Synchronous Condenser Selection & Operation

Synchronous Condenser Selection & Operation. VELCO Granite Substation Upgrade (2004 – 2008) Presentation to ERCOT Regional Planning Group. Vermont Electric Power Company, Inc (VELCO).

giulio
Télécharger la présentation

Synchronous Condenser Selection & Operation

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Synchronous Condenser Selection & Operation VELCO Granite Substation Upgrade (2004 – 2008) Presentation to ERCOT Regional Planning Group

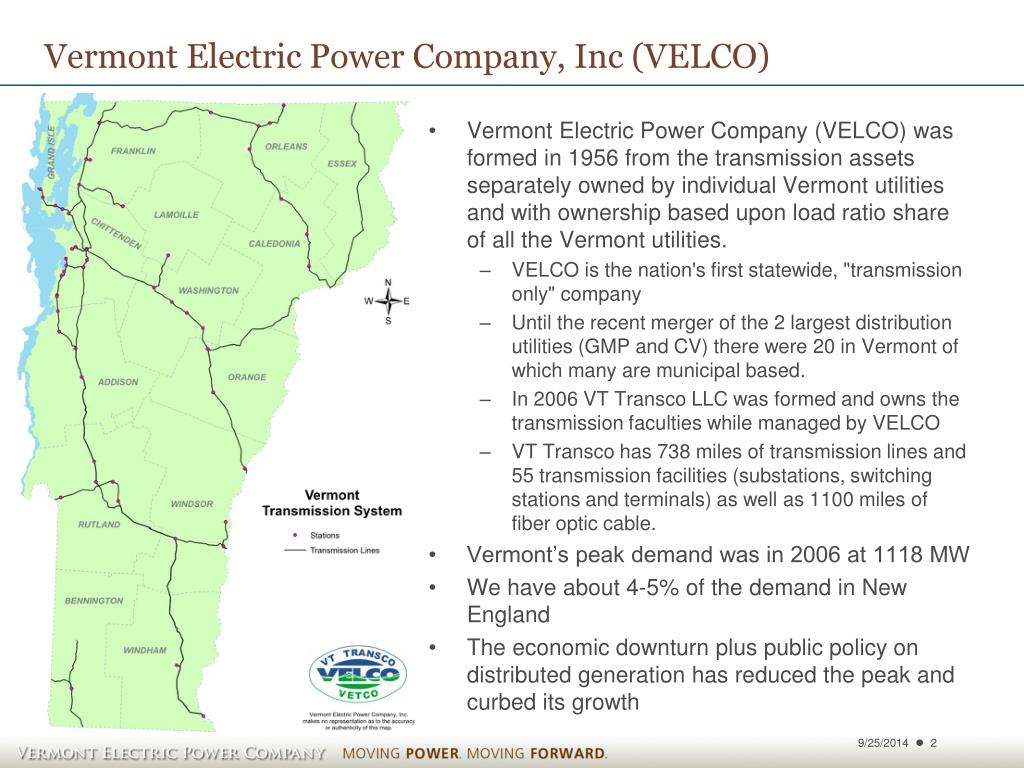

  2. Vermont Electric Power Company, Inc (VELCO) • Vermont Electric Power Company (VELCO) was formed in 1956 from the transmission assets separately owned by individual Vermont utilities and with ownership based upon load ratio share of all the Vermont utilities. • VELCO is the nation's first statewide, "transmission only" company • Until the recent merger of the 2 largest distribution utilities (GMP and CV) there were 20 in Vermont of which many are municipal based. • In 2006 VT Transco LLC was formed and owns the transmission faculties while managed by VELCO • VT Transco has 738 miles of transmission lines and 55 transmission facilities (substations, switching stations and terminals) as well as 1100 miles of fiber optic cable. • Vermont’s peak demand was in 2006 at 1118 MW • We have about 4-5% of the demand in New England • The economic downturn plus public policy on distributed generation has reduced the peak and curbed its growth

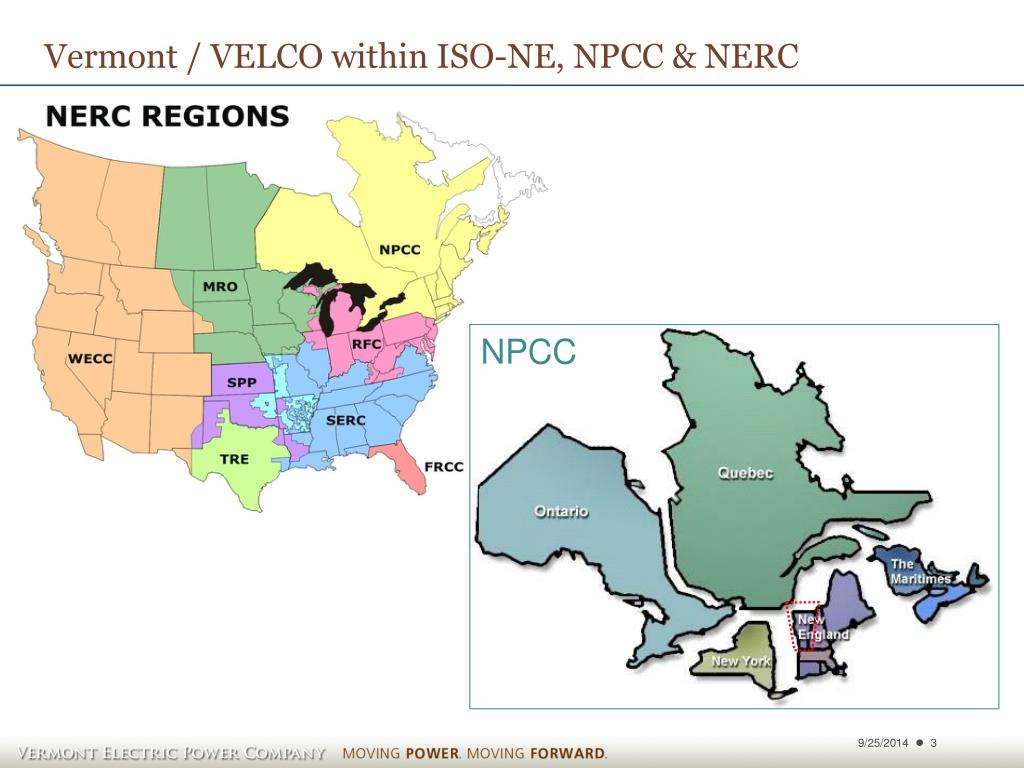

  3. Vermont / VELCO within ISO-NE, NPCC & NERC NPCC

  4. VELCO System Prior to the Northwest Reliability Project DC • 2004 • Net importer of energy • Mostly small scale hydro • A hand full of GTs, Diesels, wood burners of marginal size with largest being 52 MW • Low short circuit strength in north • 200 MW back-to-back HVDC converter on main Quebec interface • Installed in 1985 (control upgrade in 2012) • Segmented “Block Load” on other Quebec Interface • Statcom (VSC) at Essex • Commissioned in 2001

  5. VELCO North-west Reliability Project (NRP) DC • Extend 345 kV system closer to Chittenden County • From there replacing some sub-transmission with 115 kV for additional HV paths into the area • Add +/- 60°phase shifting transformers (PSTs) into our north and central New York ties • Breaker and Capacitor additions • Granite Substation Upgrade: • Two (2) New 230/115 kV Autotransformers • Each In series with 115 kV +/- 60°PSTs • Four (4) 115 kV 25 MVAR Cap Banks • Four (4) +25/-12.5 Sync Cond • Connected on 13.8 kV AT tertiary windings

  6. Reactive Power Scoping and Technology for Granite (1/3) • Project Need / Solution Development: • For loss of a major line other lines could overload • A PST on a key tie could avoid its own overload • Need the 230 kV line at Granite to take on more flow so remaining overloaded lines can be relieved. As such PSTs were planned for Granite • 230 kV tie needs reactive support to source the added real power and avoid under voltage. • Time frame for reactive power response allows for starting the reactive facility pre-contingency to avoid losses and was initially expected to be operational only 10% of the time • Following the Essex Statcom project and the observed control interaction with the HVDC station, Harmonics and low-voltage ride through were lessons learned and were key points of interest for the Granite Project

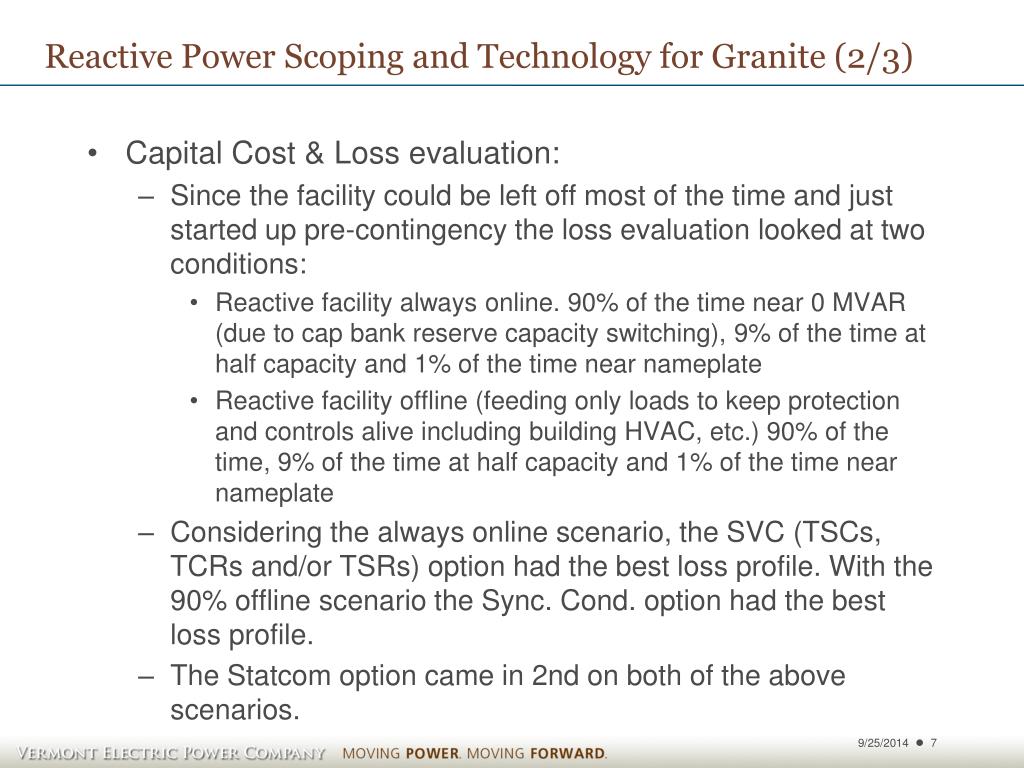

  7. Reactive Power Scoping and Technology for Granite (2/3) • Capital Cost & Loss evaluation: • Since the facility could be left off most of the time and just started up pre-contingency the loss evaluation looked at two conditions: • Reactive facility always online. 90% of the time near 0 MVAR (due to cap bank reserve capacity switching), 9% of the time at half capacity and 1% of the time near nameplate • Reactive facility offline (feeding only loads to keep protection and controls alive including building HVAC, etc.) 90% of the time, 9% of the time at half capacity and 1% of the time near nameplate • Considering the always online scenario, the SVC (TSCs, TCRs and/or TSRs) option had the best loss profile. With the 90% offline scenario the Sync. Cond. option had the best loss profile. • The Statcom option came in 2nd on both of the above scenarios.

  8. Reactive Power Scoping and Technology for Granite (3/3) • In discussion with the VT Dept. of Public Service (DPS) we were able to focus on either: • Two (2) +25/-12.5 MVAR SCs per transformer tertiary • One (1) SC per tertiary & 2 additional step-down transformers to connect a 37.5 MVAR thyristor switched capacitor (TSC) & a 17 MVAR thyristor switched reactor (TSR) to each • Both include mechanically switched capacitor (MSC) banks • Since MSCs, SCs, TSCs and TSRs do not create harmonics (even through MSCs and TSCs may interact with them) these are the preferred tools to avoid lengthy studies to alleviate concerns about possible interaction with other facilities. • Statcoms and thyristor controlled reactors (TCRs) both create harmonics which can be filtered but some level of net harmonics would be added to the system. • The above notes only the 1st stage of development at Granite. Later discussions ruled out other than SC technology for the 1st stage due to added equipment of having both technologies especially as the chance of building Stage 2 at Granite became less certain

  9. Granite Overview 1-line – Granite RPD HMI

  10. Further Information about Granite (1/3) • A Redundant Joint VAR controller (JVC) was installed as a part of the SC installation which has control of the SCs, MSCs and the Autotransformer LTCs • The SCs when online are used to regulate the 115 kV • The MSCs, when SCs are online, switch to offset the output of the SCs to low loss or potentially absorbing operation • The MSCs, when SCs are offline, are used to regulate the 115 kV • The Autotransformer LTCs are used to regulate the 230 kV • The SCs have 3 stages of dynamic response: • It immediately response responds based upon to its pre-event field (AKA: flux or internal voltage) and inertia • The excitation controller (EC) has fast response for regulating the 13.8 kV bus based upon its set-point • The JVC with VAR orders to the SCs via their unit controller (UC) PLC sends increments and decrements to the EC for its 13.8 kV set-point for change over seconds for 115 kV regulation

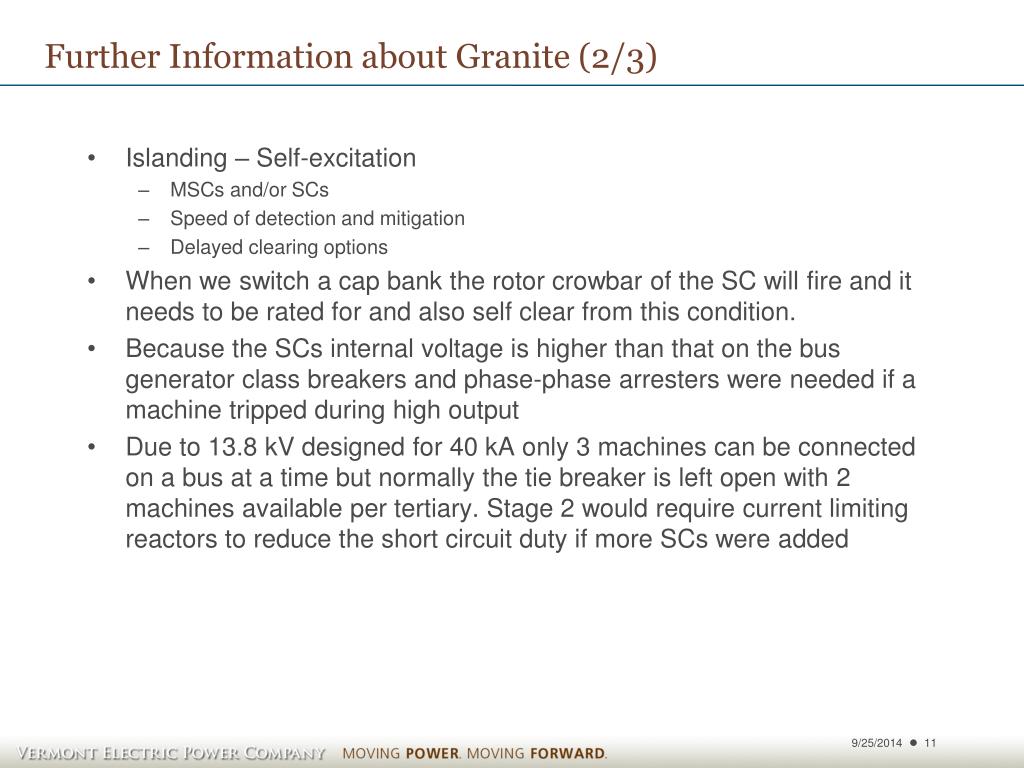

  11. Further Information about Granite (2/3) • Islanding – Self-excitation • MSCs and/or SCs • Speed of detection and mitigation • Delayed clearing options • When we switch a cap bank the rotor crowbar of the SC will fire and it needs to be rated for and also self clear from this condition. • Because the SCs internal voltage is higher than that on the bus generator class breakers and phase-phase arresters were needed if a machine tripped during high output • Due to 13.8 kV designed for 40 kA only 3 machines can be connected on a bus at a time but normally the tie breaker is left open with 2 machines available per tertiary. Stage 2 would require current limiting reactors to reduce the short circuit duty if more SCs were added

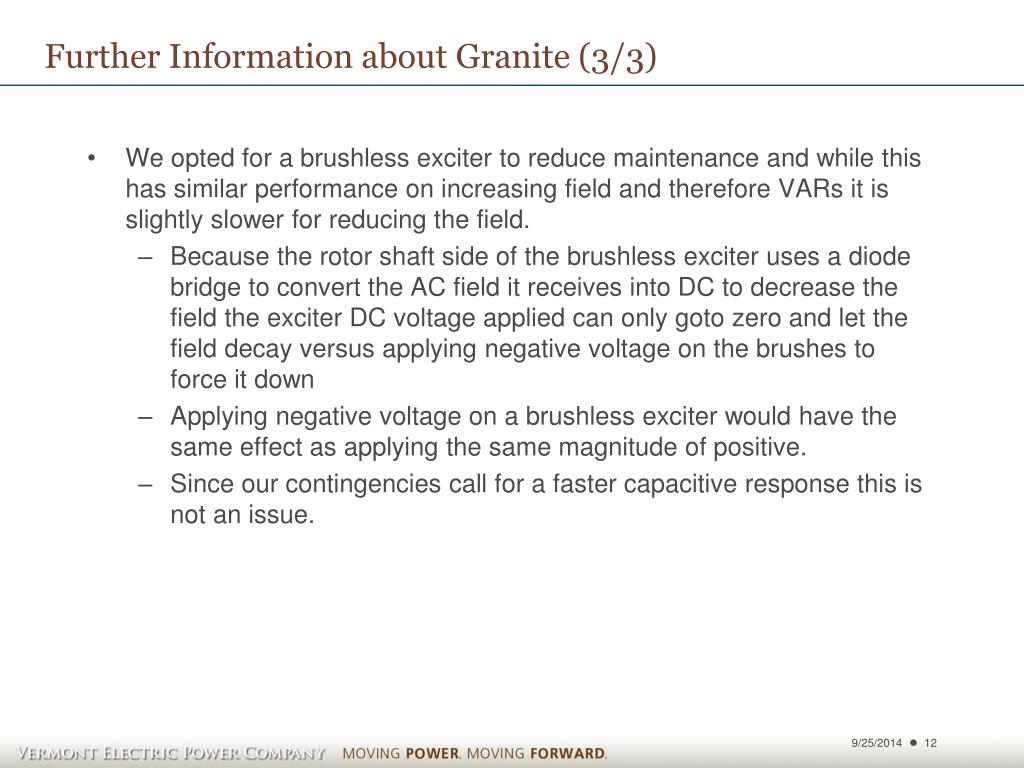

  12. Further Information about Granite (3/3) • We opted for a brushless exciter to reduce maintenance and while this has similar performance on increasing field and therefore VARs it is slightly slower for reducing the field. • Because the rotor shaft side of the brushless exciter uses a diode bridge to convert the AC field it receives into DC to decrease the field the exciter DC voltage applied can only goto zero and let the field decay versus applying negative voltage on the brushes to force it down • Applying negative voltage on a brushless exciter would have the same effect as applying the same magnitude of positive. • Since our contingencies call for a faster capacitive response this is not an issue.

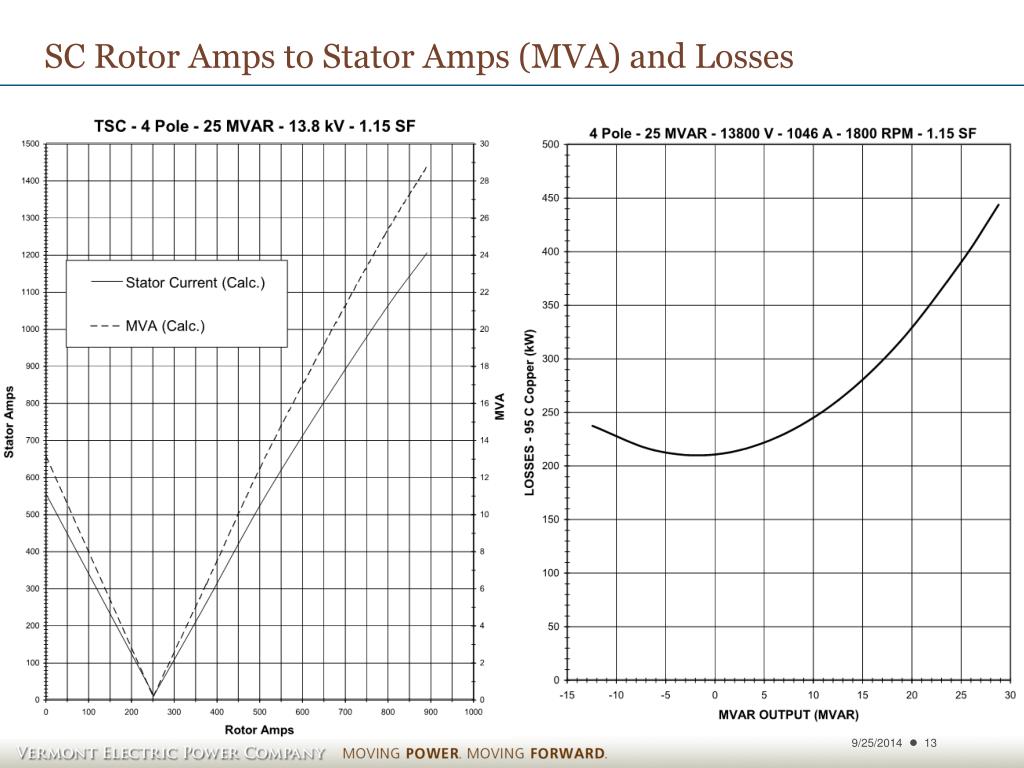

  13. SC Rotor Amps to Stator Amps (MVA) and Losses

  14. Starting a Synchronous Condenser (1/2) • Due to cost we had opted for a reactor start for our condensers. The options discussed were: • Pony Motor Start – This a motor on the same shaft as the SC that spins the machine up from a 480V or other LV source. This takes longer and has added expense of the motor, its drives and larger station service system but causes no significant system voltage drop during the start. • Direct Line Start – If the system is strong enough, the impedance of the coupling transformer high enough and/or no sensitive customer loads are “nearby” then the SC could be placed on the system directly. This is the fastest start and least expensive solution although the machine may need to be designed for this • Reactor Start – the SC will be started off the system but initially in series with a reactor sized for allowable voltage drop with whatever outages are assumed. This requires a reactor plus associated cables and at least 1 breaker. Less cost than pony motor but faster start. Most likely not black start capable • Since the scoping: Auto-Transformer/Reactor Start – Start with an auto transformer in series with the SC then transitions to a reactor portion. This adds an additional step for more control and likewise more cost.

  15. Starting a Synchronous Condenser (2/2) • With our reactor start we have the following initial voltage dip with typical generation dispatch: • All-lines-In w/ 1 SC on same bus and 2 on other bus: 3.3% • All-lines-In w/ only 2 SCs on other bus: 3.8% • All-lines-In w/ no SCs online: 4.4% • One line out w/ no SCs online: 8.9% • One line out w/ only 2 SCs on other bus: 7.1% • One line outw/ other 3 SCs online: 5.9% • With the All-lines-in case the start sequence has 135 seconds of turning on support systems and validating their operation (shorter if already online) before breakers operate at which the machine the start is 12-17 seconds. • With future installations we plan to use pony motors to allow use during black start • While we initially planned to operate only 10% of the time having some portion of the facility online provides power quality benefit and mitigates the power quality impact of additional machine starts

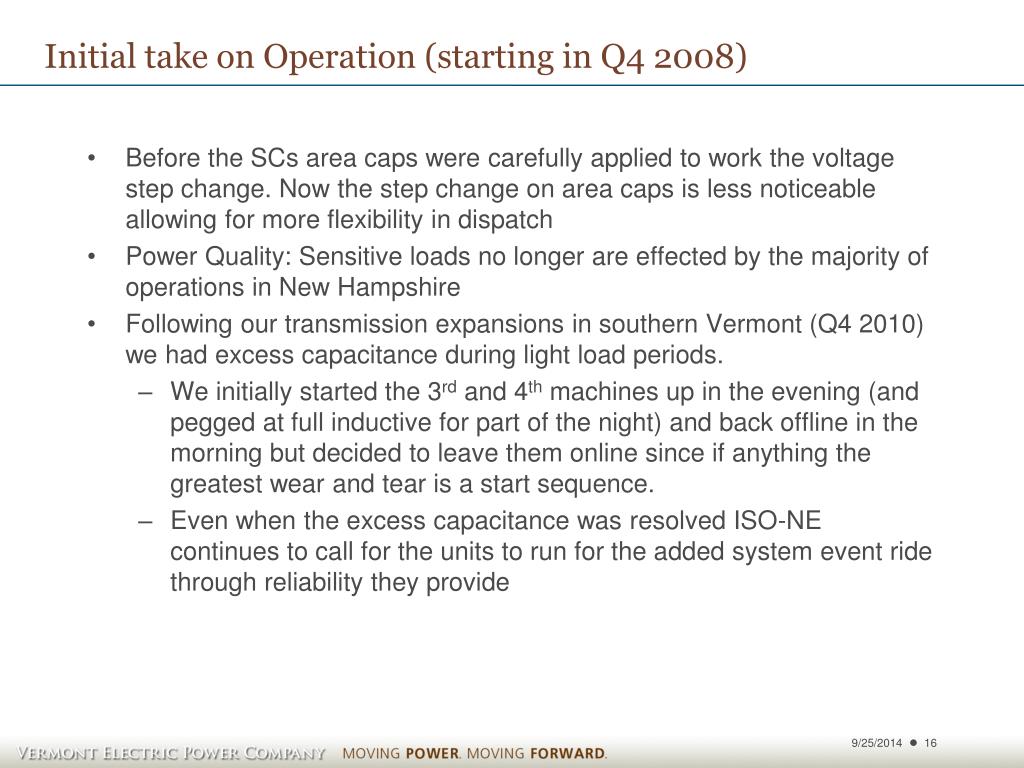

  16. Initial take on Operation (starting in Q4 2008) • Before the SCs area caps were carefully applied to work the voltage step change. Now the step change on area caps is less noticeable allowing for more flexibility in dispatch • Power Quality: Sensitive loads no longer are effected by the majority of operations in New Hampshire • Following our transmission expansions in southern Vermont (Q4 2010) we had excess capacitance during light load periods. • We initially started the 3rd and 4th machines up in the evening (and pegged at full inductive for part of the night) and back offline in the morning but decided to leave them online since if anything the greatest wear and tear is a start sequence. • Even when the excess capacitance was resolved ISO-NE continues to call for the units to run for the added system event ride through reliability they provide

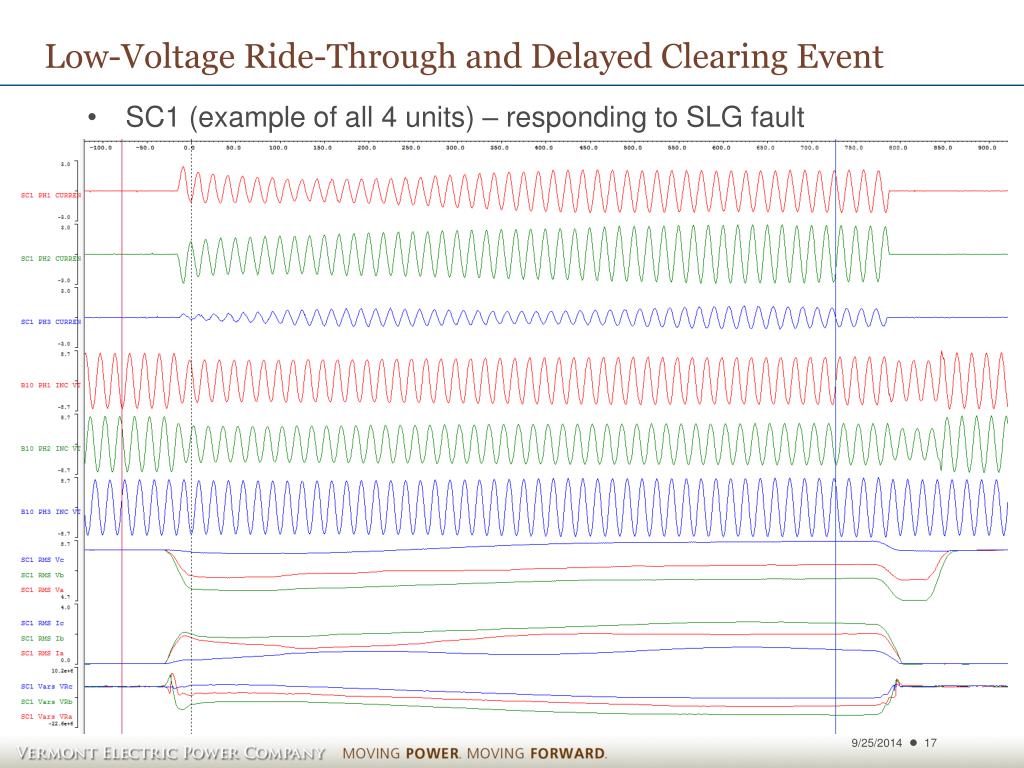

  17. Low-Voltage Ride-Through and Delayed Clearing Event • SC1 (example of all 4 units) – responding to SLG fault

  18. Some Lessons Learned • Dedicated transformers versus leveraging transmission autotransformers, while more expensive, would aid in outage and clearance work for 13.8 kV system. • These dedicated transformers would also have dual LV windings for tying the 2 sides instead of using a tie breaker • With plan to have units offline the materials of the cooling water, piping and expansion tank need to be designed to avoid rust as offline systems may have sustained oxygen in piping and expansion tank will always have oxygen so it should potentially be non-ferrous • Radiator & fan design should look into lower noise options such as variable speed motors or many smaller fans per radiator • Pony Motors would avoid voltage drop on start

  19. Maintenance & Failures • Radiator fan motors use belts which may break when starting a frozen radiator fan. Have replaced 3 or 4 sets of belts each winter • The facility has an extra radiator per unit • 3 Radiator fan motors over 2 years will be replaced due to bearings • 2 excitation system fans have been replaced over the 5 years. Will replace all in 5 year intervals as well as electronic capacitors • 2 unit controller (PLC) power supplies have failed over 5 years • All cooling water tank pressure-level transducers have been replaced in 3 years but this may have been due to a filtration process which sent more water past the transducer • Monthly maintenance includes a list of inspections and cleaning of components such as air and cooling water filters • System Operators report on SCADA alarms as needed • HMI remotely checked out regularly • Annual maintenance adds little to the monthly regiment but suggests inspections that require a shutdown • We expect the know more following a ~5 year inspection • Breakers and Protection Systems on normal maintenance schedules

  20. Granite RPD Timeline • 2004, Q3: Sent mini-spec out to vendors for info on tech options • 2005, Q2: in discussion with state finalized on SCs for Stage 1 • Q3: RFP sent to vendors, Pre-bid meeting, Bids in • 2006, Q1: Final Q/A meetings with vendors, Pre-award meeting • Kick Off meeting following contract • 2007, June-July: SC factory witness testing • December: Controls testing and control panel factory • 2008, July-August: testing & commissioning • September: Trial Operation Begins • November: Trial Operation Complete

  21. Wind Generation… • Wind generators have limits on their voltage/VAR control • They create harmonics which in low short circuit areas can even cause problems with their own operation as well as put harmonics onto the system • Synchronous Condensers • Add to the VAR / Voltage capability of a Wind facility • Add modestly to the short circuit levels • No added harmonics (versus an SVC or Statcom) • Simplifying control interaction and voltage control studies • Reduce likelihood for low / high voltage wind facilitiy trips

  22. Questions / Comments?
