DESCRIPTION

Cost Data. Cost Data Overview. Factors Earned Value 50/50 Rule Examples. Factors. BCWS - Budgeted Cost Work Scheduled - Budget entry numbers ACWP - Actual Cost Work Performed - Actuals, what you spent BCWP - Budgeted Cost Work Performed - Earned Value, what you have accomplished. Factors.

1 / 41

Télécharger la présentation

Cost Data

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Cost Data

  2. Cost Data Overview • Factors • Earned Value • 50/50 Rule • Examples

  3. Factors • BCWS - Budgeted Cost Work Scheduled - Budget entry numbers • ACWP - Actual Cost Work Performed - Actuals, what you spent • BCWP - Budgeted Cost Work Performed - Earned Value, what you have accomplished

  4. Factors • BAC - Budget at Completion - the total of all the budget numbers, the bottom line • EAC - Estimate at Completion - based on your rate of expenditures, what you probably will spend by the end of the project • CV - Cost Variance, BCWP - ACWP = CV • SV - Schedule Variance, BCWP - BCWS = SV

  5. Factors • CPI - Cost Performance Index BCWP/ACWP = CPI • SPI - Schedule Performance Index BCWP/BCWS = SPI

  6. BCWP - Earned Value • Calculating Earned Value should be easy if you set up your budget correctly. • Earned Value or BCWP is the value of what you have produced. If you have produced $500,000 worth of the $1,000,000 project, your BCWP is $500,000 or 50%.

  7. BCWP - Earned Value • Let’s use a wall as an example: • There are $50 per foot in materials • It will take 4 labor hours per foot to build at $20/hour • There will be $200 in other labor charges • There is a crew of four working • The wall is 80 feet long • On the first and last days the crew has 8 hours of set up and tear down time each

  8. BCWP - Earned Value • Budget • Materials - $50 X 80 = $4000 • Labor for wall - 4 X 80 X $20 = $6400 • Labor for set up and tear down - 16 X $20 = $320 • Additional Labor - $200 • Total = $10,920

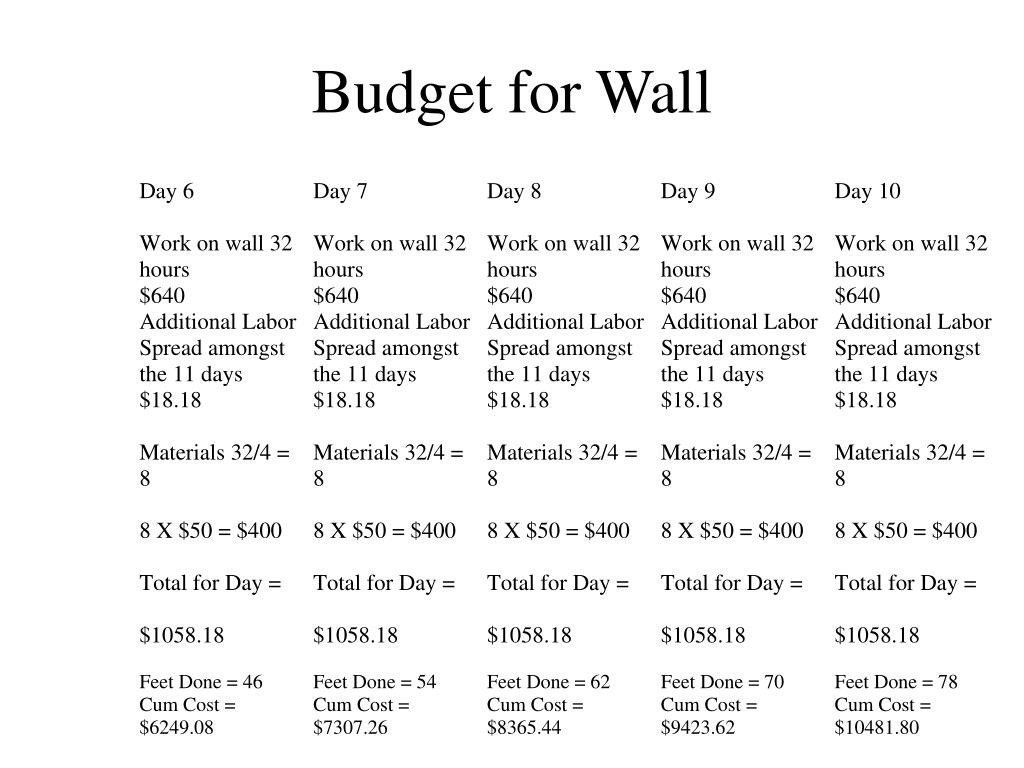

  9. Budget for Wall

  10. Budget for Wall

  11. Budget for Wall

  12. Wall • Question • How would you do this budget different?

  13. Actual Construction

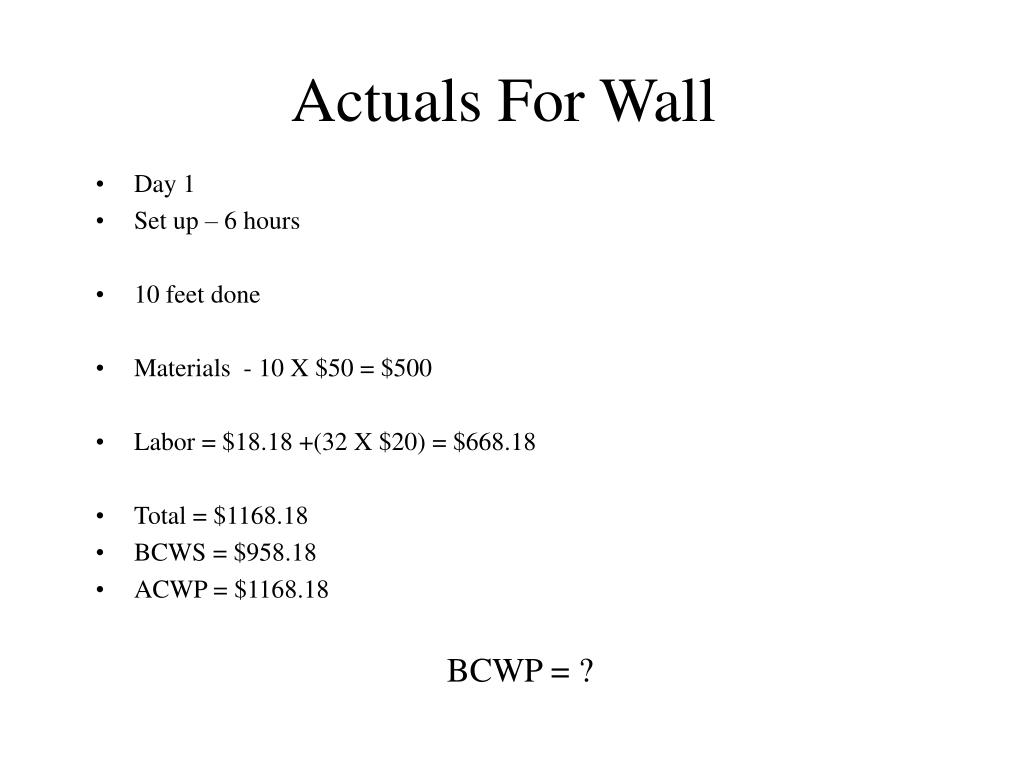

  14. Actuals For Wall • Day 1 • Set up – 6 hours • 10 feet done • Materials - 10 X $50 = $500 • Labor = $18.18 +(32 X $20) = $668.18 • Total = $1168.18 • BCWS = $958.18 • ACWP = $1168.18 BCWP = ?

  15. BCWP • How would you allocate the budget so you could determine BCWP?

  16. BCWP • Easiest is to take total costs and prorate over some easy thing to measure, like the length of the wall. • $10,920/80 = $136.50 / foot completed

  17. Actuals For Wall • Day 1 • Set up – 6 hours • 10 feet done or a value of (10 X $136.50) = $1365.00 or $1365.00/10,920 complete = 12.5% complete • Materials - 10 X $50 = $500 • Labor = $18.18 +(32 X $20) = $668.18 • Total = $1168.18 • BCWS = $958.18 • ACWP = $1168.18 • BCWP = $1365.00

  18. Actuals for Wall - Day 1 • BCWS = $958.18 • ACWP = $1168.18 • BCWP = $1365.00 • CV = BCWP - ACWP = 1365.00 - 1168.18 = $196.82 Positive so it is favorable • SV = BCWP - BCWS = 1365.00 - 958.18 = $406.82 Positive so it is favorable • CPI = BCWP/ACWP = 1365/1168.18 = 1.168 or for every dollar that is spent, we earn $1.17 in value • SPI = BCWP/BCWS = 1365/958.18 = 1.42 or we are doing about 40% better on schedule than anticipated. • EAC = BAC/CPI = $10,920/1.17 = $9333.33

  19. Actuals For Wall • Day 2 • It rained - no work performed • Labor = $18.18 +(32 X $20) = $668.18 • Total = $668.18 • BCWS = $2016.36 • ACWP = $1836.36 • BCWP = $1365.00

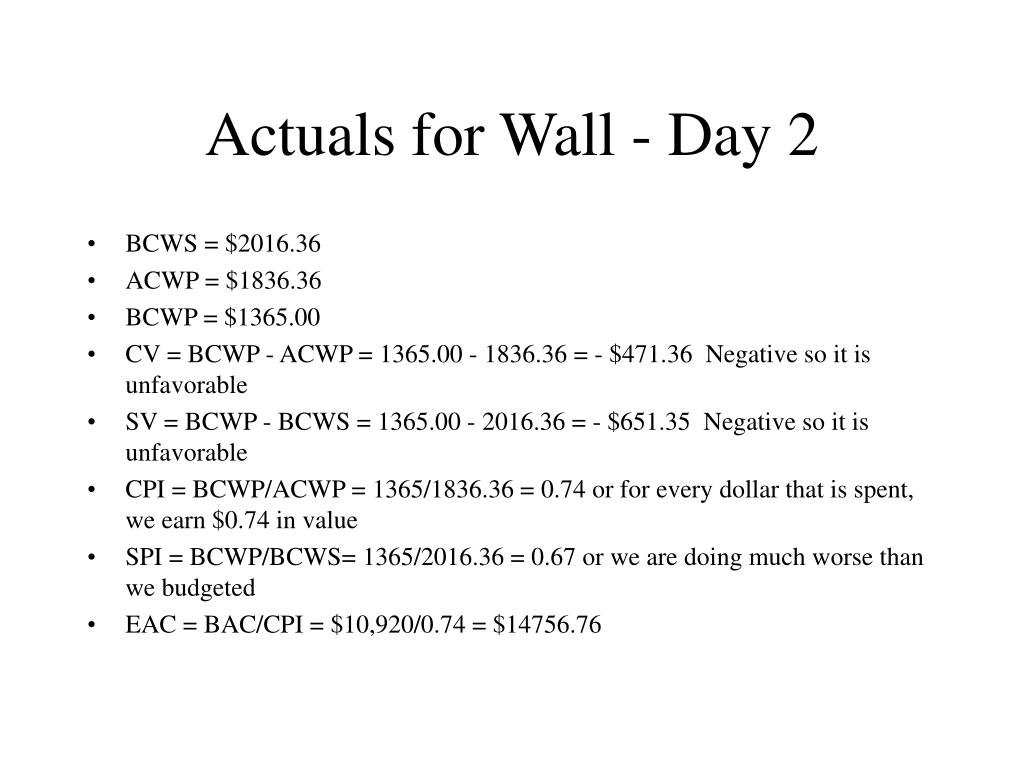

  20. Actuals for Wall - Day 2 • BCWS = $2016.36 • ACWP = $1836.36 • BCWP = $1365.00 • CV = BCWP - ACWP = 1365.00 - 1836.36 = - $471.36 Negative so it is unfavorable • SV = BCWP - BCWS = 1365.00 - 2016.36 = - $651.35 Negative so it is unfavorable • CPI = BCWP/ACWP = 1365/1836.36 = 0.74 or for every dollar that is spent, we earn $0.74 in value • SPI = BCWP/BCWS= 1365/2016.36 = 0.67 or we are doing much worse than we budgeted • EAC = BAC/CPI = $10,920/0.74 = $14756.76

  21. Actuals For Wall • Day 3 • Sunny day, crew motivated, did 14 feet today. • Materials = 14 X $50 = $700 • Total Done = 24 • BCWP = 24 X 136.50 = $3276.00 • Labor = $18.18 +(32 X $20) = $668.18 • Total = $1368.18 • BCWS = $3074.54 • ACWP = $ 3204.54 • BCWP = $3276.00

  22. Actuals for Wall - Day 3 • BCWS = $3074.54 • ACWP = $ 3204.54 • BCWP = $3276.00 • CV = BCWP - ACWP = 3276.00 - 3204.54 = $71.46 Positive so it is favorable • SV = BCWP - BCWS = 3276.00 - 3074.54 = $201.46 Positive so it is favorable • CPI = BCWP/ACWP = 3276/3204.54 = 1.02 or for every dollar that is spent, we earn $1.02 in value • SPI = BCWP/BCWS= 3276/3074.54 = 1.06 or we are doing much worse than we budgeted • EAC = BAC/CPI = $10,920/1.02 = $10,705.89

  23. S - Curves • Ok, so now we can calculate the statistics • Next we want to be able to graph the numbers and see where we are from a visual perspective.

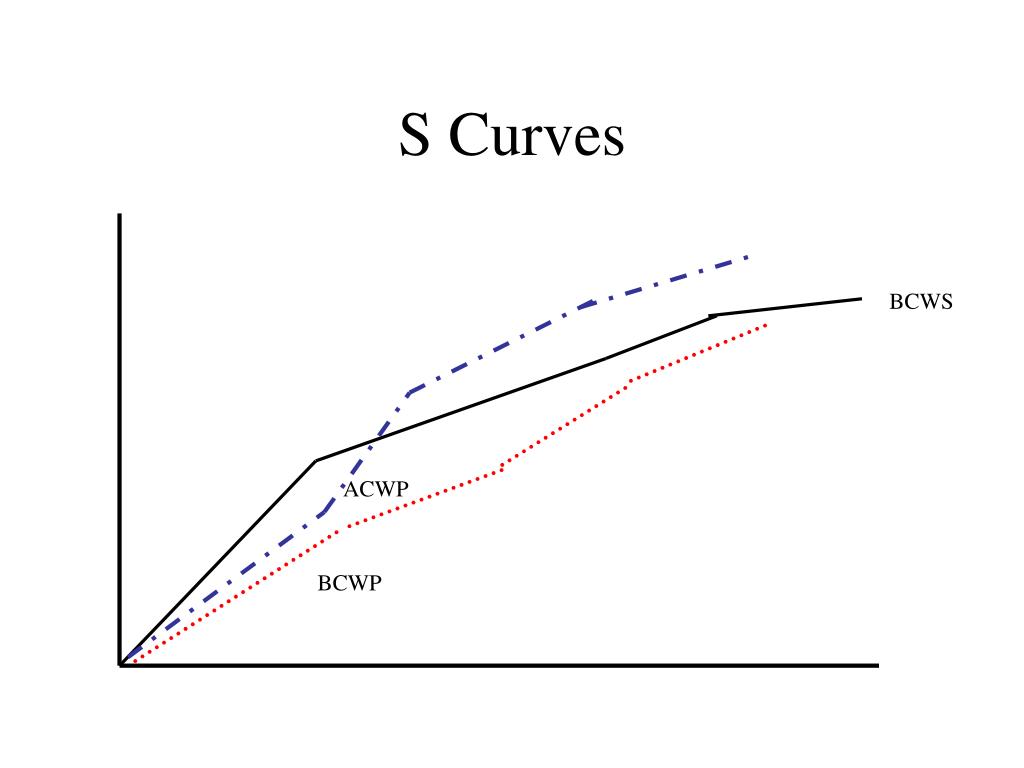

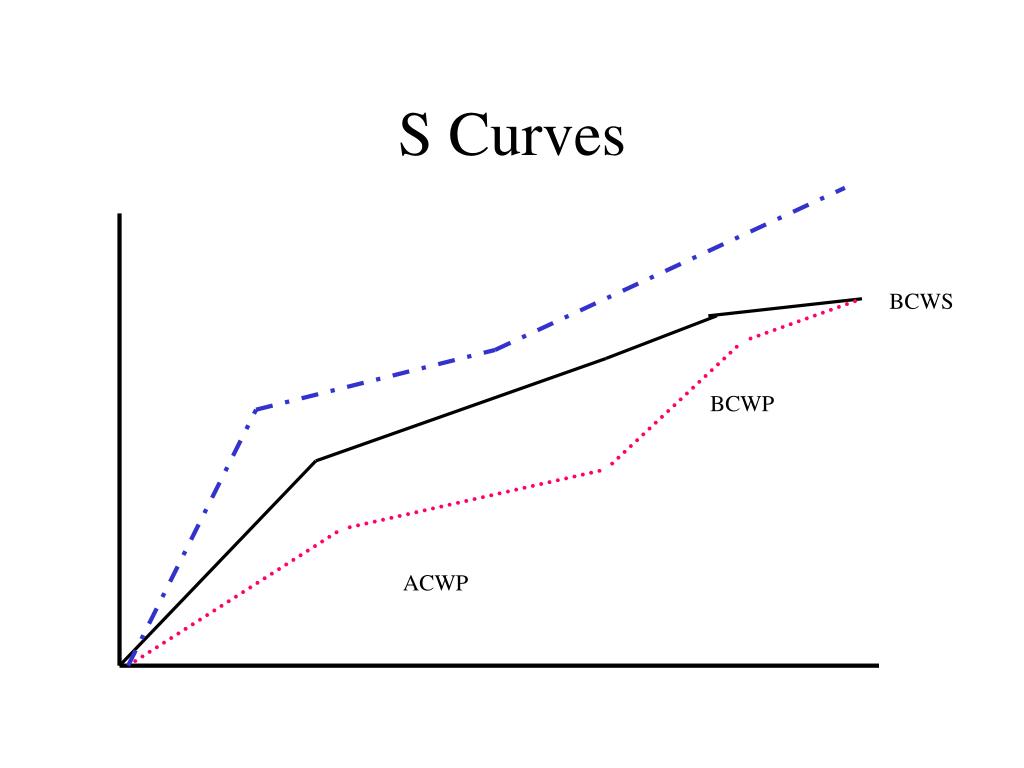

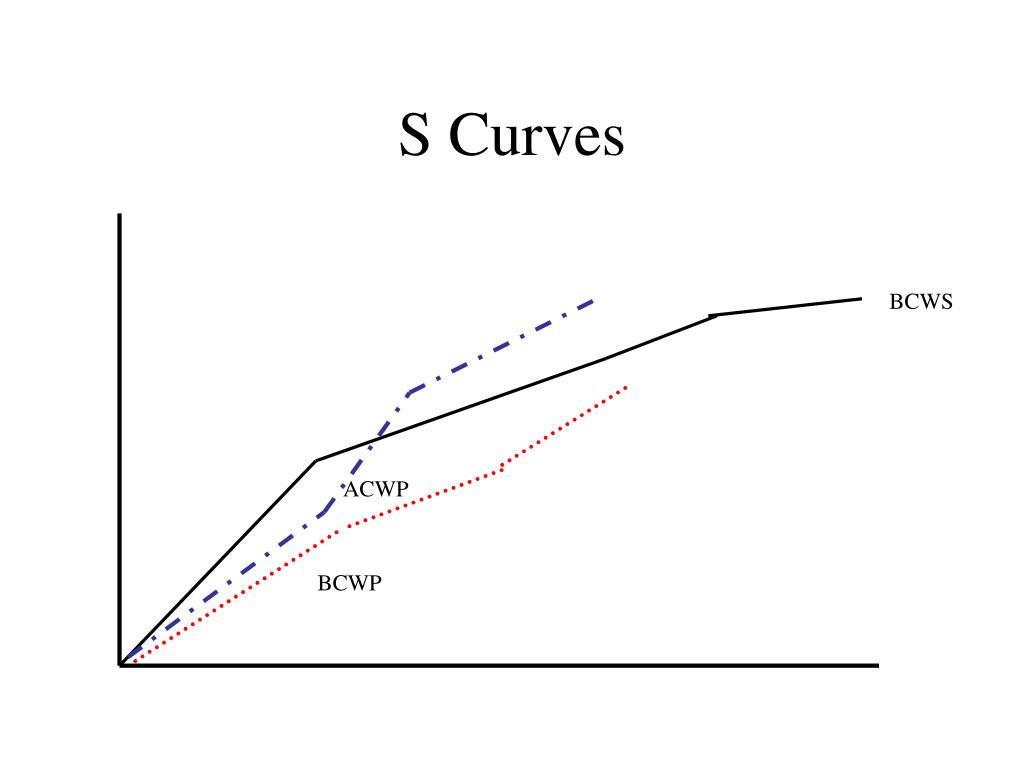

  24. S Curves • S Curves are a good way to see at a glance what is going on. • The following curve shows our data on a graph.

  25. S Curves BCWS ACWP BCWP

  26. S Curves BCWS BCWP ACWP

  27. S Curves BCWS BCWP ACWP

  28. S Curves BCWS ACWP BCWP

  29. S Curves BCWS ACWP BCWP

  30. S Curves BCWS ACWP BCWP

  31. S Curves BCWS ACWP BCWP

  32. S Curves BCWS ACWP BCWP

  33. Wall Example Continued • The following Excel example shows how the curves can be used.

  34. 50/50 Rule • Frame has an easier way to calculate earned value. • It is called the 50/50 rule. • With this rule, you earned 50% of the earned value the instant you start a task and the other 50% when the task is complete.

  35. 50/50 Rule Task 1 = $50k Task 2 = $25k Task 3 = $40k

  36. 50/50 Rule Task 1 = $50k: Started so, we have earned $25k Task 2 = $25k Task 3 = $40k BCWP = ?

  37. 50/50 Rule Task 1 = $50k: Started so, we have earned $25k Task 2 = $25k Task 3 = $40k BCWP = 25K

  38. 50/50 Rule Task 1 = $50k: Started so, we have earned $25k Task 2 = $25k: Started so have earned $12.5k Task 3 = $40k BCWP = ?

  39. 50/50 Rule Task 1 = $50k: Started so, we have earned $25k Task 2 = $25k: Started so have earned $12.5k Task 3 = $40k BCWP = $37.5K

  40. 50/50 Rule Task 1 = $50k: Finished so, we have earned $50k Task 2 = $25k: Started so have earned $12.5k Task 3 = $40k: Started so we have earned $20k BCWP = $82.5K

  41. Reminders • BCWP can never exceed BCWS • At the end of a project the schedule variance will always equal zero • Cost variance can exceed BCWS
