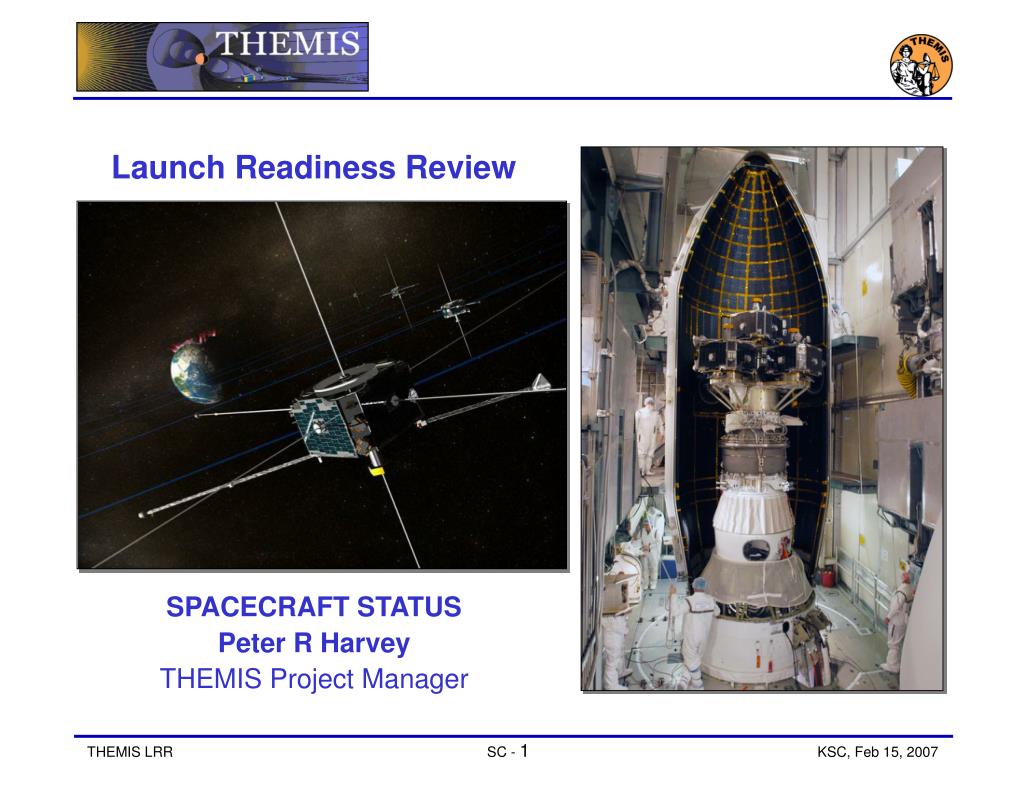

Launch Readiness Review SPACECRAFT STATUS Peter R Harvey THEMIS Project Manager

Launch Readiness Review SPACECRAFT STATUS Peter R Harvey THEMIS Project Manager. Mission Overview. Launch Vehicle: Delta II, Eastern Range Apogee: 91845.2 km ± 9567 km Perigee: 435 km ± 10 km (500 km ± 7 km on or after 3/1/2007) Inclination: 16.0 deg ± 0.5 deg Date: February 16, 2007

halil
Télécharger la présentation

Launch Readiness Review SPACECRAFT STATUS Peter R Harvey THEMIS Project Manager

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Launch Readiness Review • SPACECRAFT STATUS • Peter R Harvey • THEMIS Project Manager

  2. Mission Overview Launch Vehicle: Delta II, Eastern Range Apogee: 91845.2 km ± 9567 km Perigee: 435 km ± 10 km (500 km ± 7 km on or after 3/1/2007) Inclination: 16.0 deg ± 0.5 deg Date: February 16, 2007 Space Segment Spacecraft: 5 Spinning Probes with Fuel for Orbit & Attitude Adjust Instruments: 3-Axis Electric Field, Magnetic Field 3-D Ion & Electron Particle Detectors Spin Rate: 20 RPM Orbit Period(s): 1, 2 and 4 days Orientation: Ecliptic Normal Ground Segment Observatories: 20 Northern with All Sky Imagers and Magnetometers Control Facilities: Mission and Science Operations Centers Operations Phases: L&EO, Cruise, Ascent, Campaigns, De-orbit Lifetime: 2.3 years

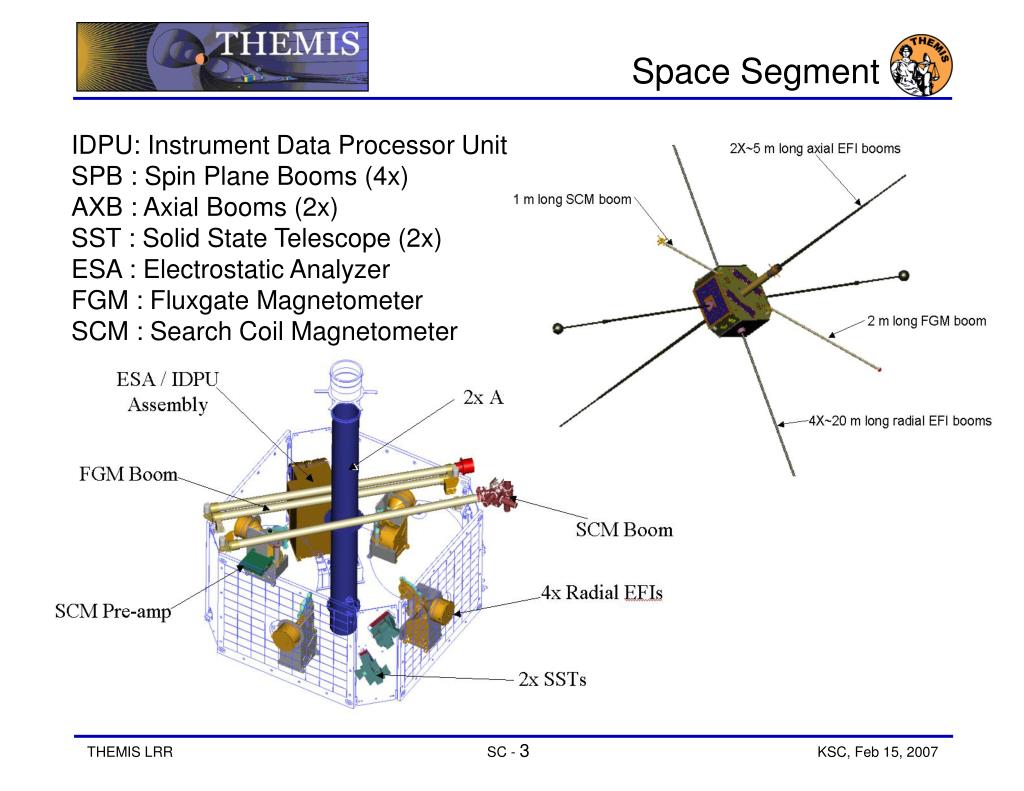

  3. Space Segment IDPU: Instrument Data Processor Unit SPB : Spin Plane Booms (4x) AXB : Axial Booms (2x) SST : Solid State Telescope (2x) ESA : Electrostatic Analyzer FGM : Fluxgate Magnetometer SCM : Search Coil Magnetometer

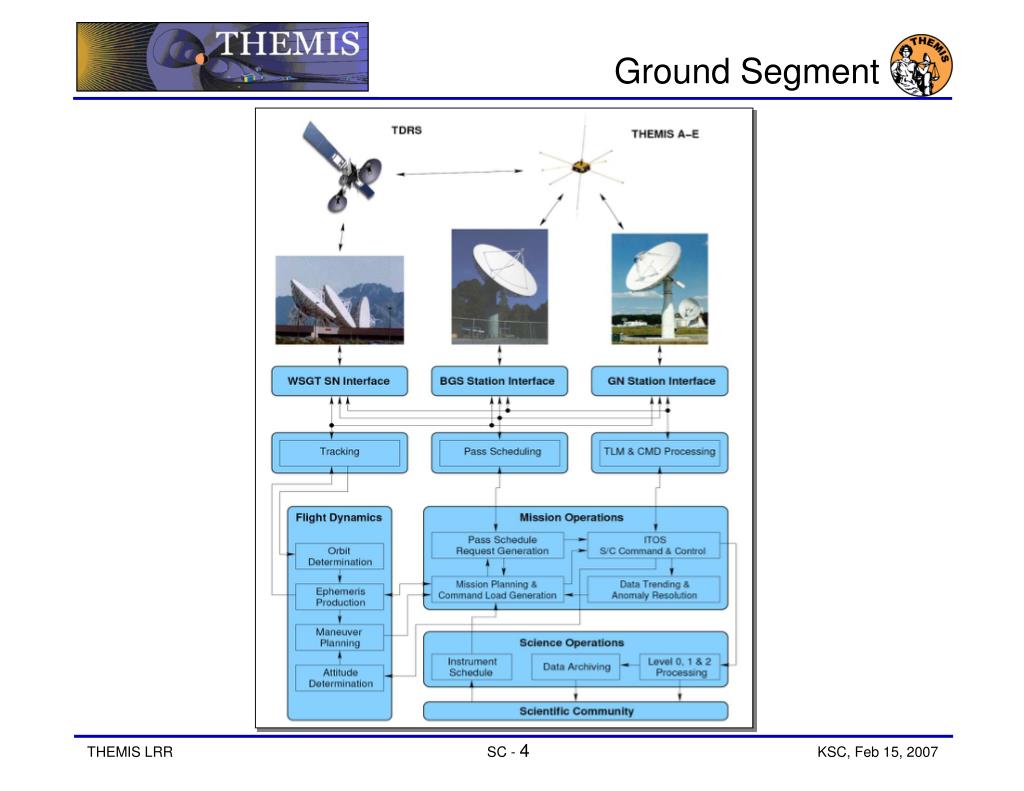

  4. Ground Segment

  5. FRR RFA #1 • ITEM • ULA reported worst case CG offset of .0732 inch between PCA and Third Stage. NASA Requested Verification that this offset was enveloped in THEMIS Probe Separation Analysis, in particular the simultaneous probe separation. INVESTIGATION • Reviewed Separation Analyses • Verified CG offsets >> .0732” had been studied. • Clearances always > 1.8” • STATUS • Closed

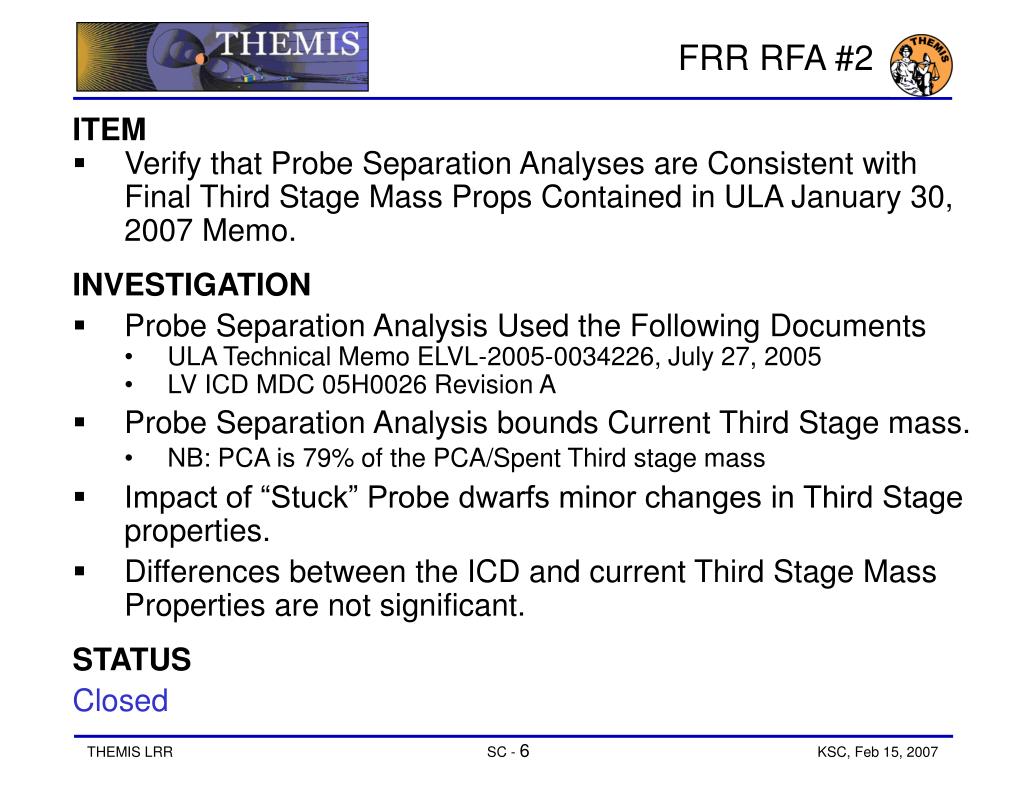

  6. FRR RFA #2 • ITEM • Verify that Probe Separation Analyses are Consistent with Final Third Stage Mass Props Contained in ULA January 30, 2007 Memo. INVESTIGATION • Probe Separation Analysis Used the Following Documents • ULA Technical Memo ELVL-2005-0034226, July 27, 2005 • LV ICD MDC 05H0026 Revision A • Probe Separation Analysis bounds Current Third Stage mass. • NB: PCA is 79% of the PCA/Spent Third stage mass • Impact of “Stuck” Probe dwarfs minor changes in Third Stage properties. • Differences between the ICD and current Third Stage Mass Properties are not significant. • STATUS • Closed

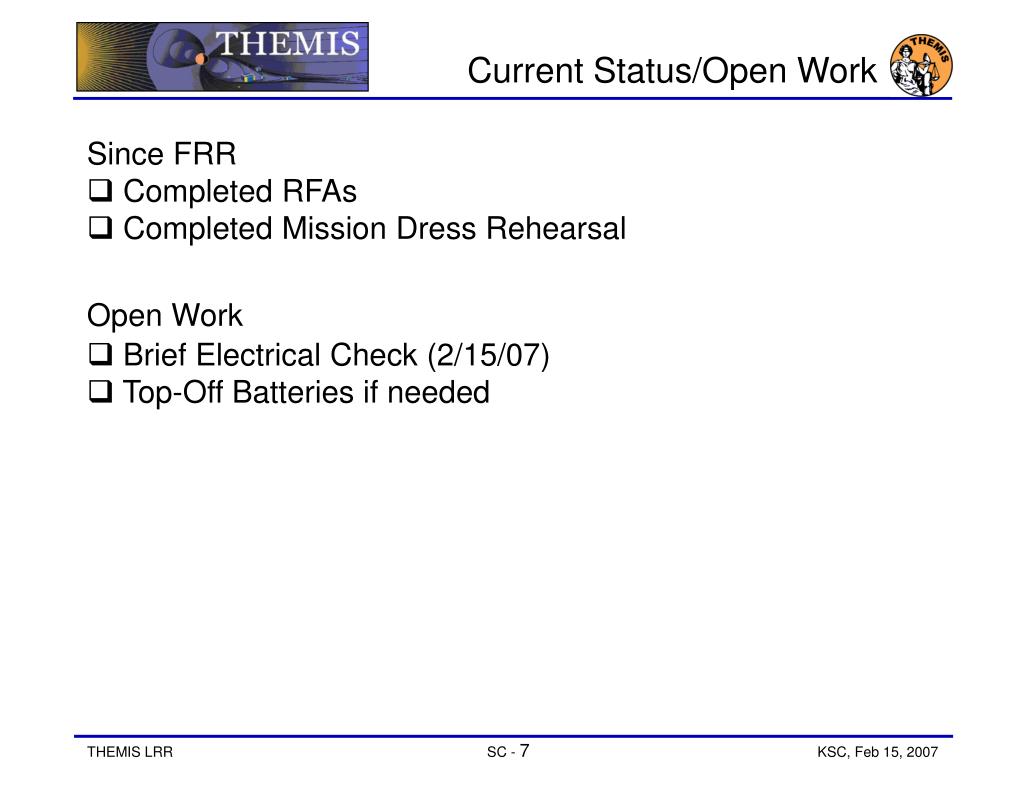

  7. Current Status/Open Work Since FRR • Completed RFAs • Completed Mission Dress Rehearsal Open Work • Brief Electrical Check (2/15/07) • Top-Off Batteries if needed

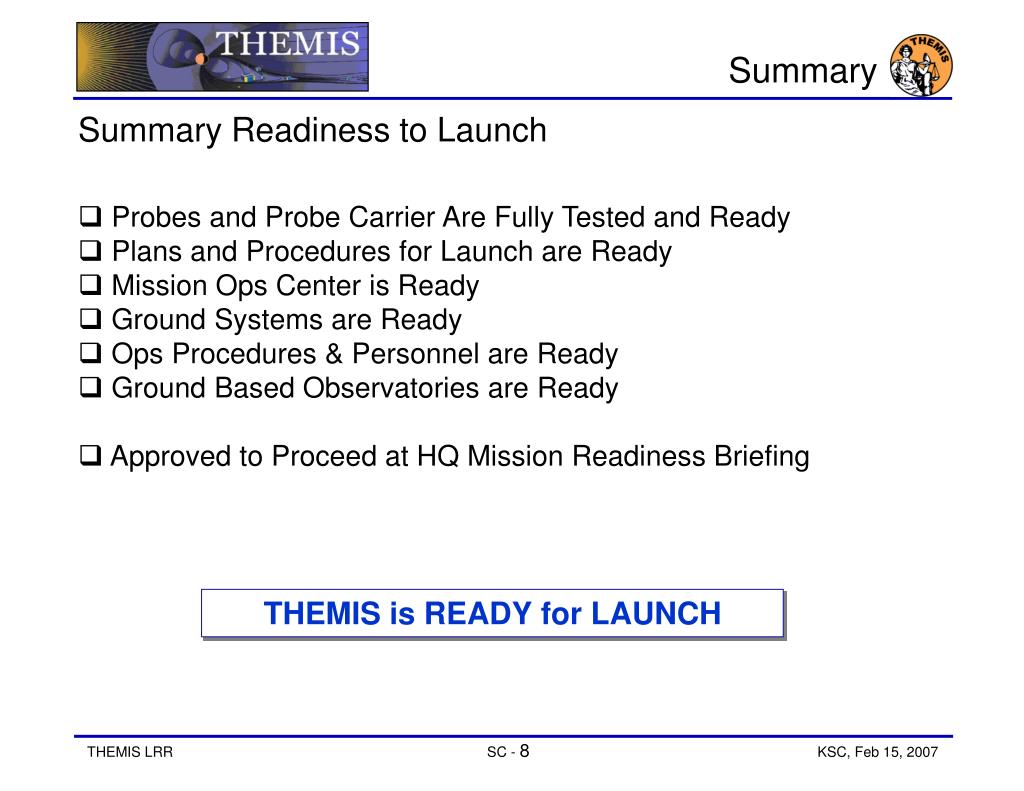

  8. Summary Summary Readiness to Launch • Probes and Probe Carrier Are Fully Tested and Ready • Plans and Procedures for Launch are Ready • Mission Ops Center is Ready • Ground Systems are Ready • Ops Procedures & Personnel are Ready • Ground Based Observatories are Ready • Approved to Proceed at HQ Mission Readiness Briefing THEMIS is READY for LAUNCH
