  1. Due Date Planning for Complex Product Systemswith Uncertain Processing Times By: Dongping Song Supervisors: Dr. C.Hicks&Dr. C.F.Earl Department of MMM Engineering University of Newcastle upon Tyne April, 1999

  2. Overview 1. Introduction 2. Literature review 3. Two stage model 4. Lead-time distribution estimation 5. Due date planning 6. Industrial case study 7. Conclusions and further work

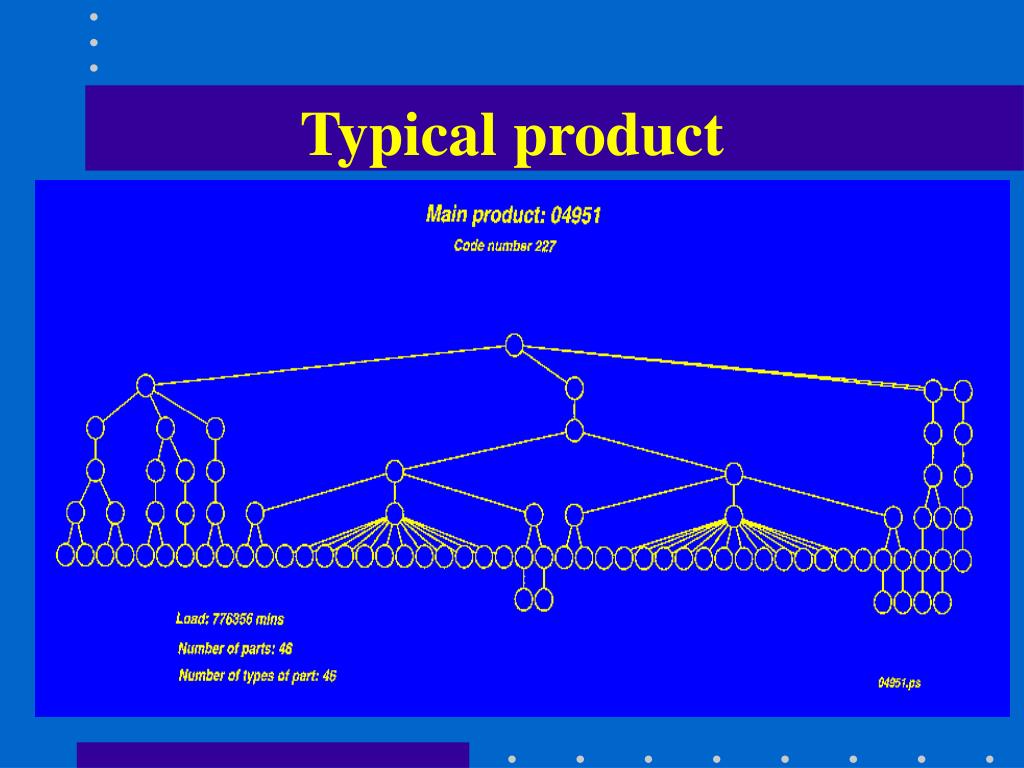

  3. Typical product

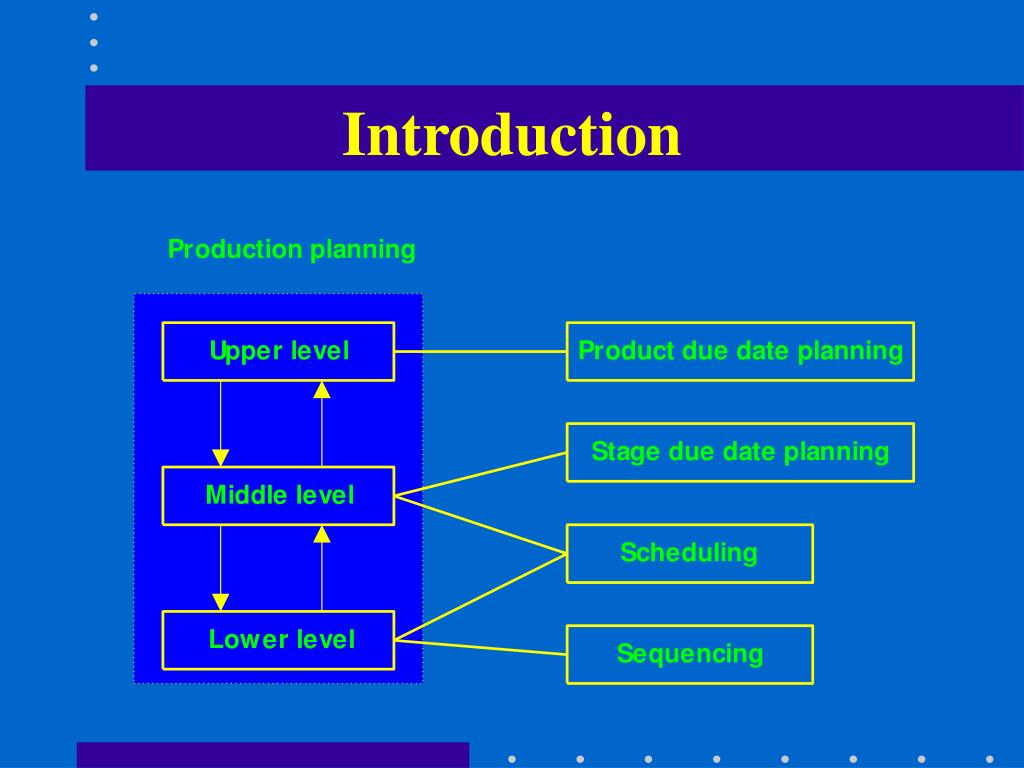

  4. Introduction

  5. Uncertainty in processing Lead time distribution Component Manufacture Assembly process distribution Latest component completion time distribution

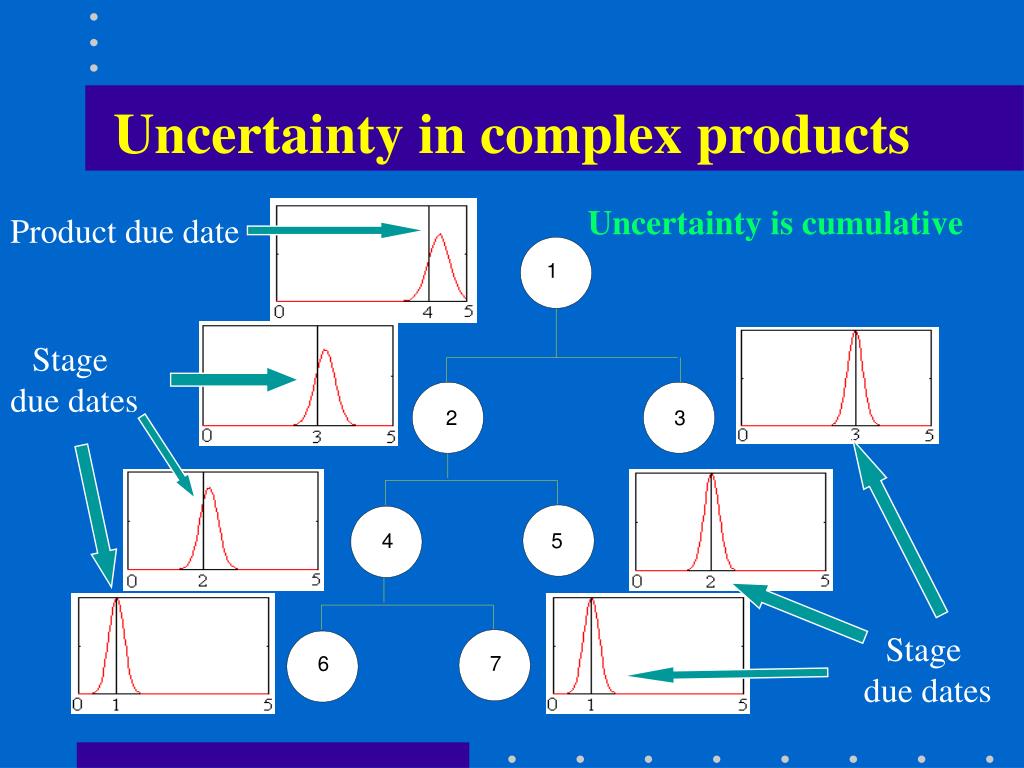

  6. Uncertainty in complex products Uncertainty is cumulative Product due date Stage due dates Stage due dates

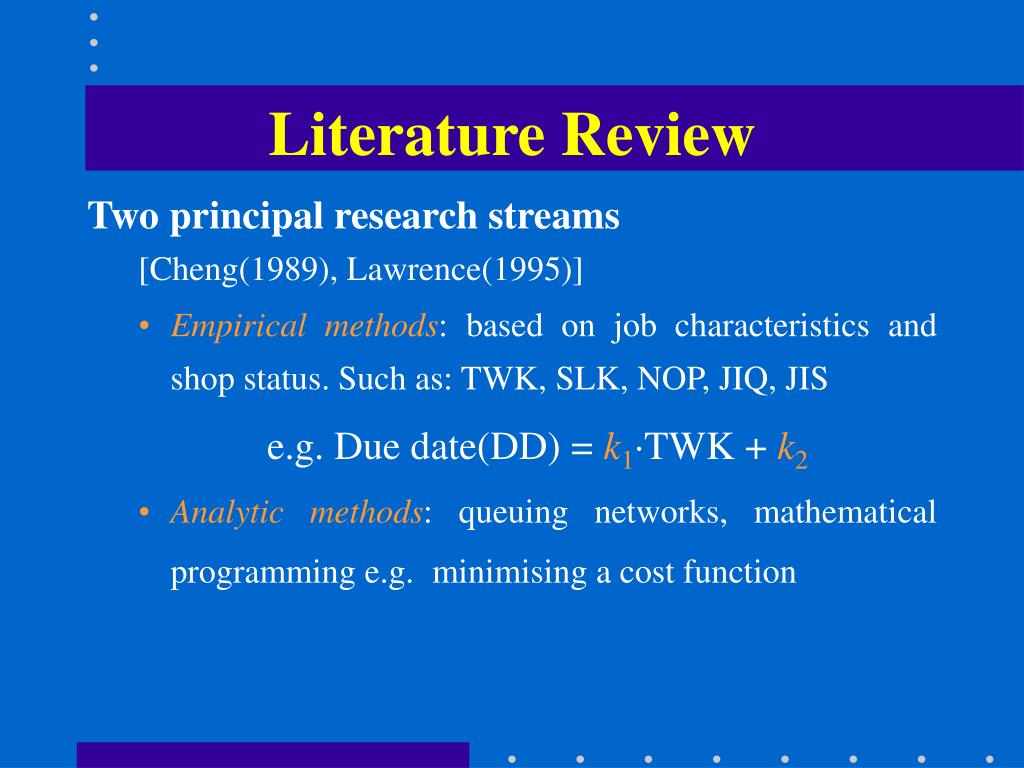

  7. Literature Review Two principal research streams [Cheng(1989), Lawrence(1995)] • Empirical methods: based on job characteristics and shop status. Such as: TWK, SLK, NOP, JIQ, JIS e.g. Due date(DD) = k1×TWK + k2 • Analytic methods: queuing networks, mathematical programming e.g. minimising a cost function

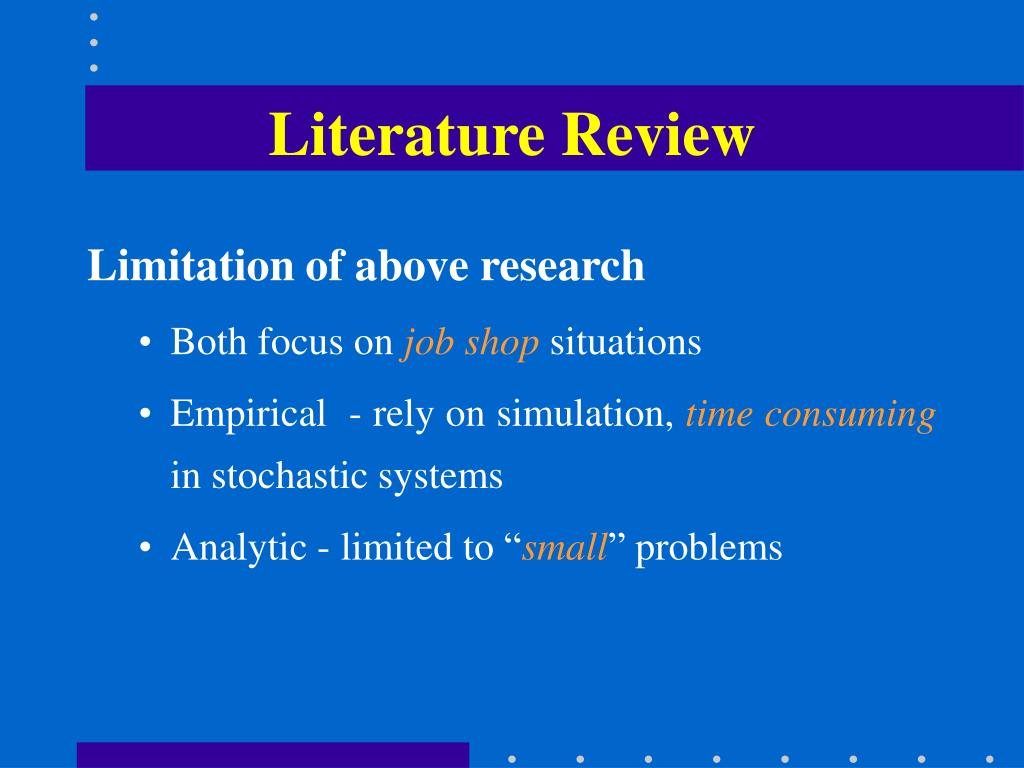

  8. Literature Review Limitation of above research • Both focus on job shop situations • Empirical - rely on simulation, time consuming in stochastic systems • Analytic - limited to “small” problems

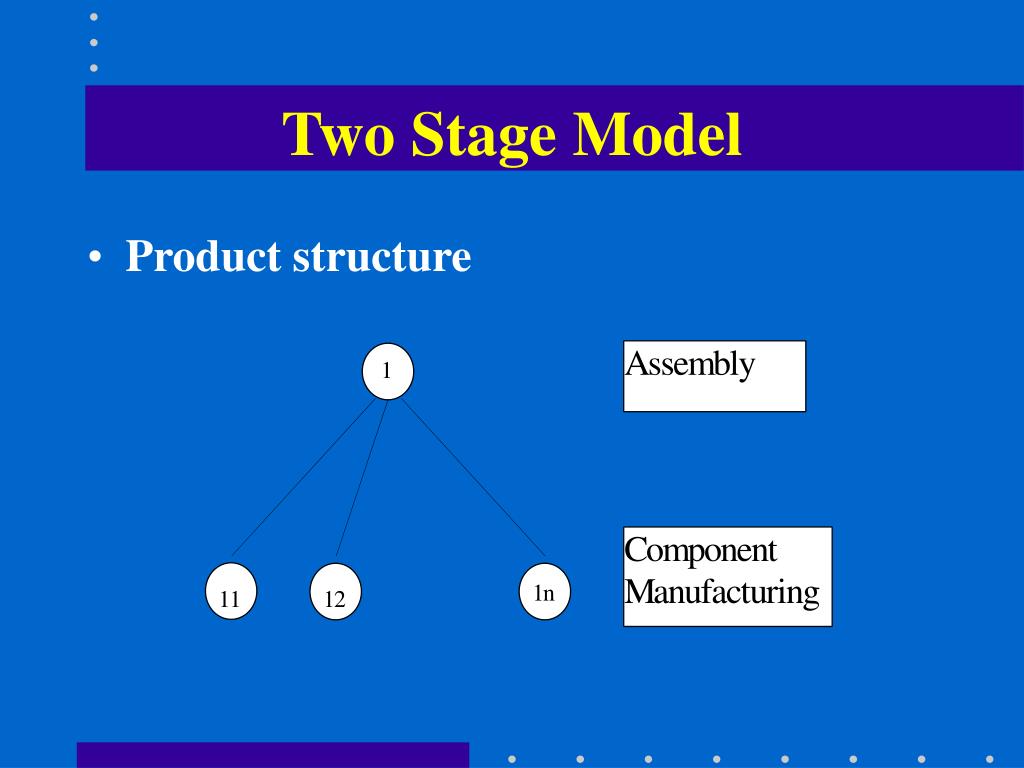

  9. Two Stage Model • Product structure

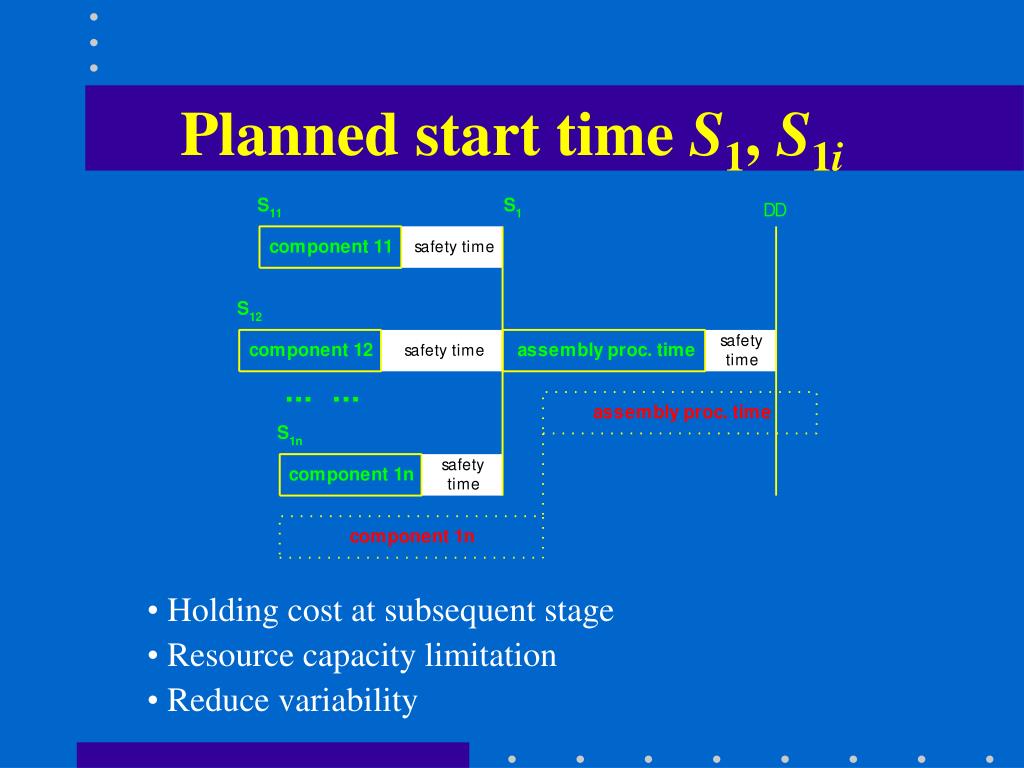

  10. Planned start time S1, S1i • Holding cost at subsequent stage • Resource capacity limitation • Reduce variability

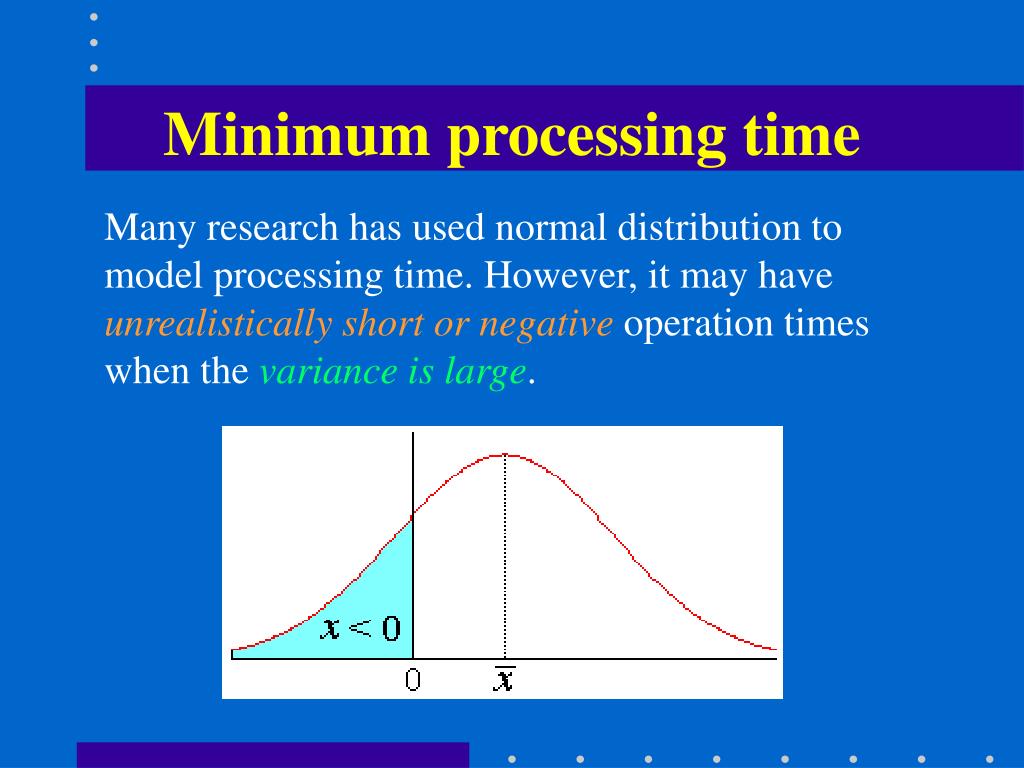

  11. Minimum processing time Many research has used normal distribution to model processing time. However, it may have unrealistically short or negative operation times when the variance is large.

  12. Truncated distribution Probability density function (PDF) Cumulative distribution function ( CDF) M1 = Minimum processing time

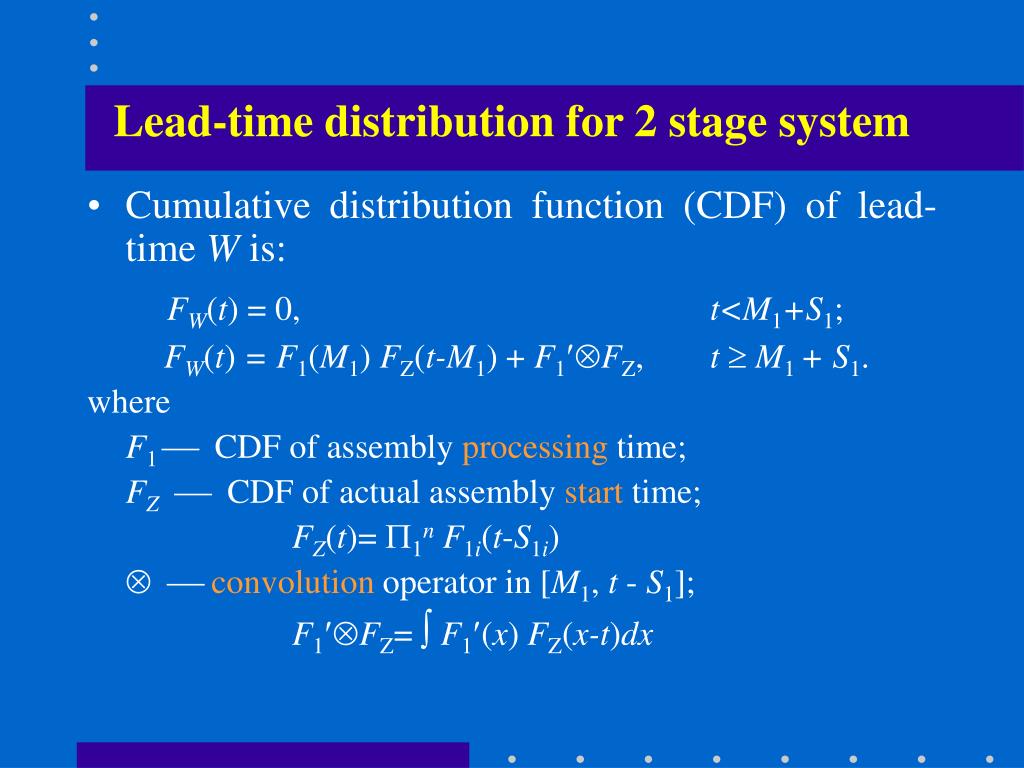

  13. Lead-time distribution for 2 stage system • Cumulative distribution function (CDF) of lead-time W is: • FW(t)= 0, t<M1+S1; • FW(t) = F1(M1) FZ(t-M1) + F1¢ÄFZ, t ³ M1 + S1. • where • F1 ¾ CDF of assembly processing time; • FZ¾ CDF of actual assembly start time; • FZ(t)= P1n F1i(t-S1i) • ľ convolution operator in [M1, t - S1]; • F1¢ÄFZ= òF1¢(x) FZ(x-t)dx

  14. Lead-time Distribution Estimation Complex product structure • approximation method based upon two stage model Assumptions • normally distributed processing times • approximate lead-time by truncated normal distribution

  15. Lead-time Distribution Estimation Normal distribution approximation • Compute mean and variance of assembly start time Z and assembly process time Q : mZ, sZ2andmQ, sQ2 • Obtain mean and variance of lead-time W(=Z+Q): mW = mQ+mZ, sW2 = sQ2+sZ2 • Approximate W by truncated normal distribution: N(mW, sW2), t ³ M1+ S1. More moments are needed if using general distribution to approximate

  16. Approximation procedure for setting stage due date

  17. Approximation procedure for setting product due date

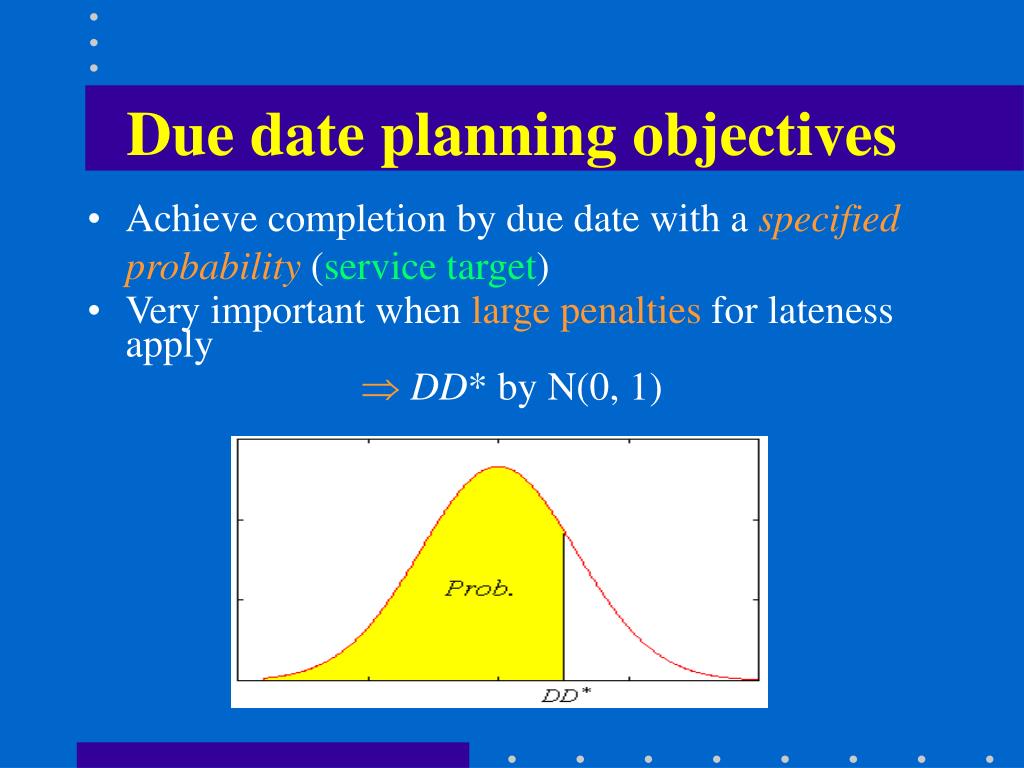

  18. Due date planning objectives • Achieve completion by due date with a specified probability (service target) • Very important when large penalties for lateness apply ÞDD* by N(0, 1)

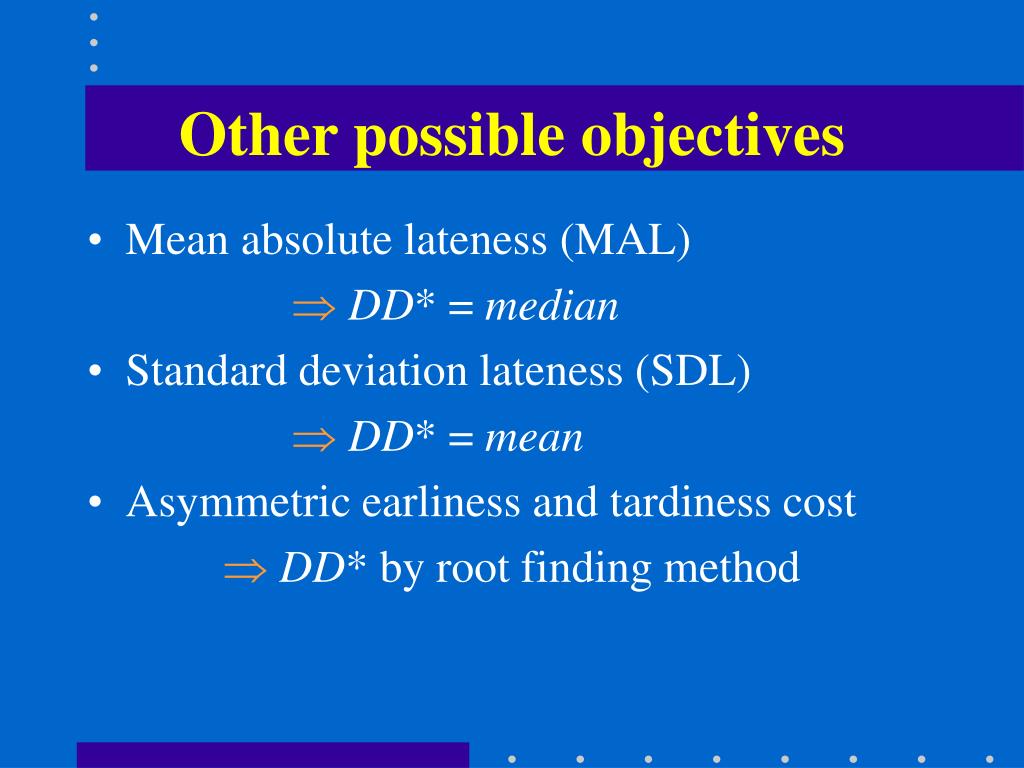

  19. Other possible objectives • Mean absolute lateness (MAL) ÞDD* = median • Standard deviation lateness (SDL) ÞDD* = mean • Asymmetric earliness and tardiness cost ÞDD* by root finding method

  20. Industrial Case Study • Product structure 17 components 17 components (Data from Parsons)

  21. System parameters setting • normal processing times • at stage 6: m =7days for 32 components, m =3.5 days for the other two. • at other stages : m=28 days • standard deviation: s= 0.1m • backwards scheduling based on mean data • planned start time: 0 for 32 components and 3.5 for other two.

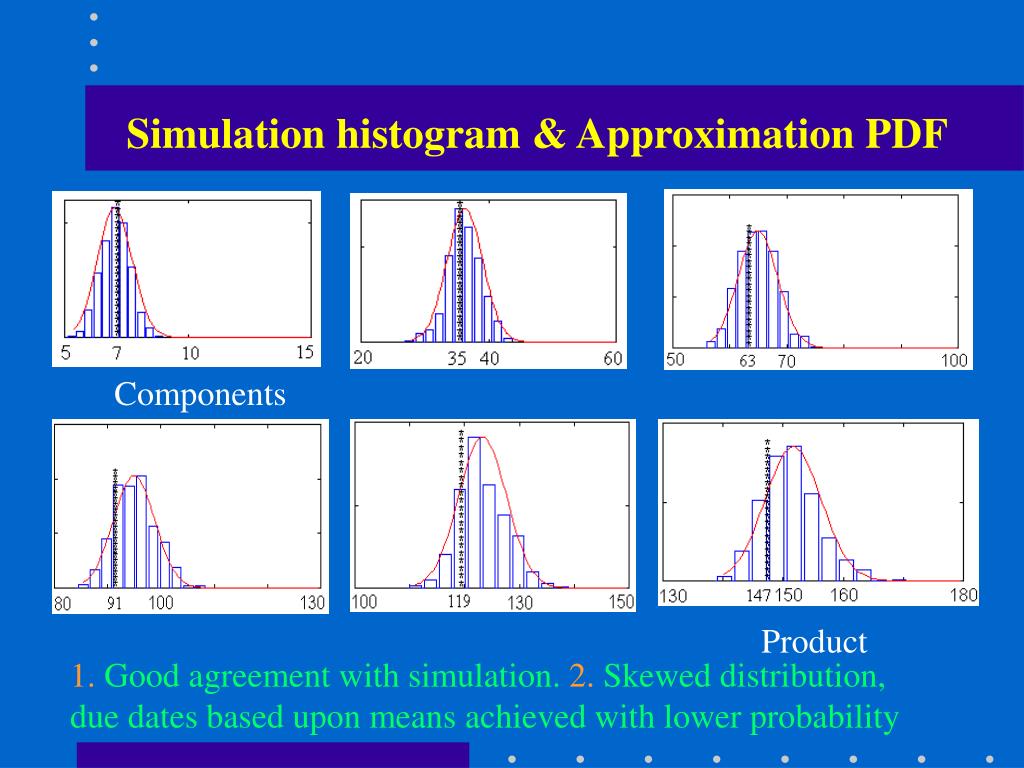

  22. Simulation histogram & Approximation PDF Components Product 1. Good agreement with simulation. 2. Skewed distribution, due dates based upon means achieved with lower probability

  23. Product due date • Simulation verification for product due date to achieve specified probability Days from component start time

  24. Stage due dates • Simulation verification for stage due dates to achieve 90% probability (by settting stage safety due dates)

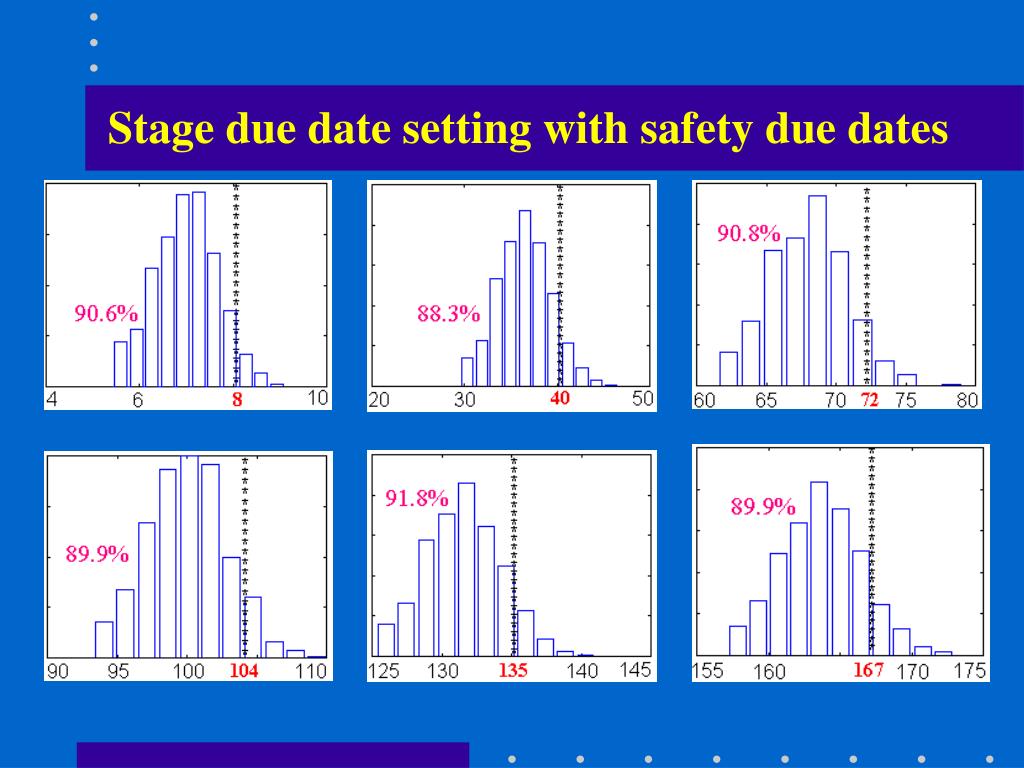

  25. Stage due date setting with safety due dates

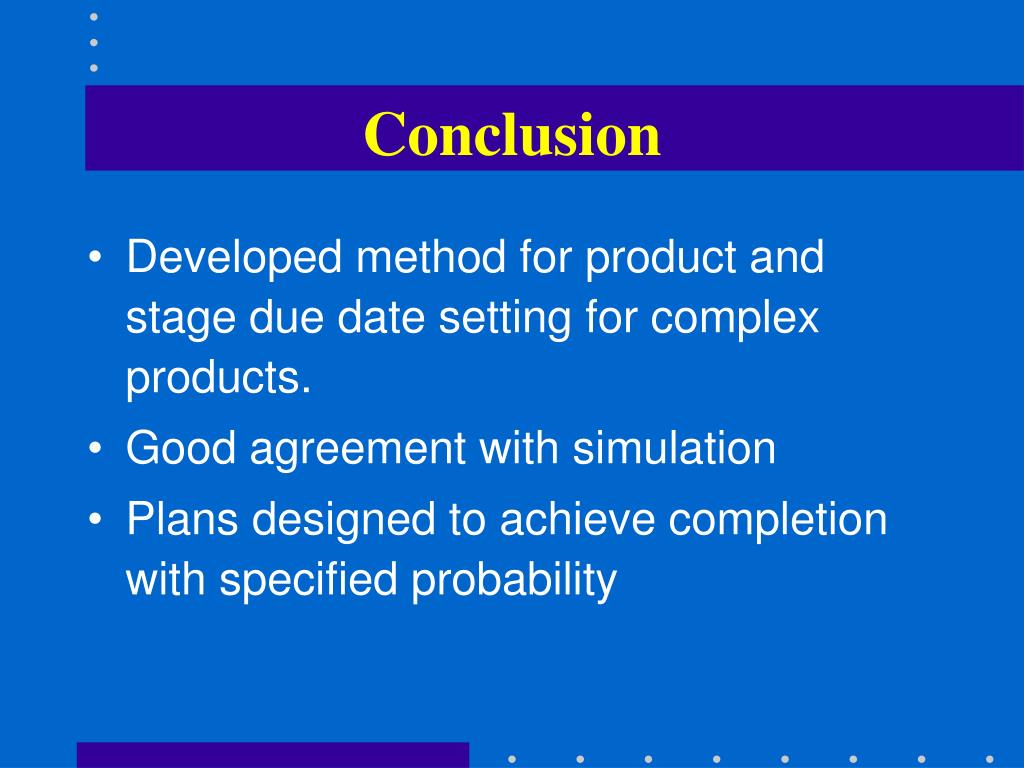

  26. Conclusion • Developed method for product and stage due date setting for complex products. • Good agreement with simulation • Plans designed to achieve completion with specified probability

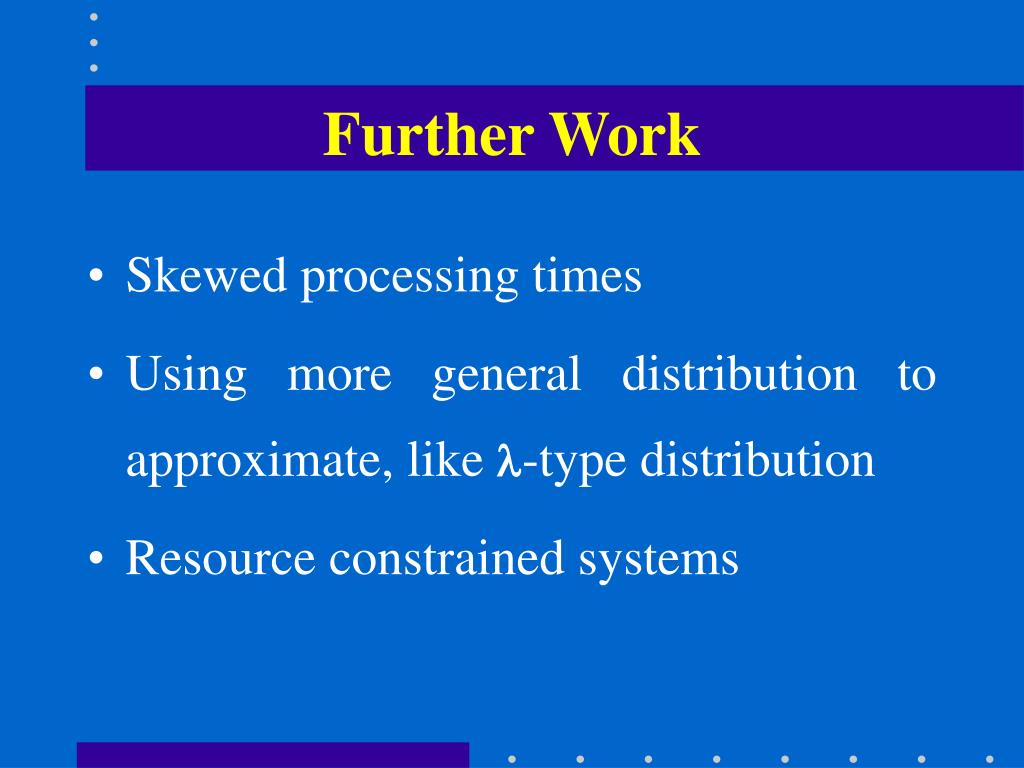

  27. Further Work • Skewed processing times • Using more general distribution to approximate, like l-type distribution • Resource constrained systems
