DO Timeline Split Silicon V2.0

DESCRIPTION

FPS. ICD. Lum (L0). South . North . C-layer. B-layer. Fiber Tracker Silicon Forward Muon Calorimeter Overall Installation = double shift assumed. DO Timeline Split Silicon V2.0.

1 / 11

Télécharger la présentation

DO Timeline Split Silicon V2.0

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

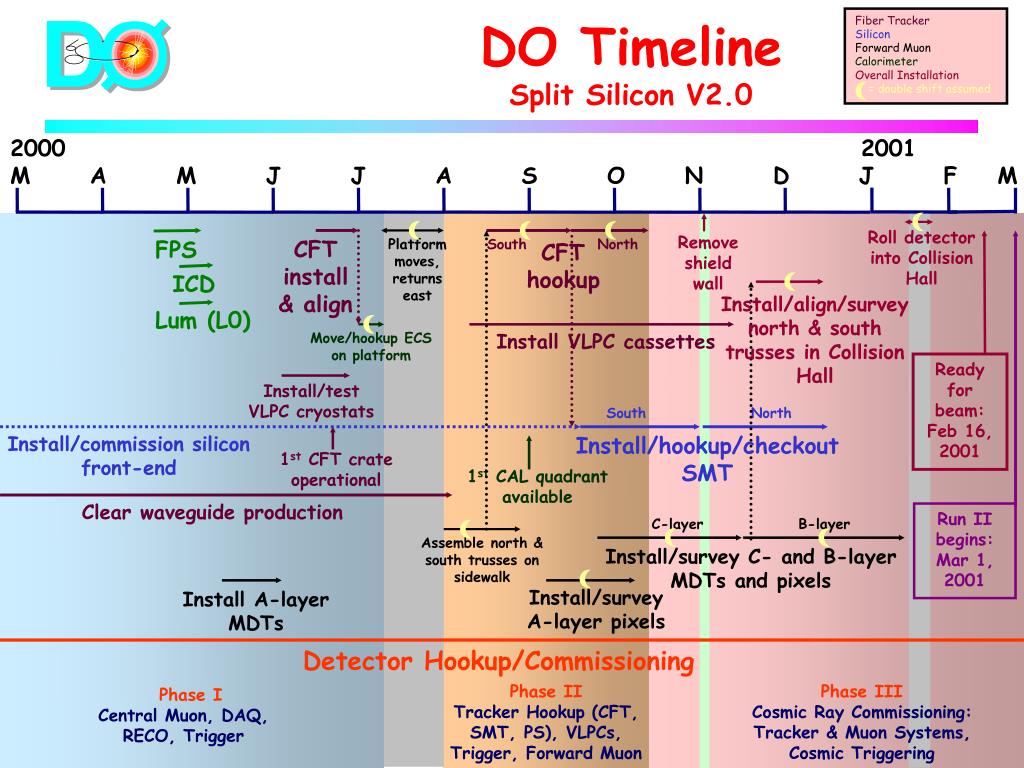

  1. FPS ICD Lum (L0) South North C-layer B-layer Fiber TrackerSiliconForward MuonCalorimeterOverall Installation= double shift assumed DO TimelineSplit Silicon V2.0 2000 2001 M A M J J A S O N D J F M Roll detector into Collision Hall Remove shield wall CFT install & align Platform moves, returns east South North CFT hookup Install/align/survey north & south trusses in Collision Hall Move/hookup ECS on platform Install VLPC cassettes Ready for beam: Feb 16, 2001 Install/test VLPC cryostats Install/commission silicon front-end Install/hookup/checkout SMT 1st CFT crate operational 1st CAL quadrant available Clear waveguide production Run II begins: Mar 1, 2001 Assemble north & south trusses on sidewalk Install/survey C- and B-layer MDTs and pixels Install/survey A-layer pixels Install A-layer MDTs Detector Hookup/Commissioning Phase II Tracker Hookup (CFT, SMT, PS), VLPCs, Trigger, Forward Muon Phase III Cosmic Ray Commissioning: Tracker & Muon Systems, Cosmic Triggering Phase I Central Muon, DAQ, RECO, Trigger

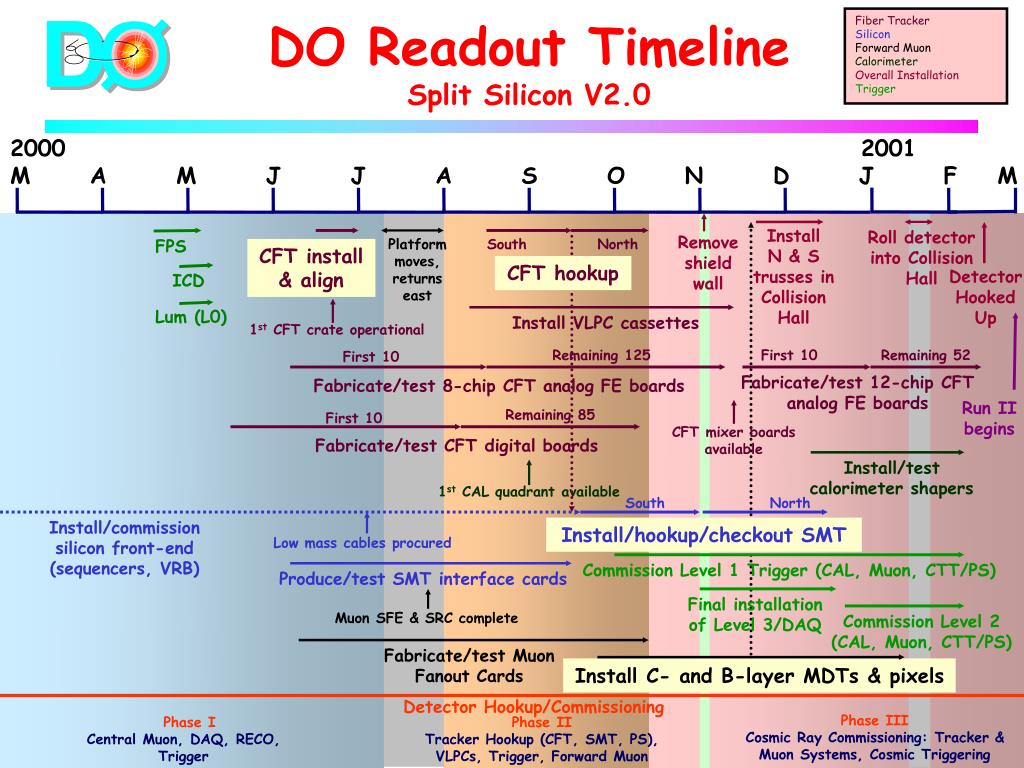

  2. First 10 Remaining 52 FPS ICD Lum (L0) Remaining 125 First 10 Remaining 85 First 10 South North Fiber TrackerSiliconForward MuonCalorimeterOverall InstallationTrigger DO Readout TimelineSplit Silicon V2.0 2000 2001 M A M J J A S O N D J F M Install N & S trusses in Collision Hall Roll detector into Collision Hall Remove shield wall Platform moves, returns east South North CFT install & align CFT hookup Detector Hooked Up Install VLPC cassettes 1st CFT crate operational Fabricate/test 12-chip CFT analog FE boards Fabricate/test 8-chip CFT analog FE boards Run II begins CFT mixer boards available Fabricate/test CFT digital boards Install/test calorimeter shapers 1st CAL quadrant available Install/commission silicon front-end (sequencers, VRB) Install/hookup/checkout SMT Low mass cables procured Commission Level 1 Trigger (CAL, Muon, CTT/PS) Produce/test SMT interface cards Final installation of Level 3/DAQ Muon SFE & SRC complete Commission Level 2 (CAL, Muon, CTT/PS) Fabricate/test Muon Fanout Cards Install C- and B-layer MDTs & pixels Detector Hookup/Commissioning Phase III Cosmic Ray Commissioning: Tracker & Muon Systems, Cosmic Triggering Phase I Central Muon, DAQ, RECO, Trigger Phase II Tracker Hookup (CFT, SMT, PS), VLPCs, Trigger, Forward Muon

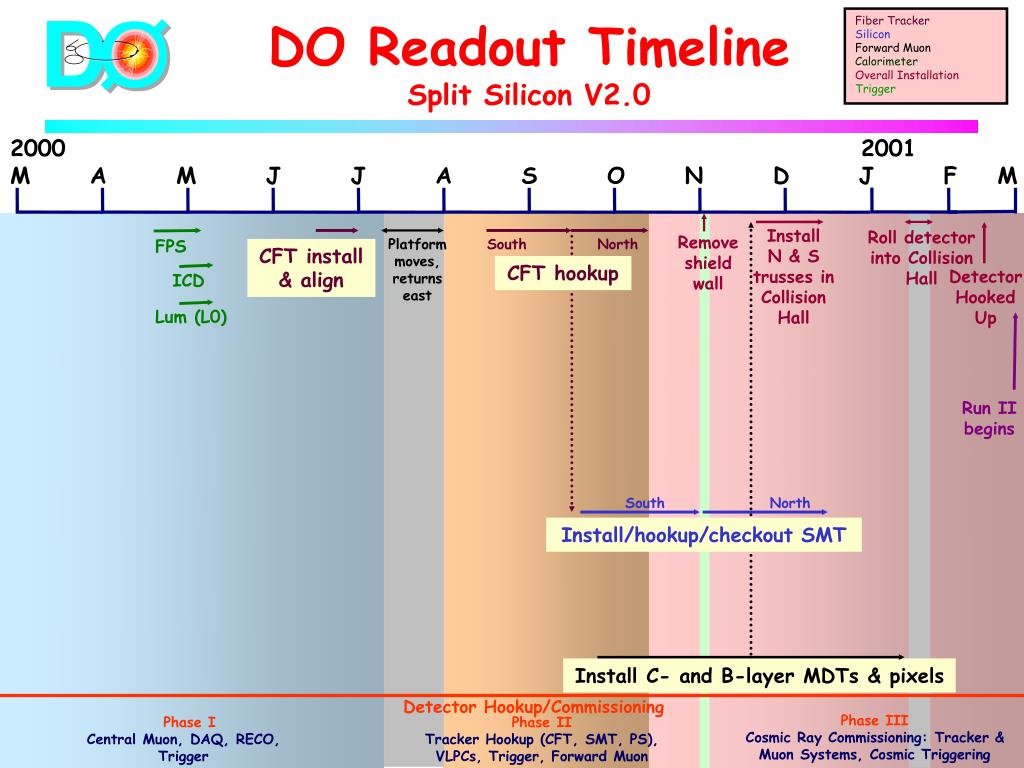

  3. FPS ICD Lum (L0) South North Fiber TrackerSiliconForward MuonCalorimeterOverall InstallationTrigger DO Readout TimelineSplit Silicon V2.0 2000 2001 M A M J J A S O N D J F M Install N & S trusses in Collision Hall Roll detector into Collision Hall Remove shield wall Platform moves, returns east South North CFT install & align CFT hookup Detector Hooked Up Run II begins Install/hookup/checkout SMT Install C- and B-layer MDTs & pixels Detector Hookup/Commissioning Phase III Cosmic Ray Commissioning: Tracker & Muon Systems, Cosmic Triggering Phase I Central Muon, DAQ, RECO, Trigger Phase II Tracker Hookup (CFT, SMT, PS), VLPCs, Trigger, Forward Muon

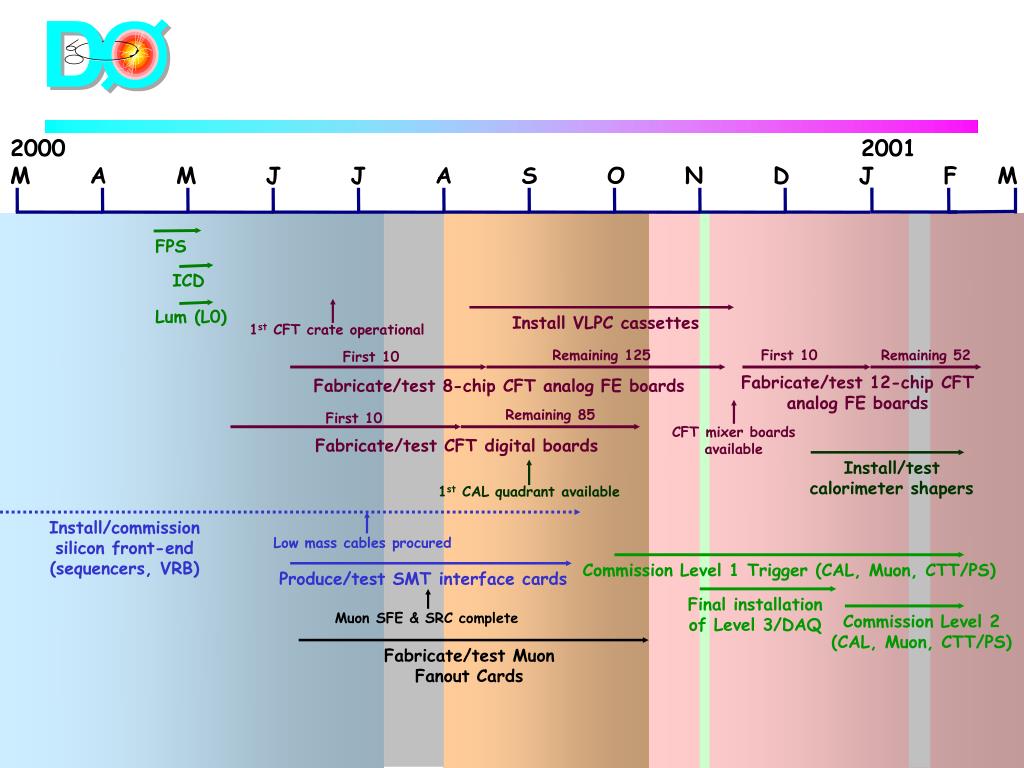

  4. First 10 Remaining 52 FPS ICD Lum (L0) Remaining 125 First 10 Remaining 85 First 10 2000 2001 M A M J J A S O N D J F M Install VLPC cassettes 1st CFT crate operational Fabricate/test 12-chip CFT analog FE boards Fabricate/test 8-chip CFT analog FE boards CFT mixer boards available Fabricate/test CFT digital FE boards Install/test calorimeter shapers 1st CAL quadrant available Install/commission silicon front-end (sequencers, VRB) Low mass cables procured Commission Level 1 Trigger (CAL, Muon, CTT/PS) Produce/test SMT interface cards Final installation of Level 3/DAQ Muon SFE & SRC complete Commission Level 2 (CAL, Muon, CTT/PS) Fabricate/test Muon Fanout Cards

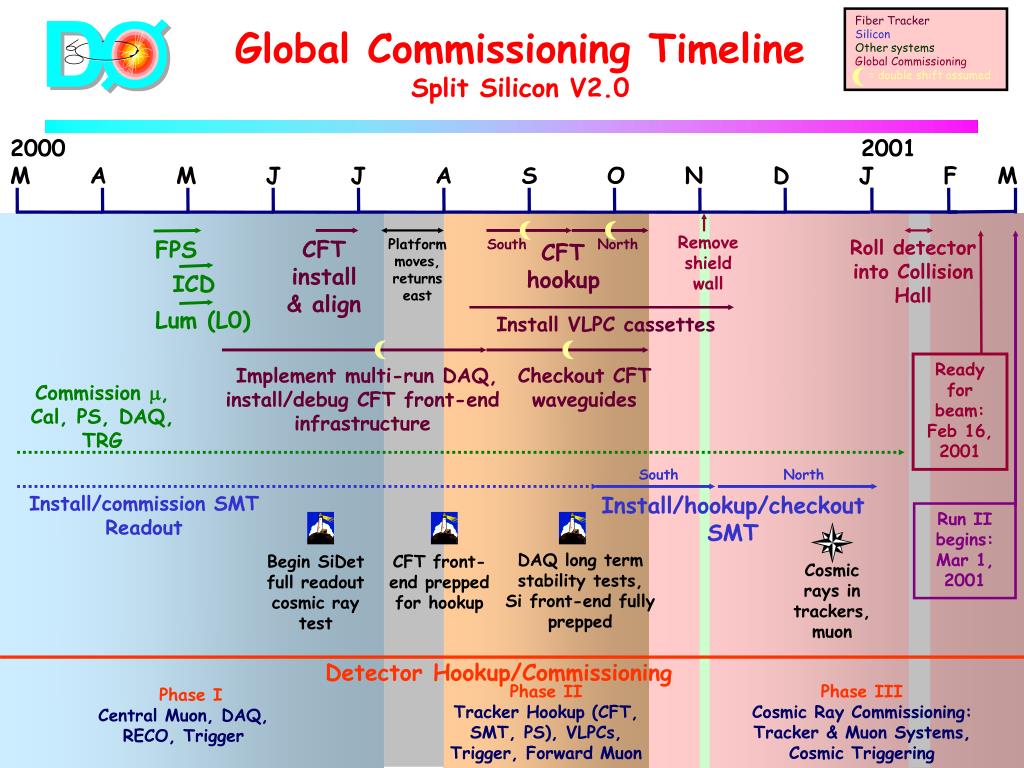

  5. FPS ICD Lum (L0) South North Fiber TrackerSiliconOther systemsGlobal Commissioning= double shift assumed Global Commissioning TimelineSplit Silicon V2.0 2000 2001 M A M J J A S O N D J F M Remove shield wall CFT install & align Platform moves, returns east South North Roll detector into Collision Hall CFT hookup Install VLPC cassettes Ready for beam: Feb 16, 2001 Implement multi-run DAQ, install/debug CFT front-end infrastructure Checkout CFT waveguides Commission m, Cal, PS, DAQ, TRG Install/commission SMT Readout Install/hookup/checkout SMT Run II begins: Mar 1, 2001 DAQ long term stability tests, Si front-end fully prepped Begin SiDet full readout cosmic ray test CFT front-end prepped for hookup Cosmic rays in trackers, muon Detector Hookup/Commissioning Phase II Tracker Hookup (CFT, SMT, PS), VLPCs, Trigger, Forward Muon Phase III Cosmic Ray Commissioning: Tracker & Muon Systems, Cosmic Triggering Phase I Central Muon, DAQ, RECO, Trigger

  6. = task complete = partially complete Major Installation Activities April – June, 2000 April May June July Collision Wall down – Hi Bay full survey survey Collision Wall back up Collision Wall down Install/align CFT Move ECS onto platform: hookup cryo, survey Install gas/cooling lines in Collision Hall Solenoid Test survey Modify/install solenoid mounts, re-survey Install CFT cable ductwork in platform survey Platform moves(to July 28) Install/commission VLPC cryostats in platform End detectors installed (FPS, ICD, L0) survey Survey east PDTs Rework/reassemble shielding mid-pieces Rework EF shielding pieces survey Move truss tops to Hi Bay Stage/survey N/S shielding in Hi Bay Forward Muon Installation Move south truss bottom to Hi Bay, re-weld arms survey Install both EF shields • Crane needed • Platform occupied • ICR occupied • CF closed; no cal preamp access Assemble A-layer north pixel plane on shield wall survey Install/load test C-layer MDT & pixel mounts Install N/S A-layer MDTs

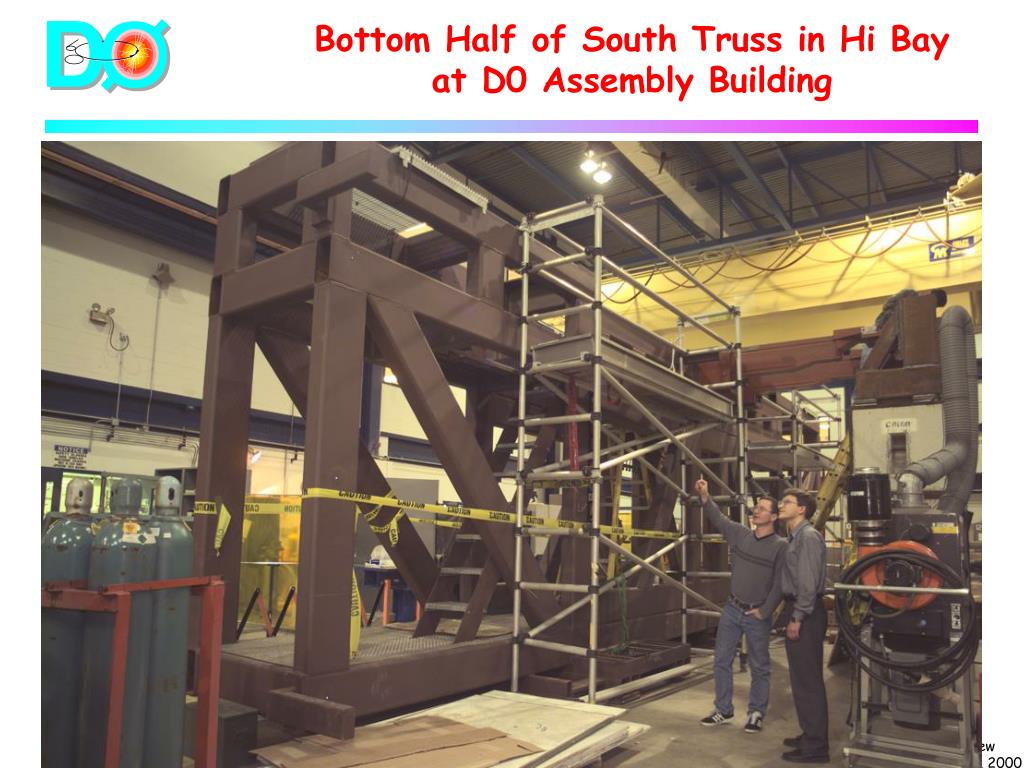

  7. Bottom Half of South Truss in Hi Bay at D0 Assembly Building

  8. Commissioning Status(cont’d) 2 calorimeter crates Offline Data Storage WEB Catalogue Online Event Monitoring

  9. Commissioning Contact Personnel

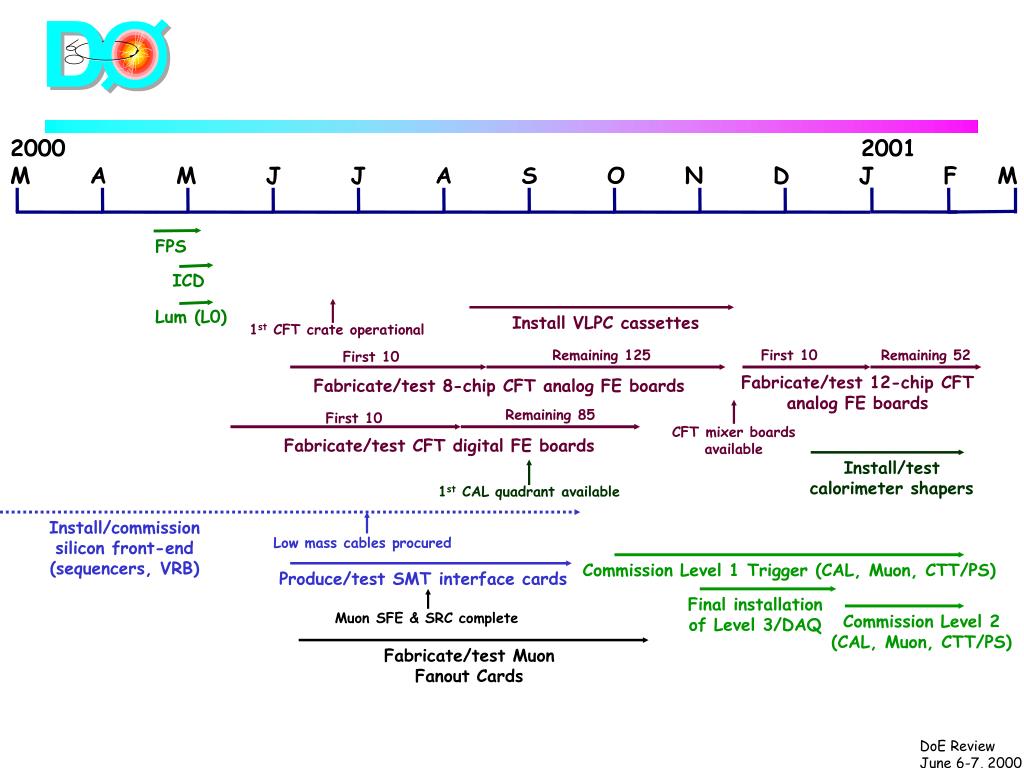

  10. First 10 Remaining 52 FPS ICD Lum (L0) Remaining 125 First 10 Remaining 85 First 10 2000 2001 M A M J J A S O N D J F M Install VLPC cassettes 1st CFT crate operational Fabricate/test 12-chip CFT analog FE boards Fabricate/test 8-chip CFT analog FE boards CFT mixer boards available Fabricate/test CFT digital boards Install/test calorimeter shapers 1st CAL quadrant available Install/commission silicon front-end (sequencers, VRB) Low mass cables procured Commission Level 1 Trigger (CAL, Muon, CTT/PS) Produce/test SMT interface cards Final installation of Level 3/DAQ Muon SFE & SRC complete Commission Level 2 (CAL, Muon, CTT/PS) Fabricate/test Muon Fanout Cards

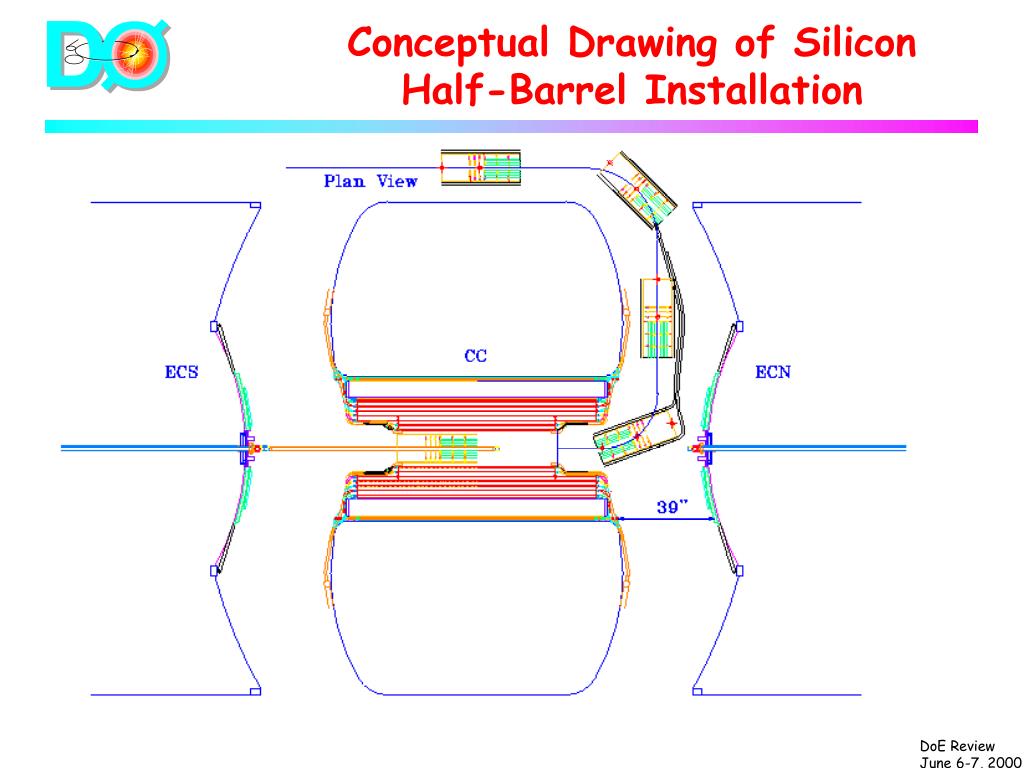

  11. Conceptual Drawing of Silicon Half-Barrel Installation
