1 / 8

2013 Project Priority List (PPL) Update

2013 Project Priority List (PPL) Update. February 20, 2013. 2013 PPL Update – Agenda. Project Portfolio Update Summary of 2/7 TAC Discussion 2013 Release Targets 2013 Target Start Dates Retail Project Review SCR756 – Remaining MarkeTrak Enhancements

ianthe
Télécharger la présentation

2013 Project Priority List (PPL) Update

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. 2013 Project Priority List (PPL) Update February 20, 2013

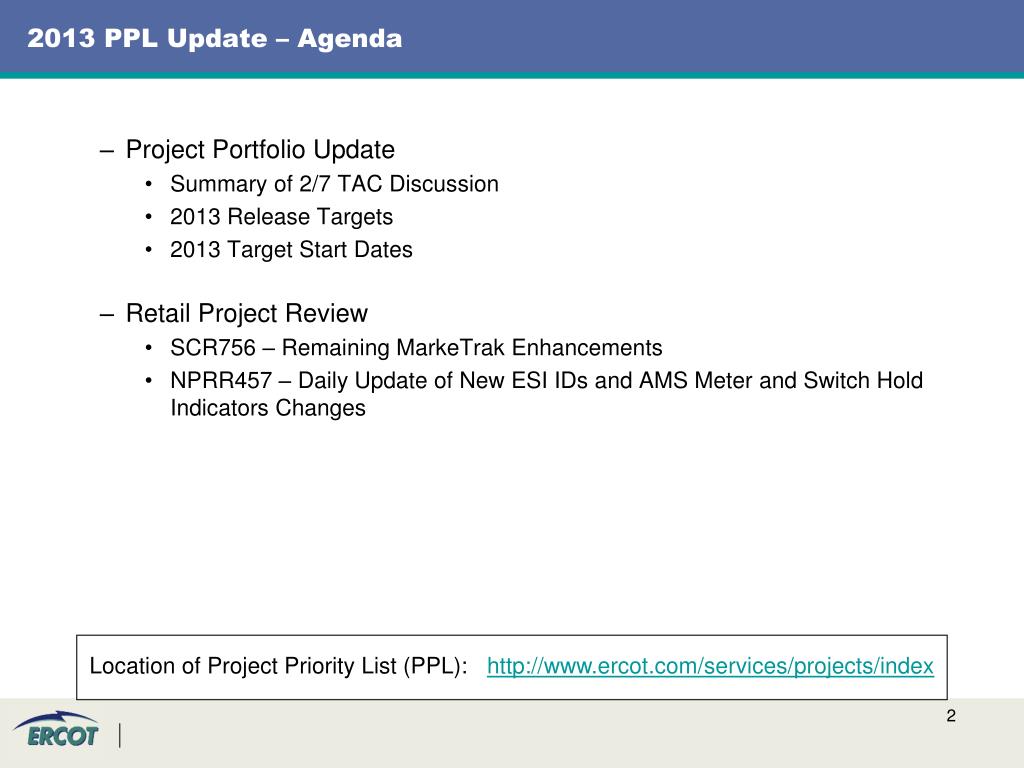

  2. 2013 PPL Update – Agenda • Project Portfolio Update • Summary of 2/7 TAC Discussion • 2013 Release Targets • 2013 Target Start Dates • Retail Project Review • SCR756 – Remaining MarkeTrak Enhancements • NPRR457 – Daily Update of New ESI IDs and AMS Meter and Switch Hold Indicators Changes Location of Project Priority List (PPL): http://www.ercot.com/services/projects/index

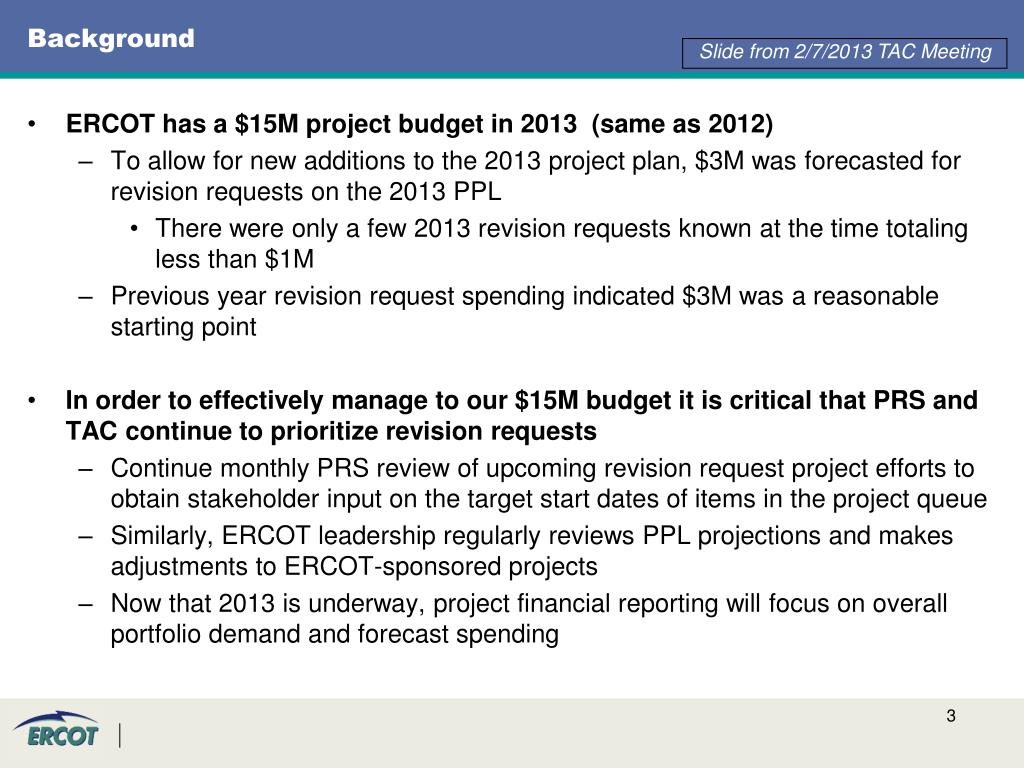

  3. Background Slide from 2/7/2013 TAC Meeting • ERCOT has a $15M project budget in 2013 (same as 2012) • To allow for new additions to the 2013 project plan, $3M was forecastedfor revision requests on the 2013 PPL • There were only a few 2013 revision requests known at the time totaling less than $1M • Previous year revision request spending indicated $3M was a reasonable starting point • In order to effectively manage to our $15M budget it is critical that PRS and TAC continue to prioritize revision requests • Continue monthly PRS review of upcoming revision request project efforts to obtain stakeholder input on the target start dates of items in the project queue • Similarly, ERCOT leadership regularly reviews PPL projections and makes adjustments to ERCOT-sponsored projects • Now that 2013 is underway, project financial reporting will focus on overall portfolio demand and forecast spending

  4. Moving Forward… ERCOT Recommendations Slide from 2/7/2013 TAC Meeting • The next slide (#5) shows 2013 forecast spending and includes: • Projects that are in flight • Projects that are planned to start in 2013 • Slide 6 shows the planned Start Dates for revision requests that are “Not Started” • A forecast variance based on historical trends

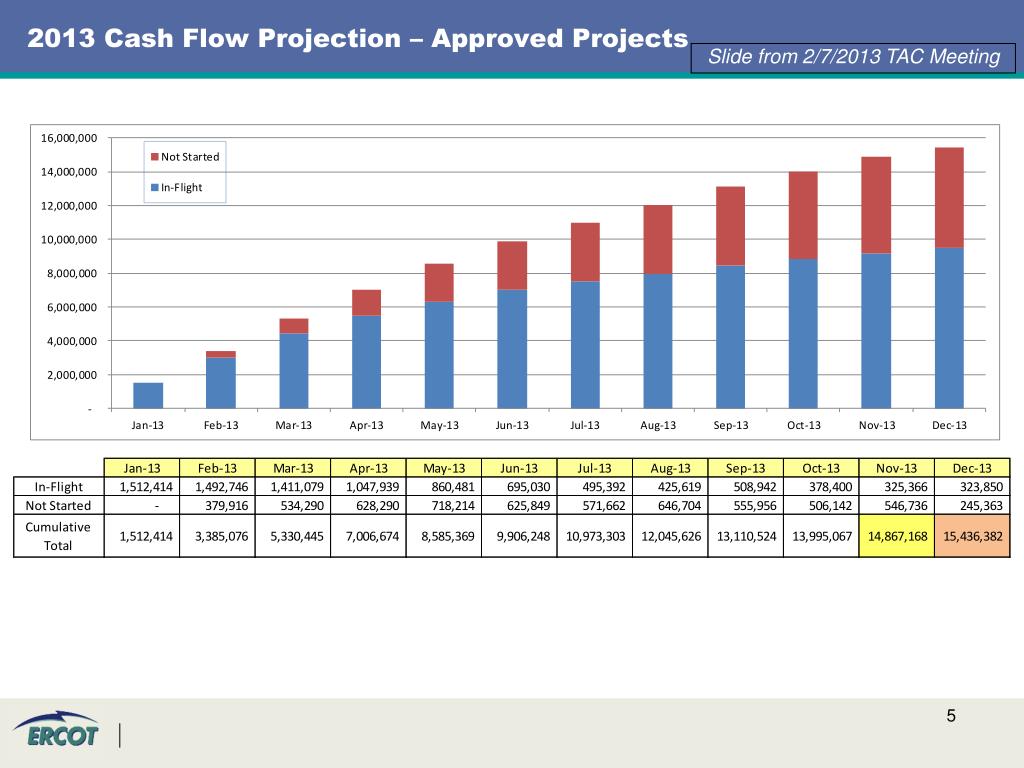

  5. 2013 Cash Flow Projection – Approved Projects Slide from 2/7/2013 TAC Meeting

  6. Approved Revision Requests “Not Started” – Planned to Start in 2013 Moved Start from Apr 2013 Moved Start from Apr 2013 Moved Start from Jun 2013 Moved Start from Mar 2013 ERCOT requests your input: Are these the most important revision requests to work on in 2013?

  7. ERCOT Public 2013 Release Targets – Board-Approved NPRRs/SCRs/xGRRs 2014 None None None None None None (a), (b), etc. indicates multiple release phases Red Text: New additions and target release changes Go-live dates can differ from Protocol effective dates – Please refer to market notices for more details Strike-Through Text: Previous target release changes Release targets are subject to change

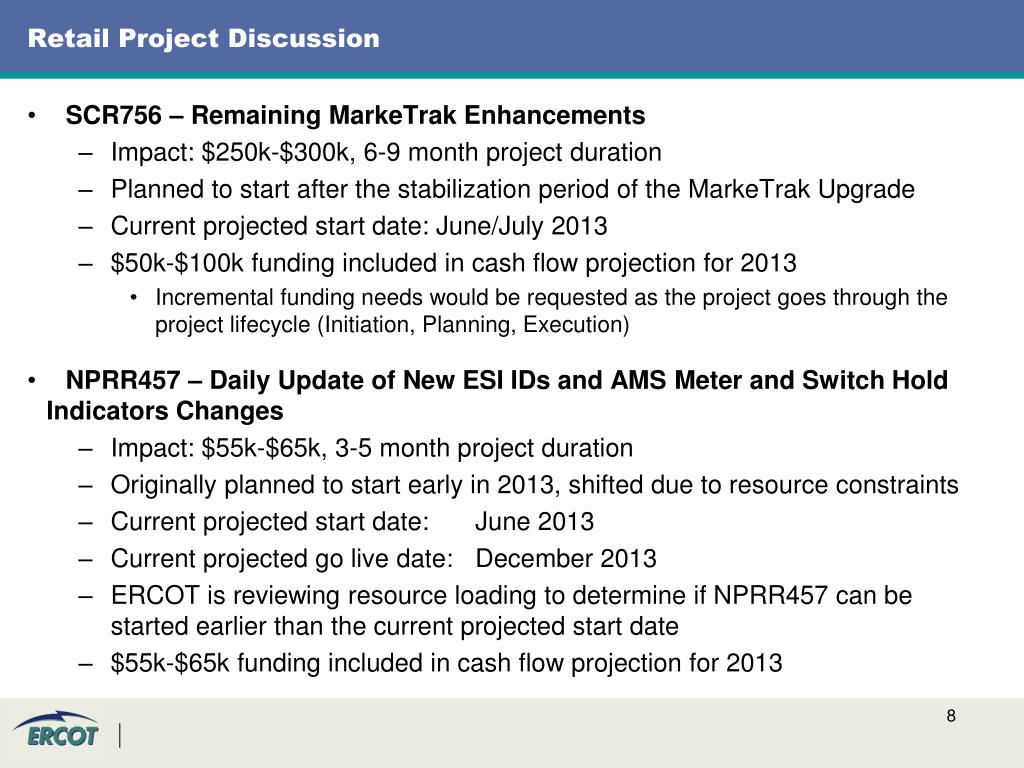

  8. Retail Project Discussion • SCR756 – Remaining MarkeTrak Enhancements • Impact: $250k-$300k, 6-9 month project duration • Planned to start after the stabilization period of the MarkeTrak Upgrade • Current projected start date: June/July 2013 • $50k-$100k funding included in cash flow projection for 2013 • Incremental funding needs would be requested as the project goes through the project lifecycle (Initiation, Planning, Execution) • NPRR457 – Daily Update of New ESI IDs and AMS Meter and Switch Hold Indicators Changes • Impact: $55k-$65k, 3-5 month project duration • Originally planned to start early in 2013, shifted due to resource constraints • Current projected start date: June 2013 • Current projected go live date: December 2013 • ERCOT is reviewing resource loading to determine if NPRR457 can be started earlier than the current projected start date • $55k-$65k funding included in cash flow projection for 2013

More Related
