TrackAlert A Short-Range Emergency Tracking System
430 likes | 559 Vues
This project presents a short-range emergency tracking system designed to monitor individuals who require constant supervision, such as small children and those with mental disabilities, including autism. The system utilizes a lightweight GPS device that operates within a 1-mile radius, sending real-time location data to a web application accessible via any internet-enabled device. An RFID alarm system alerts caretakers when the individual leaves the designated perimeter. This innovative solution aims to enhance safety, providing families and institutions peace of mind through effective supervision.
TrackAlert A Short-Range Emergency Tracking System
E N D
Presentation Transcript
TrackAlertA Short-Range Emergency Tracking System Group 14 Melissa Grenier Carlos Gonzalez Gina McGhee Sainjulien Senatus
Project Description • A tracking system that can track a person within at least a 1 mile radius • The person will be wearing a traceable GPS device that communicates with a stationary base station • The device’s location will be available through a web application accessible through a computer and/or handheld internet-enabled device • RFID will be used as an alarm system to alert the base station when the person has left the perimeter (home)

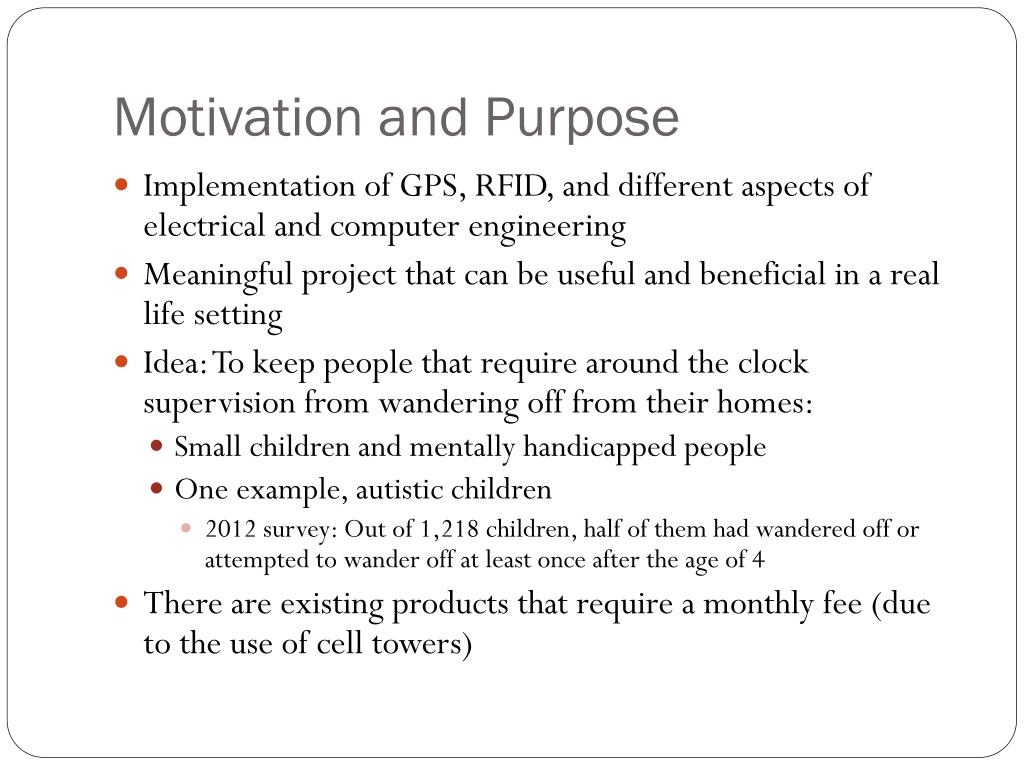

Motivation and Purpose • Implementation of GPS, RFID, and different aspects of electrical and computer engineering • Meaningful project that can be useful and beneficial in a real life setting • Idea: To keep people that require around the clock supervision from wandering off from their homes: • Small children and mentally handicapped people • One example, autistic children • 2012 survey: Out of 1,218 children, half of them had wandered off or attempted to wander off at least once after the age of 4 • There are existing products that require a monthly fee (due to the use of cell towers)

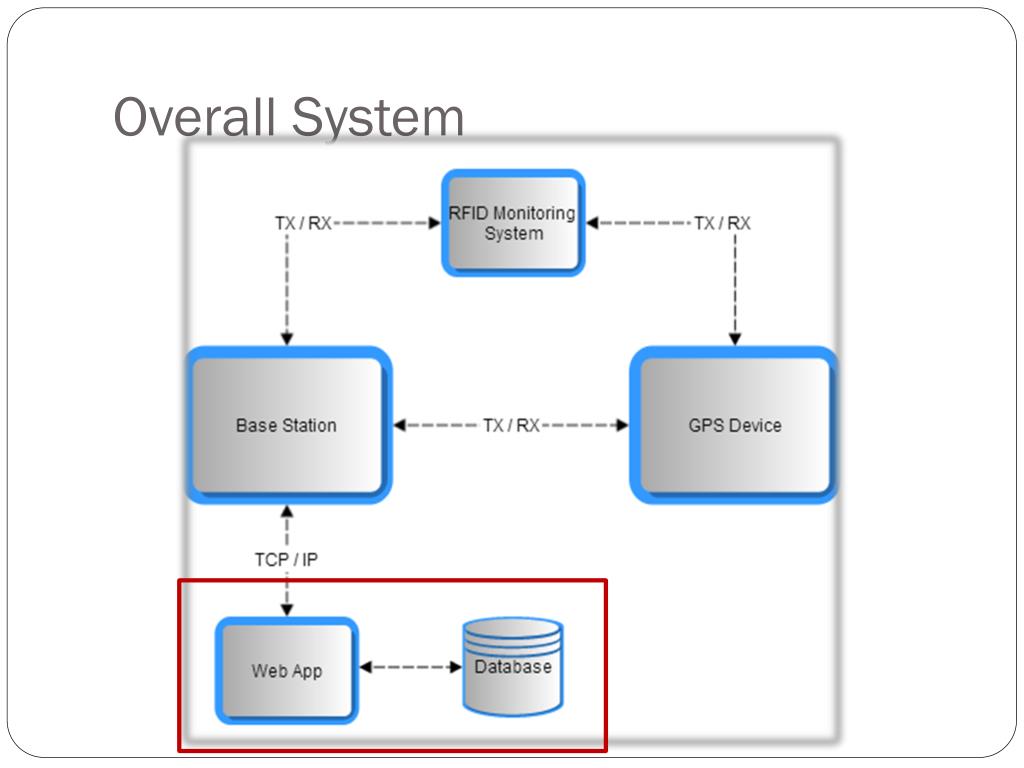

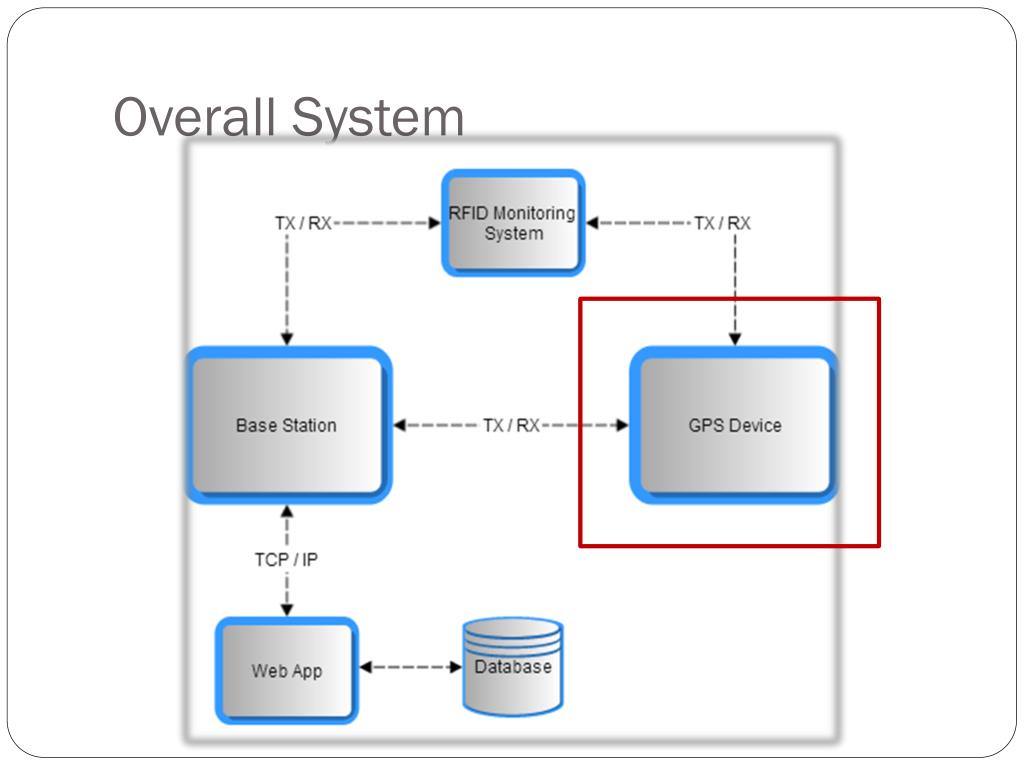

Goals and Objectives Families with small children or mentally handicapped relatives Daycares Mental Institutions GPS Device Lightweight Low On Power Consumption Easily carried (even by a child) Long battery life RFID System Act as an alarm monitoring system Alert base station when and which GPS device leaves the house Web Application Easy to use user interface Available from any device that has internet connectivity Host multiple users simultaneously Be able to display GPS location on a map Base Station Communicate with more than one GPS device Communicate with device up to a 1 mile distance Receive messages from RFID system Communicate with web app
GPS Device • LS20031 Module • Embedded Antenna • Up to 66 satellites at time • Build-in battery • 3.3V • 42mA • Operating Temperature • 14g • Dimensions (mm)

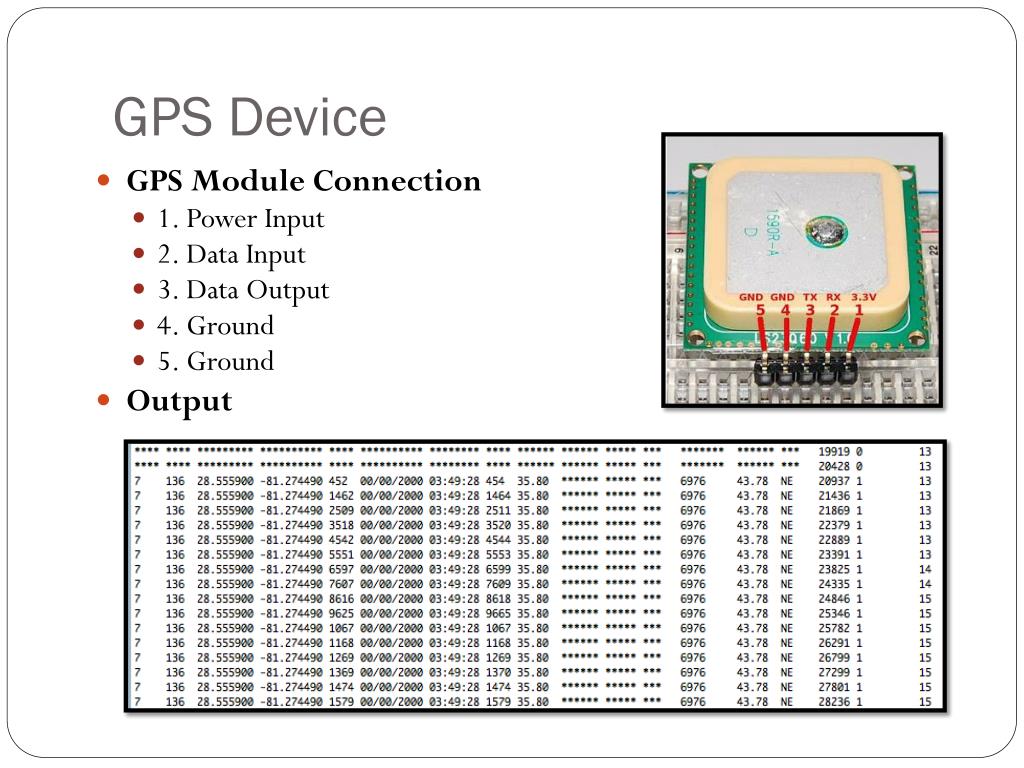

GPS Device • GPS Module Connection • 1. Power Input • 2. Data Input • 3. Data Output • 4. Ground • 5. Ground • Output

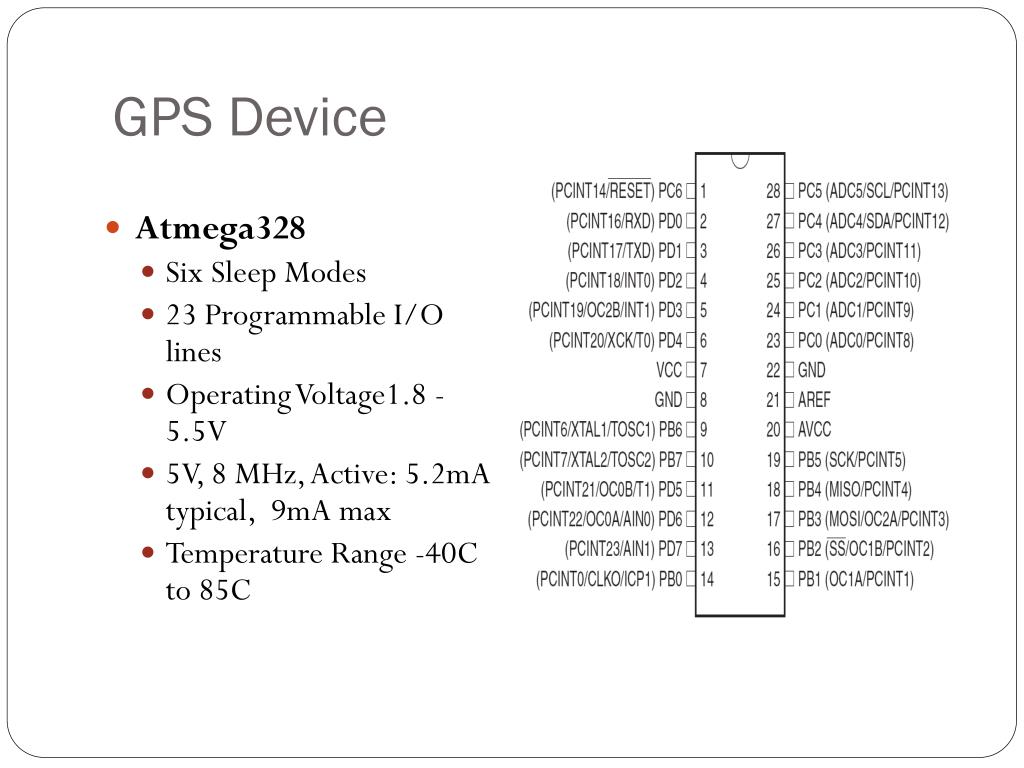

GPS Device • Atmega328 • Six Sleep Modes • 23 Programmable I/O lines • Operating Voltage1.8 -5.5V • 5V, 8 MHz, Active: 5.2mA typical, 9mA max • Temperature Range -40C to 85C
GPS Device • LCD Character Display • Personal Information • Odometer • High Quality 16x2 • 3.3V Power Supply • 1.5mA • Operating Temperature 0C to 50C • Size: 8.6 x 36 x 80mm
GPS Device • Rechargeable Battery • Polymer Lithium Ion Battery • 3.7V at 2000mAh • Temperature • Weight: 36g • Size:5.8x54x60mm

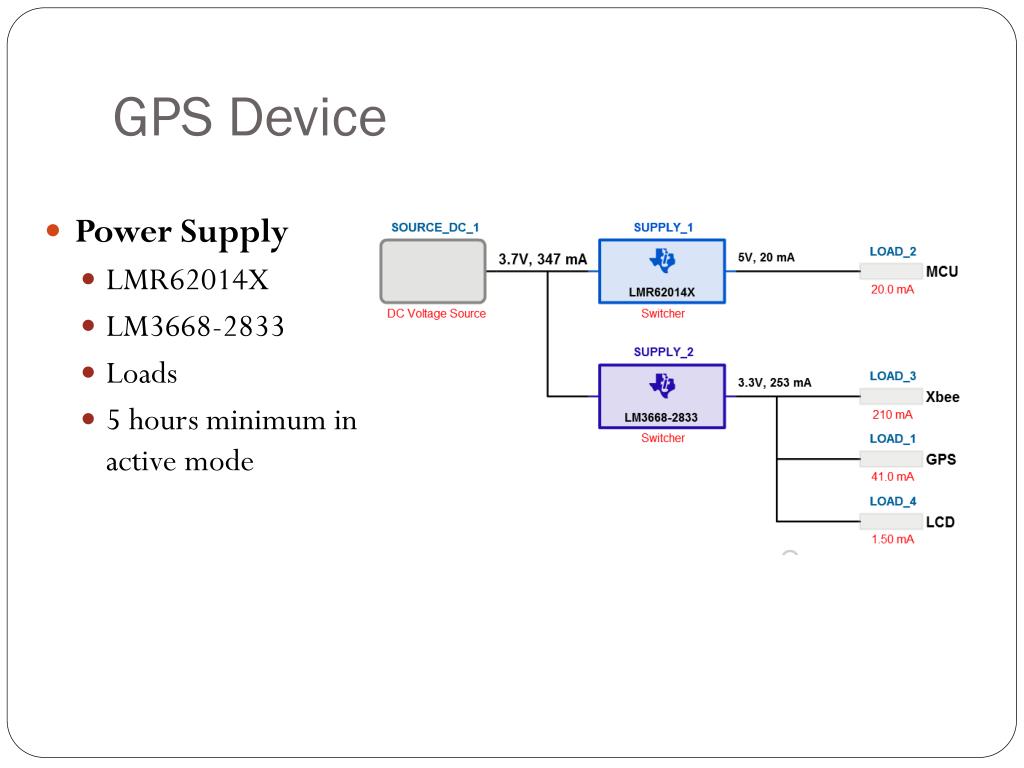

GPS Device • Power Supply • LMR62014X • LM3668-2833 • Loads • 5 hours minimum in active mode

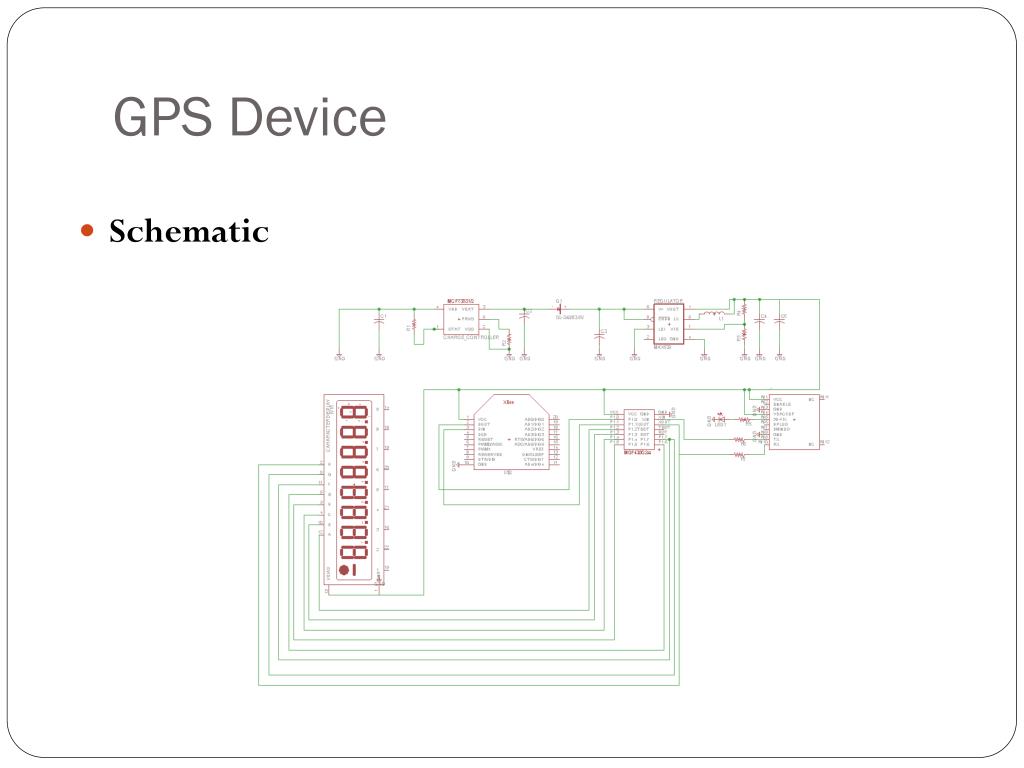

GPS Device • Schematic
Electrical schematic • 12 volts (source) • 3 voltage regulators (LM2574). These voltage regulators will be placed in parallel in order to have the same 12 volts as input. • 3.3 VDC (MCU) • 5 VDC (Reader) • 3.3 VDC (Xbee)

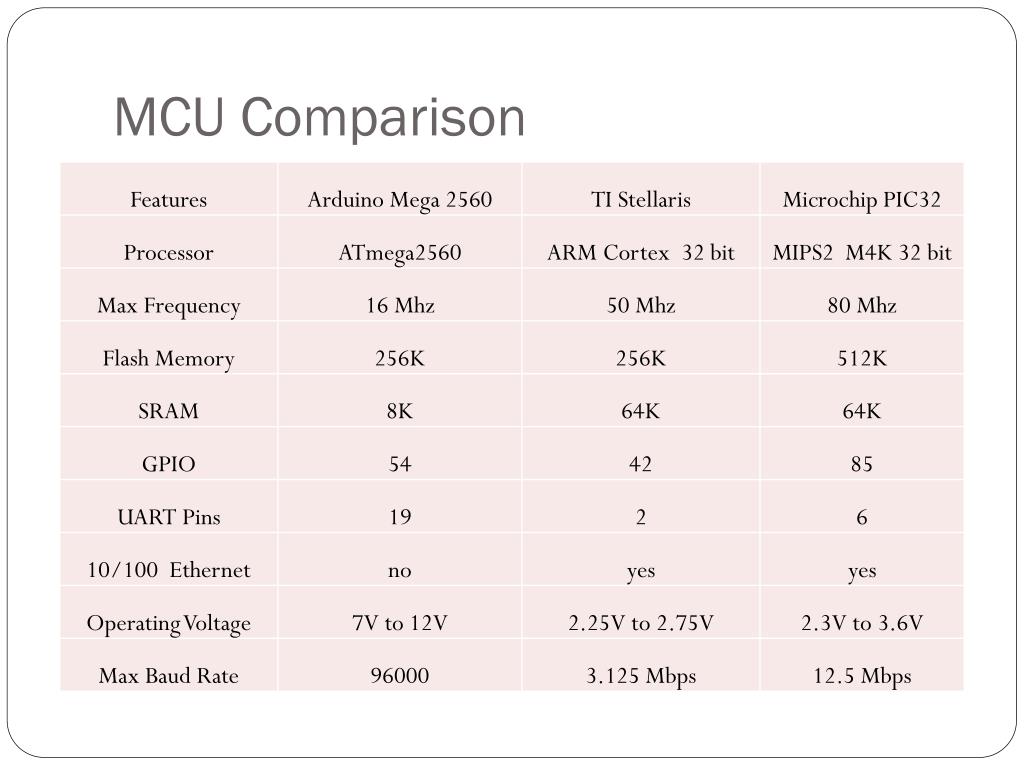

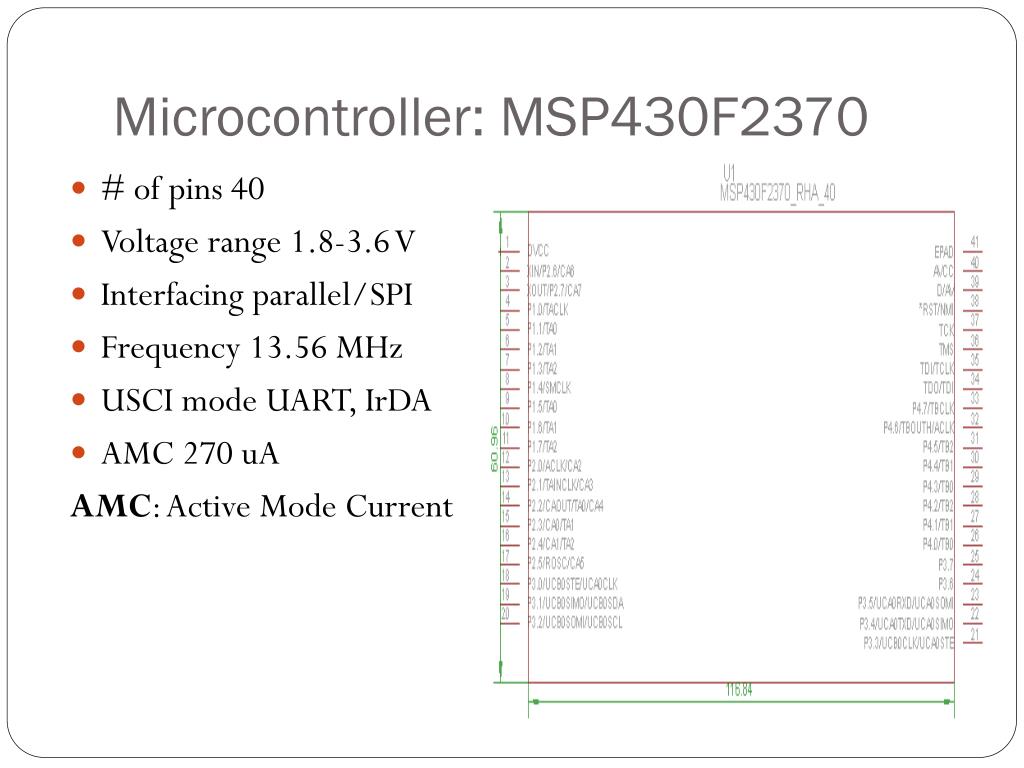

Microcontroller: MSP430F2370 • # of pins 40 • Voltage range 1.8-3.6 V • Interfacing parallel/SPI • Frequency 13.56 MHz • USCI mode UART, IrDA • AMC 270 uA AMC: Active Mode Current

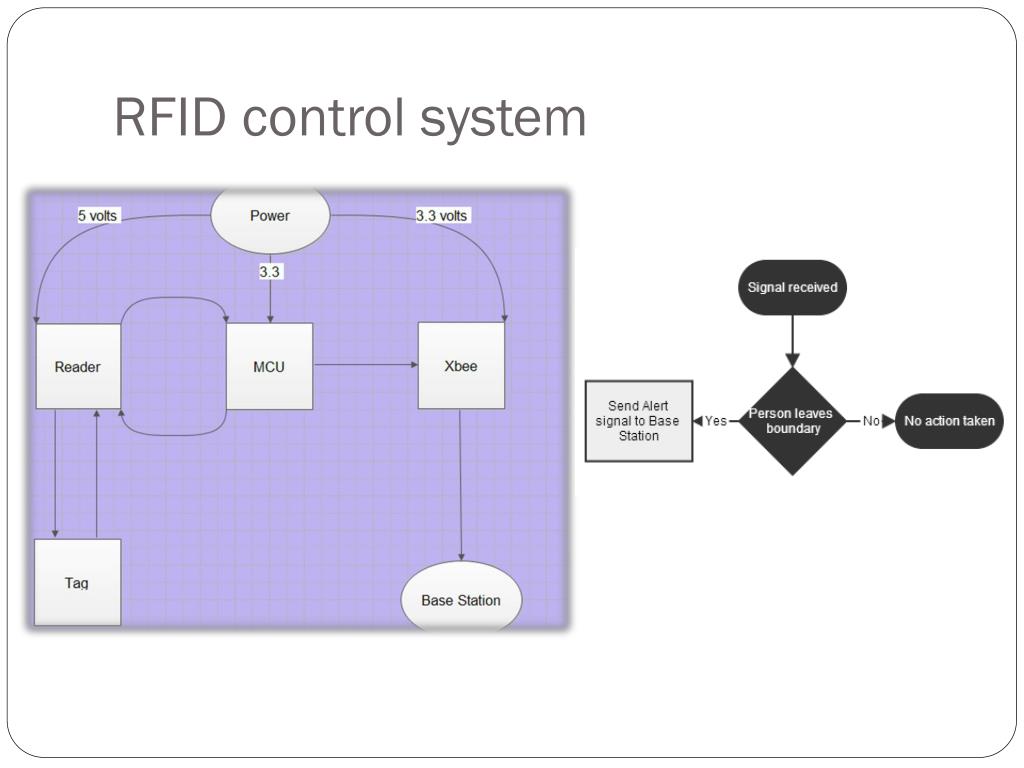

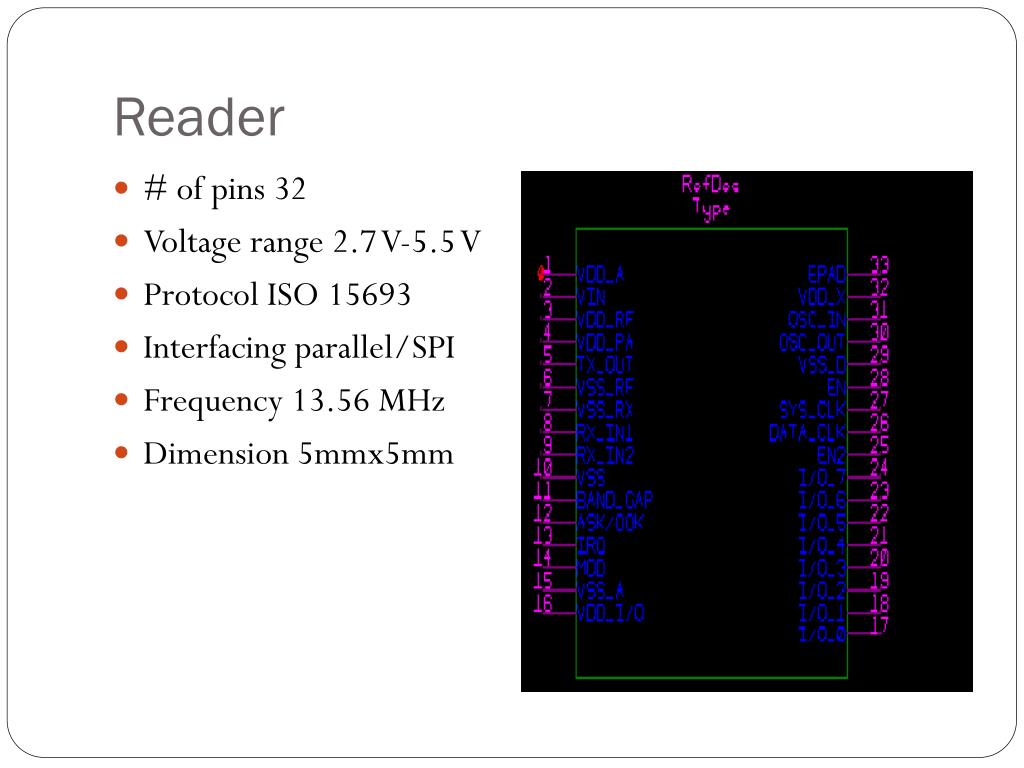

Reader • # of pins 32 • Voltage range 2.7 V-5.5 V • Protocol ISO 15693 • Interfacing parallel/SPI • Frequency 13.56 MHz • Dimension 5mmx5mm

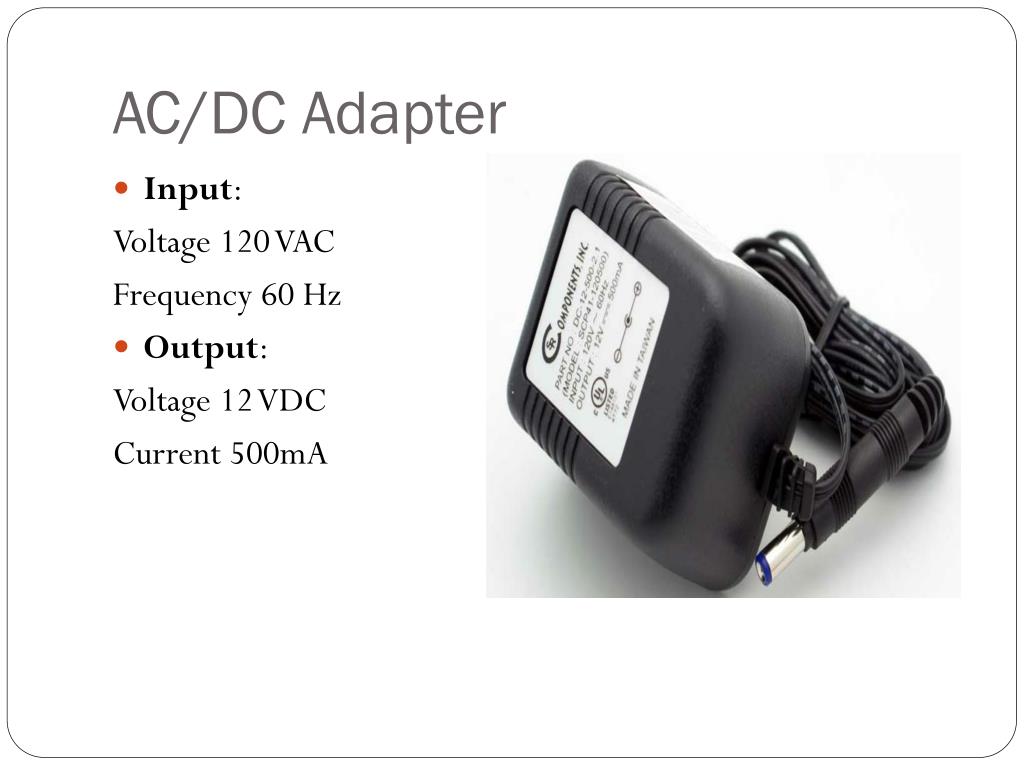

AC/DC Adapter • Input: Voltage 120 VAC Frequency 60 Hz • Output: Voltage 12 VDC Current 500mA
MCU Necessities • UART Connectivity • Baud Rate Variability • TCP/IP Stack Integration • 10/100 Ethernet MAC/PHY

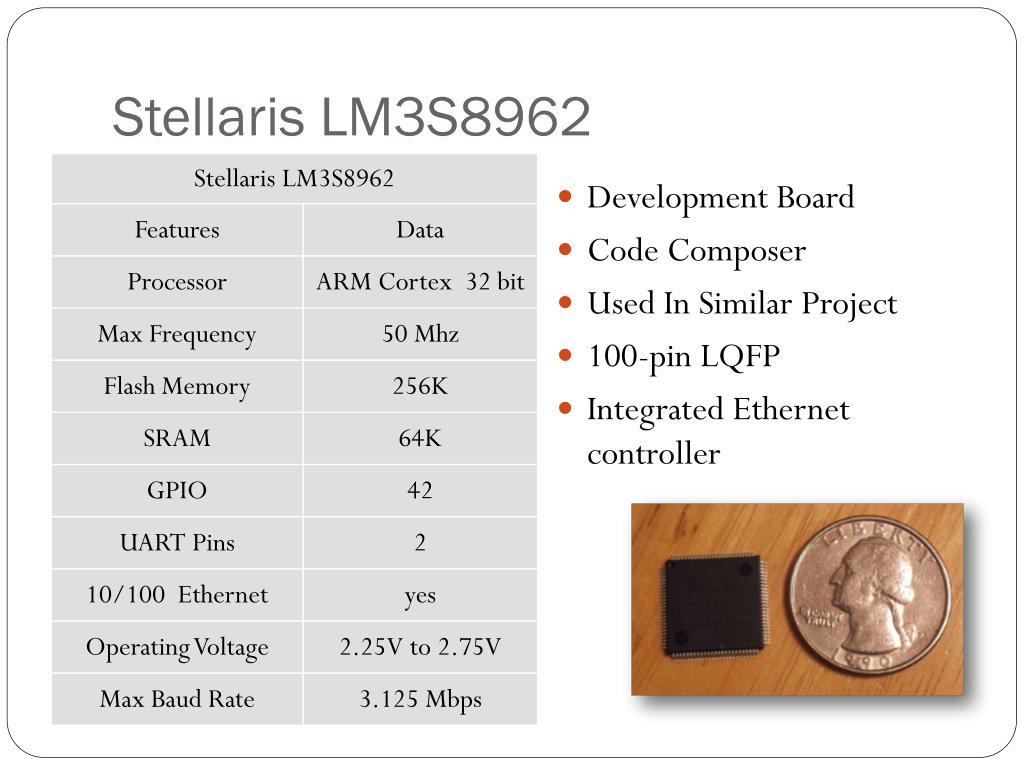

Stellaris LM3S8962 Development Board Code Composer Used In Similar Project 100-pin LQFP Integrated Ethernet controller

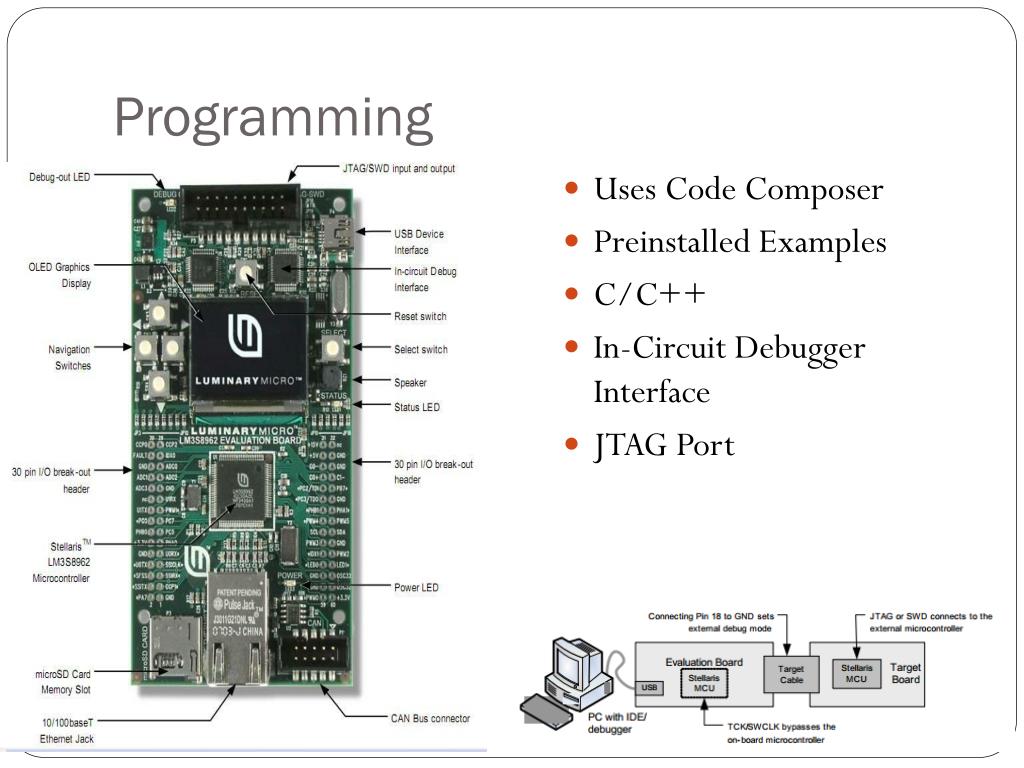

Programming Uses Code Composer Preinstalled Examples C/C++ In-Circuit Debugger Interface JTAG Port

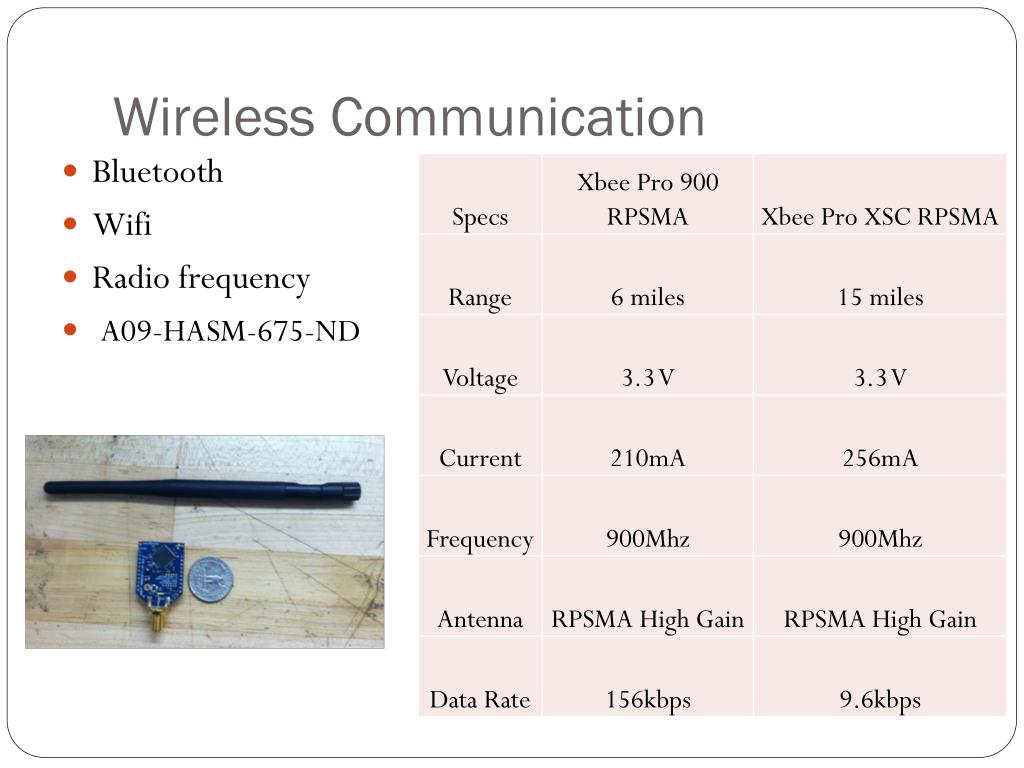

Wireless Communication Bluetooth Wifi Radio frequency A09-HASM-675-ND
Display System • 16x2 character LCD • 3.3V power supply • Yellow LED Backlight • 5x8 dot characters • 11 general I/O pin interface • 1/16 duty cycle • Dimensions: 0.34 x 1.4 x 3.2" (8.6 x 36 x 80mm)
Power Supply • 9V AC/DC Adapter • 1A Output Current • TPS6215X /TPS560200 • DC-DC Step Down Converter
Database • Looking for: • Scalability • Security • Low Maintenance • Reliability • Low Complexity Level

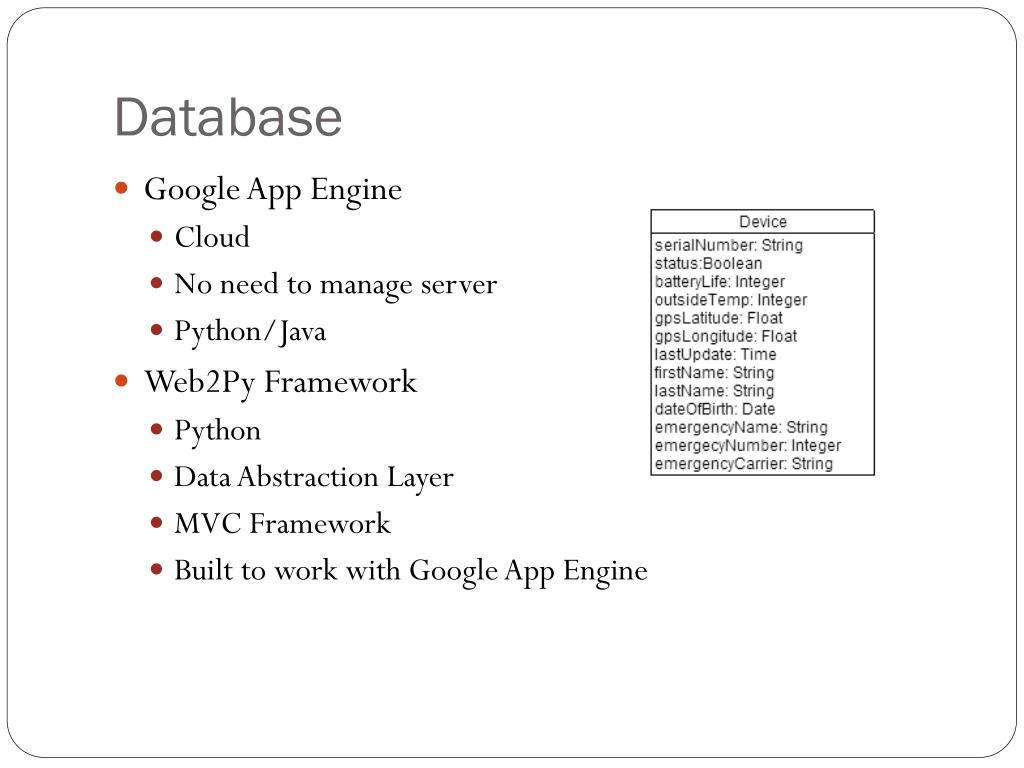

Database • Google App Engine • Cloud • No need to manage server • Python/Java • Web2Py Framework • Python • Data Abstraction Layer • MVC Framework • Built to work with Google App Engine

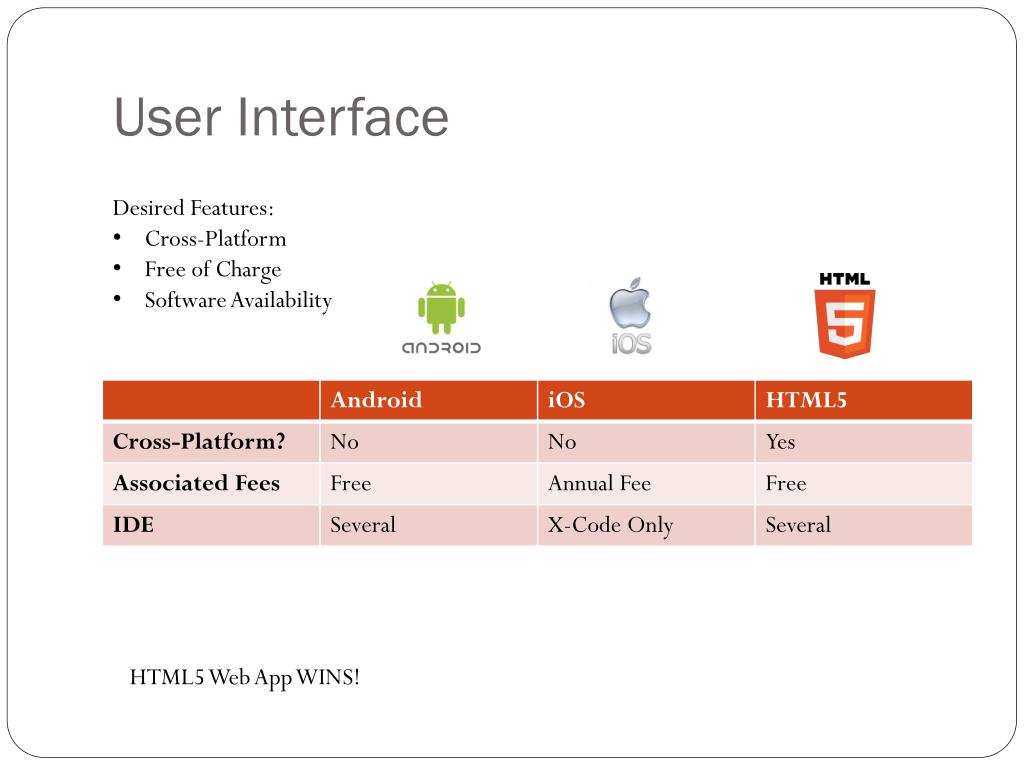

User Interface • Desired Features: • Cross-Platform • Free of Charge • Software Availability HTML5 Web App WINS!

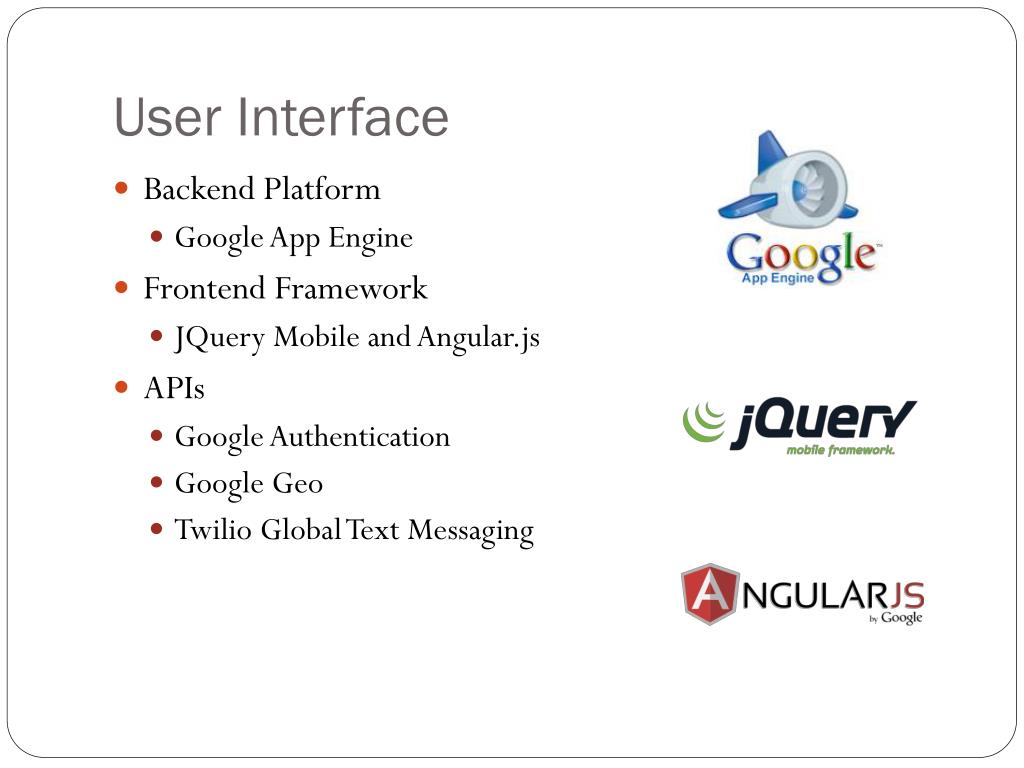

User Interface • Backend Platform • Google App Engine • Frontend Framework • JQuery Mobile and Angular.js • APIs • Google Authentication • Google Geo • Twilio Global Text Messaging

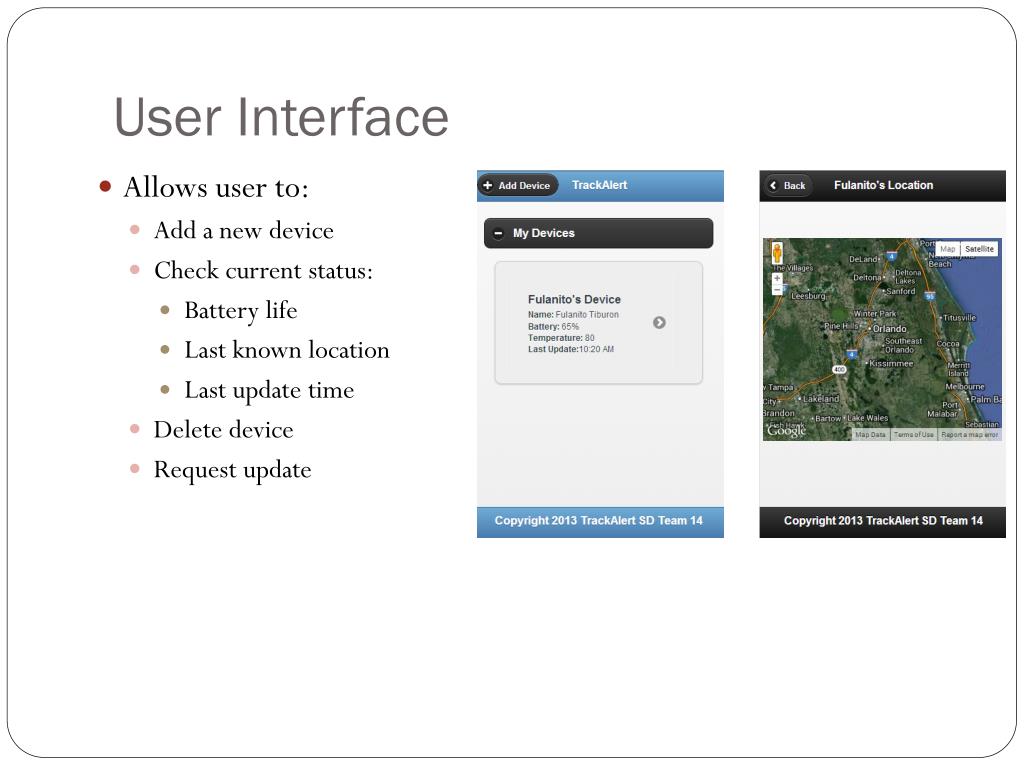

User Interface • Allows user to: • Add a new device • Check current status: • Battery life • Last known location • Last update time • Delete device • Request update

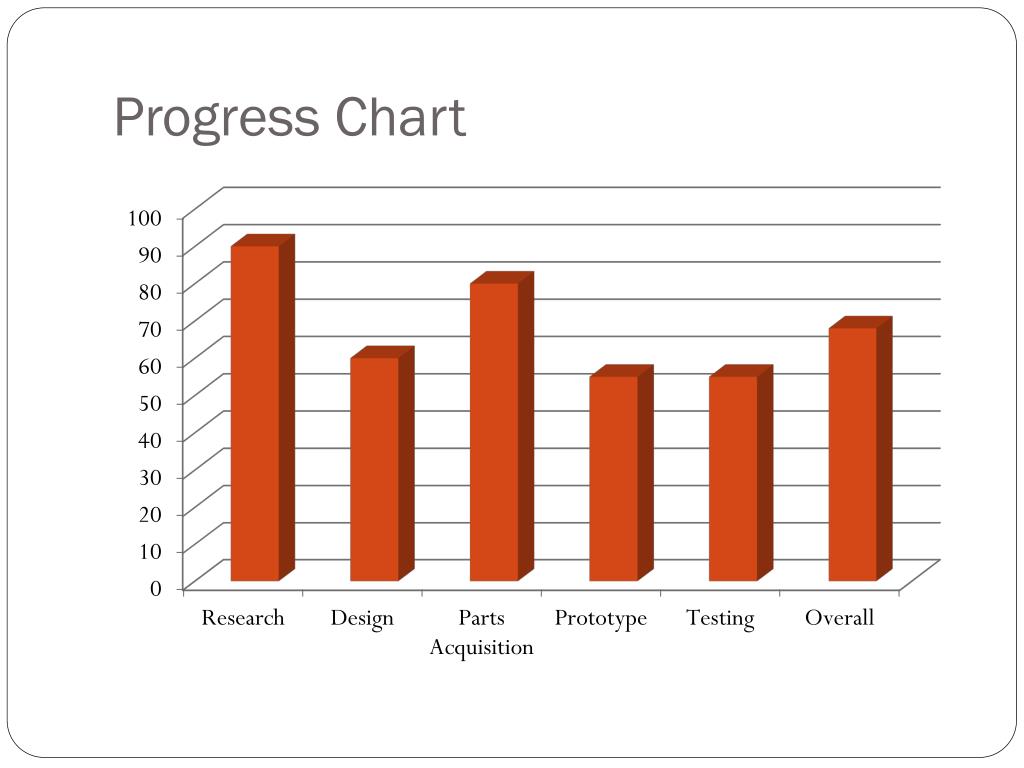

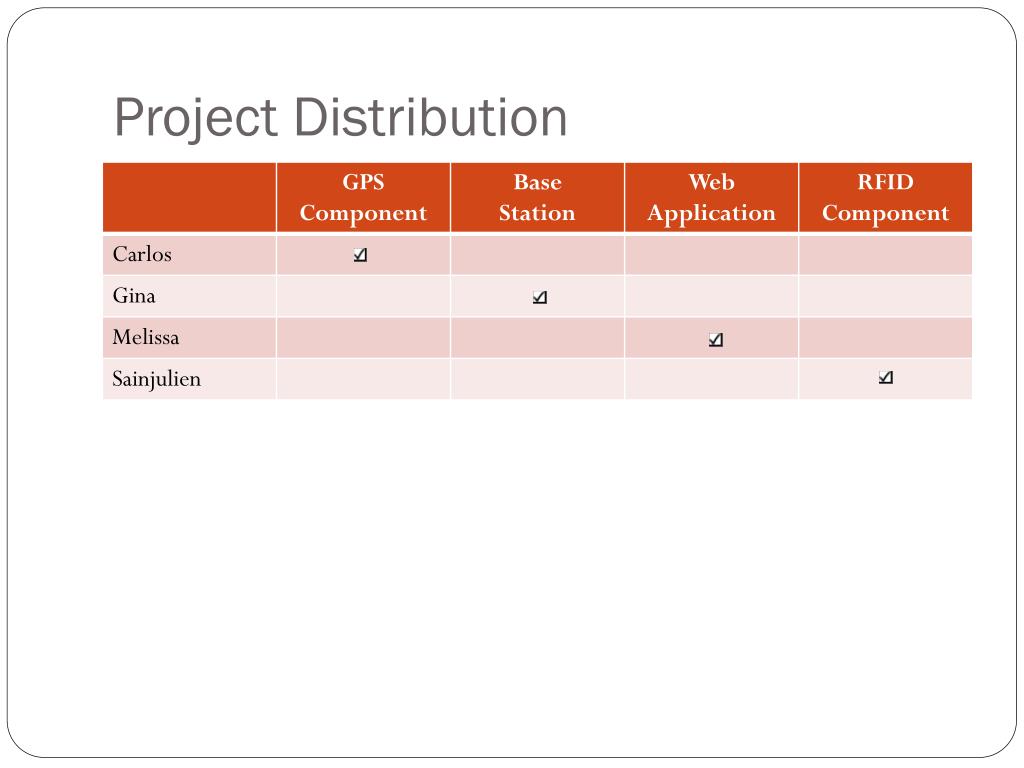

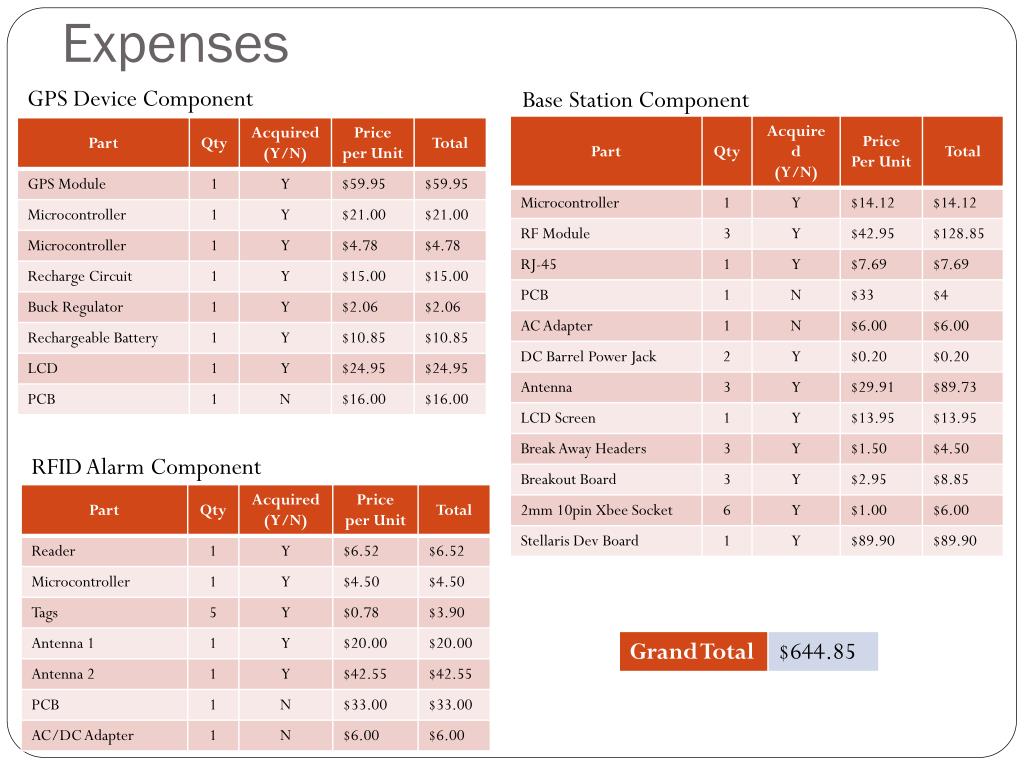

Expenses GPS Device Component Base Station Component RFID Alarm Component
Issues and Concerns • Soldering • Programming • Range (possibly, based on research) • GPS boot up time takes a while • PCB Layout
