Nodal Program Update

Nodal Program Update. Technical Advisory Committee 2 September 2010. Agenda. Program Status LFC Test Overview Certification Updates Cut-Over Certification – Primer for Remaining Systems. Integrated Nodal Timeline – Go-Live December 1, 2010.

irma-sharpe
Télécharger la présentation

Nodal Program Update

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Nodal Program Update Technical Advisory Committee 2 September 2010

  2. Agenda • Program Status • LFC Test Overview • Certification Updates • Cut-Over Certification – Primer for Remaining Systems Technical Advisory Committee

  3. Integrated Nodal Timeline – Go-Live December 1, 2010 Technical Advisory Committee

  4. 2010 Market Trials Timeline – Go-Live December 1, 2010 Technical Advisory Committee

  5. 2010 Cut Over Timeline – 4 month outlook Technical Advisory Committee

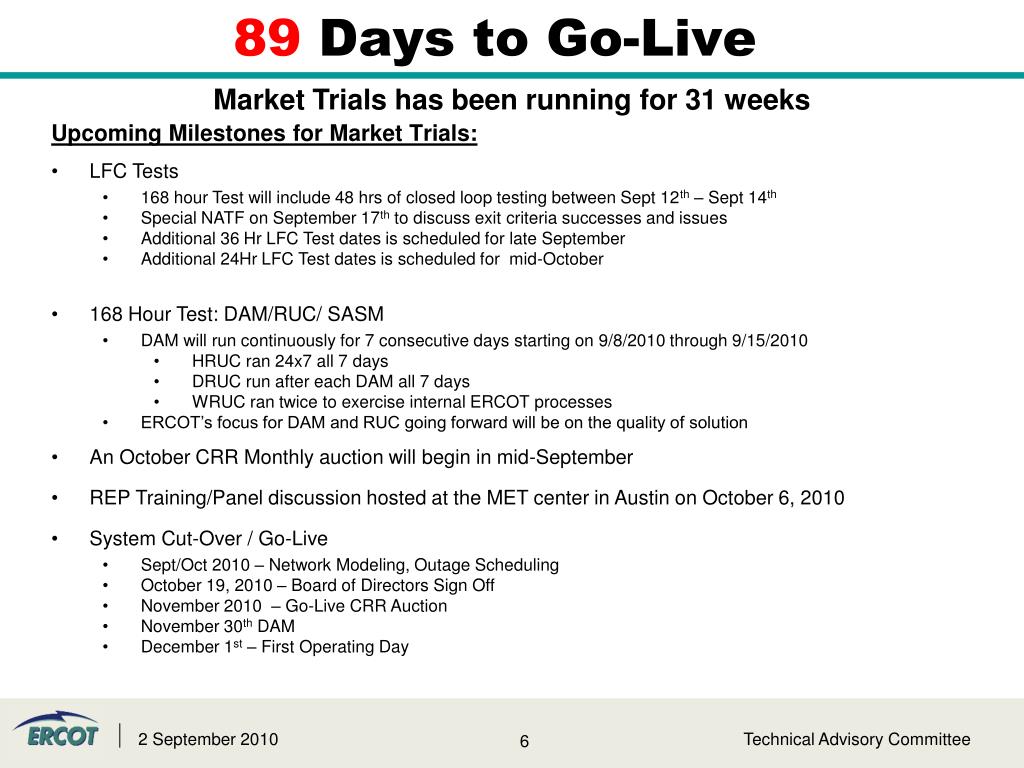

  6. 89 Days to Go-Live Market Trials has been running for 31 weeks • Upcoming Milestones for Market Trials: • LFC Tests • 168 hour Test will include 48 hrs of closed loop testing between Sept 12th – Sept 14th • Special NATF on September 17th to discuss exit criteria successes and issues • Additional 36 Hr LFC Test dates is scheduled for late September • Additional 24Hr LFC Test dates is scheduled for mid-October • 168 Hour Test: DAM/RUC/ SASM • DAM will run continuously for 7 consecutive days starting on 9/8/2010 through 9/15/2010 • HRUC ran 24x7 all 7 days • DRUC run after each DAM all 7 days • WRUC ran twice to exercise internal ERCOT processes • ERCOT’s focus for DAM and RUC going forward will be on the quality of solution • An October CRR Monthly auction will begin in mid-September • REP Training/Panel discussion hosted at the MET center in Austin on October 6, 2010 • System Cut-Over / Go-Live • Sept/Oct 2010 – Network Modeling, Outage Scheduling • October 19, 2010 – Board of Directors Sign Off • November 2010 – Go-Live CRR Auction • November 30th DAM • December 1st – First Operating Day Technical Advisory Committee

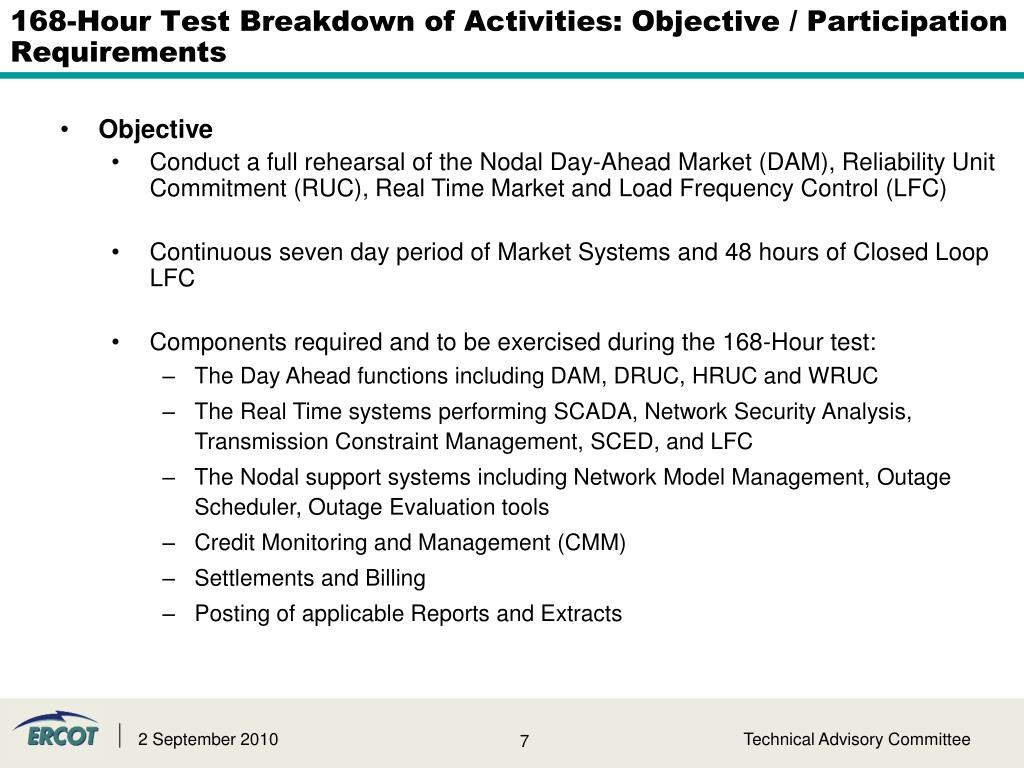

  7. 168-Hour Test Breakdown of Activities: Objective / Participation Requirements • Objective • Conduct a full rehearsal of the Nodal Day-Ahead Market (DAM), Reliability Unit Commitment (RUC), Real Time Market and Load Frequency Control (LFC) • Continuous seven day period of Market Systems and 48 hours of Closed Loop LFC • Components required and to be exercised during the 168-Hour test: • The Day Ahead functions including DAM, DRUC, HRUC and WRUC • The Real Time systems performing SCADA, Network Security Analysis, Transmission Constraint Management, SCED, and LFC • The Nodal support systems including Network Model Management, Outage Scheduler, Outage Evaluation tools • Credit Monitoring and Management (CMM) • Settlements and Billing • Posting of applicable Reports and Extracts Technical Advisory Committee

  8. 168-Hour Test Breakdown of Activities: Objective / Participation Requirements • Participation Requirements: • The value of the 168-Hour Test is dependent on participation by the Market. • The 168-Hour Test is required by all registered Market Participants intending to be involved in the Nodal Market • Participation data and metrics will be published and made readily available to the ERCOT Board, Independent Market Monitor and the related Market Participant Forums (NATF, TAC) • Metrics will also include comparisons of Zonal Resource Plans to Nodal COPs. • Participation should be reasonably reflective of post Go-Live behavior Technical Advisory Committee

  9. 168-Hour Test Breakdown of Activities: Entry / Exit Criteria • Entry Criteria for the 168-Hour test will be as follows: • All defined Market Trials Testing up until the 168-Hr test has been completed in accordance with the Market Trials Handbooks published to the Nodal Readiness Center • ERCOT declares readiness for initiating the 168-Hour test to TAC and the Board and obtains director level sign off from ERCOT management. • Exit Criteria: • 168 hours of continuous Nodal systems testing have been completed without encountering any major system issues that would prevent the Nodal Market from going live while maintaining system security and reliability as required by the ERCOT Protocols, Operating Guides, other binding documents, and NERC Reliability Standards. • ERCOT provides a test summary report to TAC and the Board outlining the successful testing processes. Technical Advisory Committee

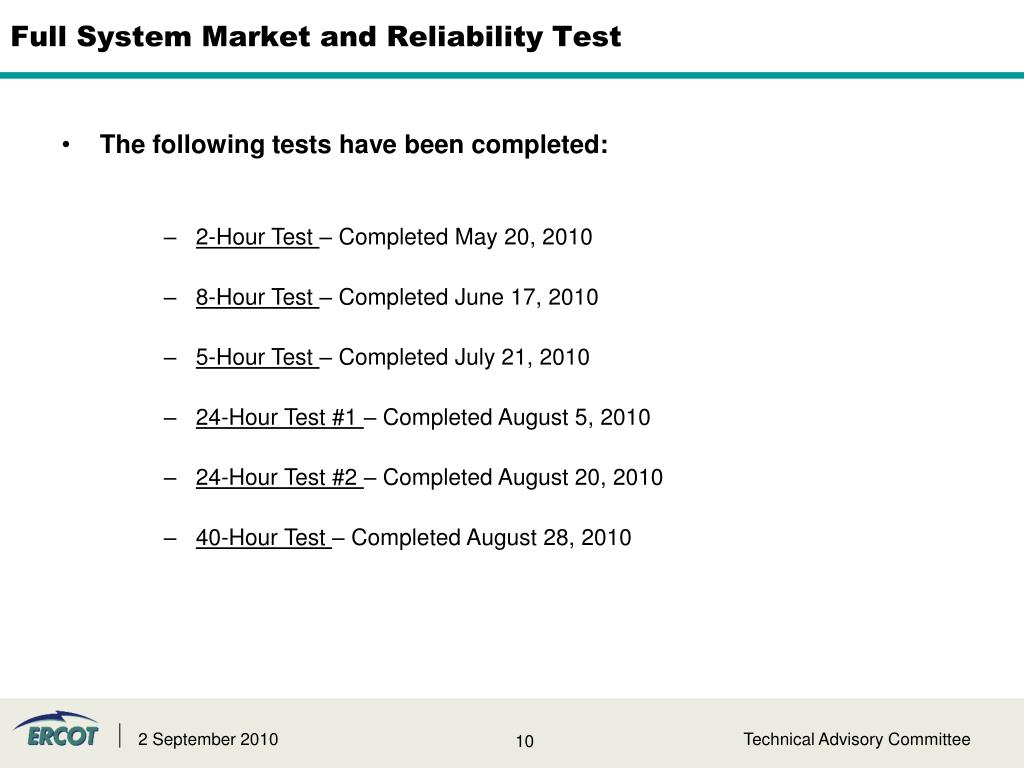

  10. Full System Market and Reliability Test • The following tests have been completed: • 2-Hour Test – Completed May 20, 2010 • 8-Hour Test – Completed June 17, 2010 • 5-Hour Test – Completed July 21, 2010 • 24-Hour Test #1 – Completed August 5, 2010 • 24-Hour Test #2 – Completed August 20, 2010 • 40-Hour Test – Completed August 28, 2010 Technical Advisory Committee

  11. August 26th 40 Hr LFC Test Overview Kenneth Ragsdale Market Trials

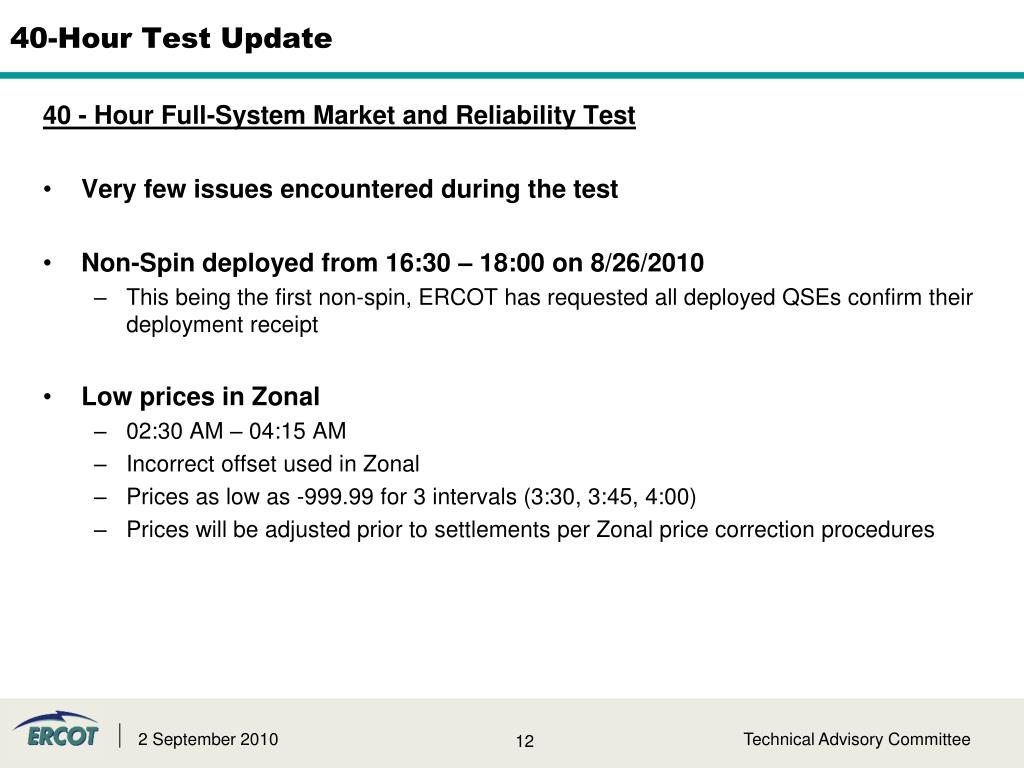

  12. 40-Hour Test Update 40 - Hour Full-System Market and Reliability Test • Very few issues encountered during the test • Non-Spin deployed from 16:30 – 18:00 on 8/26/2010 • This being the first non-spin, ERCOT has requested all deployed QSEs confirm their deployment receipt • Low prices in Zonal • 02:30 AM – 04:15 AM • Incorrect offset used in Zonal • Prices as low as -999.99 for 3 intervals (3:30, 3:45, 4:00) • Prices will be adjusted prior to settlements per Zonal price correction procedures Technical Advisory Committee

  13. Approximate 40-Hour Test Timeline – Aug 26 Technical Advisory Committee

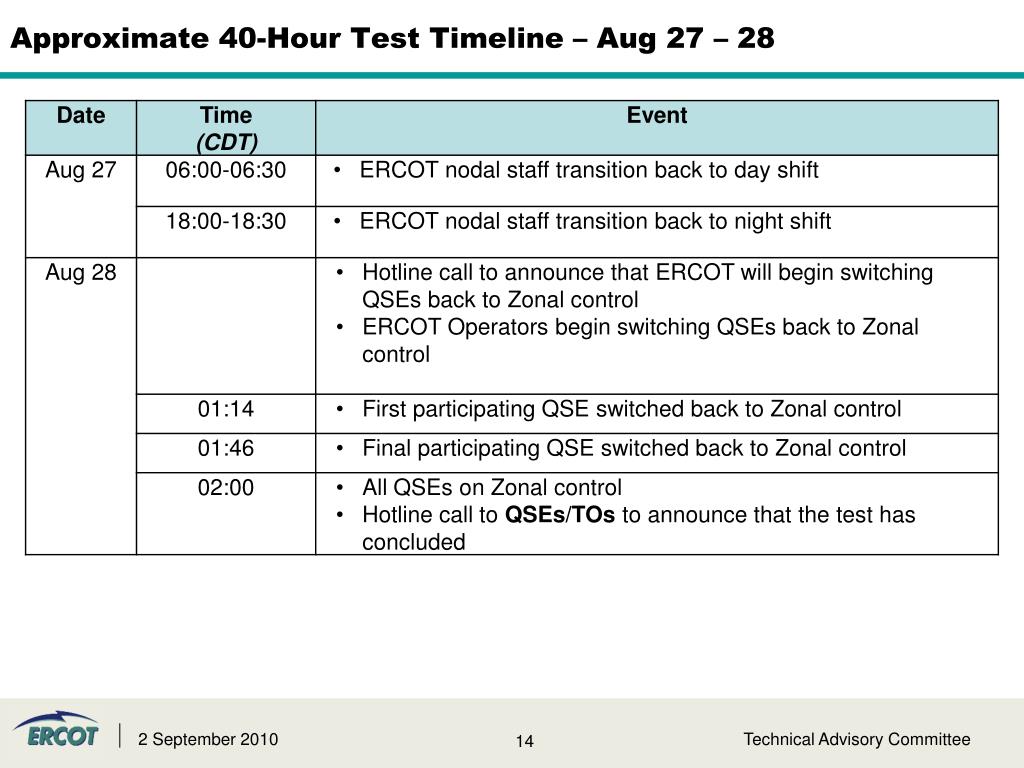

  14. Approximate 40-Hour Test Timeline – Aug 27 – 28 Technical Advisory Committee

  15. 40-Hour Test Completion Criteria – Initial Assessment Overview – Completion Criteria • ERCOT will communicate an initial assessment of the following completion criteria upon conclusion of the test : • The rolling CPS1 one minute average score must equal or exceed 100% during the test period • Note that the CPS1 average will not take into account the periods where ERCOT is transitioning to Nodal and then back to Zonal • Note that the CPS1 average will not take into account the periods where ERCOT is performing system tuning • Hourly CPS1 Scores: • Max: 180, Min: 84, Average: 146 • There was only one hour in which the CPS1 score was less than 100 (HE 0100 on Aug 28th) • Zonal Commercially Significant Constraints (CSCs) and Closely Related Elements (CREs) managed below thermal limits. • West-North stability constraint was active in nodal during final 1 ½ hours of testing and was active in zonal during the transition period from nodal to zonal control • Local Congestion managed below thermal limits • Yes • Stability limits managed below transfer limits • No NERC Disturbance Control Standard (DCS) failure if applicable. • No DCS failures during the test • No LFC-SCED system issues that result in termination of the test. • No LFC / SCED failures • Procedural and software fixes have been verified to address lessons learned from previous rounds of testing Technical Advisory Committee

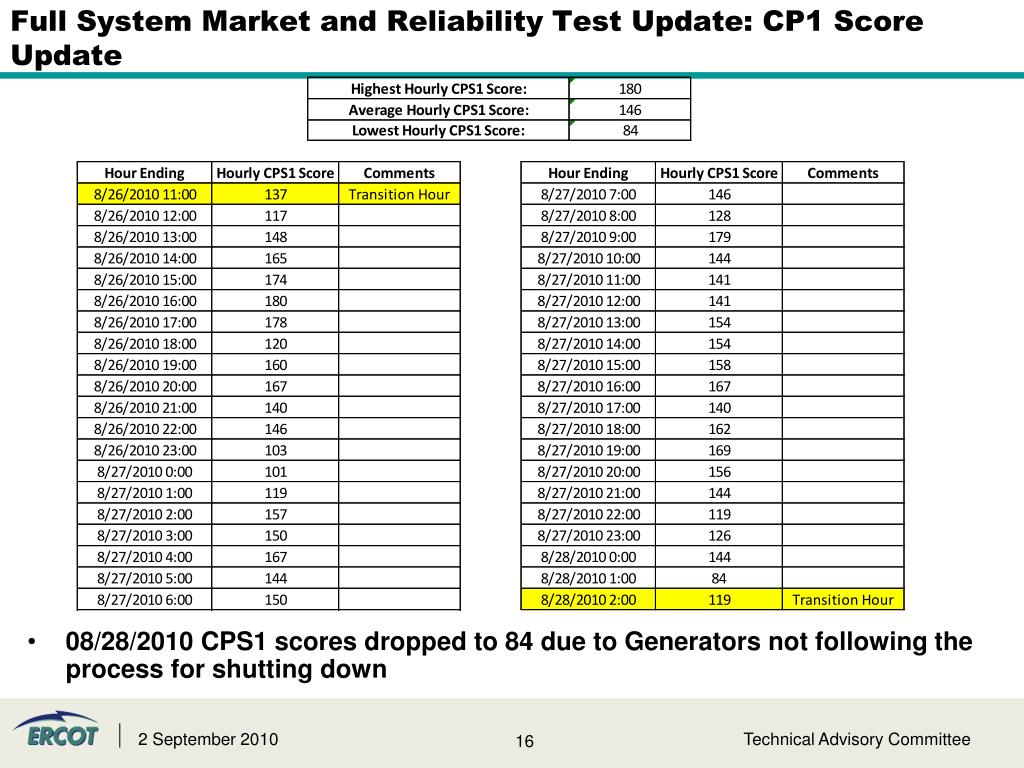

  16. Full System Market and Reliability Test Update: CP1 Score Update • 08/28/2010 CPS1 scores dropped to 84 due to Generators not following the process for shutting down Technical Advisory Committee

  17. Nodal Go-Live UpdateCertified Systems Kenneth Ragsdale Market Trials

  18. NMMS Overview Recommendation of Certification • Status / Other Issues: • Stability issue resolved as of July 1 (ERCOT continues to monitor production) • Navigation performance issues improved Aug 1st (43% reduction in response time measured) • Validation performance improvement patch was added on Friday, August 27th (expected a 20-40% reduction in validation time). Improvement on validation times were tested as follows: • Average: 45.18% • Median: 66.41% • Max: 97.46% Open Defects: Deferred Defects: 0 Sev 1 ! 11 Deferred ! 0 Sev 2 0 ! Sev 3-5 Technical Advisory Committee

  19. OS Overview Recommendation of Certification • Status / Other Issues: • No defects reported in the Outage Scheduler • Outage Scheduler transition tasks were completed on 8/13 and the system was ready for dual entry and validation on 8/16 • Market Notice for dual entry and validation was sent on August 16th • All Outage scheduler issues within the TSP Issues list have either been addressed or are resolved Open Defects: Deferred Defects: 0 Sev 1 ! 119 Deferred ! 0 Sev 2 0 ! Sev 3-5 Technical Advisory Committee

  20. CRR Overview Recommendation of Certification • Status / Other Issues: • Working with Siemens on automated processor fix. Expectation is to receive fix before Go-Live • Incorrect Loadzone Designation from Topology Processor Output file • Resource Nodes missing from Settlement Point output file produced by Topology Processor • Topology Processor cannot consume outages information for CRR modeling • CRR MUI requires a system reboot for Bid Limit to take effect (internal to ERCOT) workaround is nuisance -targeting 09/13/2010 resolution Open Defects: Deferred Defects: 0 Sev 1 ! 4 Deferred ! 0 Sev 2 ! 4 Sev 3-5 Technical Advisory Committee

  21. Nodal Go-Live UpdateReview of Full Nodal Operations Go-Live Items Kenneth Ragsdale Market Trials

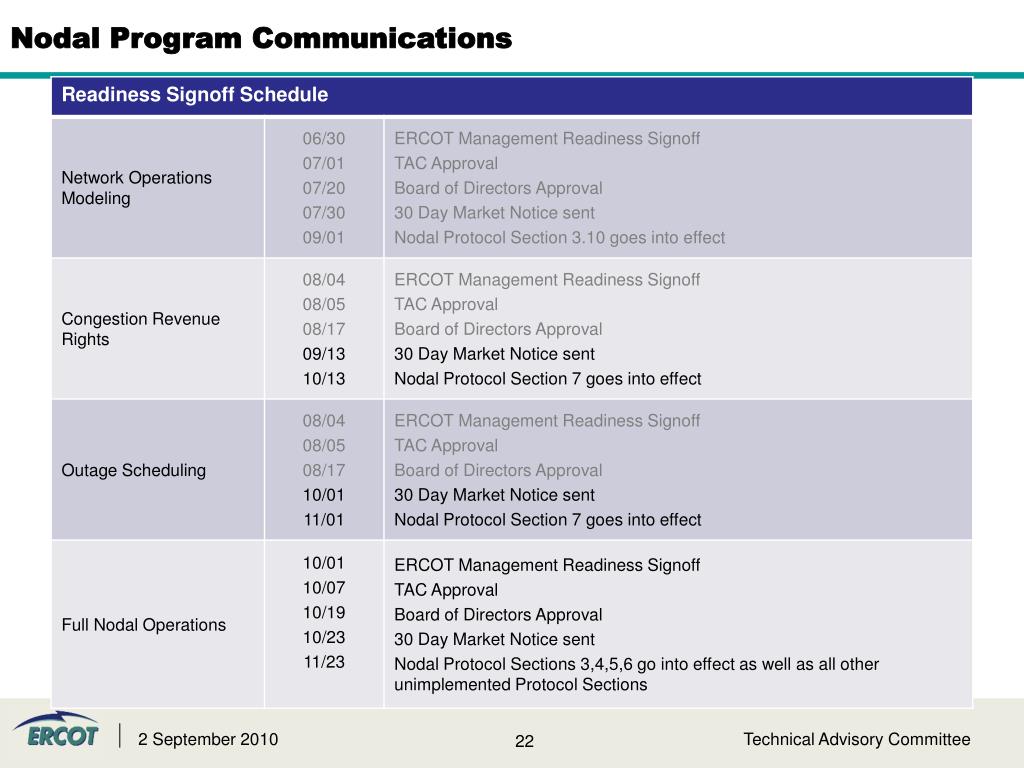

  22. Nodal Program Communications Technical Advisory Committee

  23. Nodal Cutover Communications – Zonal Protocol 21.12.3 21.12.3 Notice to Market Participants of Effective Date for Nodal Protocol Provisions and Retirement of Zonal Protocol Provision No part of the nodal market design may start operation until all the Market Readiness Criteria for that part of the nodal market design have been met. Certification that all Market Readiness Criteria have been met must be made at least by each of the following: the Technical Advisory Committee (TAC), ERCOT and the ERCOT Board. Upon such certification, ERCOT shall issue two Notices alerting Market Participants to the effective date of Nodal Protocol sections and the retirement of Zonal Protocol sections, as applicable. ERCOT shall issue the first Notice no less than thirty (30) days prior to the effective date or retirement date, as applicable, and the second Notice no less than ten (10) days prior to the effective date or retirement date, as applicable. The Notice shall include: (1) The Nodal Protocol Sections to become effective; and (2) The Zonal Protocol Sections to be retired, if any Technical Advisory Committee

  24. Readiness Methodology ERCOT will measure readiness by the following categories: • System Readiness – an evaluation of a particular system needed to support identified market activities • Process Readiness – an evaluation of the Processes and Procedures necessary to support identified market activities • People Readiness – an evaluation of ERCOT and Market Participant capabilities to support identified market activities ERCOT plans to review the Market Readiness Criteria at NATF and subsequently request a vote from TAC per Section 21.12.3, Notice to Market Participants of Effective Date for Nodal Protocol Provisions and Retirement of Zonal Protocol Provision Technical Advisory Committee

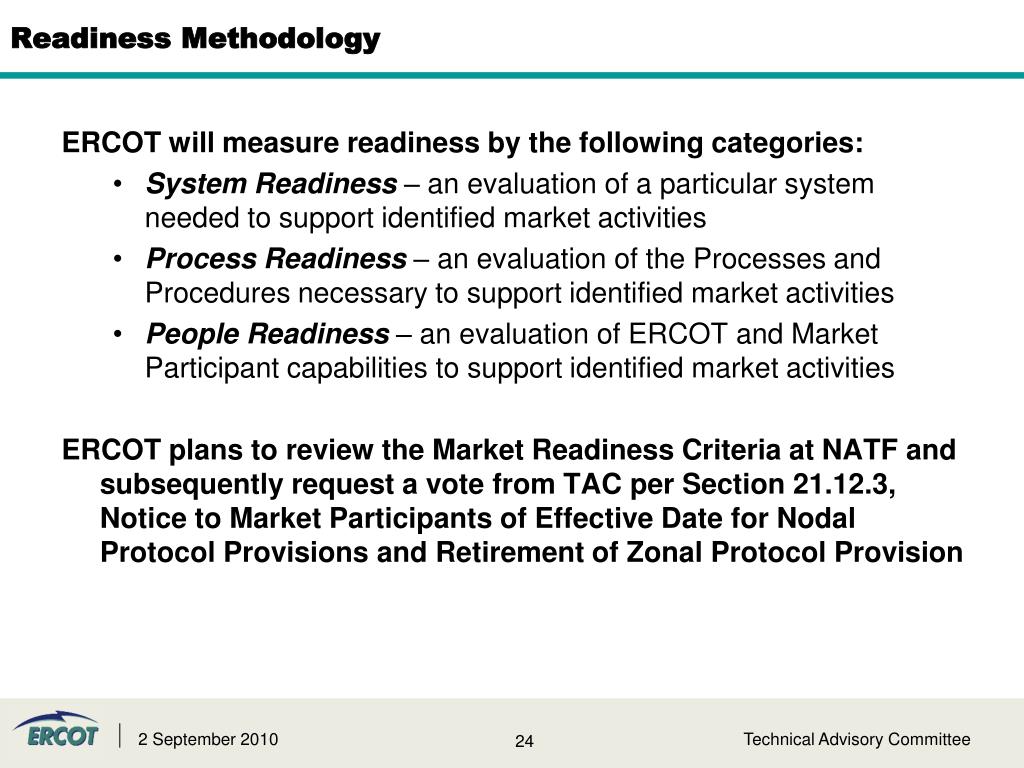

  25. Readiness Methodology System Readiness – evaluation of the Nodal system to support the market design • Core system functionality delivered • Protocol required system functionality available for market testing • System Integration delivered • System to system integration delivered to support Market Timeline and Business Processes • Known defects resolution plan • All ‘Must fix prior to go-live’ defects have a resolution plan in place • Active Readiness Metrics • Current status of Readiness Metrics Technical Advisory Committee

  26. Readiness Methodology Process Readiness – evaluation of the Processes and Procedures necessary to support the market design • Procedures complete • ERT project procedures to support business processes complete • System cutover transition plan established • ERCOT and Market Participant business activities required for transitioning into Go-Live have been established and communicated. • Market rules transition communicated • Nodal and Zonal Protocol effective / retirement dates identified and communicated for Market Participant review Technical Advisory Committee

  27. Readiness Methodology People Readiness – evaluation of ERCOT employee readiness and Market Participant knowledge to support the market design • ERCOT staff supporting Market Trials • ERCOT Business teams supporting system execution, problem resolution, and market questions • ERCOT staff trained on System and Processes • ERCOT Business teams training status based on identified ERT training metrics • Market Participant Training delivered • ERT external training classes and web based training provided by the Nodal training project Technical Advisory Committee

  28. MMS – Day Ahead, Adjustment Period, RT Market Overview Recommendation of Certification • Status / Other Issues: • DAM performance issue concerning CRR PTP options being investigated • MMS currently has 58 Open defects in Test targeted to be fixed by September 3. • MMS currently has 24 Open defects in development targeted to be fixed by October 1. • 6 DAM, 4 RUC, 4 SCED, 3 MI, 7 GUI • MMS remaining 13 (7 performance, 3 MOI, 3 MI) defects are being reviewed by business for final disposition Open Defects*: Deferred Defects*: 0 Sev 1 ! 44 Deferred ! 43 Sev 2 ! 52 Sev 3-5 * As of August 31, 2010 Technical Advisory Committee

  29. MMS – Day Ahead, Adj. Period, RT Market – Readiness Update Technical Advisory Committee

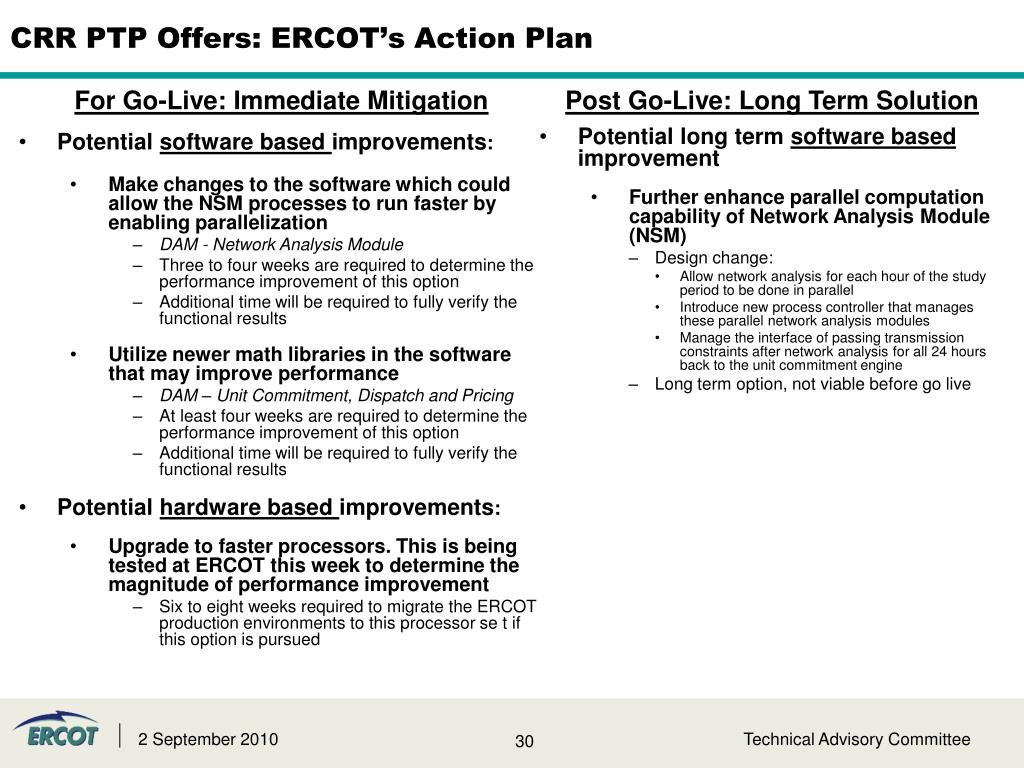

  30. CRR PTP Offers: ERCOT’s Action Plan • For Go-Live: Immediate Mitigation • Potential software based improvements: • Make changes to the software which could allow the NSM processes to run faster by enabling parallelization • DAM - Network Analysis Module • Three to four weeks are required to determine the performance improvement of this option • Additional time will be required to fully verify the functional results • Utilize newer math libraries in the software that may improve performance • DAM – Unit Commitment, Dispatch and Pricing • At least four weeks are required to determine the performance improvement of this option • Additional time will be required to fully verify the functional results • Potential hardware based improvements: • Upgrade to faster processors. This is being tested at ERCOT this week to determine the magnitude of performance improvement • Six to eight weeks required to migrate the ERCOT production environments to this processor se t if this option is pursued • Post Go-Live: Long Term Solution • Potential long term software based improvement • Further enhance parallel computation capability of Network Analysis Module (NSM) • Design change: • Allow network analysis for each hour of the study period to be done in parallel • Introduce new process controller that manages these parallel network analysis modules • Manage the interface of passing transmission constraints after network analysis for all 24 hours back to the unit commitment engine • Long term option, not viable before go live Technical Advisory Committee

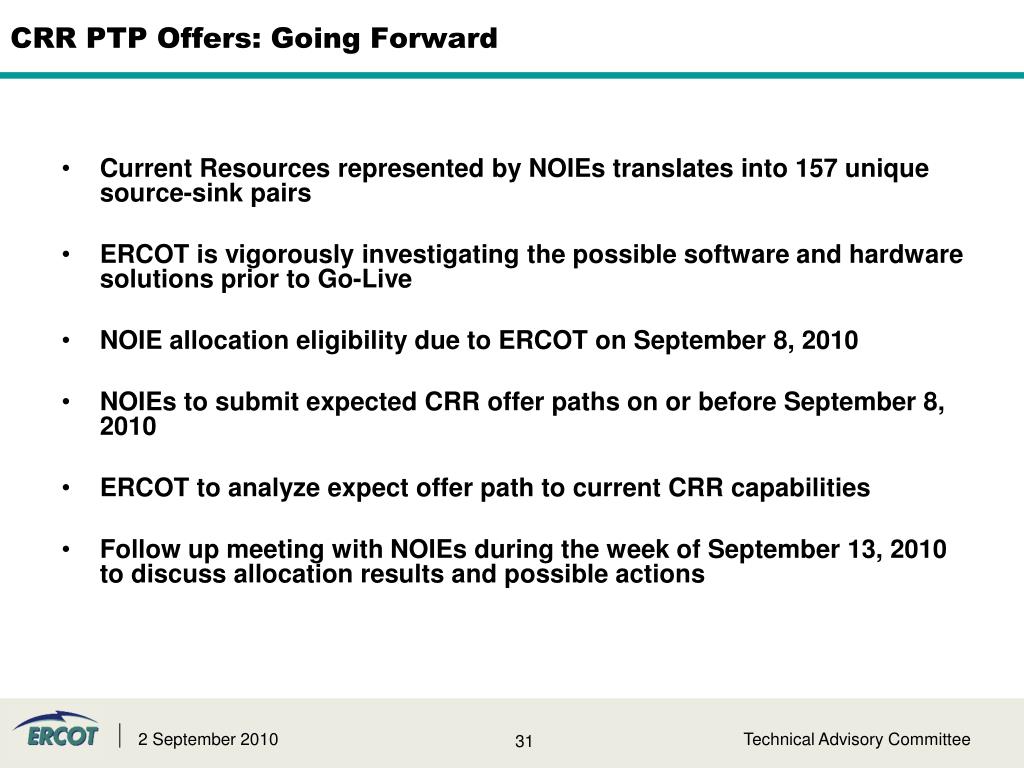

  31. CRR PTP Offers: Going Forward • Current Resources represented by NOIEs translates into 157 unique source-sink pairs • ERCOT is vigorously investigating the possible software and hardware solutions prior to Go-Live • NOIE allocation eligibility due to ERCOT on September 8, 2010 • NOIEs to submit expected CRR offer paths on or before September 8, 2010 • ERCOT to analyze expect offer path to current CRR capabilities • Follow up meeting with NOIEs during the week of September 13, 2010 to discuss allocation results and possible actions Technical Advisory Committee

  32. EMS – Real-Time Operations Recommendation of Certification • Status / Other Issues: • EMS currently has 20 Open defects in development targeted to be fixed by October 1. • 1 EMS Interface, 1 CIM Importer, 1 PSSE export • 6 STNET/SMTNET/OE • 1 VSAT • 3 RLC • 1 SE • 2 TCM • 3 LFC/Generation Open Defects*: Deferred Defects*: 0 Sev 1 ! 321 Deferred ! 12 Sev 2 ! 8 Sev 3-5 * As of August 31, 2010 Technical Advisory Committee

  33. EMS – Real-Time Operations Readiness Update Technical Advisory Committee

  34. COMS – Settlement & Billing, Metering, and Data Aggregation - Overview Recommendation of Certification • Status / Other Issues: • There are only 5 Open defects related to Core Systems at this time that are scheduled to be resolved by 09/03/2010. • -Adjustment to queries in Appworx Scheduling Job • -IDR Staging Performance Enhancement • -Adjustment to DAM Start Logic • -Adjustment to Data Aggregation to prevent file aborts from missing data • -Adjustment for AIEC calculation logic when RTPERFIP missing • There are 11 Commercial System Integration (CSI) defects related to transfer of data Open Defects*: Deferred Defects*: 0 Sev 1 ! 45 Deferred 6 ! Sev 2 ! 9 Sev 3-5 * As of August 31, 2010 Technical Advisory Committee

  35. S&B – Settlements and Billing, Metering, and Data Aggregation Readiness Update Technical Advisory Committee

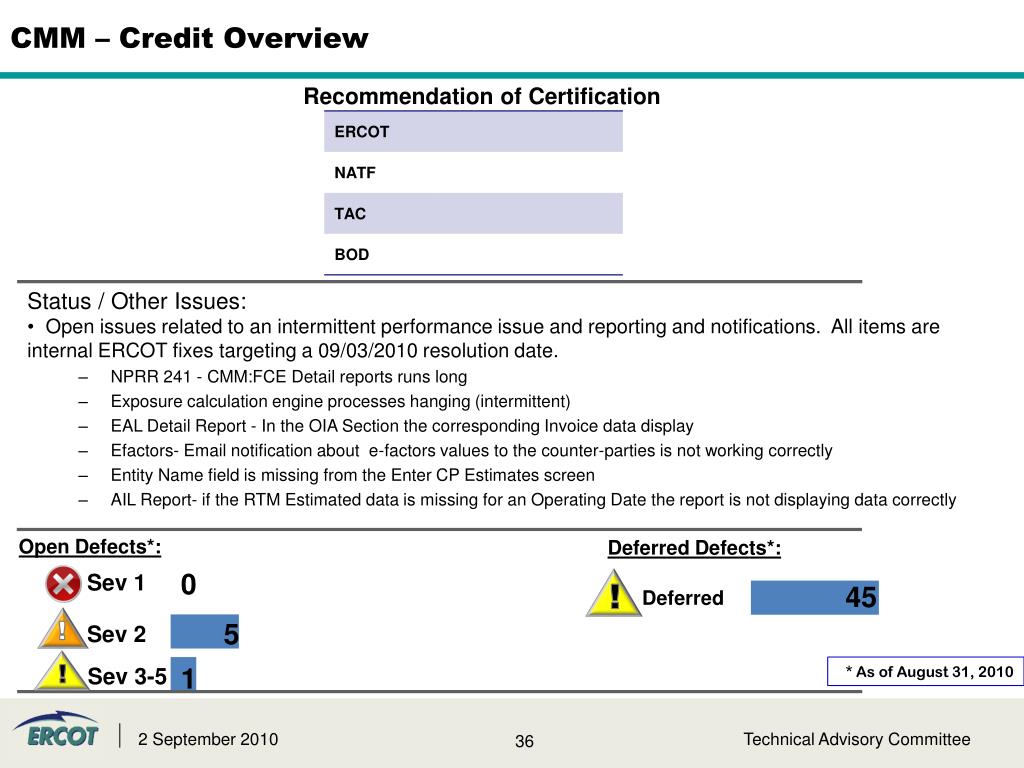

  36. CMM – Credit Overview Recommendation of Certification • Status / Other Issues: • Open issues related to an intermittent performance issue and reporting and notifications. All items are internal ERCOT fixes targeting a 09/03/2010 resolution date. • NPRR 241 - CMM:FCE Detail reports runs long • Exposure calculation engine processes hanging (intermittent) • EAL Detail Report - In the OIA Section the corresponding Invoice data display • Efactors- Email notification about e-factors values to the counter-parties is not working correctly • Entity Name field is missing from the Enter CP Estimates screen • AIL Report- if the RTM Estimated data is missing for an Operating Date the report is not displaying data correctly Open Defects*: Deferred Defects*: 0 Sev 1 ! 45 Deferred ! 5 Sev 2 ! 1 Sev 3-5 * As of August 31, 2010 Technical Advisory Committee

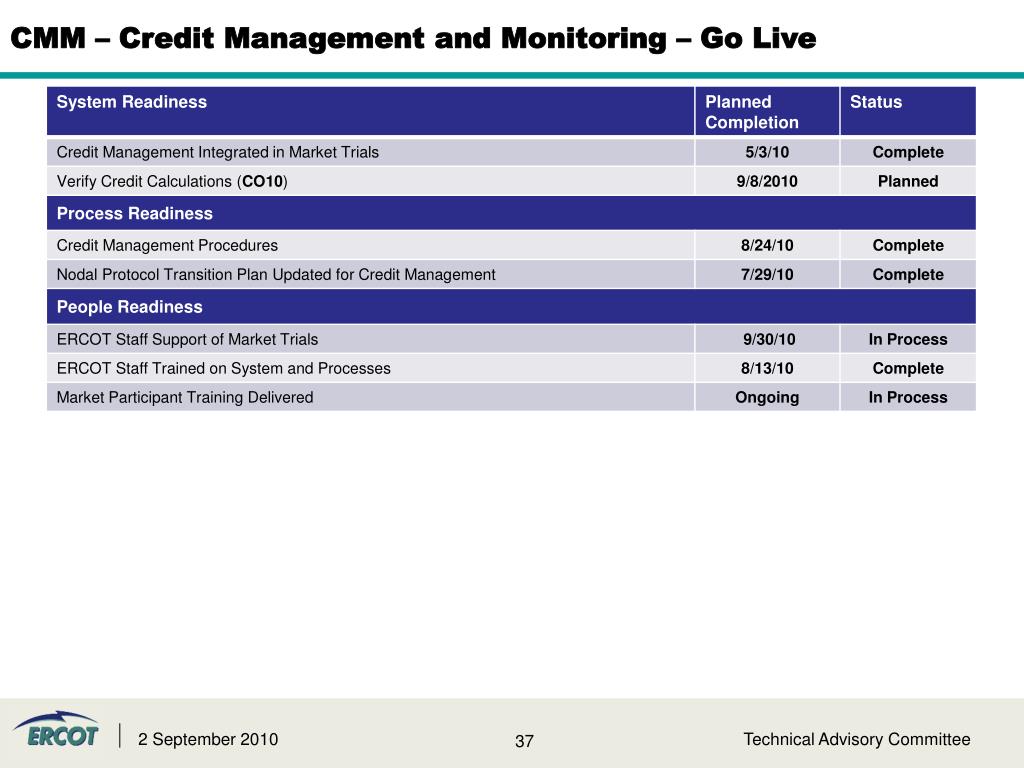

  37. CMM – Credit Management and Monitoring – Go Live Technical Advisory Committee

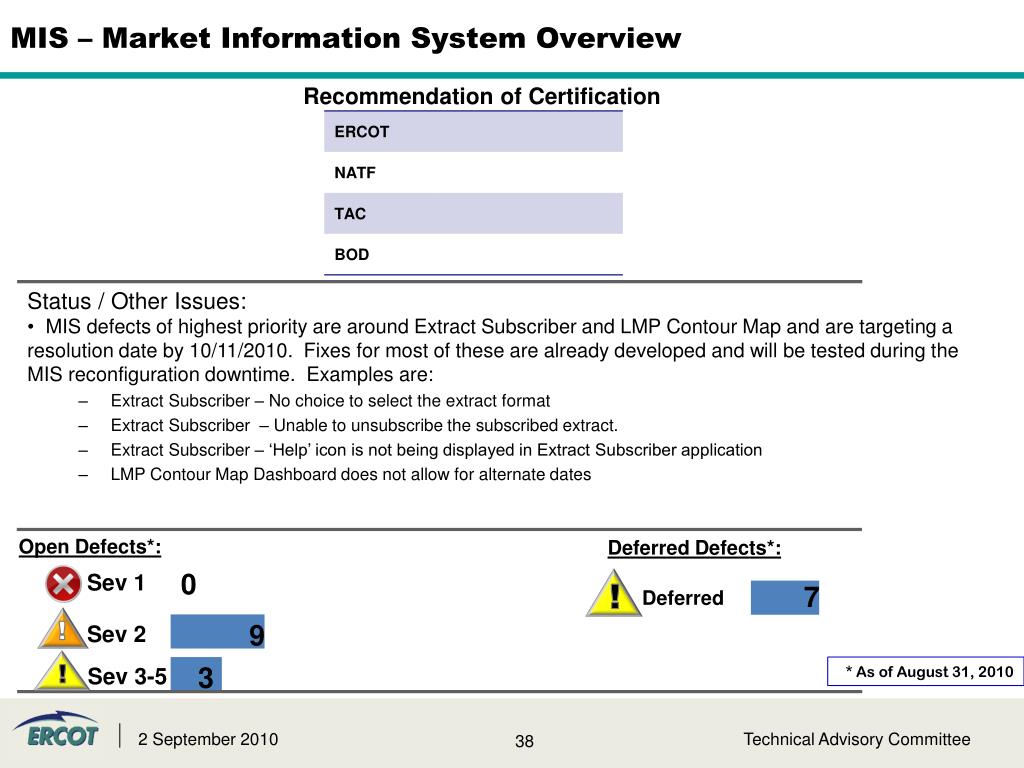

  38. MIS – Market Information System Overview Recommendation of Certification • Status / Other Issues: • MIS defects of highest priority are around Extract Subscriber and LMP Contour Map and are targeting a resolution date by 10/11/2010. Fixes for most of these are already developed and will be tested during the MIS reconfiguration downtime. Examples are: • Extract Subscriber – No choice to select the extract format • Extract Subscriber – Unable to unsubscribe the subscribed extract. • Extract Subscriber – ‘Help’ icon is not being displayed in Extract Subscriber application • LMP Contour Map Dashboard does not allow for alternate dates Open Defects*: Deferred Defects*: 0 Sev 1 ! 7 Deferred ! 9 Sev 2 ! 3 Sev 3-5 * As of August 31, 2010 Technical Advisory Committee

  39. MIS – Market Information System – Go Live Technical Advisory Committee

  40. Questions ? Technical Advisory Committee

  41. Appendix Technical Advisory Committee

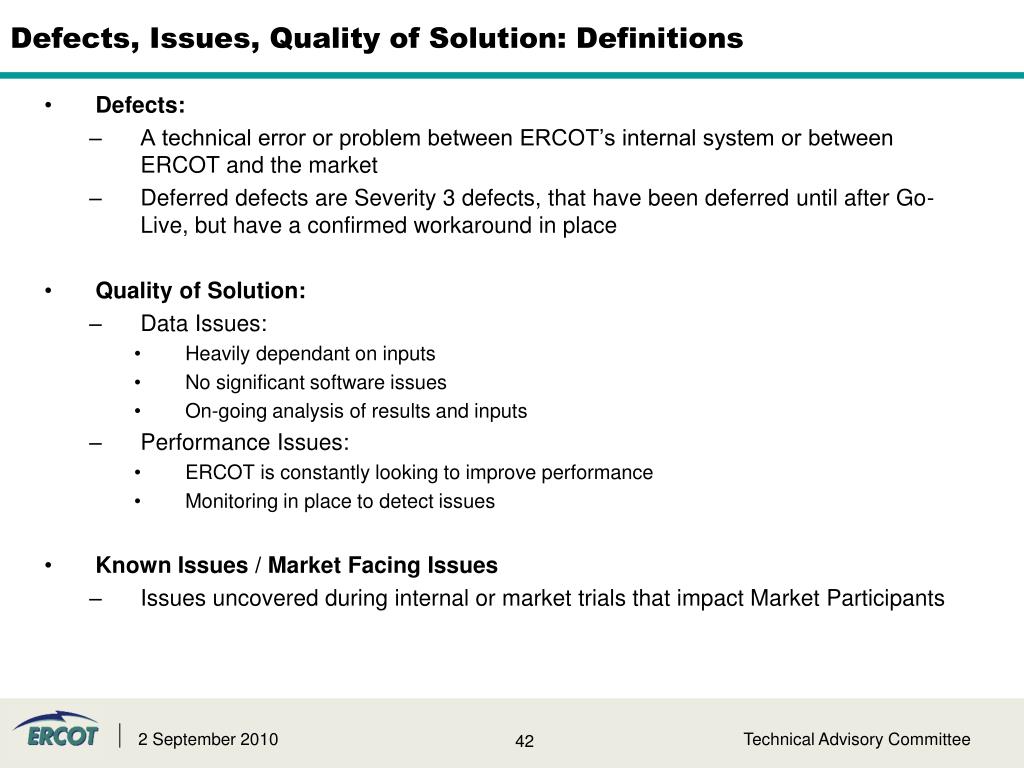

  42. Defects, Issues, Quality of Solution: Definitions • Defects: • A technical error or problem between ERCOT’s internal system or between ERCOT and the market • Deferred defects are Severity 3 defects, that have been deferred until after Go-Live, but have a confirmed workaround in place • Quality of Solution: • Data Issues: • Heavily dependant on inputs • No significant software issues • On-going analysis of results and inputs • Performance Issues: • ERCOT is constantly looking to improve performance • Monitoring in place to detect issues • Known Issues / Market Facing Issues • Issues uncovered during internal or market trials that impact Market Participants Technical Advisory Committee

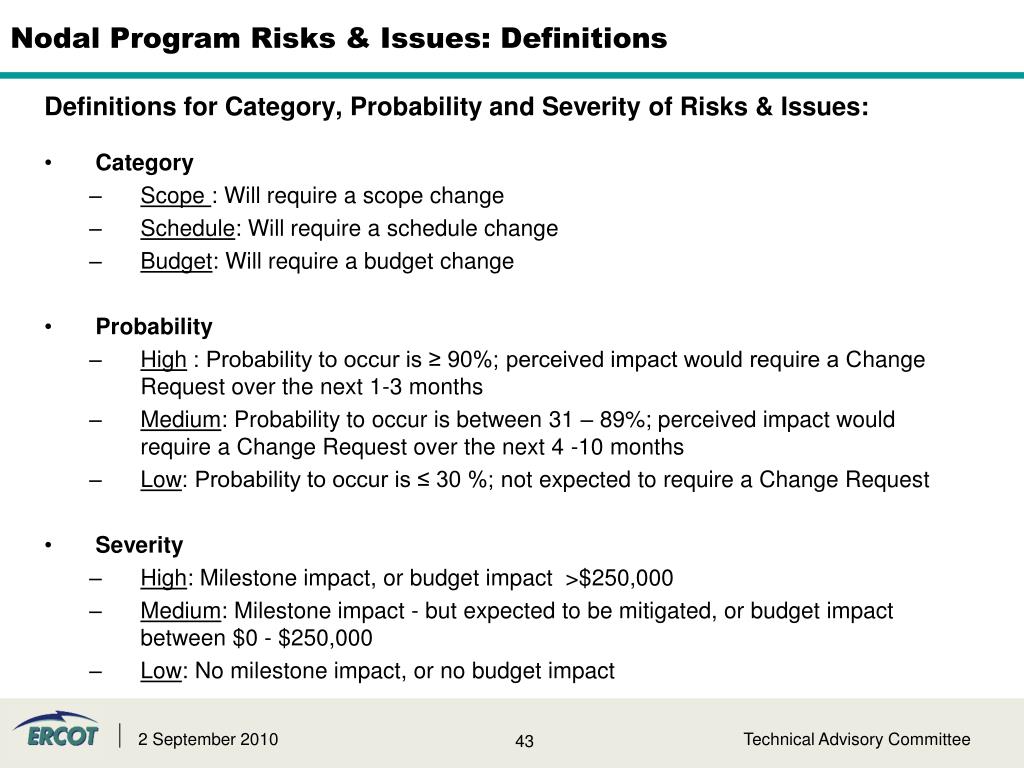

  43. Nodal Program Risks & Issues: Definitions Definitions for Category, Probability and Severity of Risks & Issues: • Category • Scope : Will require a scope change • Schedule: Will require a schedule change • Budget: Will require a budget change • Probability • High : Probability to occur is ≥ 90%; perceived impact would require a Change Request over the next 1-3 months • Medium: Probability to occur is between 31 – 89%; perceived impact would require a Change Request over the next 4 -10 months • Low: Probability to occur is ≤ 30 %; not expected to require a Change Request • Severity • High: Milestone impact, or budget impact >$250,000 • Medium: Milestone impact - but expected to be mitigated, or budget impact between $0 - $250,000 • Low: No milestone impact, or no budget impact Technical Advisory Committee

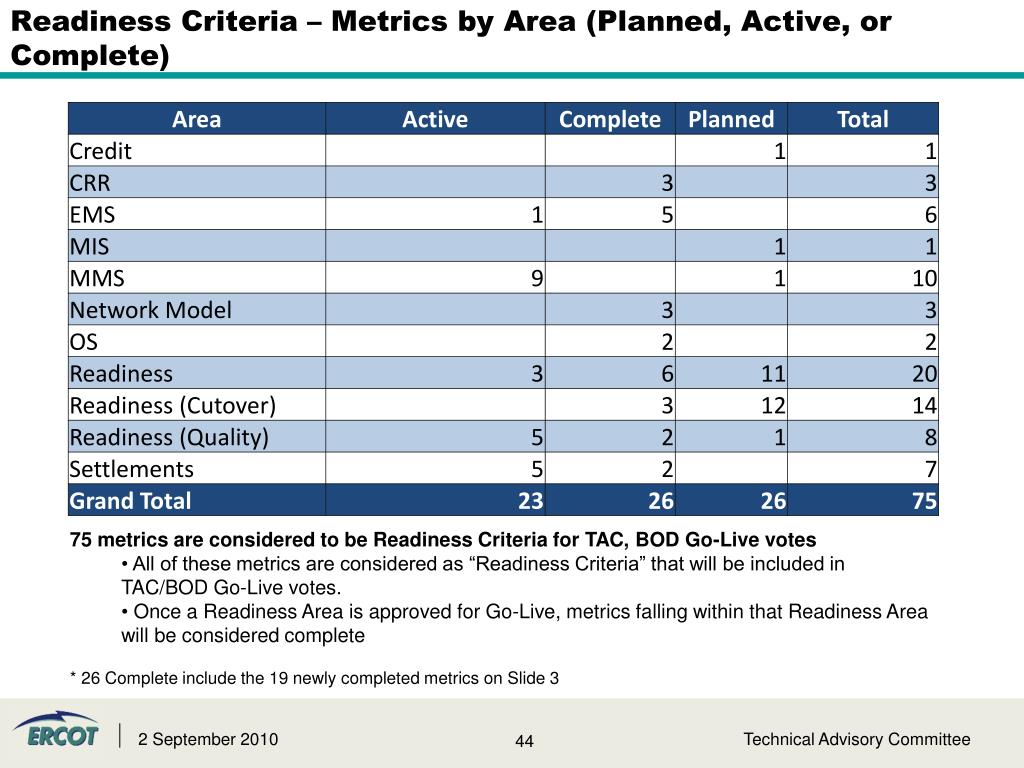

  44. Readiness Criteria – Metrics by Area (Planned, Active, or Complete) • 75 metrics are considered to be Readiness Criteria for TAC, BOD Go-Live votes • All of these metrics are considered as “Readiness Criteria” that will be included in TAC/BOD Go-Live votes. • Once a Readiness Area is approved for Go-Live, metrics falling within that Readiness Area will be considered complete • * 26 Complete include the 19 newly completed metrics on Slide 3 Technical Advisory Committee

  45. Readiness Criteria – Completed Metrics • ERCOT has 19 newly completed nodal metrics • 7 Metrics related to TAC/Board have signed off (NMMS, OS, and CRR). • 5 EMS metrics • 7 Metrics for general readiness Technical Advisory Committee

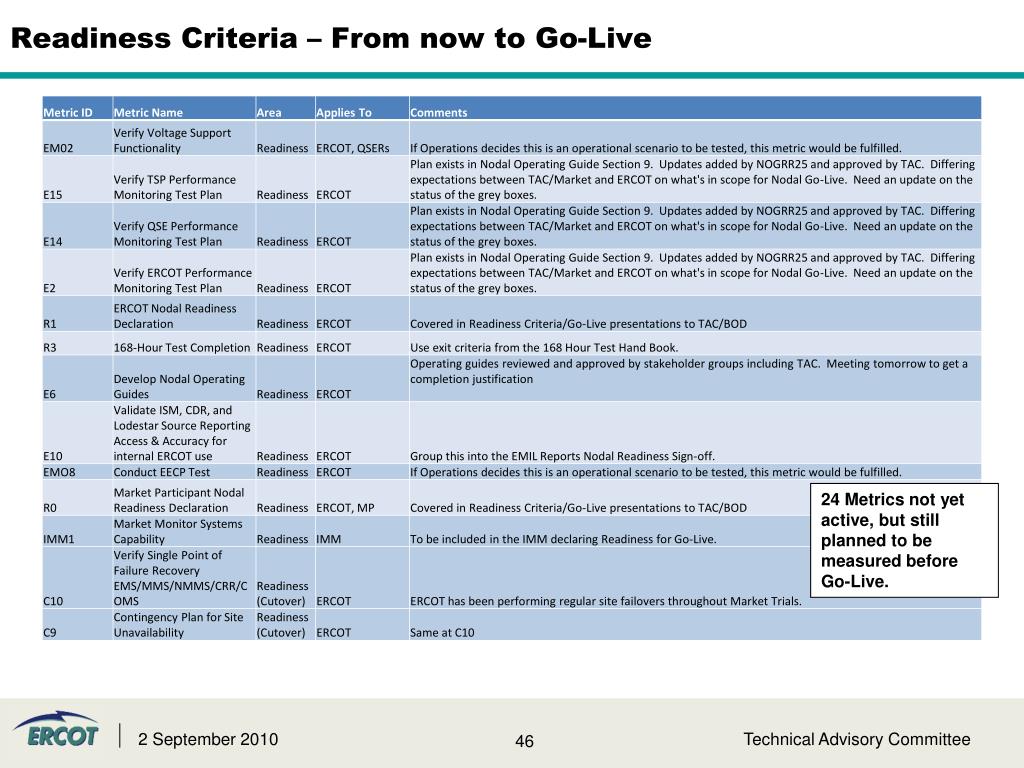

  46. Readiness Criteria – From now to Go-Live 24 Metrics not yet active, but still planned to be measured before Go-Live. Technical Advisory Committee

  47. Readiness Criteria – From now to Go-Live (continued) Metrics will be closed as TAC/BOD signoff is garnered for various systems and readiness areas Technical Advisory Committee

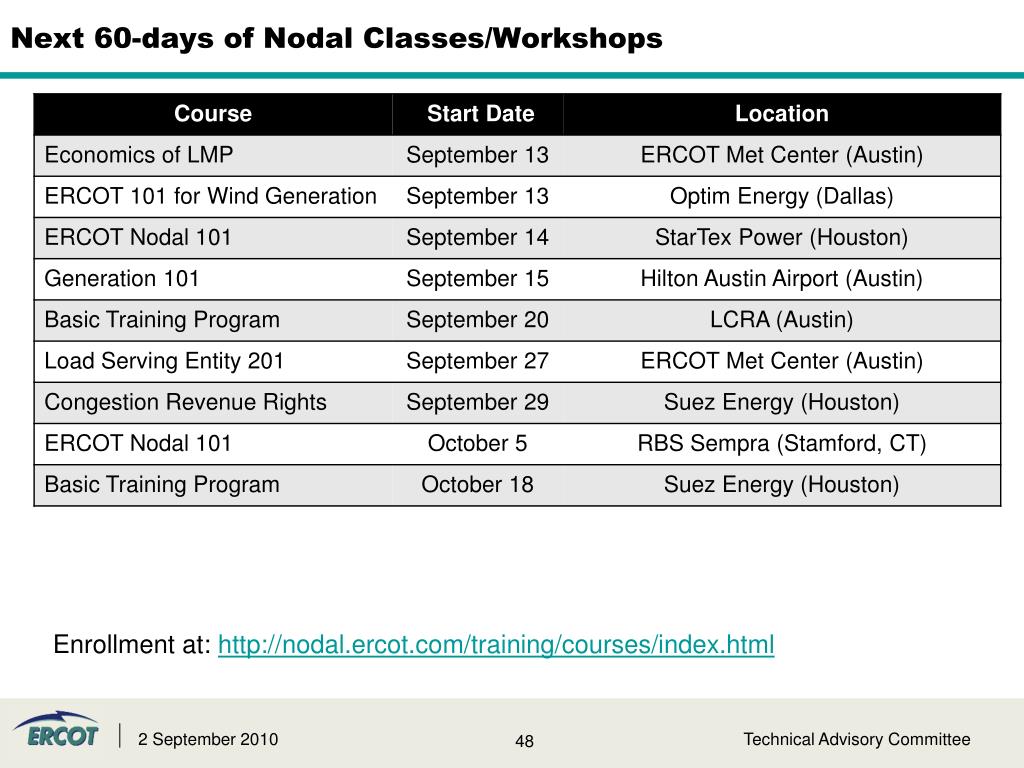

  48. Next 60-days of Nodal Classes/Workshops Enrollment at: http://nodal.ercot.com/training/courses/index.html Technical Advisory Committee

  49. RED/AMBER Metrics Summary – Market Participant Metrics Market Participant Metrics • MP15(B) • 10 CRRAHs working towards qualification * • Minimal risk to running the December 2010 Auction • MP16 • QSEs w/o Resources DAM participation between 65%-80% since measurement started in April. • These QSEs represent 1% of Load. • Minimal risk to Go-Live • MP21 • 67 WGRs – 55 passed reasonability test, 9 working with ERCOT to resolve, 3 with no response • 55 up from 42 from the previous two-week measurement * 5 new CRRAHs added prior to 8/13 deadline. Not included in MP15B because they have a 30 day window before ERCOT publishes their CRRAH qualified status. Technical Advisory Committee

  50. CRR Metrics Technical Advisory Committee
