1 / 18

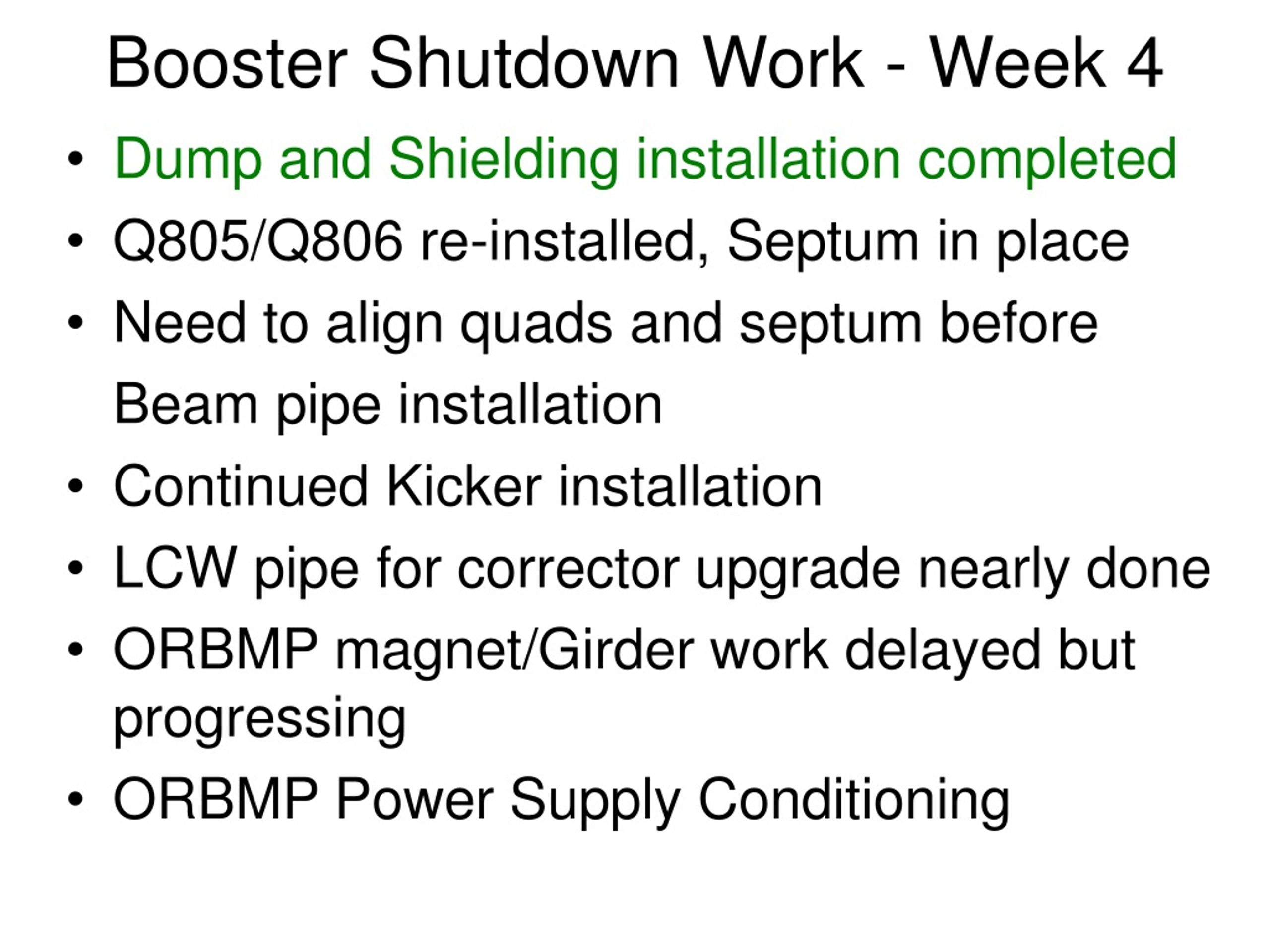

Booster Shutdown Work - Week 4

Booster Shutdown Work - Week 4. Dump and Shielding installation completed Q805/Q806 re-installed, Septum in place Need to align quads and septum before Beam pipe installation Continued Kicker installation LCW pipe for corrector upgrade nearly done

jam
Télécharger la présentation

Booster Shutdown Work - Week 4

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Booster Shutdown Work - Week 4 • Dump and Shielding installation completed • Q805/Q806 re-installed, Septum in place • Need to align quads and septum before Beam pipe installation • Continued Kicker installation • LCW pipe for corrector upgrade nearly done • ORBMP magnet/Girder work delayed but progressing • ORBMP Power Supply Conditioning

  2. Booster Shutdown Work - Week 4 • Dump and Shielding installation completed • Q805/Q806 re-installed, Septum in place • Need to align quads and septum before Beam pipe installation • Continued Kicker installation • LCW pipe for corrector upgrade nearly done • ORBMP magnet/Girder work delayed but progressing • ORBMP Power Supply Conditioning

  3. Q806 arrives

  4. Booster Shutdown Work - Week 4 • Dump and Shielding installation completed • Q805/Q806 re-installed, Septum in place • Need to align quads and septum before Beam pipe installation • Continued Kicker installation • LCW pipe for corrector upgrade nearly done • ORBMP magnet/Girder work delayed but progressing • ORBMP Power Supply Conditioning

  5. Booster Shutdown Work - Week 4 • Dump and Shielding installation completed • Q805/Q806 re-installed, Septum in place • Need to align quads and septum before Beam pipe installation • Continued Kicker installation • LCW pipe for corrector upgrade nearly done • ORBMP magnet/Girder work delayed but progressing • ORBMP Power Supply Conditioning

  6. Booster Shutdown Work - Week 4 • Booster West 13.8KV switch gear installed • RF maintenance continues • 400 MeV Gallery work progressing • BWT dig progressing for conduit. • Still waiting on MI-8 conduit!!!

  7. Booster Shutdown Work - Week 4 • Booster West 13.8KV switch gear installed • RF maintenance continues • 400 MeV Gallery work progressing • BWT dig progressing for conduit. • Still waiting on MI-8 conduit!!!

  8. Bias Supplies

  9. Booster Shutdown Work - Week 4 • Booster West 13.8KV switch gear installed • RF maintenance continues • 400 MeV Gallery work progressing • BWT dig progressing for conduit. • Still waiting on MI-8 conduit!!!

  10. MI8 Excavation

  11. Booster Shutdown Work - Week 4 • Booster West 13.8KV switch gear installed • RF maintenance continues • 400 MeV Gallery work progressing • BWT dig progressing for conduit. • Still waiting on MI-8 conduit!!!

  12. Reminder • 13.8KV Transformer/Switchgear Replacement • - Prepare for next week's transformer/switchgear work • - 208V work • - Schedule for power outage and switch to generator • 0700 to 12:00 for electrical work and switch over to generator • Monday March 27 • This will effect BET, BEG and Booster Tunnel

More Related
