22. Performance Evaluation Using Variances from Standard Costs. Student Version. 1. Describe the types of standards and how they are established. 22-2. 1. Types of Standards.

jerold
Télécharger la présentation

Performance Evaluation Using Variances from Standard Costs

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. 22 Performance Evaluation Using Variances from Standard Costs Student Version

  2. 1 Describe the types of standards and how they are established. 22-2

  3. 1 Types of Standards Unrealistic standards that can be achieved only under perfect operating conditions (such as no idle time, no machine breakdowns, no materials spoilage) are called ideal standards or theoretical standards.

  4. 1 Currently attainable standards, sometimes called normal standards,can beattained with reasonable effort. Standards set at this level allow for disruptions, such as material spoilage and machine breakdowns.

  5. 2 Describe and illustrate how standards are used in budgeting. 22-5

  6. 2 The standard cost per unit for direct materials, direct labor, and factory overhead is computed as follows: Standard Cost per Unit = Standard Price × Standard Quantity

  7. 2 Budget Performance Report The report that summarizes actual costs, standard cost, and the differences for the units produced is called a budget performance report.

  8. 2 • A favorable cost variance occurs when the actual cost is less than the standard cost (at actual volumes). • An unfavorable cost variance occurs when the actual cost exceeds the standard cost (at actual volumes).

  9. 2 Direct Materials Variance The total direct materials variance is separated into price and quantity variances.

  10. 2 Direct Labor Variance The total direct labor variance is separated into rate and time variances.

  11. 3 Compute and interpret direct materials and direct labor variances. 22-11

  12. Total Unfavorable Materials Variance 3 Direct Materials Variances Actual Direct Materials Cost = Actual Price × Actual Quantity Actual Direct Materials Cost = $5.50 × (7,300 sq. yards.) Actual Direct Materials Cost = $40,150 Standard Direct Materials Cost = Standard × Standard Quantity Standard Direct Materials Cost = $5.00 × (7,300 sq. yards.) Standard Direct Materials Cost = $37,150 Actual costs ($40,150) – Standard costs ($37,500) = $2,650

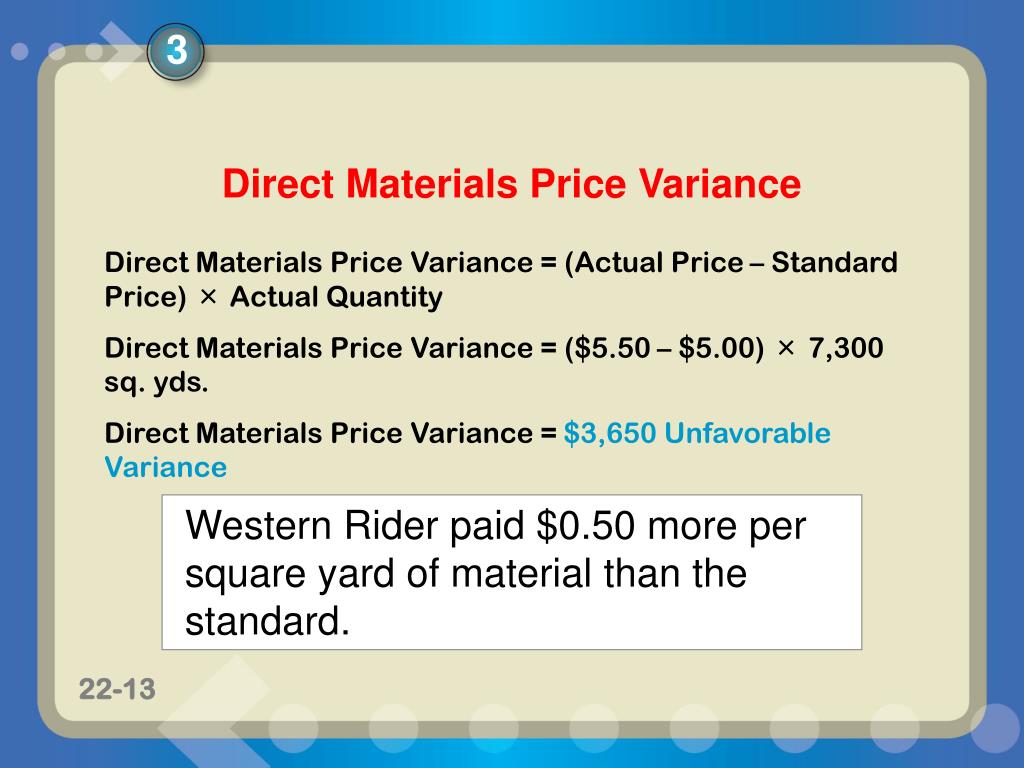

  13. 3 Direct Materials Price Variance Direct Materials Price Variance = (Actual Price – Standard Price) × Actual Quantity Direct Materials Price Variance = ($5.50 – $5.00) × 7,300 sq. yds. Direct Materials Price Variance = $3,650 Unfavorable Variance Western Rider paid $0.50 more per square yard of material than the standard.

  14. 3 Direct Materials Quantity Variance Direct Materials Quantity Variance = (Actual Quantity – Standard Quantity) × Standard Price Direct Materials Quantity Variance = (7,300 sq. yds. – 7,500 sq. yds. × $5.00 Direct Materials Price Variance = ($1,000) Favorable Variance Western Rider used 200 less square yards of material than the standard.

  15. 3 Exhibit 4 Direct Materials Variance Relationships Standard cost: Actual cost: Standard quantity × Standard price 7,500 × $5.00 = $37,500 Actual quantity × Actual price 7,300 × $5.50 = $40,150 Actual quantity × Standard price 7,300 × $5.00 = $36,500 Materials price variance Material quantity variance $3,650 U ($1,000) F Total direct materials cost variance $40,150 – $37,500 = $2,650 U

  16. Total Unfavorable Labor Variance 3 Direct Labor Variances Actual Direct Labor Cost = Actual Rate per Hour × Actual Time Actual Direct Labor Cost = $10.00 per hr. × 3,850 hrs. Actual Direct Labor Cost = $38,500 Standard Direct Labor Cost = Standard Rate per Hour × Standard Time Standard Direct Labor Cost = $9.00 per hr. × 4,000 hrs. Standard Direct Labor Cost = $36,000 Actual costs ($38,500) – Standard costs ($36,000) = $2,500

  17. 3 Direct Labor Rate Variance Direct Labor Rate Variance = (Actual Rate per Hour – Standard Rate per Hour) × Actual Hours Direct Labor Rate Variance = ($10.00 – $9.00) × 3,850 hours Direct Labor Rate Variance = $3,850 Unfavorable Variance If the actual direct labor rate for the units produced is less than the standard direct labor rate, the variance is favorable.

  18. 3 Direct Labor Time Variance Direct Labor Time Variance = (Actual Direct Labor Hours – Standard Direct Labor Hours) × Standard Rate per Hour Direct Labor Time Variance = (3,850 hours – 4,000 direct labor hours) × $9.00 Direct Labor Time Variance = ($1,350) Favorable Variance If the actual direct hours for the units produced exceeds the standard direct labor hours, the variance is unfavorable.

  19. 3 Exhibit 5 Direct Labor Variance Relationships Standard cost: Actual cost: Actual hours × Actual rate 3,850 × $10 = $38,500 Actual hours × Standard rate 3,850 × $9 = $34,650 Standard hours × Standard rate 4,000 × $9 = $36,000 Direct labor rate variance Direct labor time variance $3,850 U ($1,350) F Total direct labor cost variance $38,500 – $36,000 = $2,500 U

  20. 4 Compute and interpret factory overhead controllable and volume variances. 22-20

  21. $30,000 5,000 direct labor hours Factory Overhead Rate = 4 The Factory Overhead Flexible Budget Budgeted Factory Overhead at Normal Capacity Normal Productive Capacity Factory Overhead Rate = Factory Overhead Rate = $6.00 per direct labor hour

  22. $12,000 5,000 direct labor hours Fixed Factory Overhead Rate = 4 Fixed Factory Overhead Rate Budgeted Fixed Overhead at Normal Capacity Normal Productive Capacity Fixed Factory Overhead Rate = Fixed Factory Overhead Rate = $2.40 per direct labor hour

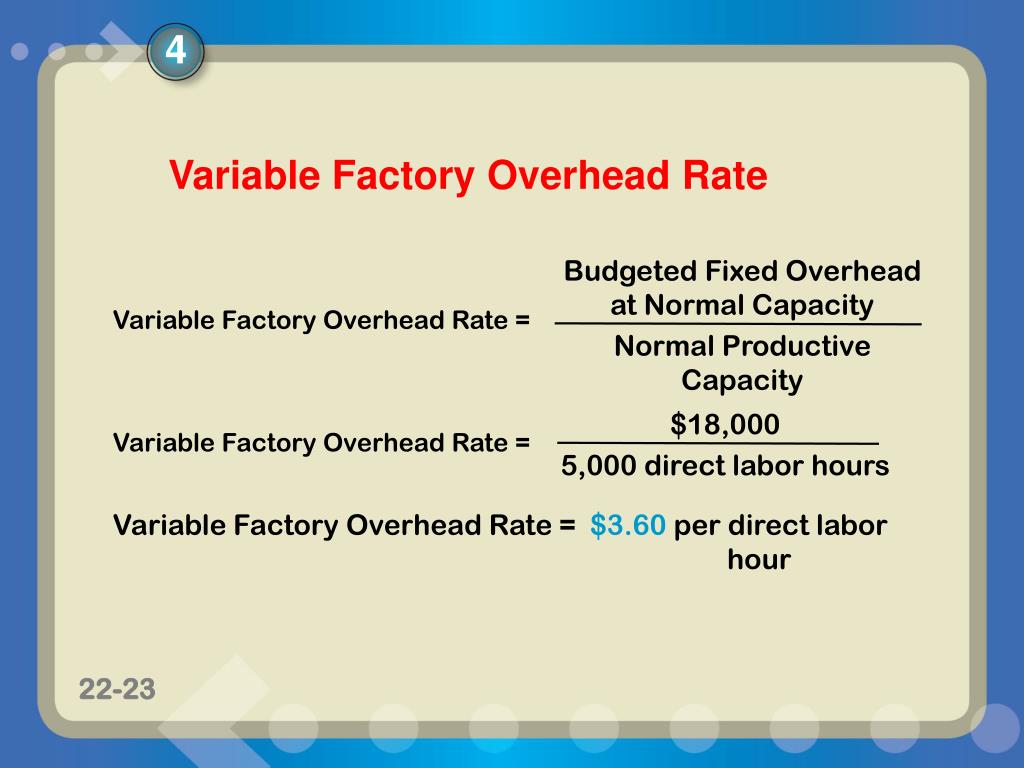

  23. $18,000 5,000 direct labor hours Variable Factory Overhead Rate = 4 Variable Factory Overhead Rate Budgeted Fixed Overhead at Normal Capacity Normal Productive Capacity Variable Factory Overhead Rate = Variable Factory Overhead Rate = $3.60 per direct labor hour

  24. Standard Hours for Actual Units Produced Variable Factory Overhead Rate × 4 Variable Factory Overhead Variances Variable Factory Overhead Controllable Variance Actual Variable Factory Overhead Budgeted Variable Factory Overhead = –

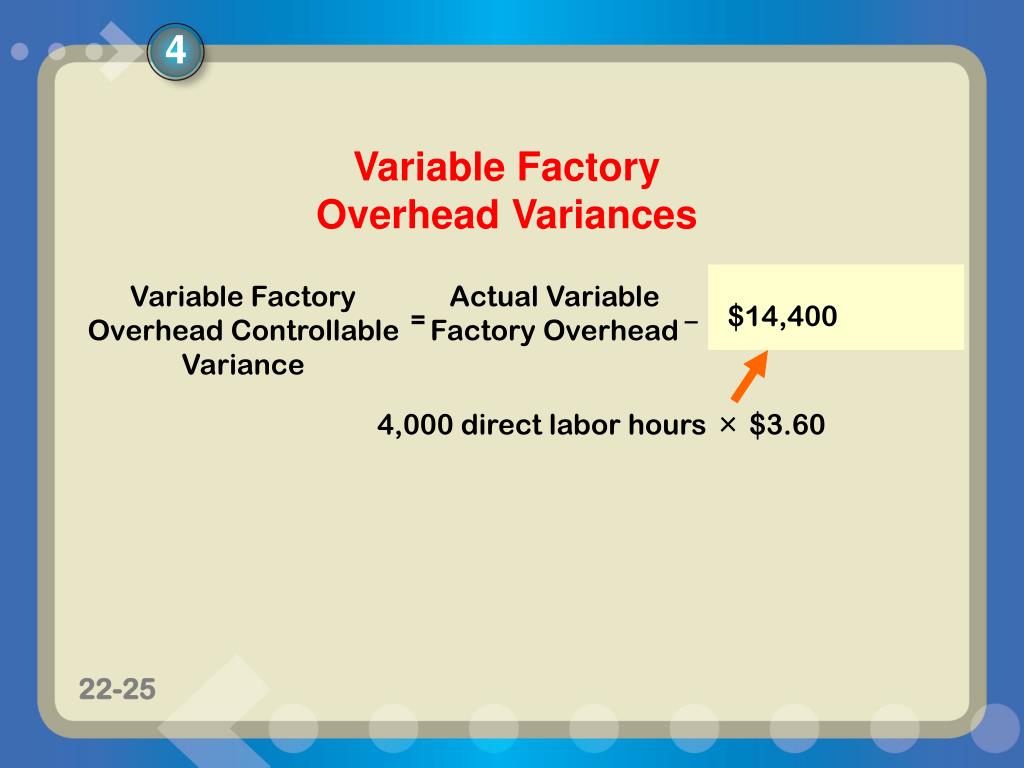

  25. $14,400 4 Variable Factory Overhead Variances Variable Factory Overhead Controllable Variance Actual Variable Factory Overhead Budgeted Variable Factory Overhead = – 4,000 direct labor hours × $3.60

  26. $14,400 Variable Factory Overhead Controllable Variance $10,400 – $14,400 = Variable Factory Overhead Controllable Variance $(4,000) Favorable Variance = 4 Variable Factory Overhead Variances Variable Factory Overhead Controllable Variance Actual Variable Factory Overhead = –

  27. Fixed Factory Overhead Volume Variance 5,000 direct labor hours 4,000 direct labor hours – $2.40 = × Fixed Factory Overhead Volume Variance $2,400 Unfavorable Variance = 4 Fixed Factory Overhead Variances Fixed Factory Overhead Rate Fixed Factory Overhead Volume Variance Standard Hours for 100% of Normal Capacity Standard Hours for Actual Units Produced × – =

  28. Standard Hours for Actual Units Produced Total Factory Overhead Rate × 4 Total Factory Overhead Cost Variance Actual Factory Overhead Applied Factory Overhead – =

  29. Total Factory Overhead Cost Variance Actual Factory Overhead Applied Factory Overhead – = 4 $24,000 5,000 jeans x 0.80 direct labor hr. per pair of jeans $6.00 ×

  30. 4 Total Factory Overhead Cost Variance Actual Factory Overhead Applied Factory Overhead – = 5,000 jeans x 0.80 direct labor hr. per pair of jeans $6.00 ×

  31. Applied Factory Overhead Total Factory Overhead Cost Variance Actual Factory Overhead - = Total Factory Overhead Cost Variance $24,000 $22,400 – = Total Factory Overhead Cost Variance = $(1,600) Favorable Variance 4 $24,000

  32. 4,000 hours × $6.00 per hour $10,400 + $12,000 4 Factory Overhead Variances and the Factory Overhead Account Factory Overhead Actual factory overhead 22,400 Applied factory overhead 24,000

  33. Budgeted Factory Overhead for Amount Produced Variable factory OH $14,400 Fixed factory OH 12,000 Total $26,400 4 Factory Overhead Actual factory overhead 22,400 Applied factory overhead 24,000 Applied Factory Overhead $24,000 Actual Factory Overhead $22,400 $(4,000) F $2,400 U Controllable Variance Volume Variance $(1,600) F Total Factory Overhead Cost Variance

  34. 5 Journalize the entries for recording standards in the accounts and prepare an income statement that includes variances from standards. 22-34

  35. 5 Recording and Reporting Variances from Standards Western Rider Inc. purchased, on account, the 7,300 square yards of blue denim at $5.50 per square yard. The standard price was $5.00 per square yard.

  36. $5.50 × 7,300 = $40,150 $5.00 × 7,300 = $36,500 $3,650 U Direct materials price variance 5 Western Rider Inc.’s Purchase of Materials Entry

  37. 5 Western Rider Inc. used 7,300 square yards of blue denim to produce 5,000 pairs of XL jeans, compared to the standard of 7,500 square yards.

  38. $5.00 × 7,500 = $37,500 $5.00 × 7,300 = $36,500 $(1,000) F Direct materials quantity variance 5 Western Rider Inc.’s Use of Materials Entry

  39. 6 Describe and provide examples of nonfinancial performance measures. 22-39

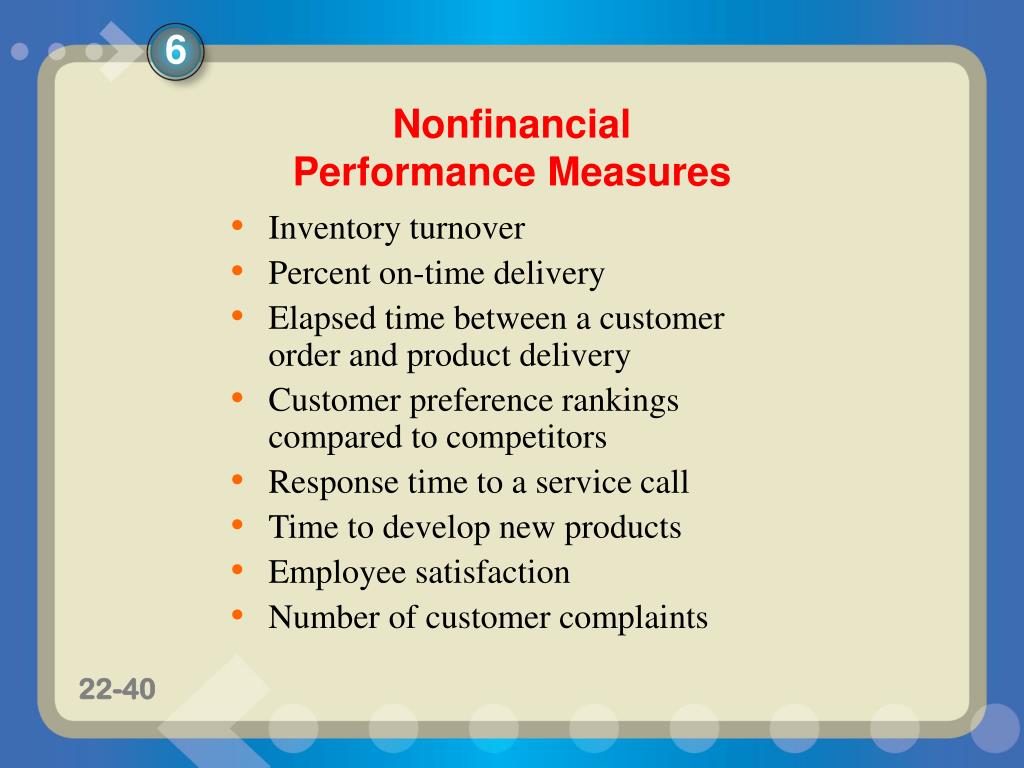

  40. 6 Nonfinancial Performance Measures • Inventory turnover • Percent on-time delivery • Elapsed time between a customer order and product delivery • Customer preference rankings compared to competitors • Response time to a service call • Time to develop new products • Employee satisfaction • Number of customer complaints

  41. 6 Nonfinancial measures can be linked to either the inputs or outputs of an activity or process. A process is a sequence of activities linked together for performing a particular task.
