TSF Upgrade

TSF Upgrade. Project Overview Resources Plans and Timetable Hardware + Tests : Scott Kolya VHDL + Tests: Marc Kelly. Bristol – Manchester - RAL. Nicolo de Groot 11th April 2003 Final Design Review. From … To …. History.

joella
Télécharger la présentation

TSF Upgrade

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. TSF Upgrade Project Overview Resources Plans and Timetable Hardware + Tests : Scott Kolya VHDL + Tests: Marc Kelly Bristol – Manchester - RAL Nicolo de Groot 11th April 2003 Final Design Review

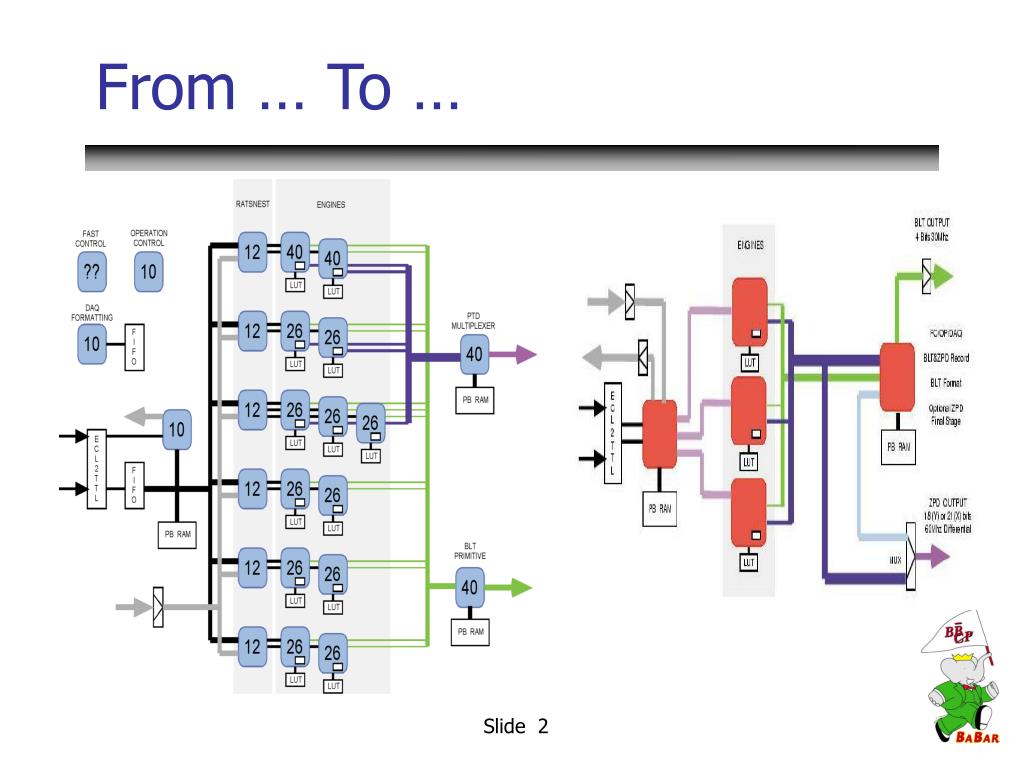

  2. From … To …

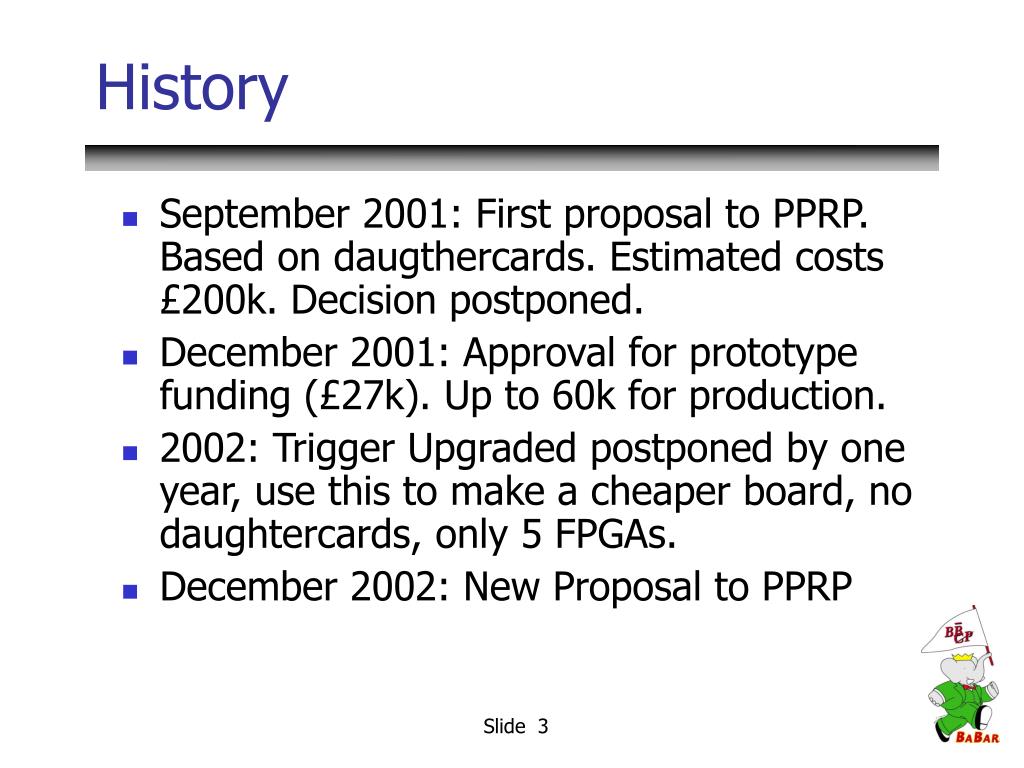

  3. History • September 2001: First proposal to PPRP. Based on daugthercards. Estimated costs £200k. Decision postponed. • December 2001: Approval for prototype funding (£27k). Up to 60k for production. • 2002: Trigger Upgraded postponed by one year, use this to make a cheaper board, no daughtercards, only 5 FPGAs. • December 2002: New Proposal to PPRP

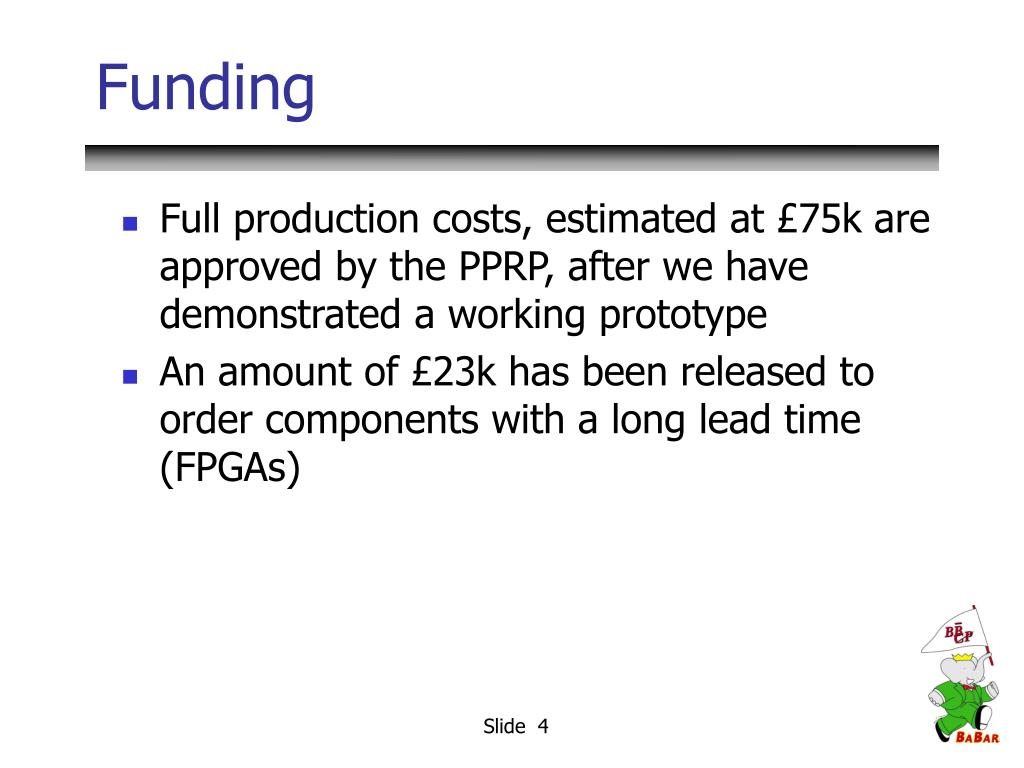

  4. Funding • Full production costs, estimated at £75k are approved by the PPRP, after we have demonstrated a working prototype • An amount of £23k has been released to order components with a long lead time (FPGAs)

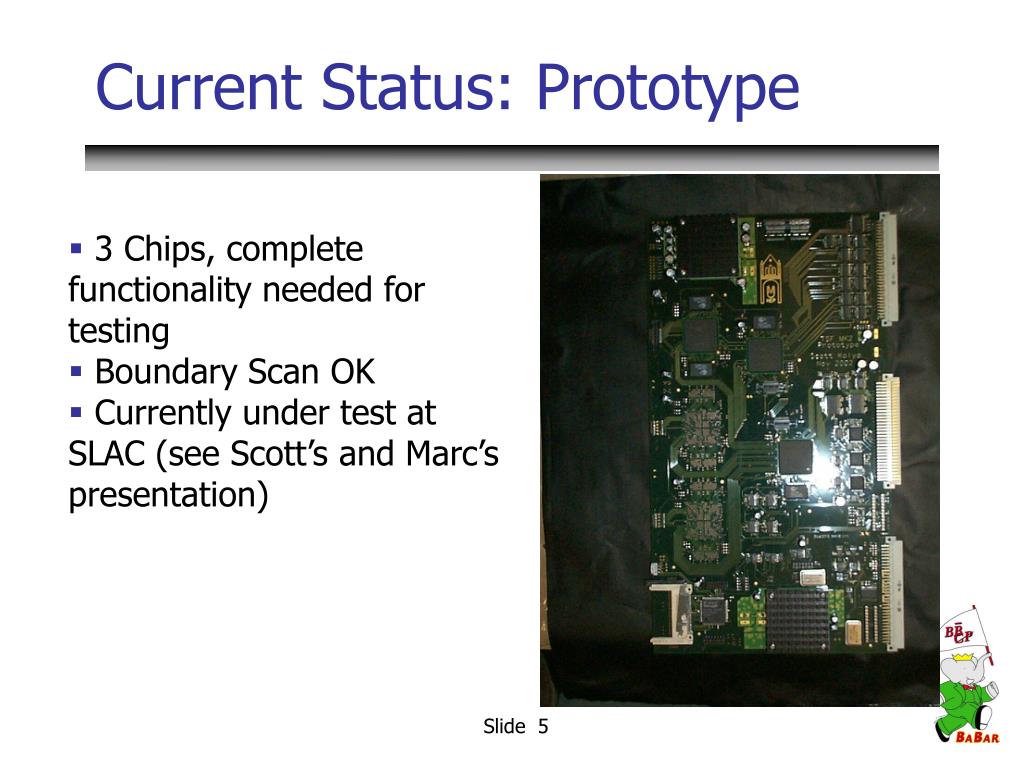

  5. Current Status: Prototype • 3 Chips, complete functionality needed for testing • Boundary Scan OK • Currently under test at SLAC (see Scott’s and Marc’s presentation)

  6. UK Manpower • Physicists / Management • Roger Barlow, Manchester • Nicolo de Groot, RAL • Technical effort • Jamie Boyd, Postdoc, Bristol, 100% • Dave Mercer, Engineer, Manchester, 50% • Scott Kolya, Postdoc, Manchester, 50% • Marc Kelly, Bristol, 100% • These are time integrated averages.

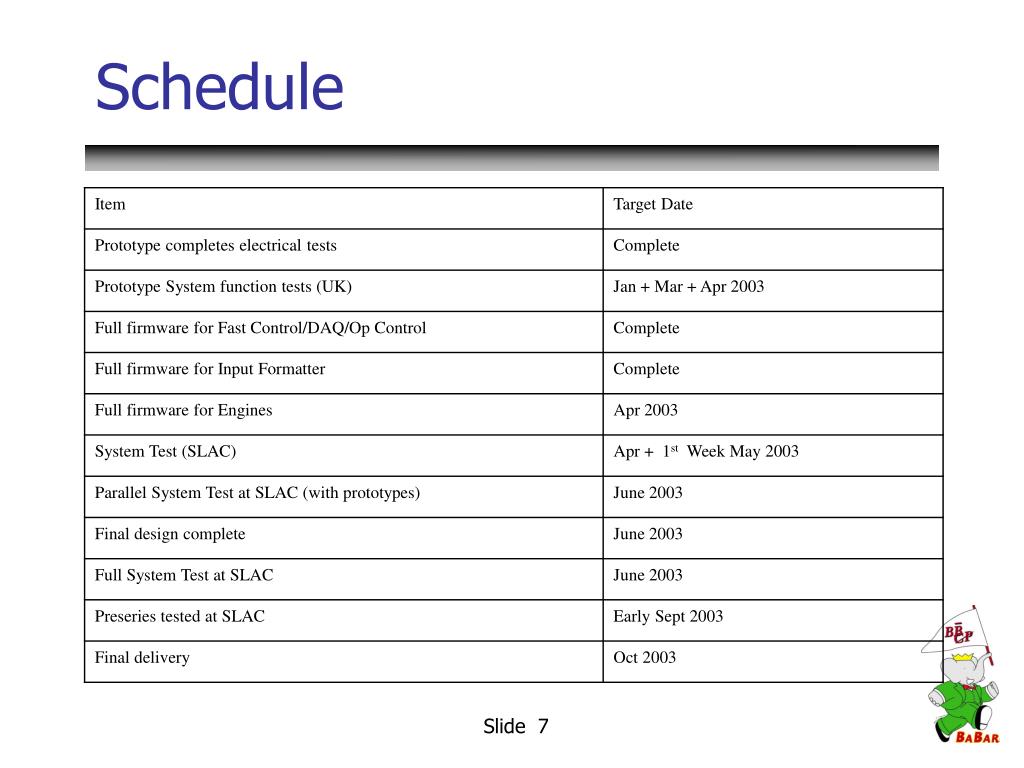

  7. Schedule

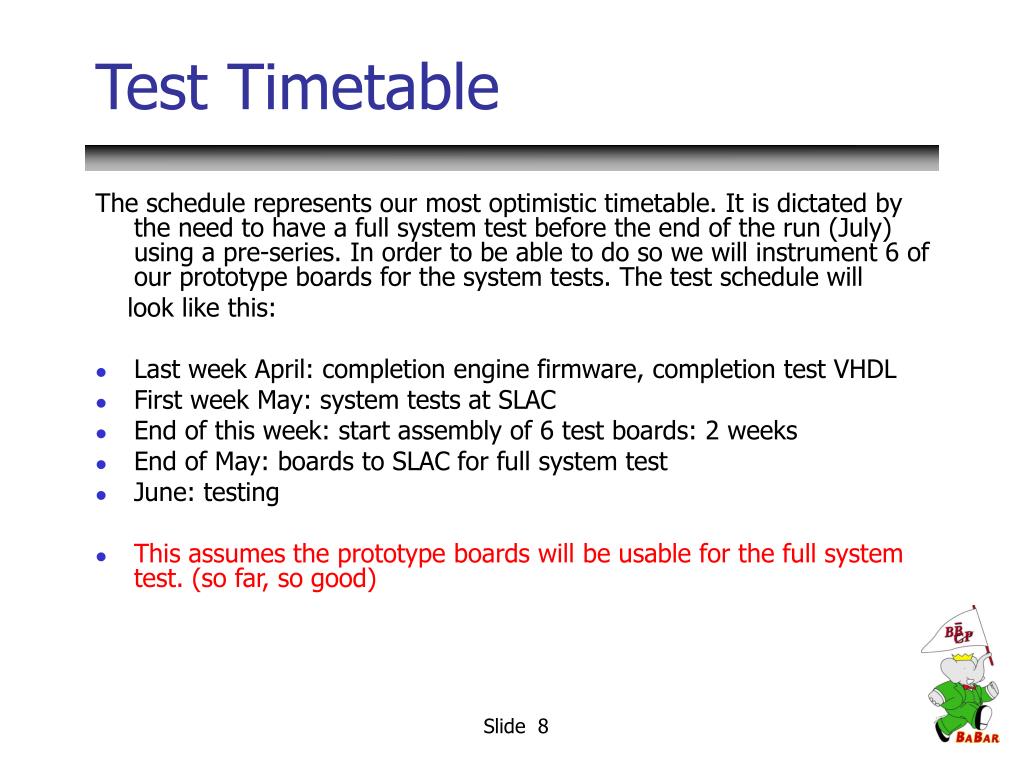

  8. Test Timetable The schedule represents our most optimistic timetable. It is dictated by the need to have a full system test before the end of the run (July) using a pre-series. In order to be able to do so we will instrument 6 of our prototype boards for the system tests. The test schedule will look like this: • Last week April: completion engine firmware, completion test VHDL • First week May: system tests at SLAC • End of this week: start assembly of 6 test boards: 2 weeks • End of May: boards to SLAC for full system test • June: testing • This assumes the prototype boards will be usable for the full system test. (so far, so good)

  9. Production Timetable • End June: final design, start production • End August: pre series ready • Early September: test at SLAC • September: production • October: delivery • Currently beam back on September 5th. Can we speed things up ?

  10. Summary • Complete redesign of TDF completed. • Prototype is there, testing. • Confident that we can deliver. • Some worries about the schedule. • Maybe on time but under budget
