SOFIA SSSC Program Status Robert Meyer Program Manager February 18, 2010

SOFIA SSSC Program Status Robert Meyer Program Manager February 18, 2010. Significant Progress!. Open Door Flights have been highly successful 100% Open Door Flight completed; December 18, 2009

katy
Télécharger la présentation

SOFIA SSSC Program Status Robert Meyer Program Manager February 18, 2010

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. SOFIA SSSC Program Status Robert Meyer Program Manager February 18, 2010

  2. Significant Progress! • Open Door Flights have been highly successful • 100% Open Door Flight completed; December 18, 2009 • The Upper Rigid Door (URD) was opened incrementally to 100% of the Aperture opening, exposing the Cavity to the atmosphere for initial internal airflow and acoustics characterization tests • Initial observations of the characteristics of the aircraft with the URD open up to 100% were benign, with no acoustics or aircraft handling issues • Two Door Closed flights completed; January 14-15, 2010 • TA Activation flights successfully completed • Aircraft Functional Check Flight (FCF), clean-up flight • Envelope Expansion flight series started with the 23o (lowest) Aperture position on January 29, 2010 and completed Feb 11 • 10%, 40%, 70% and 100% Door Open flight envelope expansion at low altitudes / low speeds nearly completed (Watch Flight Test Video) • Landing with door open at 40% completed!

  3. Door Open 40 % Landing, Feb. 11, 2010

  4. Challenges • Actual Schedules have taken longer than planned • Analyzing actual data to adjust plans • Recent schedule performance has taken about 1.4 times longer than 70% JCL • Flight test objectives have been successful, but taking longer than anticipated • Weather • Additional flights • Cavity Door Drive (CDDS) anomaly • Dryden evaluating ideas to shorten path to ISF • Addition of staff needed to shorten Mission Systems installations and checkout • More co-location at the DAOF along with key test assets • Parallelizing appropriate serial tasks • Scrubbing flight test matrix / approach • Program working mitigation approaches for longer-term schedule • Established a separate Segment 3 planning and schedule development team • Evaluating several shorter downtimes vs. 1 extended downtime in Segment 3

  5. Parallel Activities to reduce Segment 3 risk Mike, Tom John, Ting, Eric Planning Seg III Tracking Seg III Planning Activity MCCS Tracking Seg II Detailed plan & MCCS Upgrades Activity Ongoing Flight Activity 2010 2012 2011 Kevin, Dave, & John

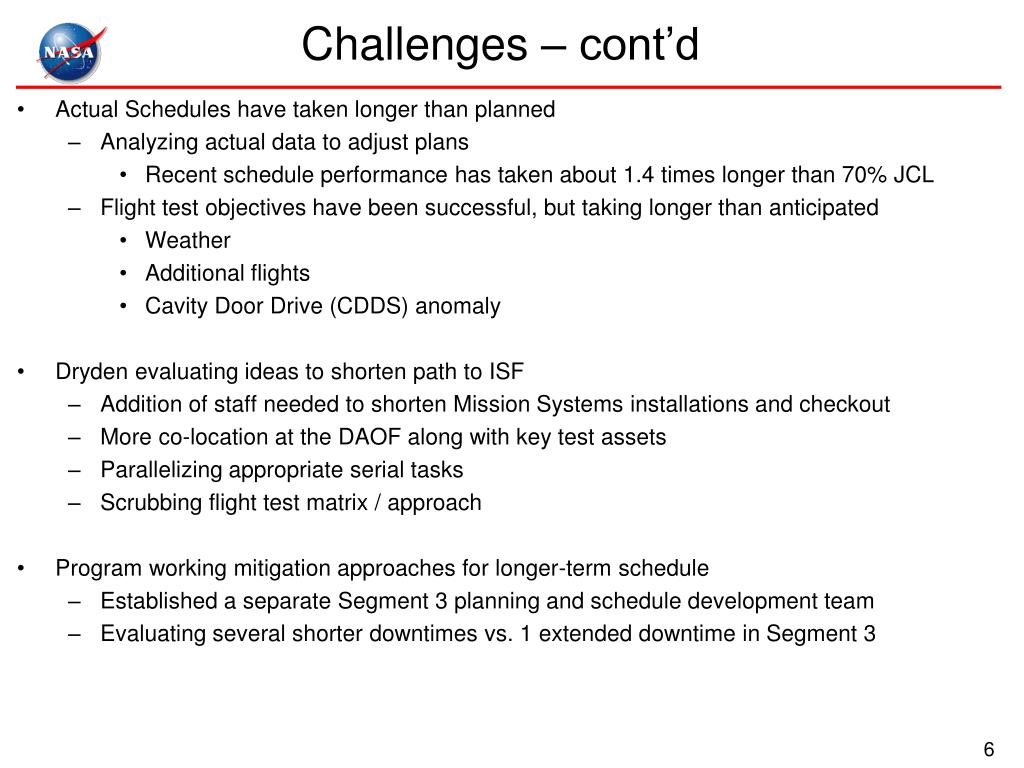

  6. Challenges – cont’d • Actual Schedules have taken longer than planned • Analyzing actual data to adjust plans • Recent schedule performance has taken about 1.4 times longer than 70% JCL • Flight test objectives have been successful, but taking longer than anticipated • Weather • Additional flights • Cavity Door Drive (CDDS) anomaly • Dryden evaluating ideas to shorten path to ISF • Addition of staff needed to shorten Mission Systems installations and checkout • More co-location at the DAOF along with key test assets • Parallelizing appropriate serial tasks • Scrubbing flight test matrix / approach • Program working mitigation approaches for longer-term schedule • Established a separate Segment 3 planning and schedule development team • Evaluating several shorter downtimes vs. 1 extended downtime in Segment 3

  7. Conceptual Segment 3 downtime re-structure • Avionics Upgrade ≈ 3 months A • RVSM 3-4 weeks? A • TA Upgrades ≈ 2 months A? • WVM ≈ 2 weeks B • Insulation ≈ 2 months off a/c C • Mirror Coating ≈ 2-3 months C • Cavity Cooling? ≈ 2 months? B • Coordinate Transform Updates* • CDDS upgrades? = 2 months** • AIU wiring start? • DAS wiring start? • MADS upgrades (Alarms/Alerts) 2011 • Cavity Cooling? (finish?) • AIU (MCCS) ≈ 2 months A • FMI (MCCS) ≈ 1 month A • DAS (MCCS) ≈ 3 months A • Workstations (MCCS) A 2012 LOC Coordinate Transform Updates EPO CDDS and CECS upgrades 2012 2013 2013 FOC 2014 • Get Science data to the community earlier (SSPC recommendation) • Maintains Program momentum • Provides addition risk margin for downtimes

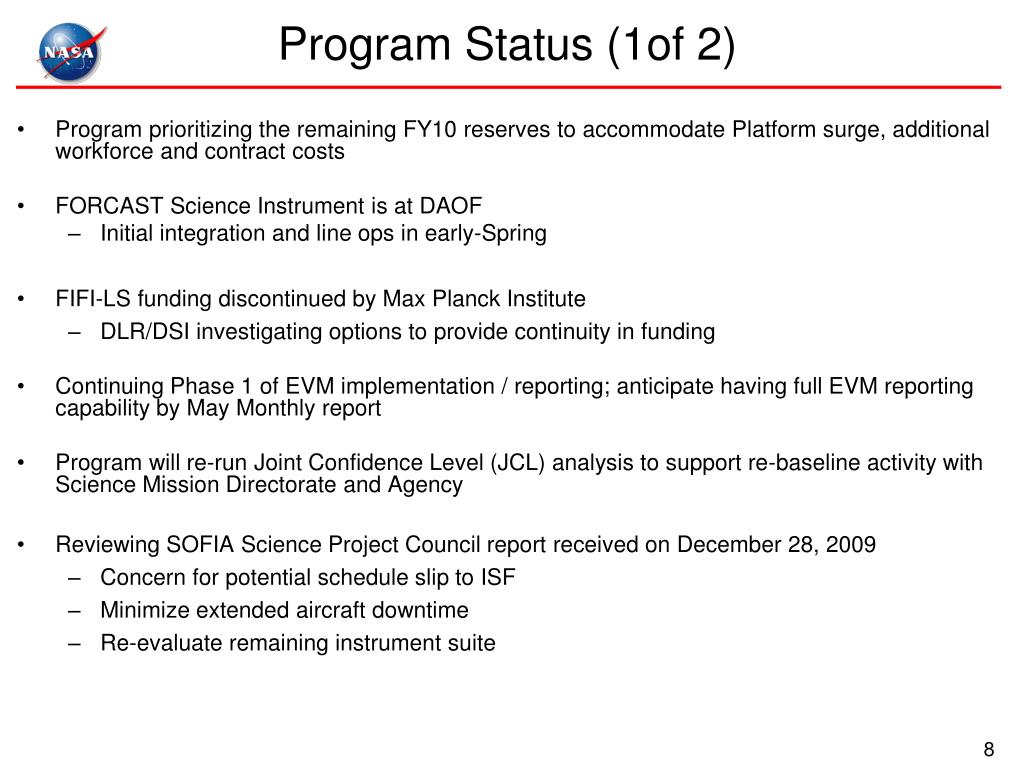

  8. Program Status (1of 2) • Program prioritizing the remaining FY10 reserves to accommodate Platform surge, additional workforce and contract costs • FORCAST Science Instrument is at DAOF • Initial integration and line ops in early-Spring • FIFI-LS funding discontinued by Max Planck Institute • DLR/DSI investigating options to provide continuity in funding • Continuing Phase 1 of EVM implementation / reporting; anticipate having full EVM reporting capability by May Monthly report • Program will re-run Joint Confidence Level (JCL) analysis to support re-baseline activity with Science Mission Directorate and Agency • Reviewing SOFIA Science Project Council report received on December 28, 2009 • Concern for potential schedule slip to ISF • Minimize extended aircraft downtime • Re-evaluate remaining instrument suite

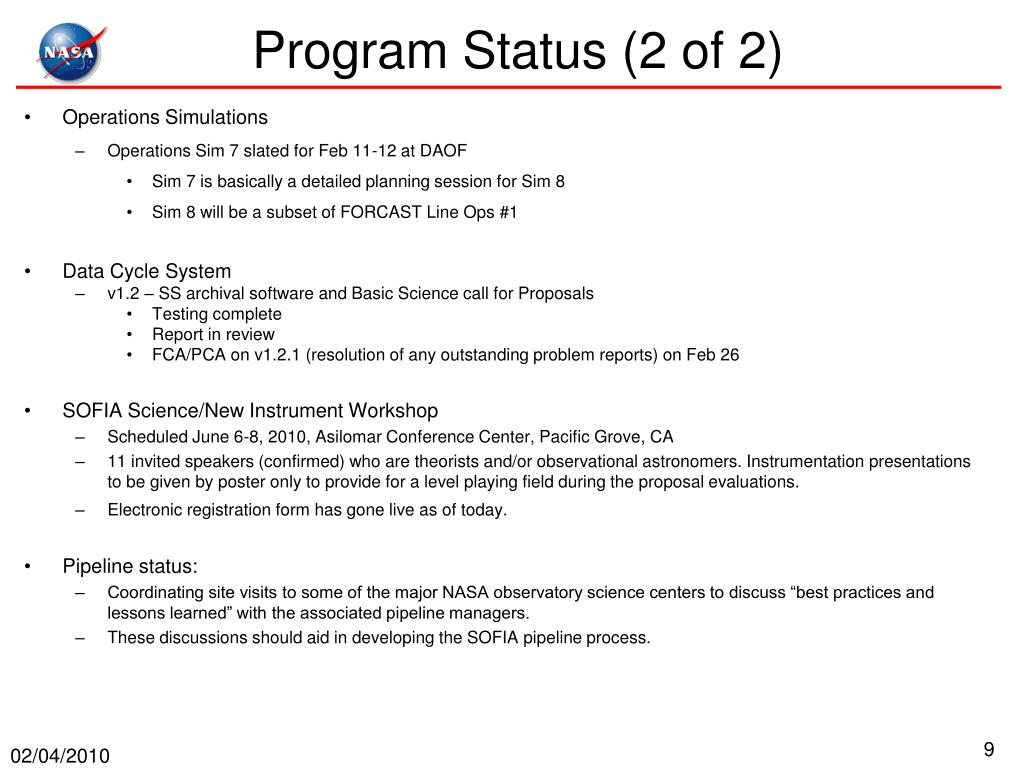

  9. Program Status (2 of 2) • Operations Simulations • Operations Sim 7 slated for Feb 11-12 at DAOF • Sim 7 is basically a detailed planning session for Sim 8 • Sim 8 will be a subset of FORCAST Line Ops #1 • Data Cycle System • v1.2 – SS archival software and Basic Science call for Proposals • Testing complete • Report in review • FCA/PCA on v1.2.1 (resolution of any outstanding problem reports) on Feb 26 • SOFIA Science/New Instrument Workshop • Scheduled June 6-8, 2010, Asilomar Conference Center, Pacific Grove, CA • 11 invited speakers (confirmed) who are theorists and/or observational astronomers. Instrumentation presentations to be given by poster only to provide for a level playing field during the proposal evaluations. • Electronic registration form has gone live as of today. • Pipeline status: • Coordinating site visits to some of the major NASA observatory science centers to discuss “best practices and lessons learned” with the associated pipeline managers. • These discussions should aid in developing the SOFIA pipeline process.

  10. FORCAST at DAOF FORCAST Instrument Readiness Room Loading onto lab stand Just Unpacked

  11. Upcoming Events • Level 1 Delta Systems Requirement Review; February 16-17, 2010 • SOFIA Science Steering Committee (SSSC) in Palmdale; February 18, 2010 • Science Instrument Trimester Review (SITR) at Palmdale; February 19, 2010 • OCE Assessment; Week of March 1, 2010 • Standing Review Board; March 22-25, 2010 • Completion of 23-degree Envelope Expansion flights; late-March, 2010 • FORCAST line ops April/May 2010 • SMD Program Management Council; April 14, 2010 • Agency Program Management Council; April 21, 2010 • TA Characterization and first light flight late April or early May • Initial Science Flight (ISF) fall 2010

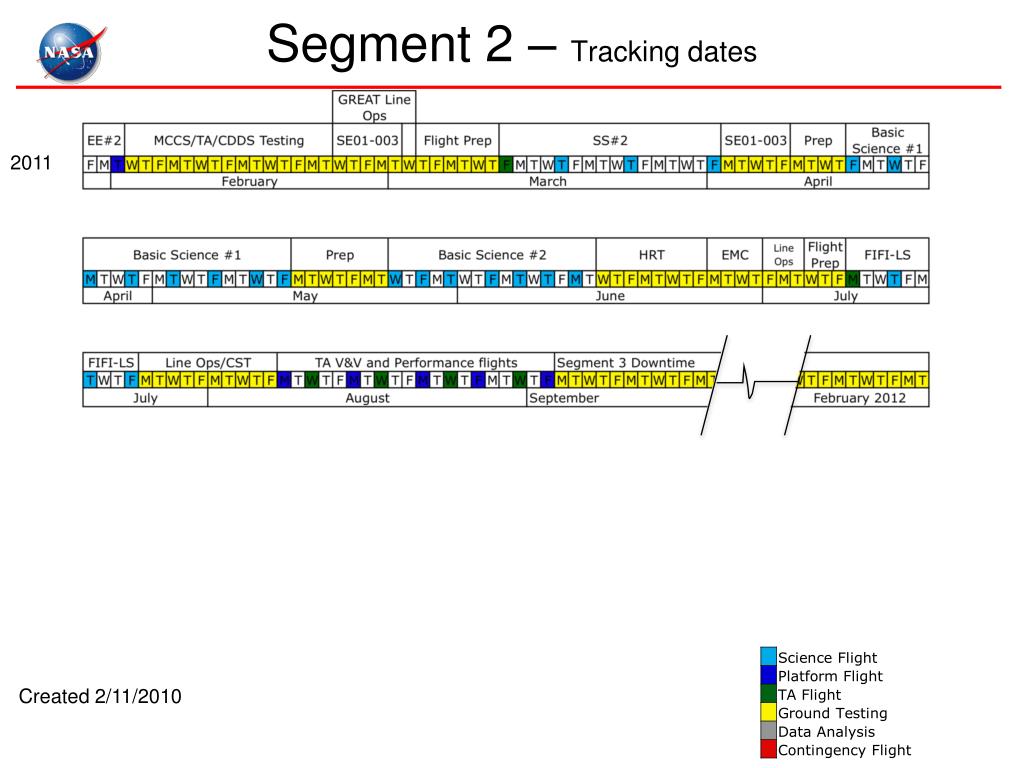

  12. Segment 2 – Tracking dates 2010 TA Characterization/ First Light attempt TA Misalignment (daytime) TA Characterization ISF Created 2/11/2010

  13. Segment 2 – Tracking dates 2011 Created 2/11/2010

  14. Segment 3 – Tracking 2012 LOC 2012 2013 2013 FOC 2014 2014 Created 2/2/2010

  15. Program Key Milestones Re-sequenced to move TA Characterization / First Light Earlier

  16. Level - 2 Waterfall

  17. Level - 3 Waterfall

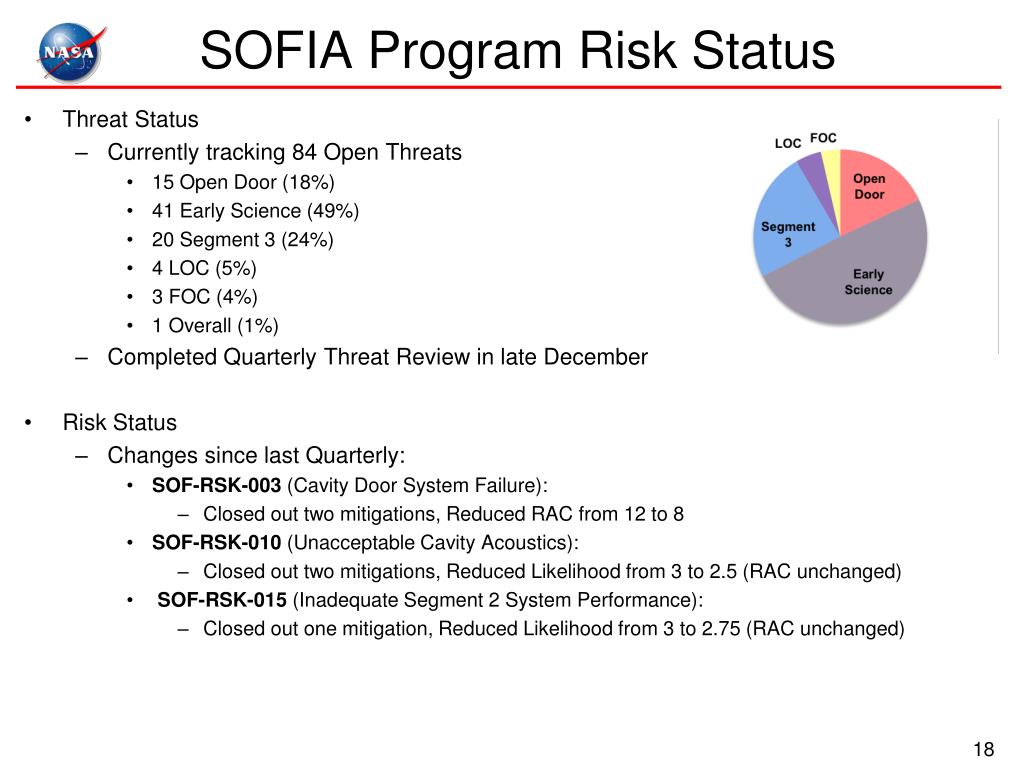

  18. SOFIA Program Risk Status • Threat Status • Currently tracking 84 Open Threats • 15 Open Door (18%) • 41 Early Science (49%) • 20 Segment 3 (24%) • 4 LOC (5%) • 3 FOC (4%) • 1 Overall (1%) • Completed Quarterly Threat Review in late December • Risk Status • Changes since last Quarterly: • SOF-RSK-003 (Cavity Door System Failure): • Closed out two mitigations, Reduced RAC from 12 to 8 • SOF-RSK-010 (Unacceptable Cavity Acoustics): • Closed out two mitigations, Reduced Likelihood from 3 to 2.5 (RAC unchanged) • SOF-RSK-015 (Inadequate Segment 2 System Performance): • Closed out one mitigation, Reduced Likelihood from 3 to 2.75 (RAC unchanged)

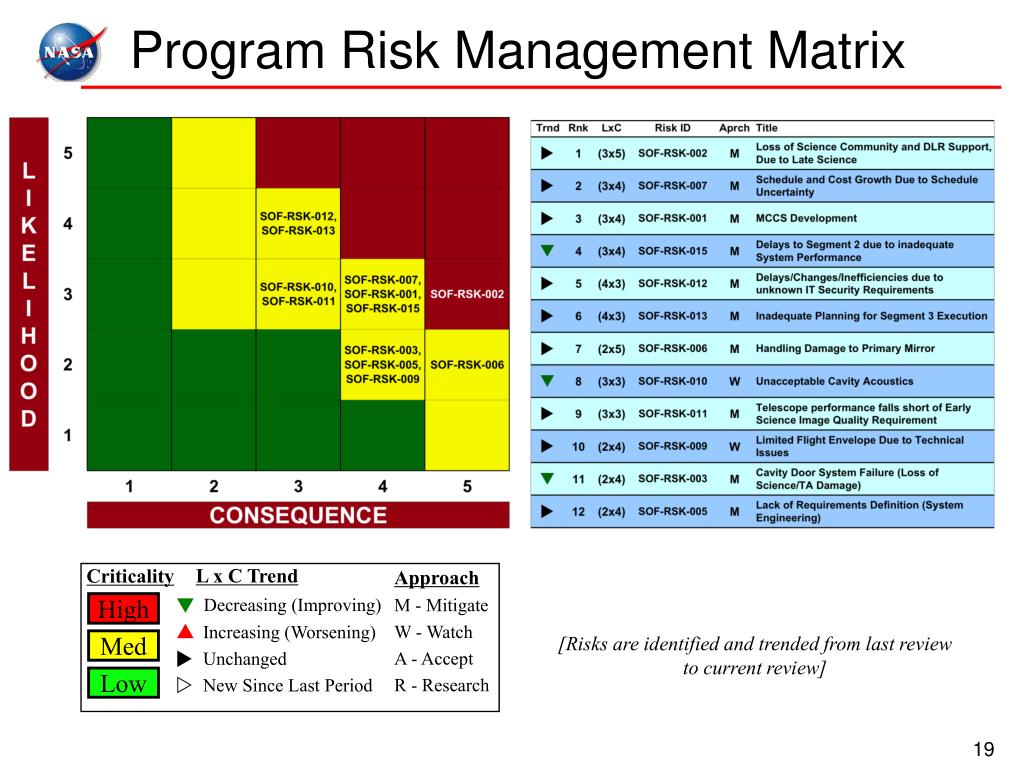

  19. Program Risk Management Matrix L x C Trend Decreasing (Improving) Increasing (Worsening) Unchanged New Since Last Period Approach M - Mitigate W - Watch A - Accept R - Research Criticality  High p [Risks are identified and trended from last review to current review] Med   Low

  20. SOFIA Program Risk Waterfall * RAC as averaged over the 12 open Program Risks * TA Characterization and First Light Open Door V&V/FCF/Open Door Flight Mitigations

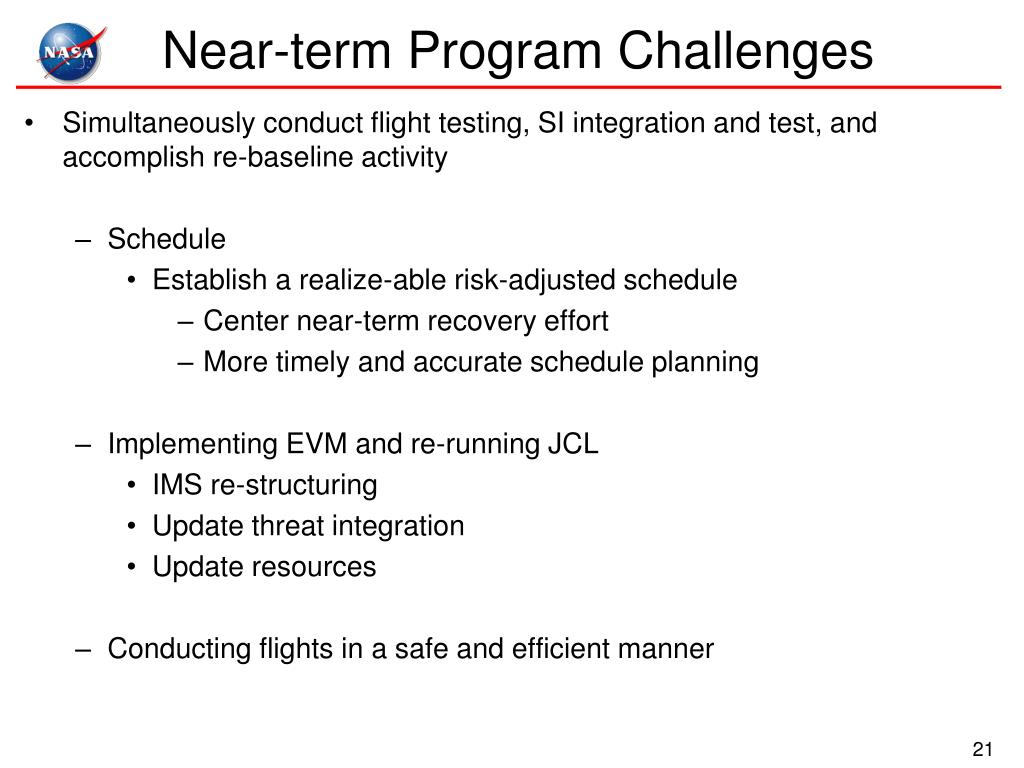

  21. Near-term Program Challenges • Simultaneously conduct flight testing, SI integration and test, and accomplish re-baseline activity • Schedule • Establish a realize-able risk-adjusted schedule • Center near-term recovery effort • More timely and accurate schedule planning • Implementing EVM and re-running JCL • IMS re-structuring • Update threat integration • Update resources • Conducting flights in a safe and efficient manner

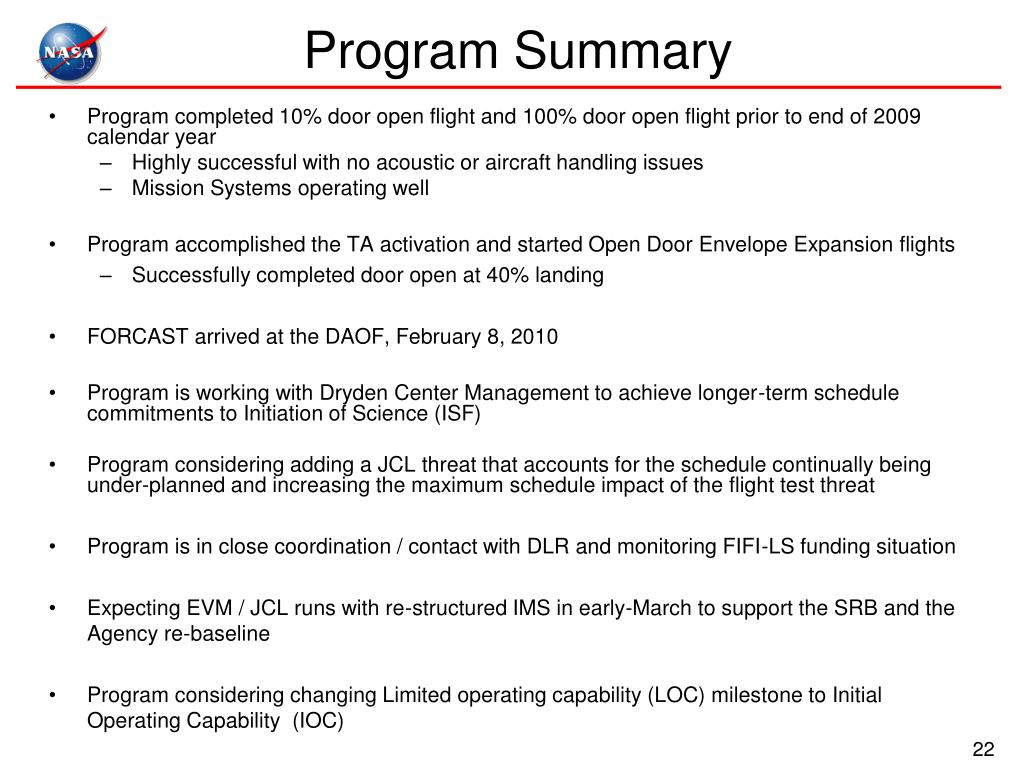

  22. Program Summary Program completed 10% door open flight and 100% door open flight prior to end of 2009 calendar year Highly successful with no acoustic or aircraft handling issues Mission Systems operating well Program accomplished the TA activation and started Open Door Envelope Expansion flights Successfully completed door open at 40% landing FORCAST arrived at the DAOF, February 8, 2010 Program is working with Dryden Center Management to achieve longer-term schedule commitments to Initiation of Science (ISF) Program considering adding a JCL threat that accounts for the schedule continually being under-planned and increasing the maximum schedule impact of the flight test threat Program is in close coordination / contact with DLR and monitoring FIFI-LS funding situation Expecting EVM / JCL runs with re-structured IMS in early-March to support the SRB and the Agency re-baseline Program considering changing Limited operating capability (LOC) milestone to Initial Operating Capability (IOC)
