Structure production data management

DESCRIPTION

Structure production data management. Margarita Saifoulina BE/RF/SR. European Organization for Nuclear Research. Outline. Data Management EDMS & MTF for RF structures Future prospects for EDMS / MTF solution. European Organization for Nuclear Research.

1 / 32

Télécharger la présentation

Structure production data management

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

Playing audio...

  1. Structure production data management Margarita Saifoulina BE/RF/SR European Organization for Nuclear Research

  2. Outline • Data Management • EDMS & MTF for RF structures • Future prospects for EDMS/MTF solution European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

  3. Data Management MTF-Travellers EDMS Web EDMS Common Layer Agile(AXALANT) Design data Drawings & Documents Infor EAM(D7i) Asset tracking Work management Other DBs Parameters Production data European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

  4. Data Organization EDMS MTF AX1.8-application Excel worksheet Axalant European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

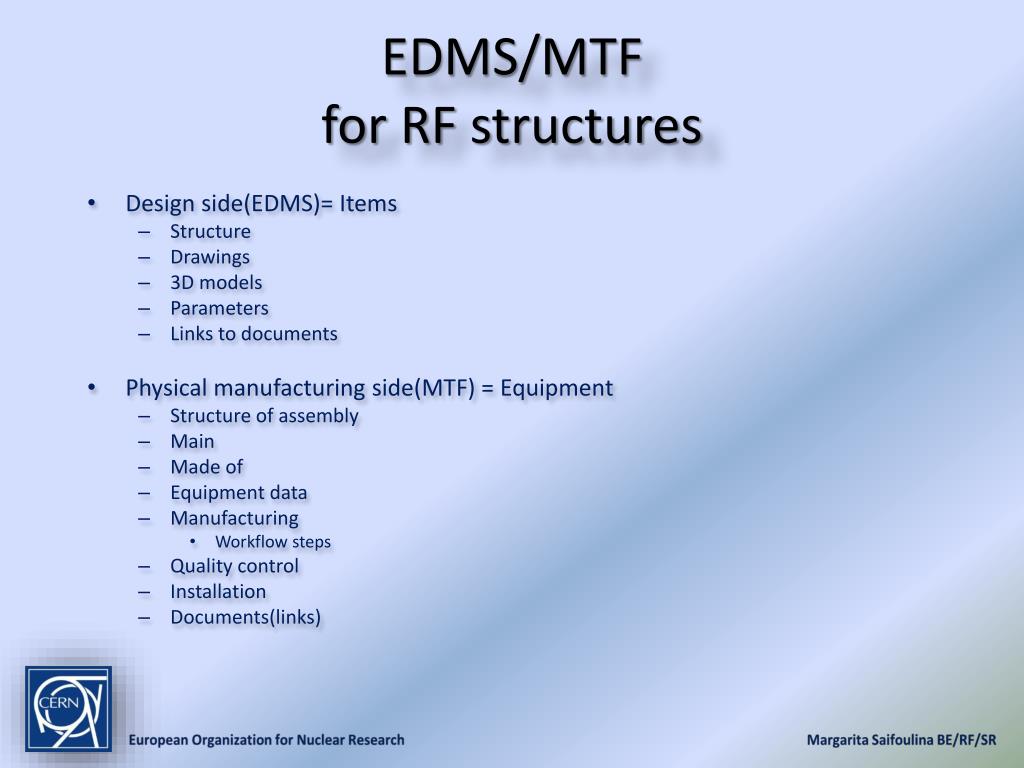

  5. EDMS/MTFfor RF structures • Design side(EDMS)= Items • Structure • Drawings • 3D models • Parameters • Links to documents • Physical manufacturing side(MTF) = Equipment • Structure of assembly • Main • Made of • Equipment data • Manufacturing • Workflow steps • Quality control • Installation • Documents(links) European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

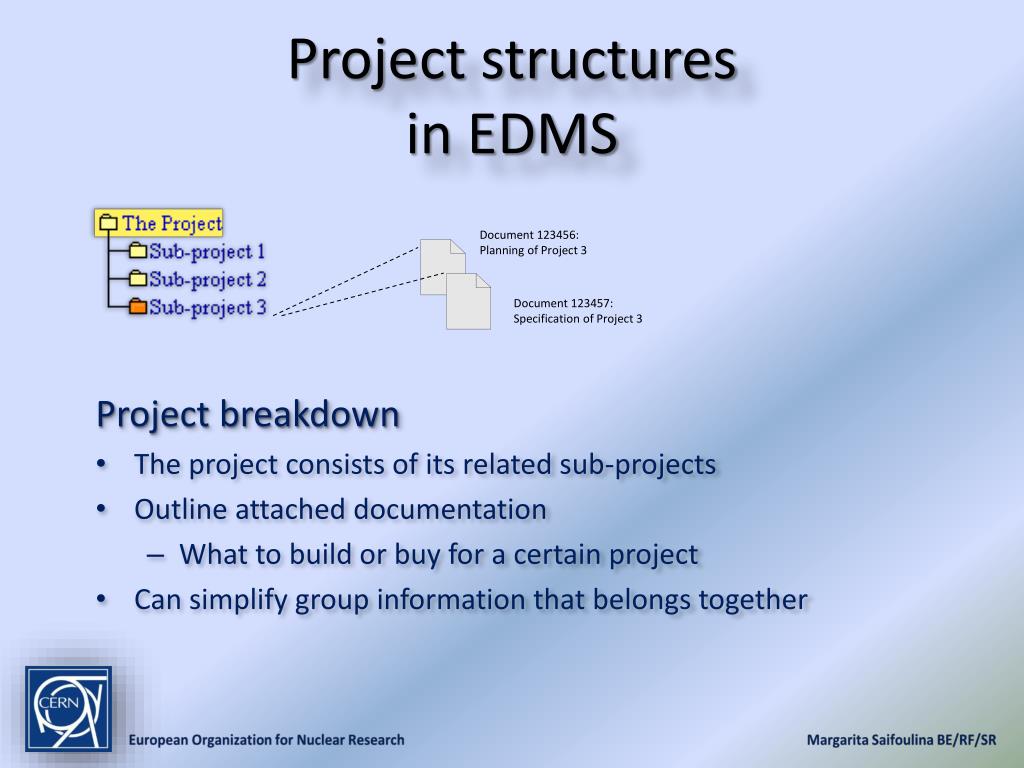

  6. Project structuresin EDMS Project breakdown • The project consists of its related sub-projects • Outline attached documentation • What to build or buy for a certain project • Can simplify group information that belongs together Document 123456: Planning of Project 3 Document 123457: Specification of Project 3 European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

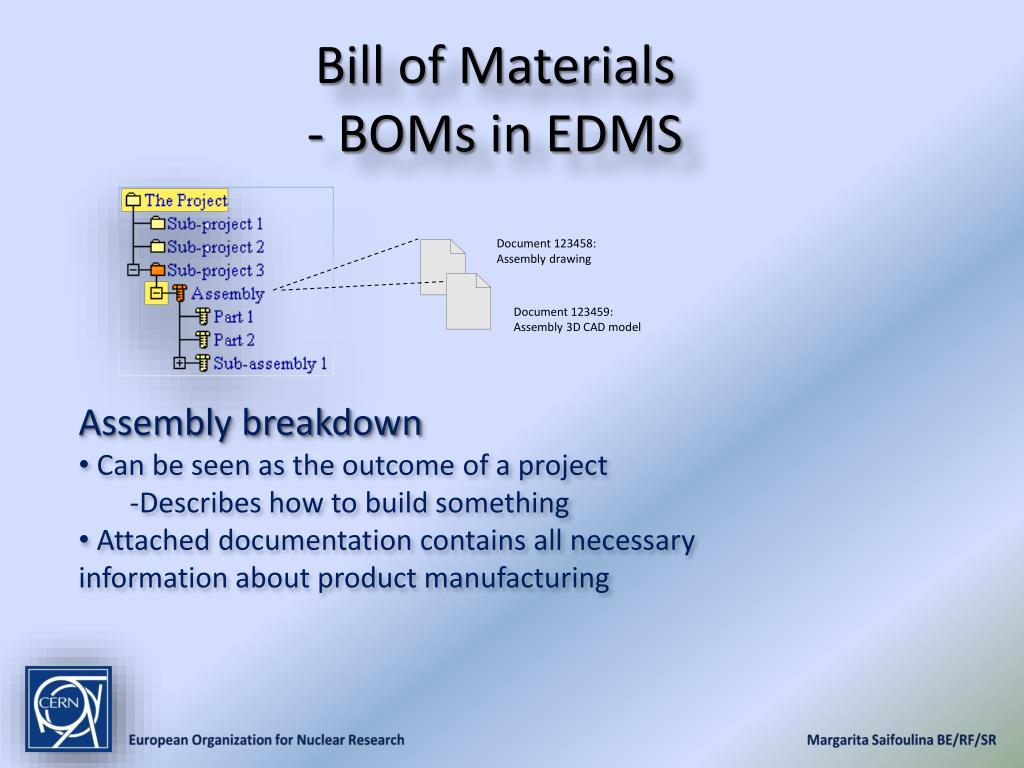

  7. Bill of Materials- BOMs in EDMS Document 123458: Assembly drawing Document 123459: Assembly 3D CAD model • Assembly breakdown • Can be seen as the outcome of a project • Describes how to build something • Attached documentation contains all necessary information about product manufacturing European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

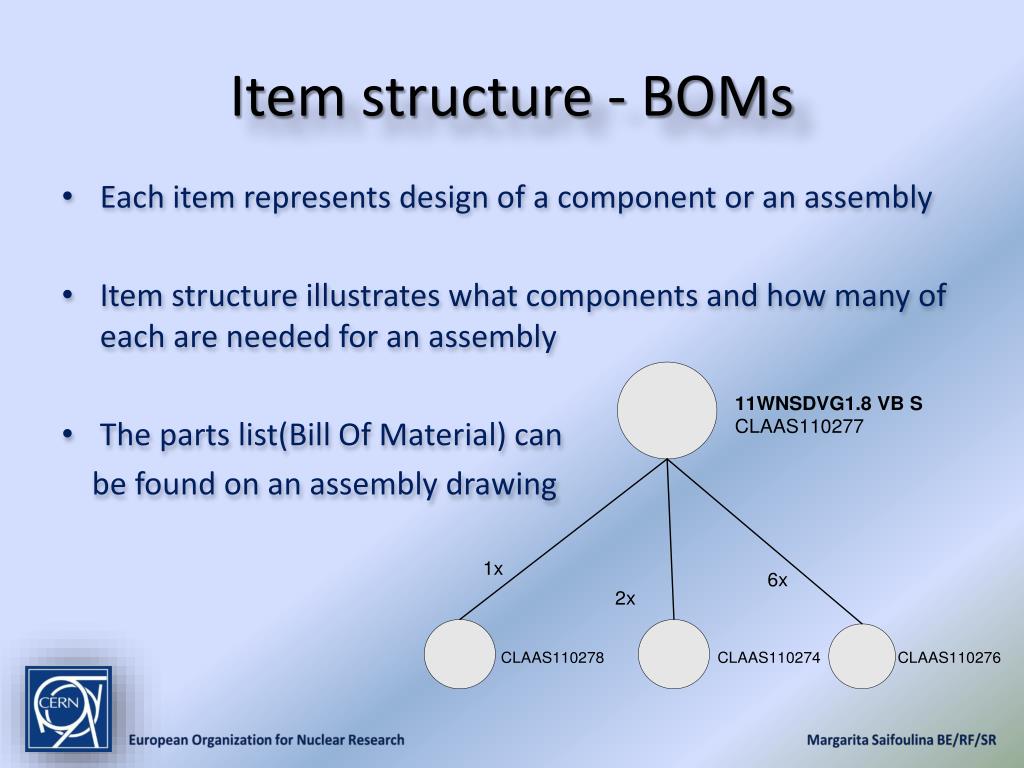

  8. Item structure - BOMs • Each item represents design of a component or an assembly • Item structure illustrates what components and how many of each are needed for an assembly • The parts list(Bill Of Material) can be found on an assembly drawing European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

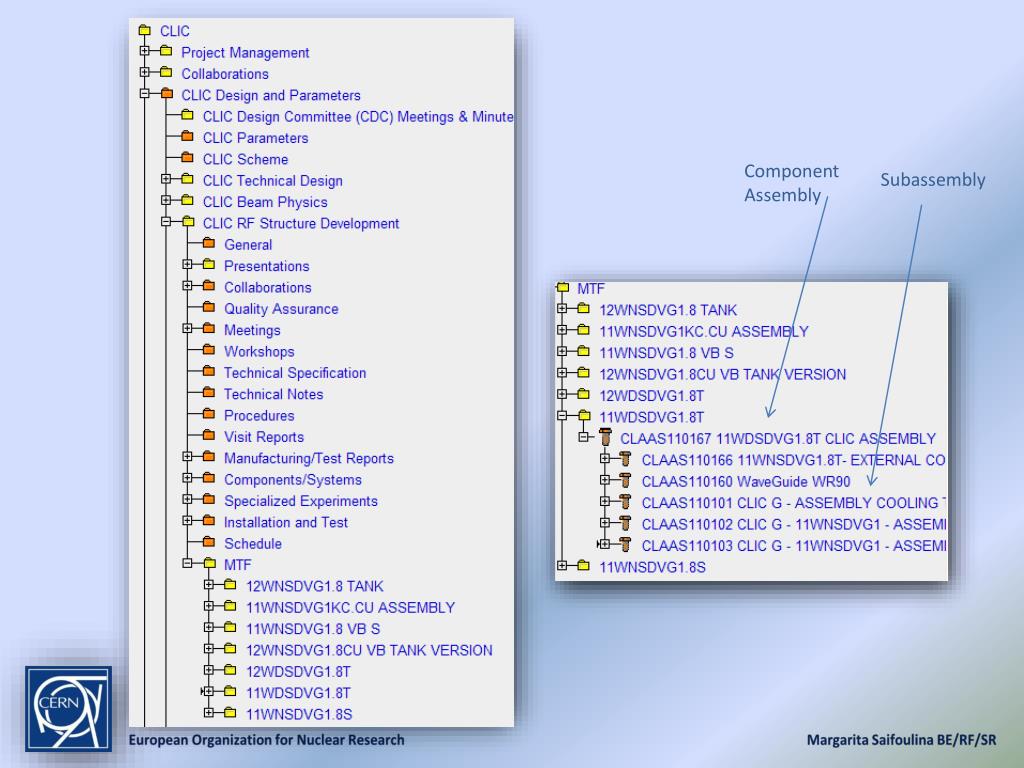

  9. Different breakdown structures

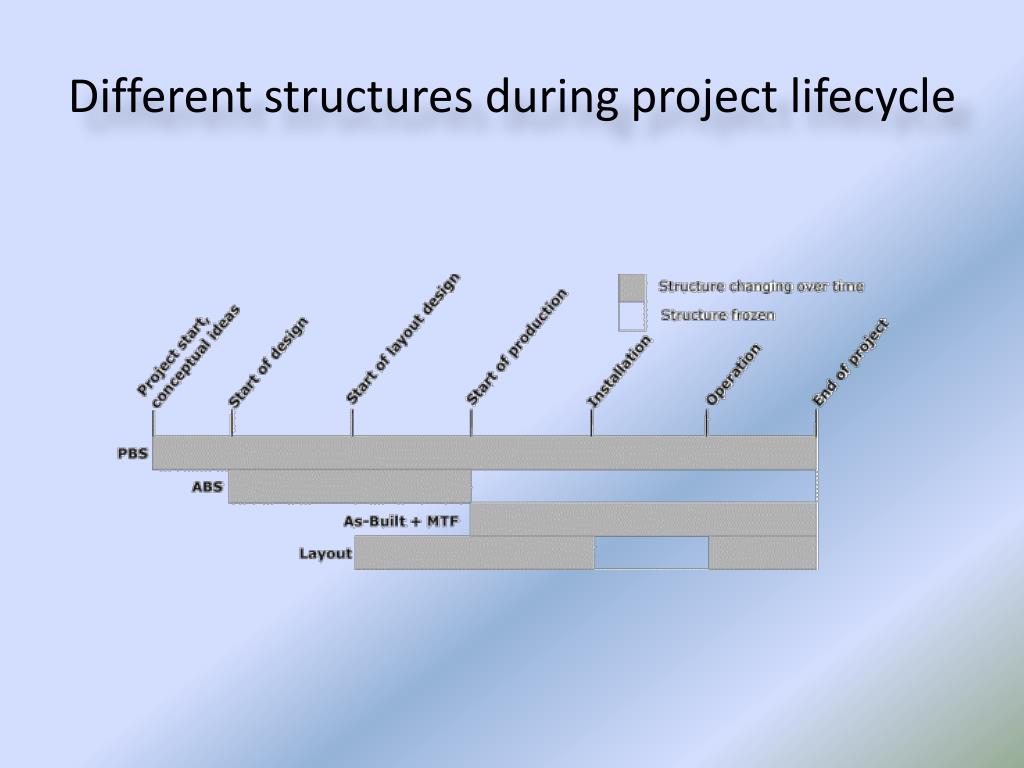

  10. Different structures during project lifecycle

  11. Product Lifecycle Management (PLM) CERN EDMS PLM = EDMS at CERN European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

  12. PLM in RF structure development • Documentation already available in EDMS/other systems • Needed an integrated interface for simplifying data management  Collecting data from several databases and systems not efficient • Demand for easier access to information about RF-structures’ PLM  European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

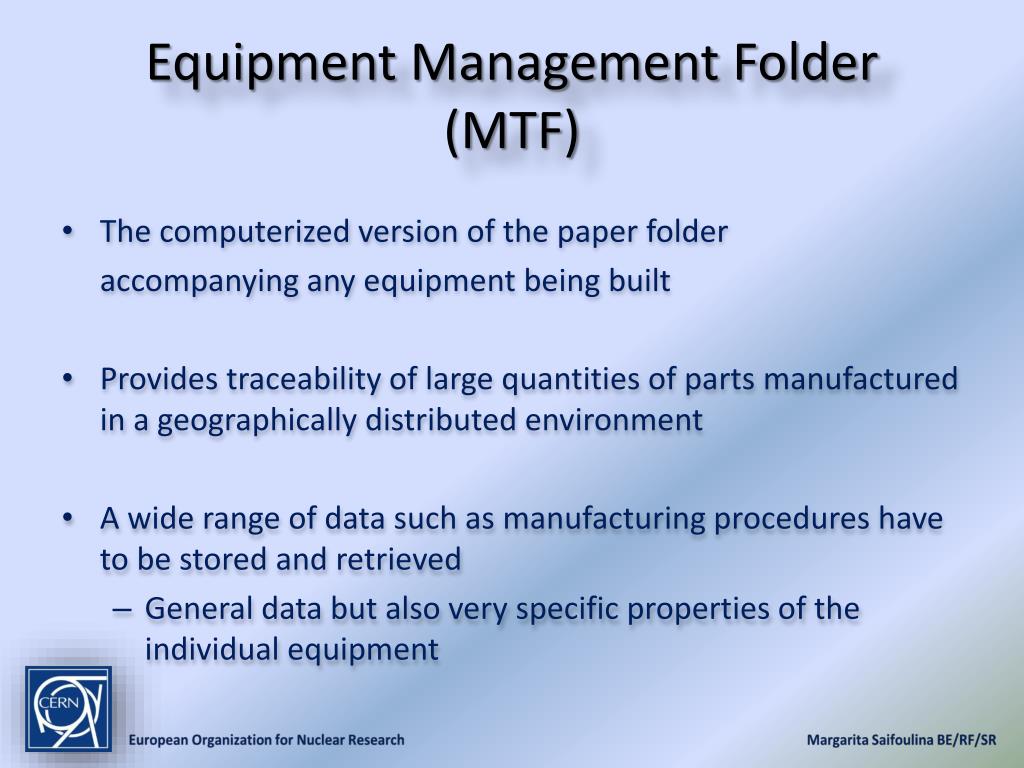

  13. Equipment Management Folder(MTF) • The computerized version of the paper folder accompanying any equipment being built • Provides traceability of large quantities of parts manufactured in a geographically distributed environment • A wide range of data such as manufacturing procedures have to be stored and retrieved • General data but also very specific properties of the individual equipment European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

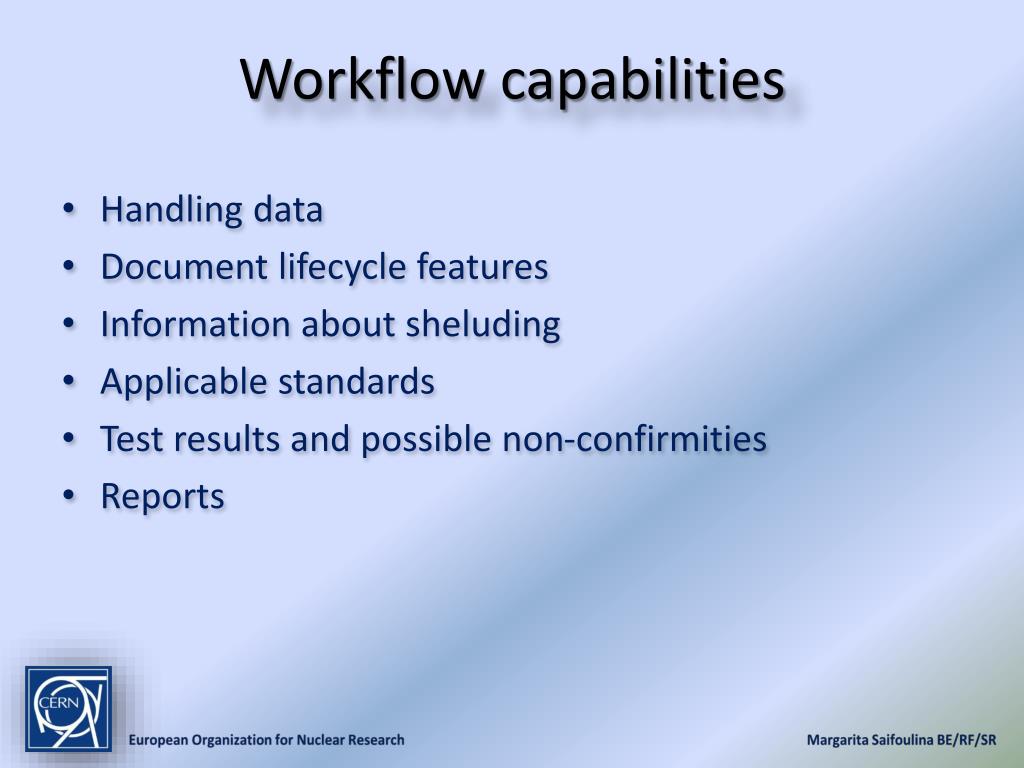

  14. Workflow capabilities • Handling data • Document lifecycle features • Information about sheluding • Applicable standards • Test results and possible non-confirmities • Reports European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

  15. Workflow steps for RF structures European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

  16. Workflow steps in AX Workflow steps European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

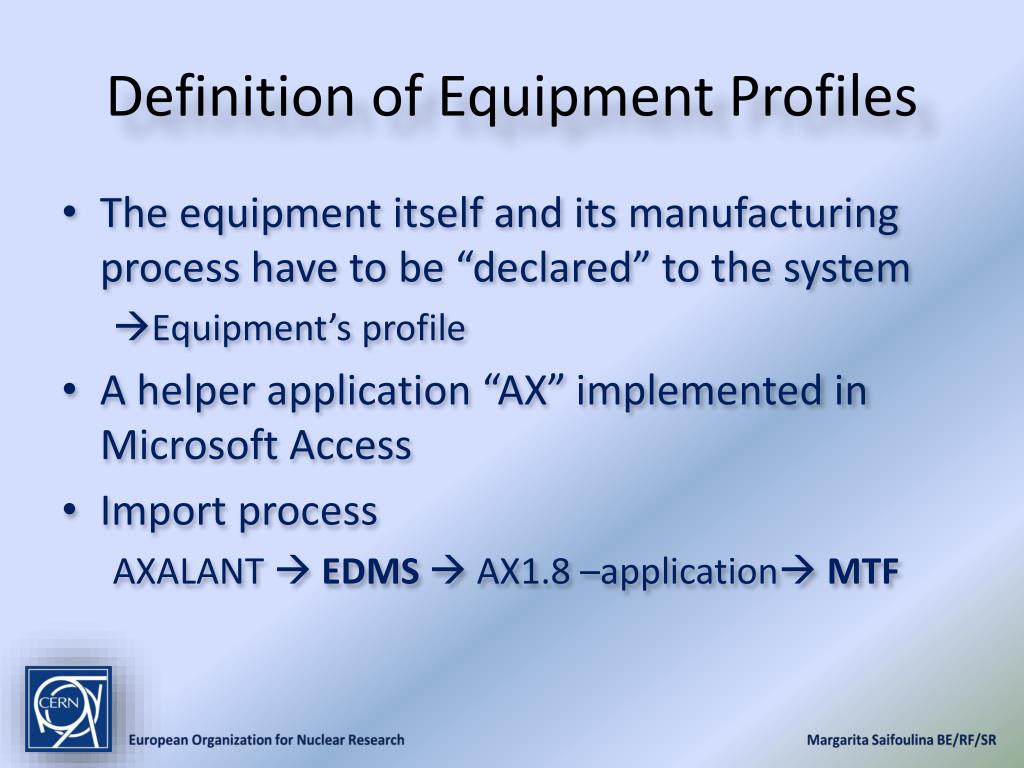

  17. Definition of Equipment Profiles • The equipment itself and its manufacturing process have to be “declared” to the system • Equipment’s profile • A helper application “AX”implemented in Microsoft Access • Import process AXALANT  EDMS  AX1.8 –application MTF European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

  18. EDMS Update Via the Import Mechanism • Based on Excel template • Import mechanism - allows rapid update of large quantities of data in a single operation European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

  19. An item in Axalant European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

  20. An equipment in AX1.8-application European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

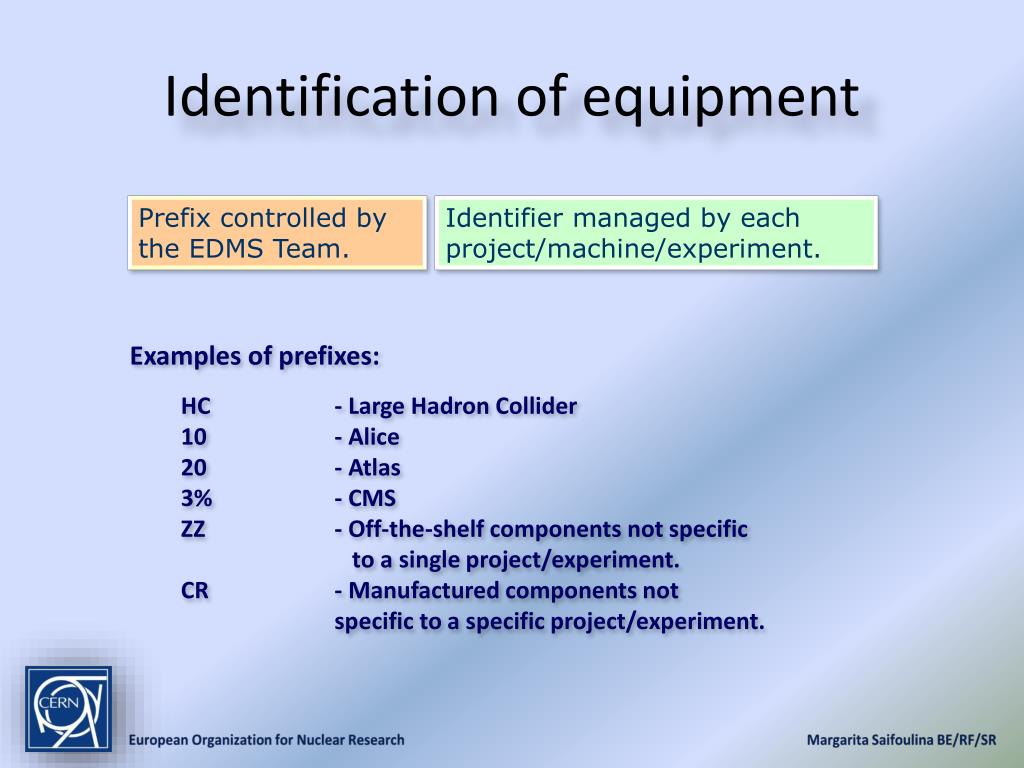

  21. Identification of equipment Prefix controlled by the EDMS Team. Identifier managed by each project/machine/experiment. Examples of prefixes:HC - Large Hadron Collider 10 - Alice 20 - Atlas 3% - CMS ZZ - Off-the-shelf components not specific to a single project/experiment. CR - Manufactured components not specific to a specific project/experiment. European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

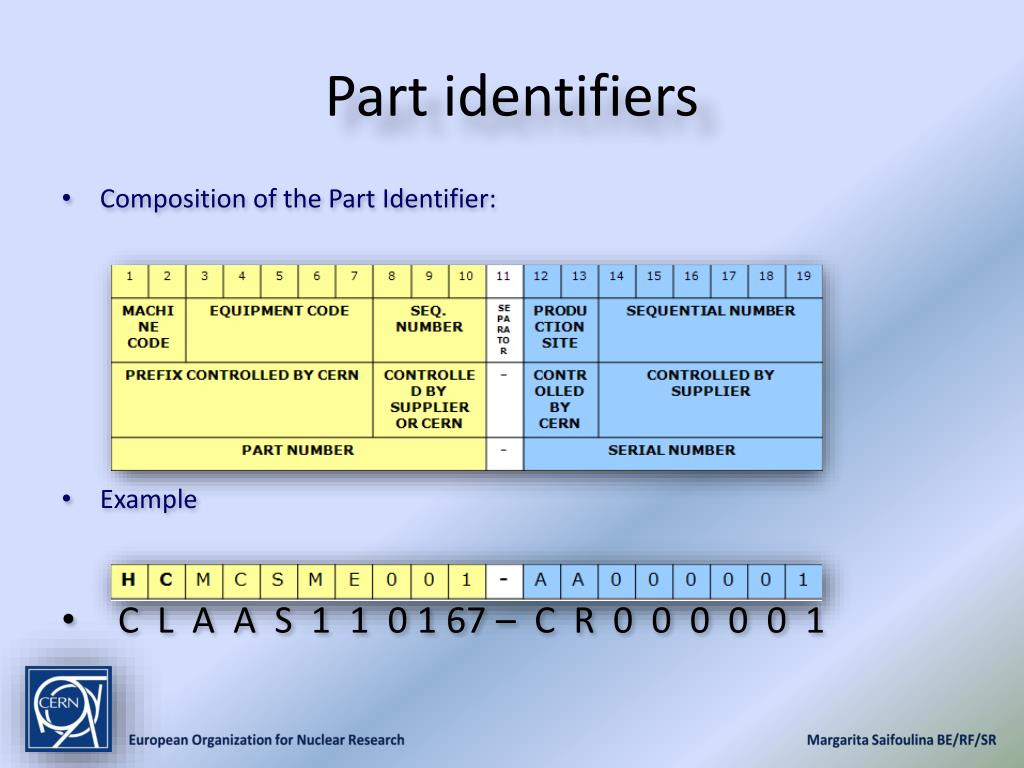

  22. Part identifiers • Composition of the Part Identifier: • Example • C L A A S 1 1 0 1 67 – C R 0 0 0 0 0 1 European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

  23. Component Assembly Subassembly European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

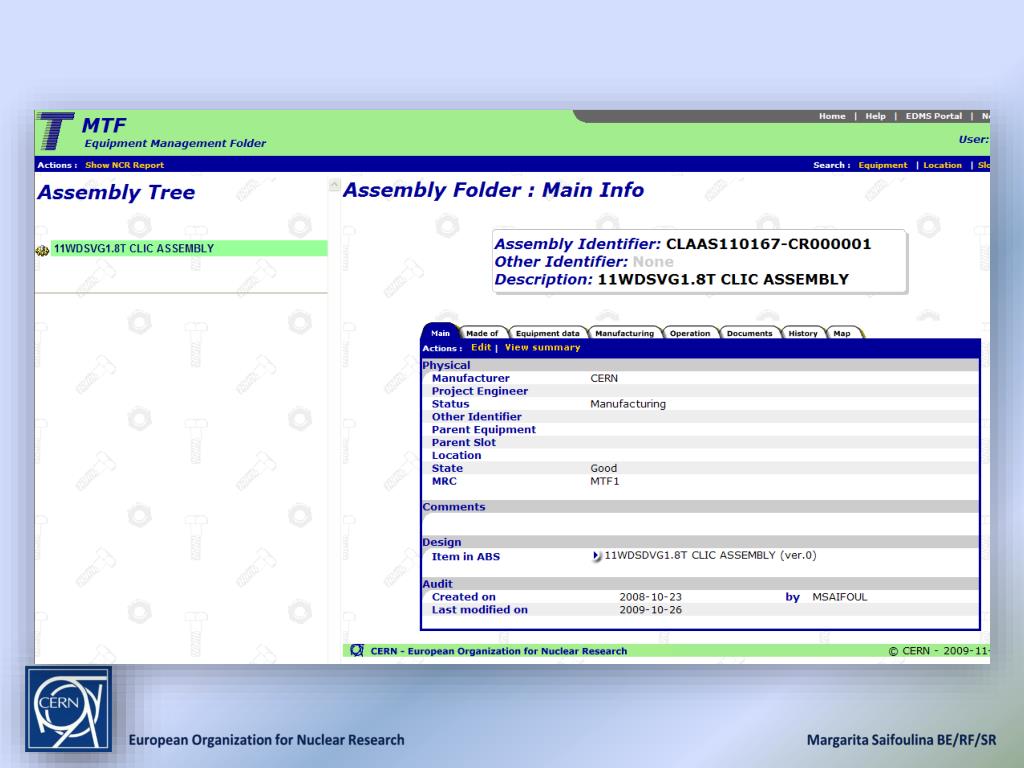

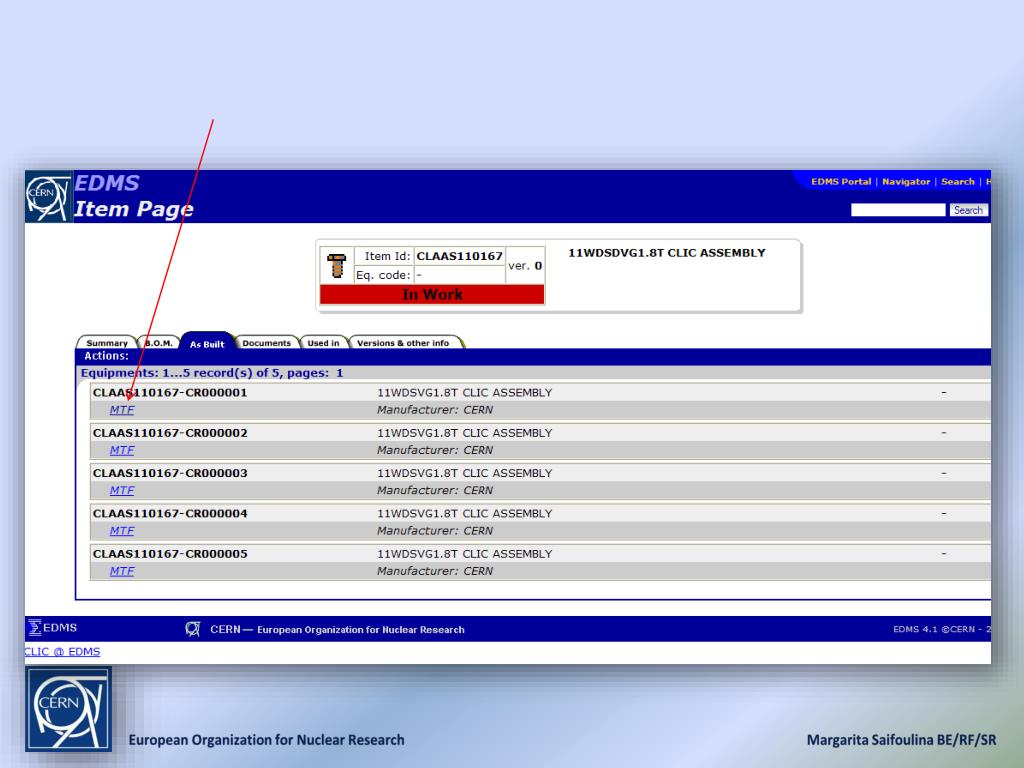

  24. European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

  25. European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

  26. European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

  27. European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

  28. European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

  29. Future prospects • Different BOM • Manual re-writing of large amount of data is a source of errors • Tree structure becomes complicated for complex equipments • Guideline on how to search information through EDMS/MTF • Data security • Change of data belonging to other users is possible in some cases European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

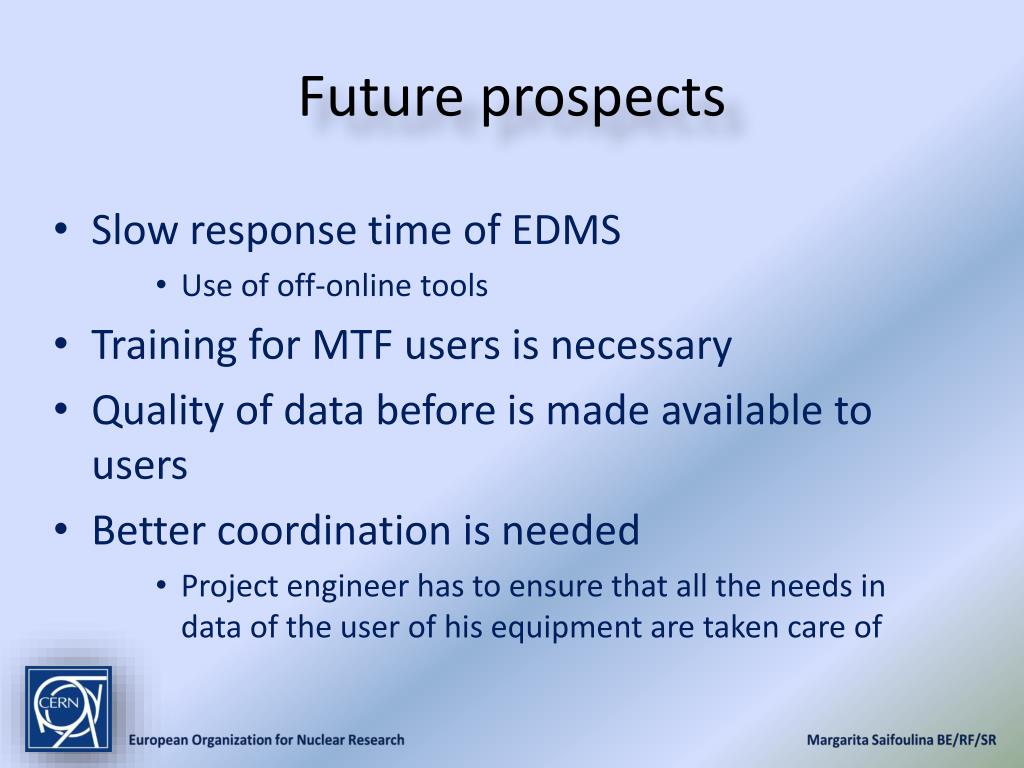

  30. Future prospects • Slow response time of EDMS • Use of off-online tools • Training for MTF users is necessary • Quality of data before is made available to users • Better coordination is needed • Project engineer has to ensure that all the needs in data of the user of his equipment are taken care of European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR

  31. THANK YOU! Questions? European Organization for Nuclear Research Margarita Saifoulina BE/RF/SR
