DOE Final Rule Transformer Efficiency

DESCRIPTION

DOE Final Rule Transformer Efficiency. Scope of Final Rule. Liquid-filled distribution transformers HV ratings through 35 kV LV ratings 600 Volts and below Single-phase capacities 10-833 kVA Three-phase capacities 15-2500 kVA Dry-type medium-voltage transformer

1 / 18

Télécharger la présentation

DOE Final Rule Transformer Efficiency

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. DOE Final RuleTransformer Efficiency

  2. Scope of Final Rule • Liquid-filled distribution transformers • HV ratings through 35 kV • LV ratings 600 Volts and below • Single-phase capacities 10-833 kVA • Three-phase capacities 15-2500 kVA • Dry-type medium-voltage transformer • Approximately same ratings as for liquid-filled

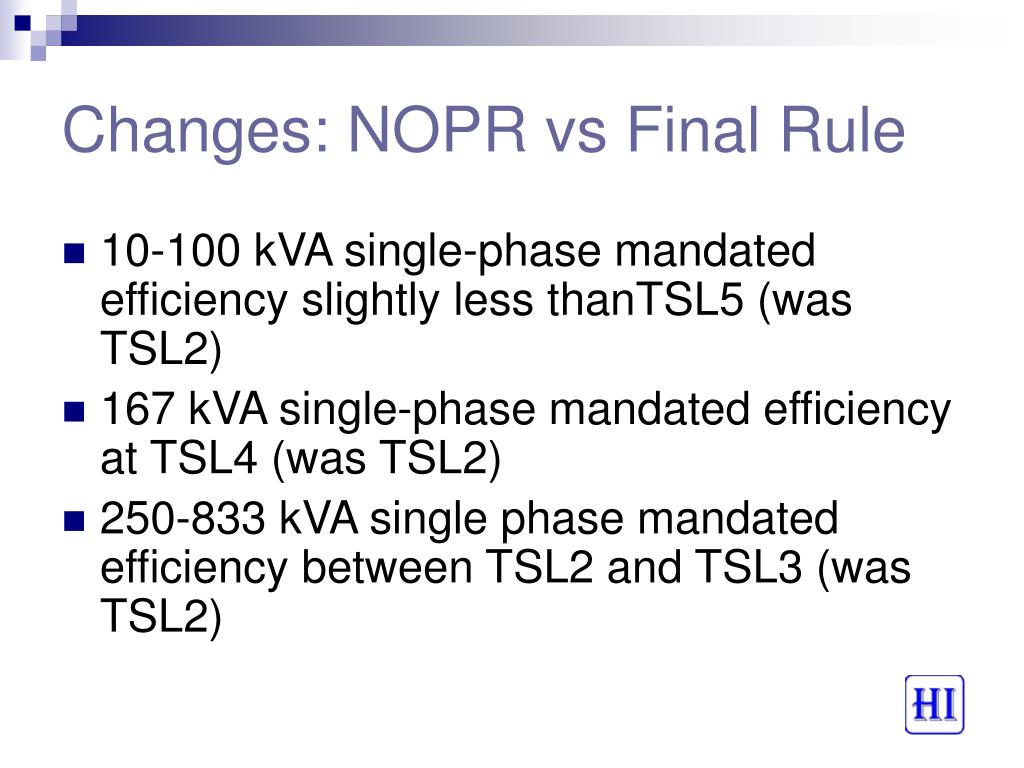

  3. Changes: NOPR vs Final Rule • 10-100 kVA single-phase mandated efficiency slightly less thanTSL5 (was TSL2) • 167 kVA single-phase mandated efficiency at TSL4 (was TSL2) • 250-833 kVA single phase mandated efficiency between TSL2 and TSL3 (was TSL2)

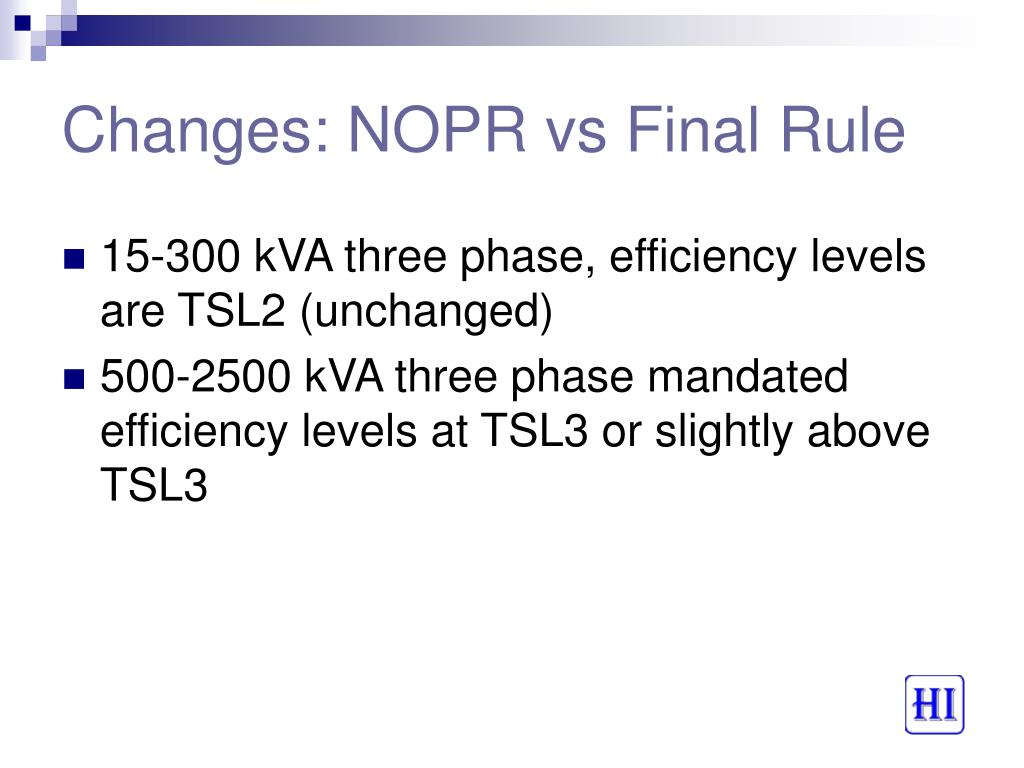

  4. Changes: NOPR vs Final Rule • 15-300 kVA three phase, efficiency levels are TSL2 (unchanged) • 500-2500 kVA three phase mandated efficiency levels at TSL3 or slightly above TSL3

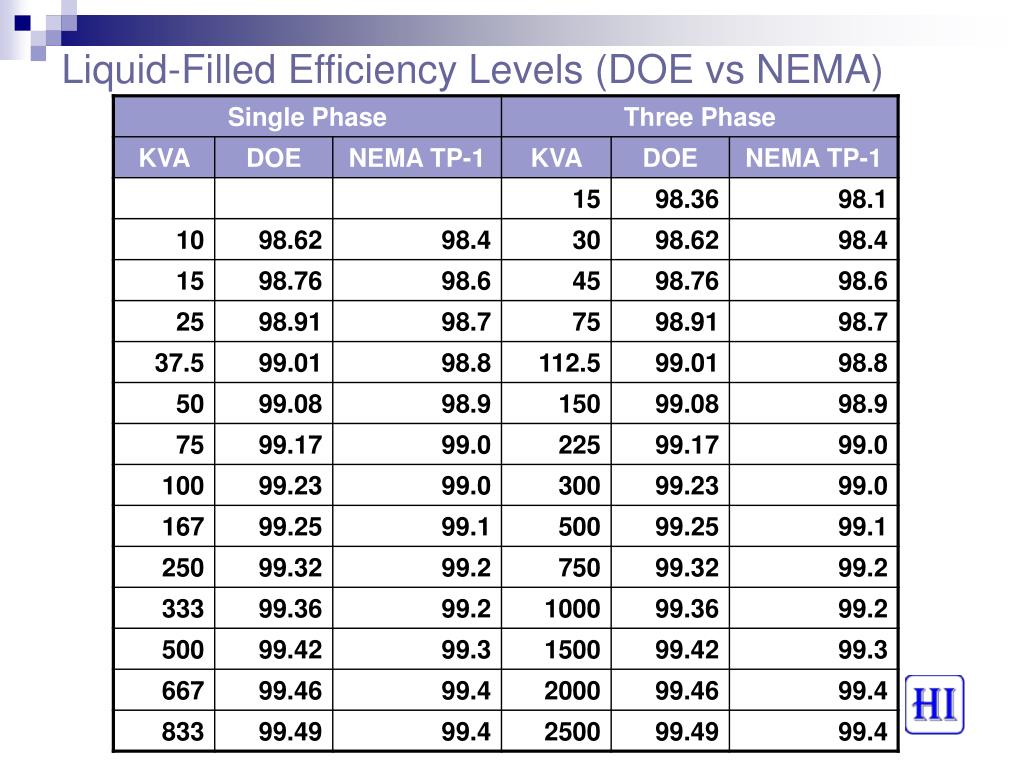

  5. Liquid-Filled Efficiency Levels (DOE vs NEMA)

  6. Liquid-Filled Efficiency Levels

  7. Major Concerns—Raw Materials Most distribution transformers sold today do not meet DOE mandate. Additional demand on scarce resources…will impact transformer cost and availability • Magnet wire – 55% increased consumption • Strip aluminum – 55% increased consumption • Transformer oil – 3% reduced consumption • Core steel – 25% increased consumption (and 20% decreased core steel vendor capacity)

  8. Cost/Efficiency Relationship Cost 100% Transformer Efficiency

  9. Major Concerns—Core Steel

  10. Core Grade Distribution, Non-DOE Designs M4 M3 M5 Production Volume M2 M6 Core Steel Grades

  11. Major Concerns—Core Steel • DOE mandate will… • force a shift to M2, M3 and M4 grades • will eliminate usage of M5 and M6 grades for liquid-filled designs

  12. Major Concerns—Core Steel • Core steel in global short supply • Domestic suppliers plan no significant capacity increases • Core steel suppliers unable to supply enough M2 and M3 steel • Globally, few core steel suppliers offer M2 and M3 grades • Dry-type transformer producers will consume M5 and M6 grades • Rare and exotic core materials may be required (amorphous metal, laser scribed, high-B, etc.)

  13. Transformer Cost • Transformer prices will increase an average 15-30% for aluminum primary designs (depending on product line) • Transformer prices will increase an average 25-40% for non optimum designs (depending on product line) • Increases for individual utilities will vary widely, based on present efficiency levels

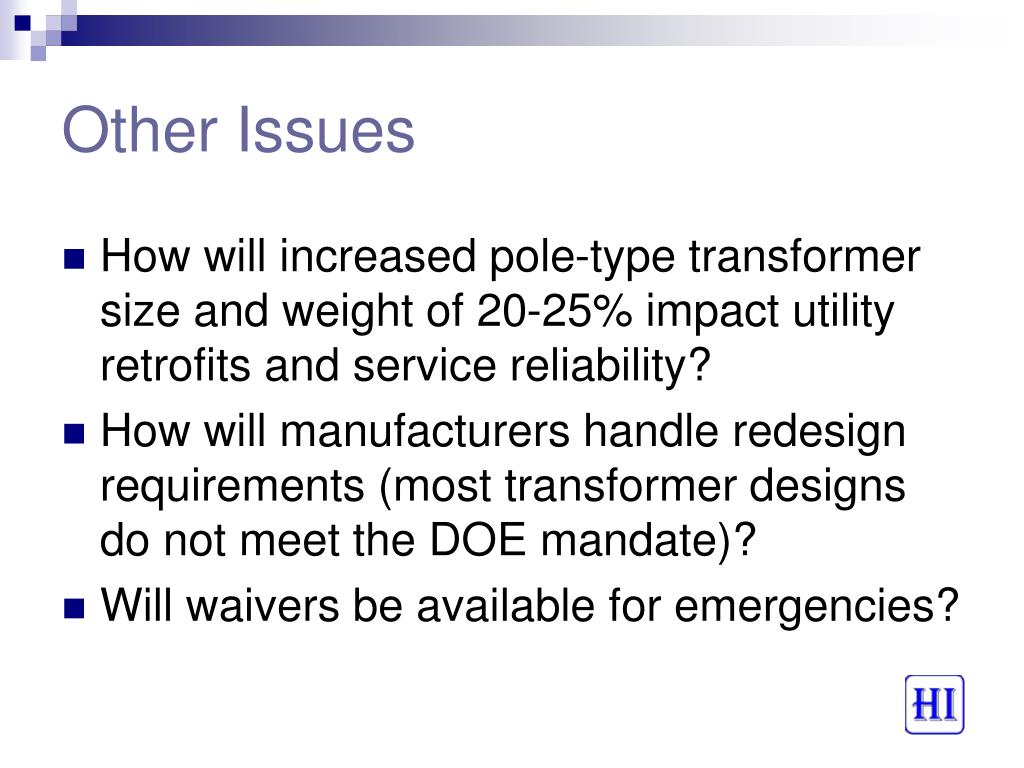

  14. Other Issues • How will increased pole-type transformer size and weight of 20-25% impact utility retrofits and service reliability? • How will manufacturers handle redesign requirements (most transformer designs do not meet the DOE mandate)? • Will waivers be available for emergencies?

  15. Howard Action Plan • Improve process capacities to compensate for increased size and weight • Increase core winding, annealing and lacing capacities • Increase coil winding capacities • Increase coil oven capacities • Increase core/coil oven capacities • Increase crane and conveyor capacities • Expand Laurel Facility size by 525,000 ft2 • Increase unit production capacities • Small pole-type from 3,000 to 6,000 units per week • Padmounted capacity by 15% • Modify factory test stations

  16. Buy the Lowest TOC That Meets DOE TOC DESIGN 1 Equal Efficiency Lower TOC DESIGN 2 Equal Efficiency Higher TOC TOC Eff Eff Cond Cond Core Core

  17. Implementation Schedule

  18. DOE Contact • Antonio Bousa: Project Manager for Distribution Transformer Energy Conservation Standards, (202) 586-4563 • DOE Web: http://www.eere.energy.gov/buildings/appliance_standards/commercial/distribution_transformers.html • Howard Web: www.howard.com
