R Engine Review. Date:16May07. Transmission durability test module. Visual inspection of module. Drive gear joint capability improvement. Drive gear joint capability improvement. Proposed design. Drive gear joint capability improvement.
E N D
R Engine Review Date:16May07
Transmission durability test module • Visual inspection of module
Drive gear joint capability improvement • Proposed design

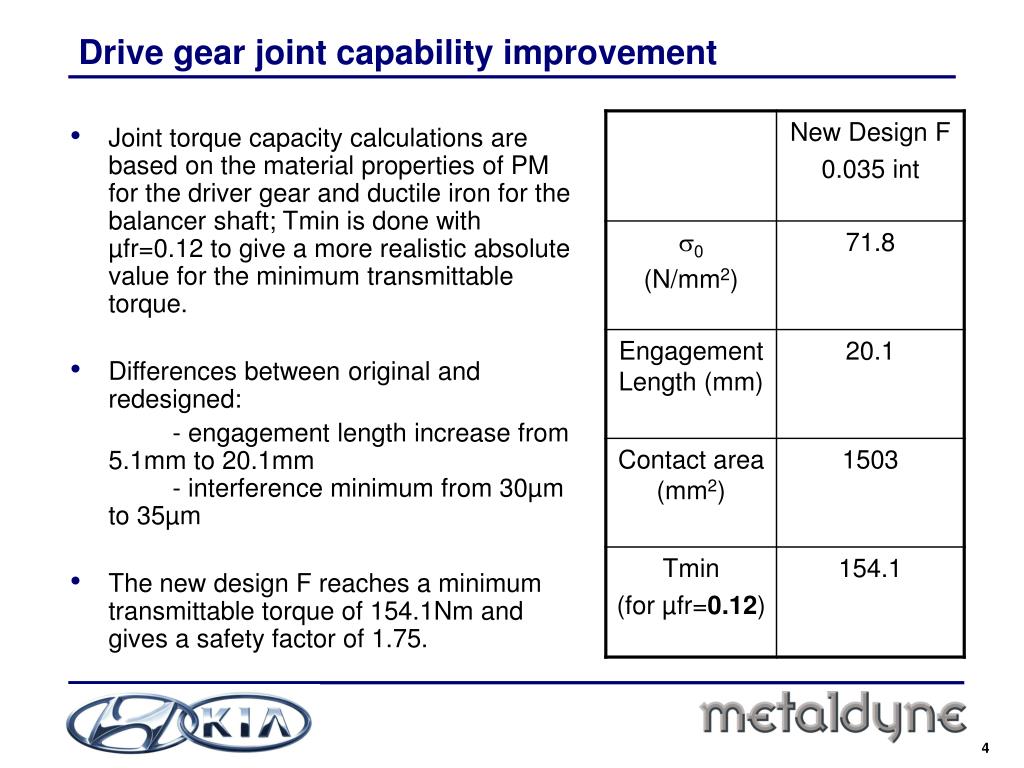

Drive gear joint capability improvement • Joint torque capacity calculations are based on the material properties of PM for the driver gear and ductile iron for the balancer shaft; Tmin is done with µfr=0.12 to give a more realistic absolute value for the minimum transmittable torque. • Differences between original and redesigned: - engagement length increase from 5.1mm to 20.1mm - interference minimum from 30µm to 35µm • The new design F reaches a minimum transmittable torque of 154.1Nm and gives a safety factor of 1.75.

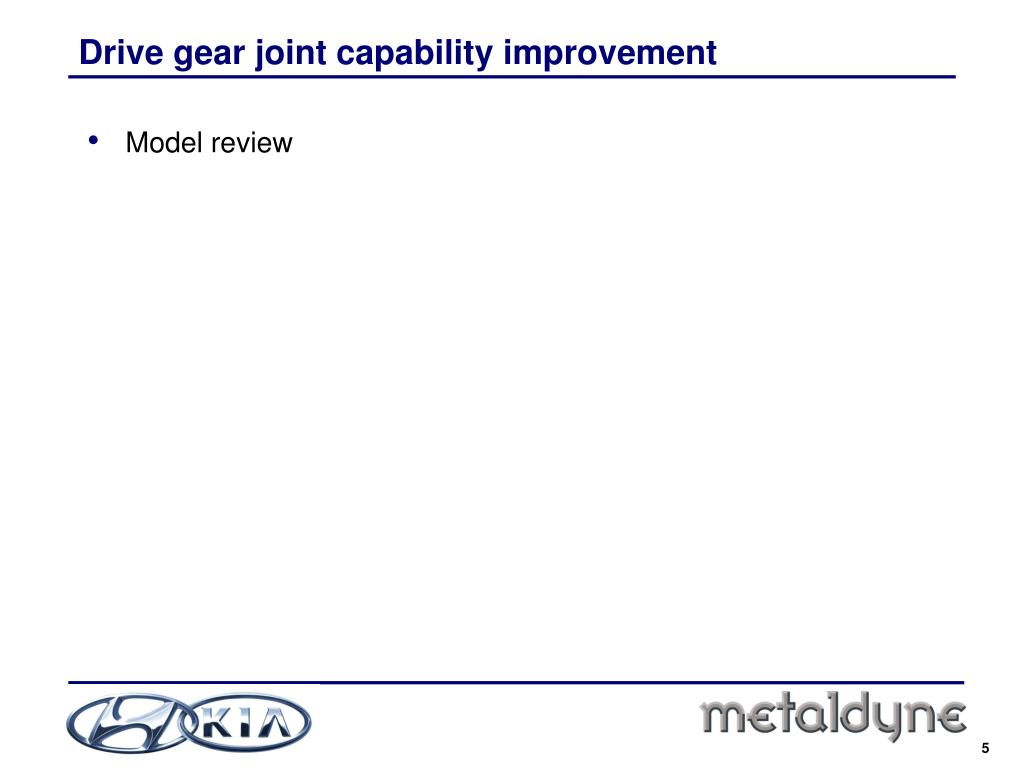

Drive gear joint capability improvement • Model review

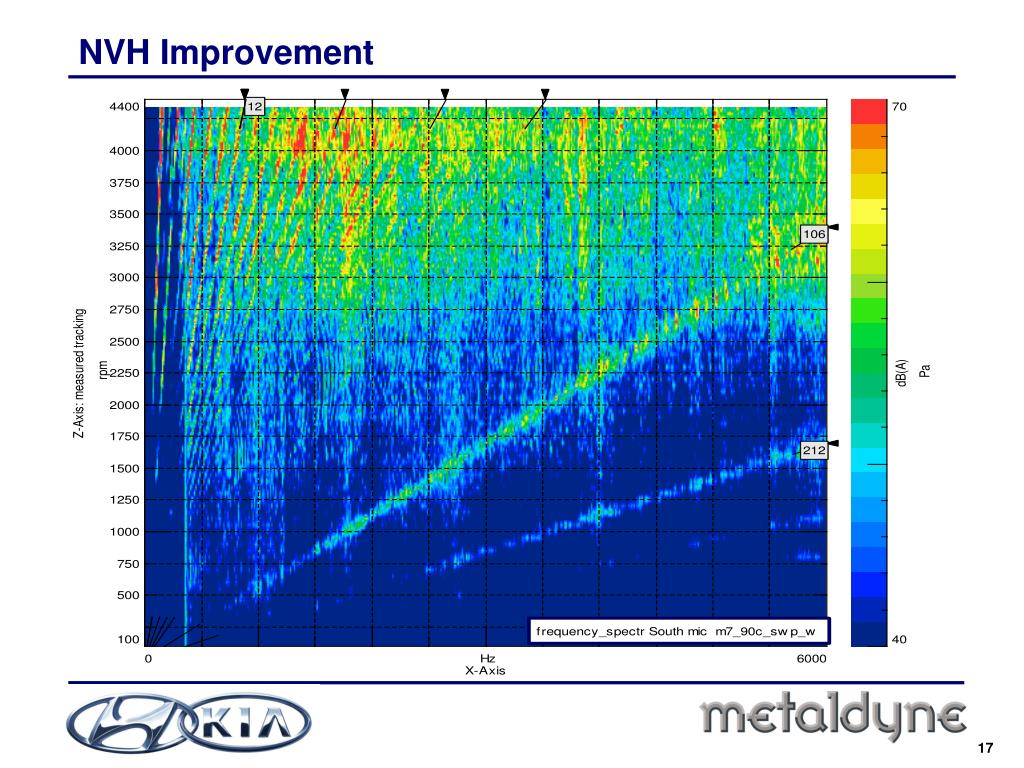

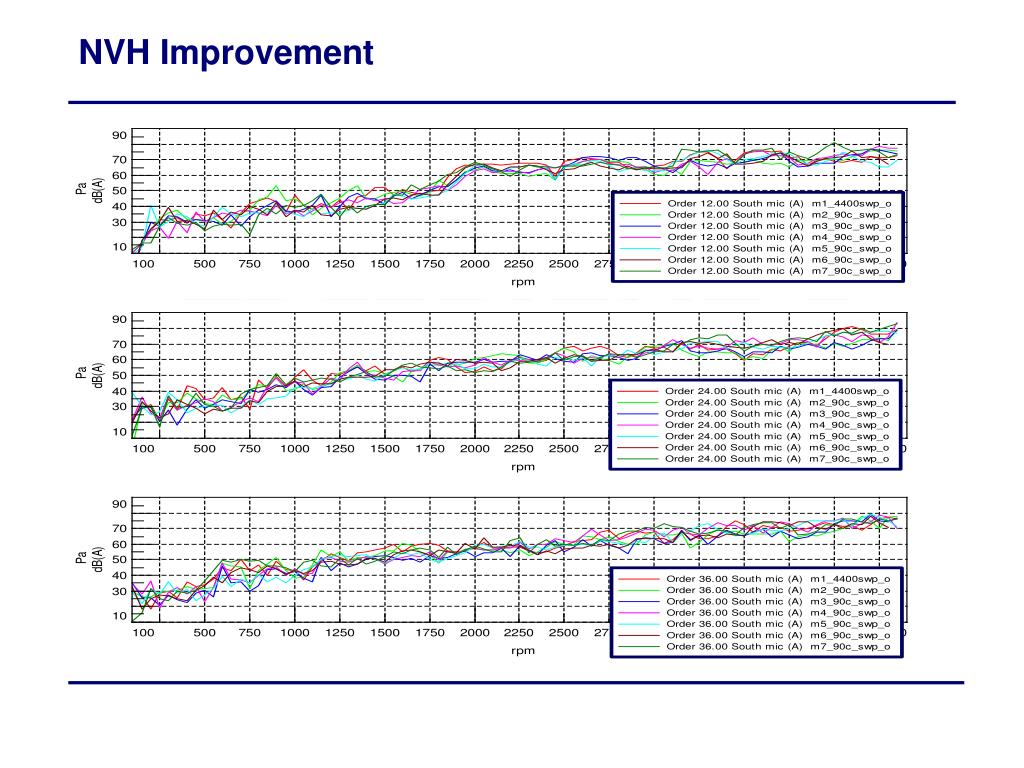

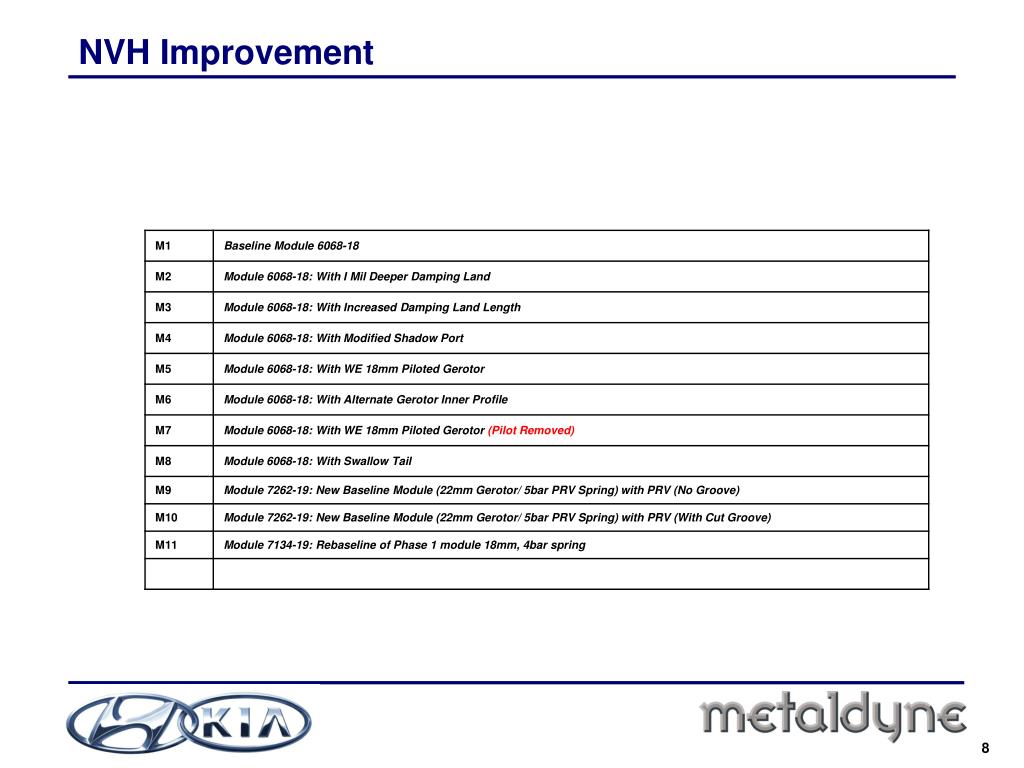

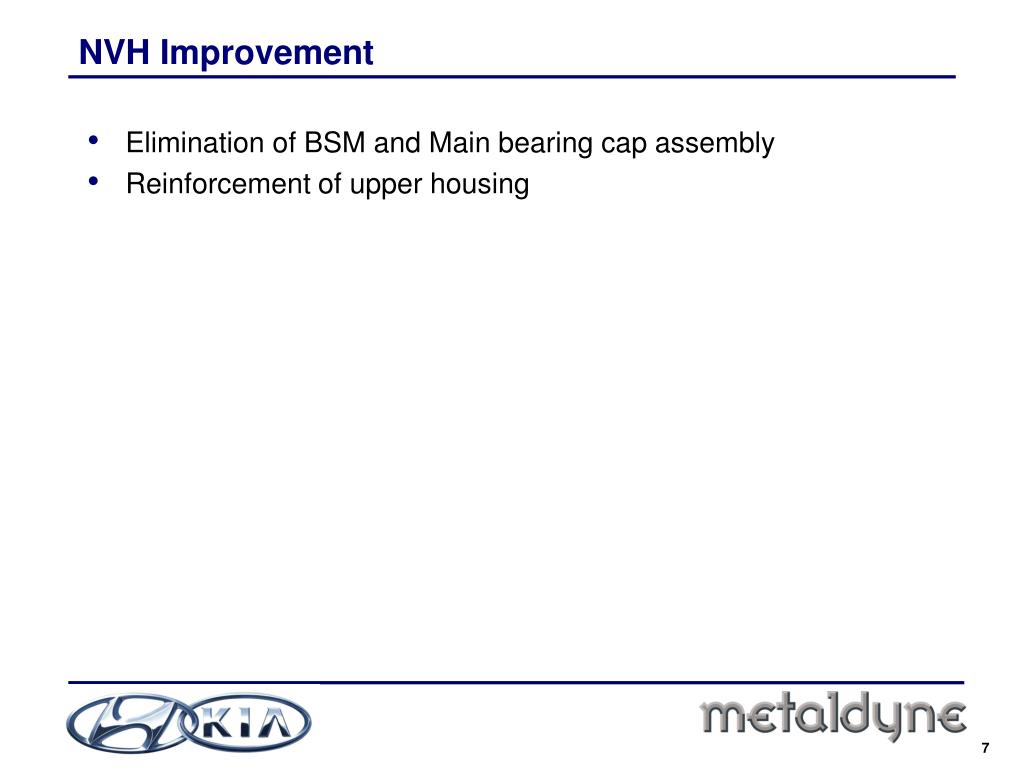

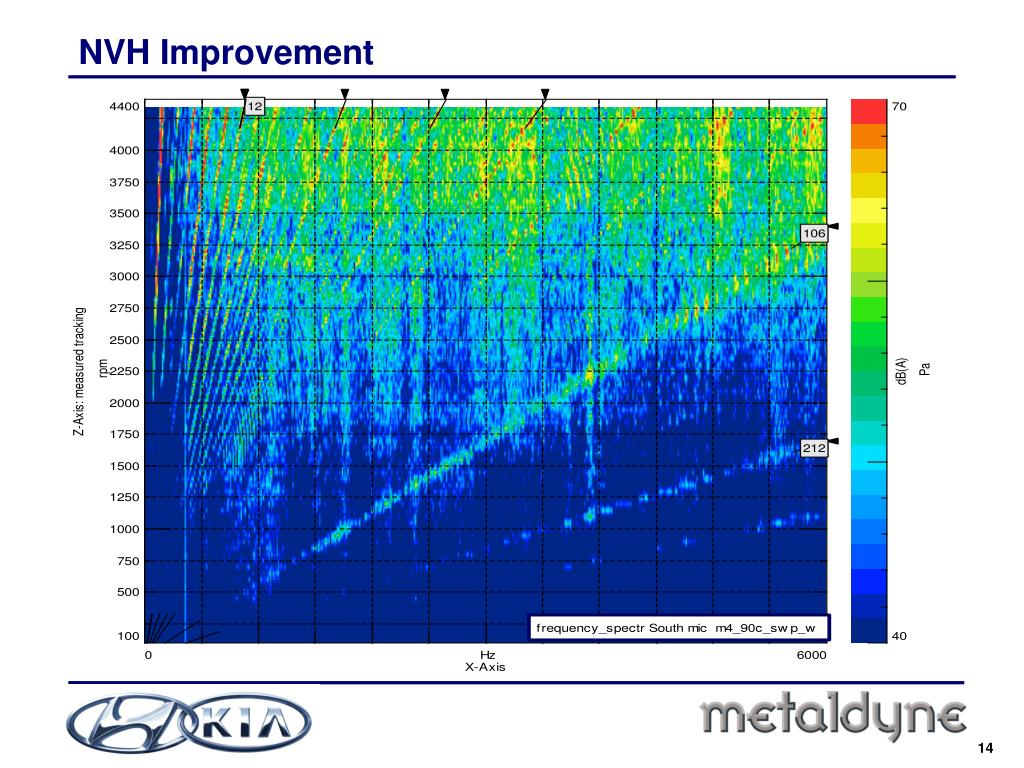

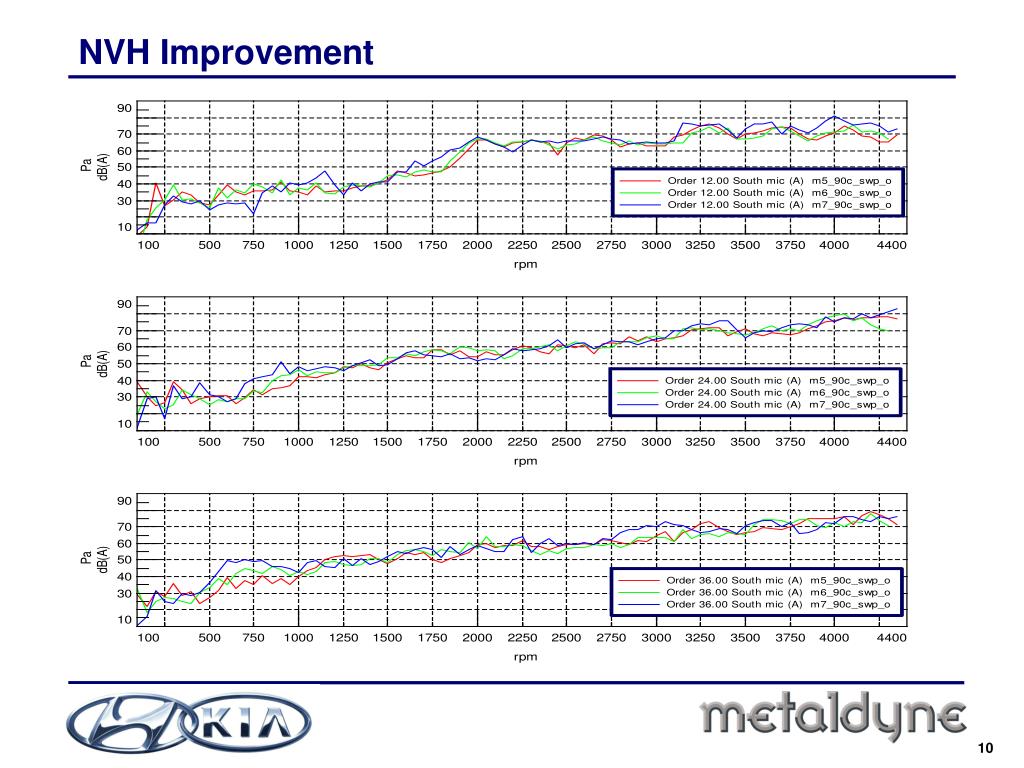

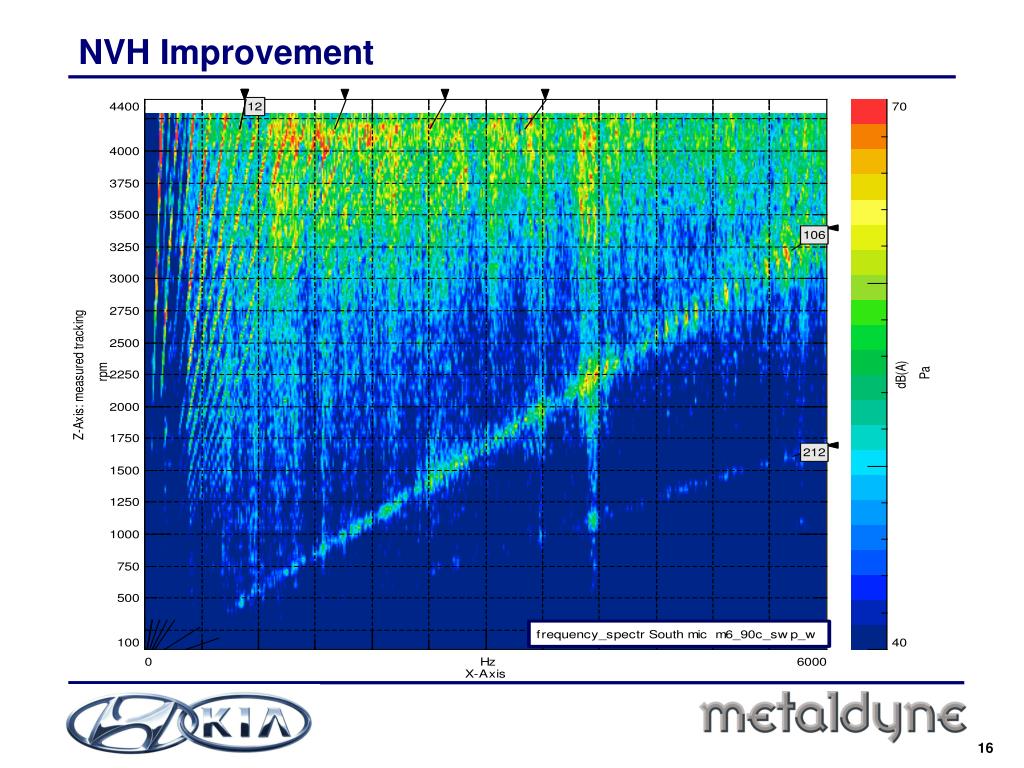

NVH Improvement • Elimination of BSM and Main bearing cap assembly • Reinforcement of upper housing
LFA Testing • Testing using the LMC bearing module to be completed upon receipt of module from HMC
PM Gear Application • PM Gear Current Status
PM Gear Application – Test results • Slip torque (using Loctite): 105Nm • Press off (using Loctite): 8.86kN • Tooth strength • The strength of the PM gear is higher than the maximum torque. The gear has a contact ratio of 3.4 therefore the actual torque capacity is significantly larger than the maximum torque

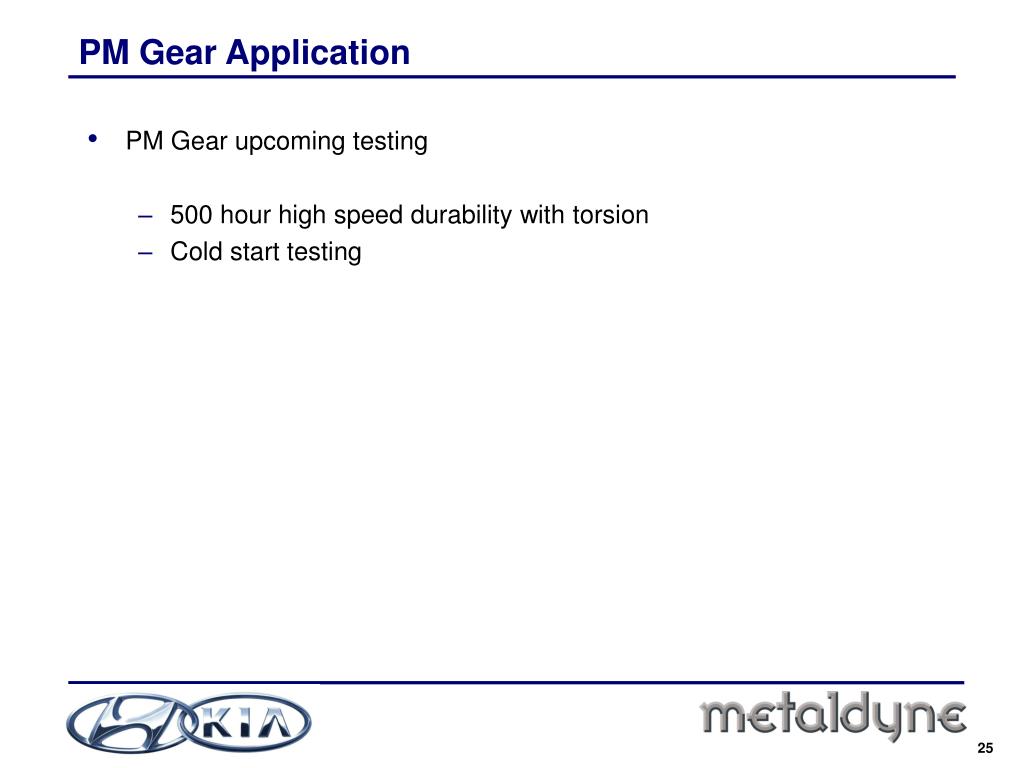

PM Gear Application • PM Gear upcoming testing • 500 hour high speed durability with torsion • Cold start testing

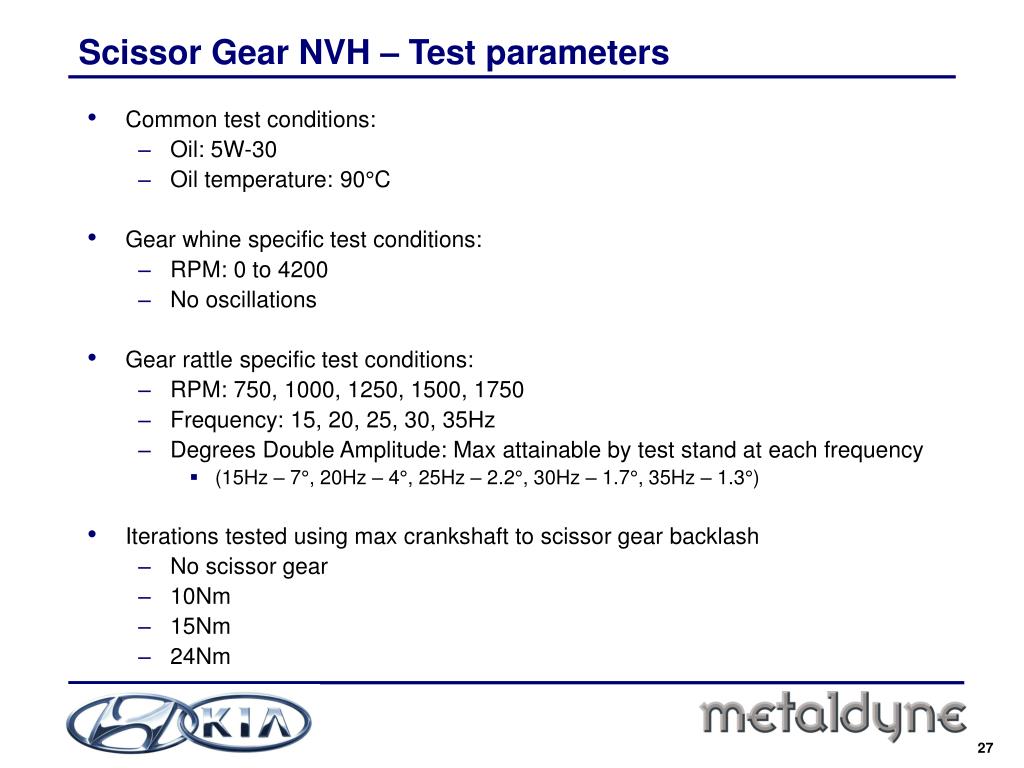

Scissor Gear NVH – Test parameters • Common test conditions: • Oil: 5W-30 • Oil temperature: 90°C • Gear whine specific test conditions: • RPM: 0 to 4200 • No oscillations • Gear rattle specific test conditions: • RPM: 750, 1000, 1250, 1500, 1750 • Frequency: 15, 20, 25, 30, 35Hz • Degrees Double Amplitude: Max attainable by test stand at each frequency • (15Hz – 7°, 20Hz – 4°, 25Hz – 2.2°, 30Hz – 1.7°, 35Hz – 1.3°) • Iterations tested using max crankshaft to scissor gear backlash • No scissor gear • 10Nm • 15Nm • 24Nm

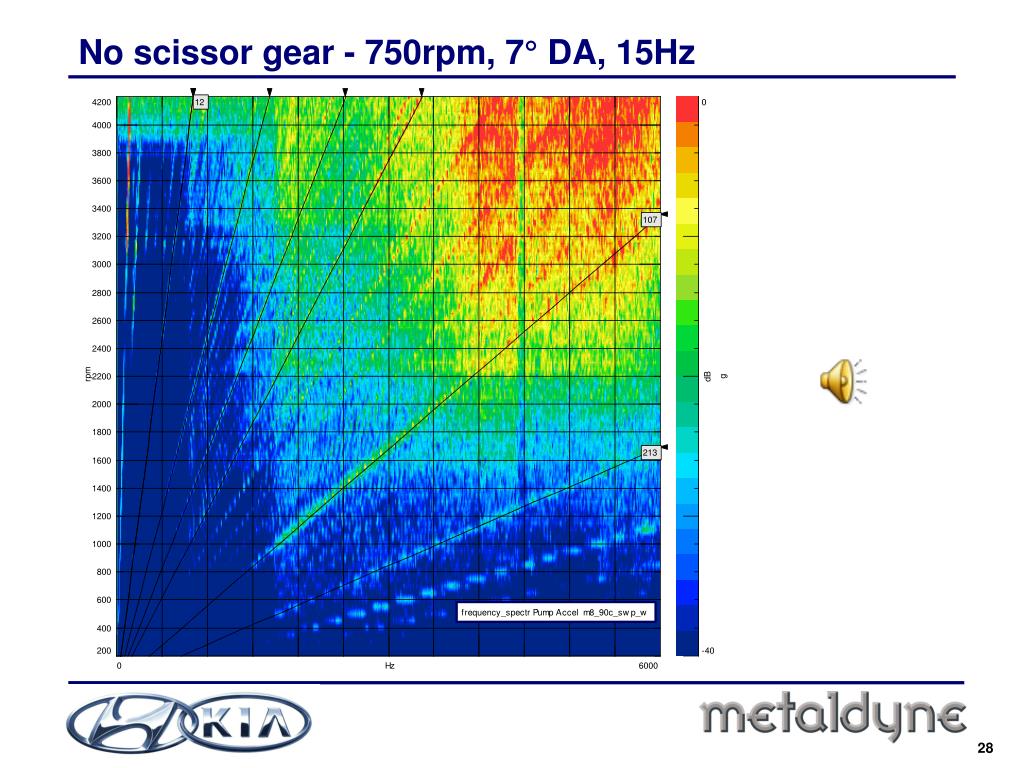

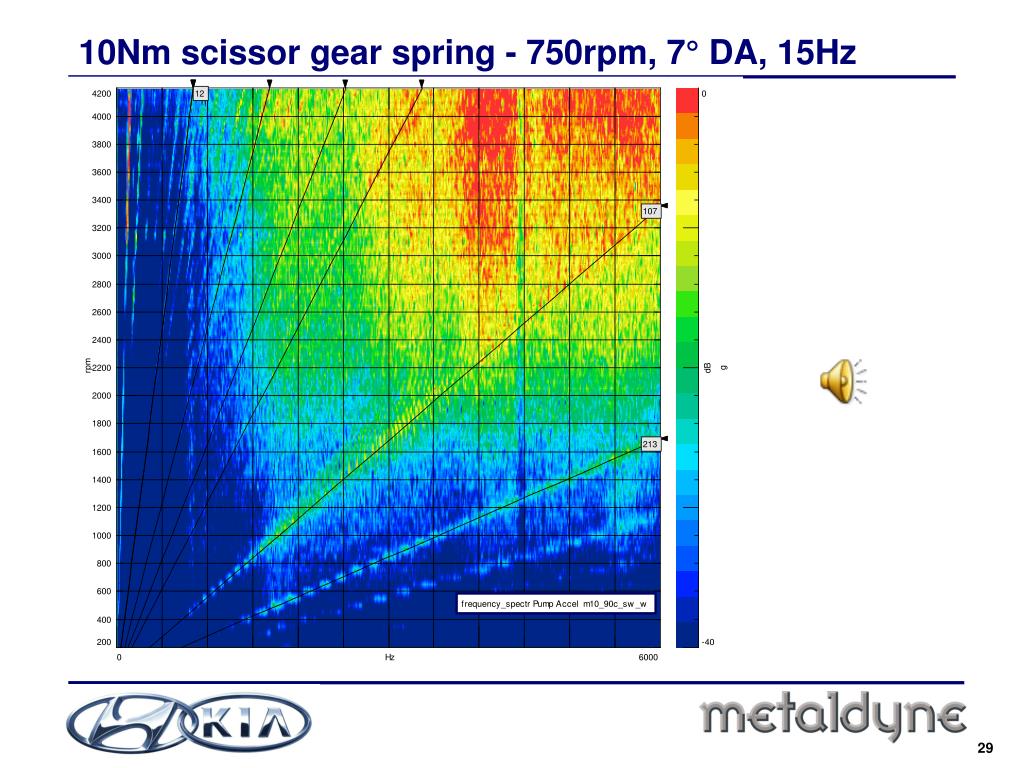

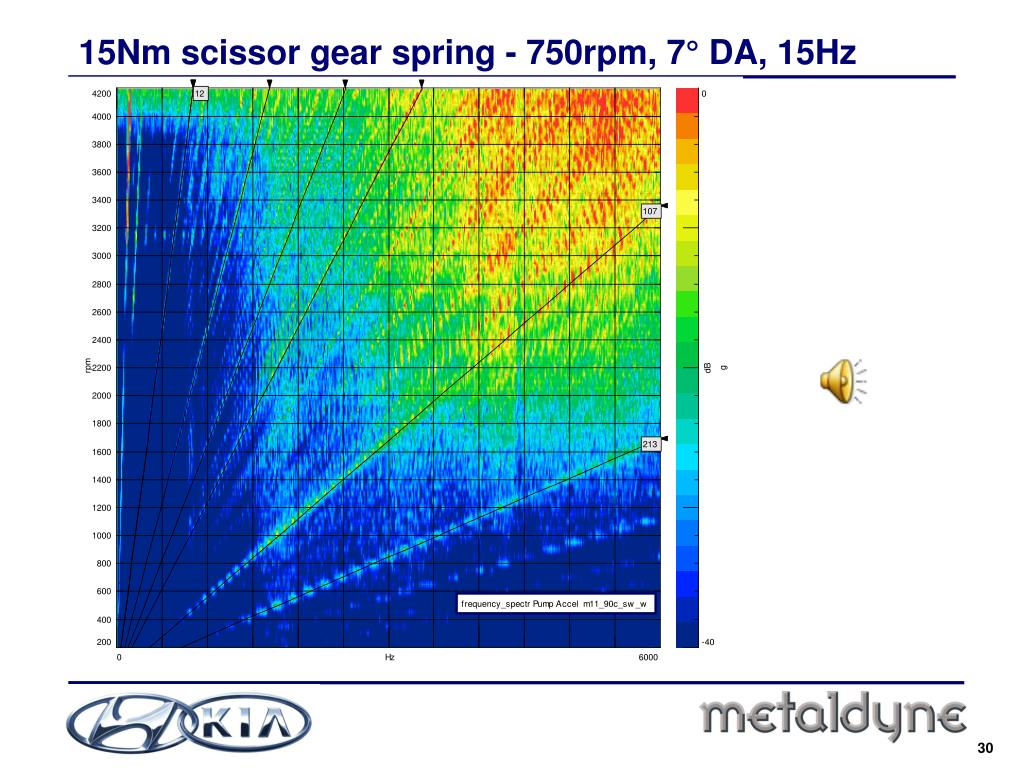

750rpm, 7° DA, 15Hz • M8 – No scissor gear spring • M10 – 10Nm spring • M11 – 15Nm spring • M9 – 24Nm spring

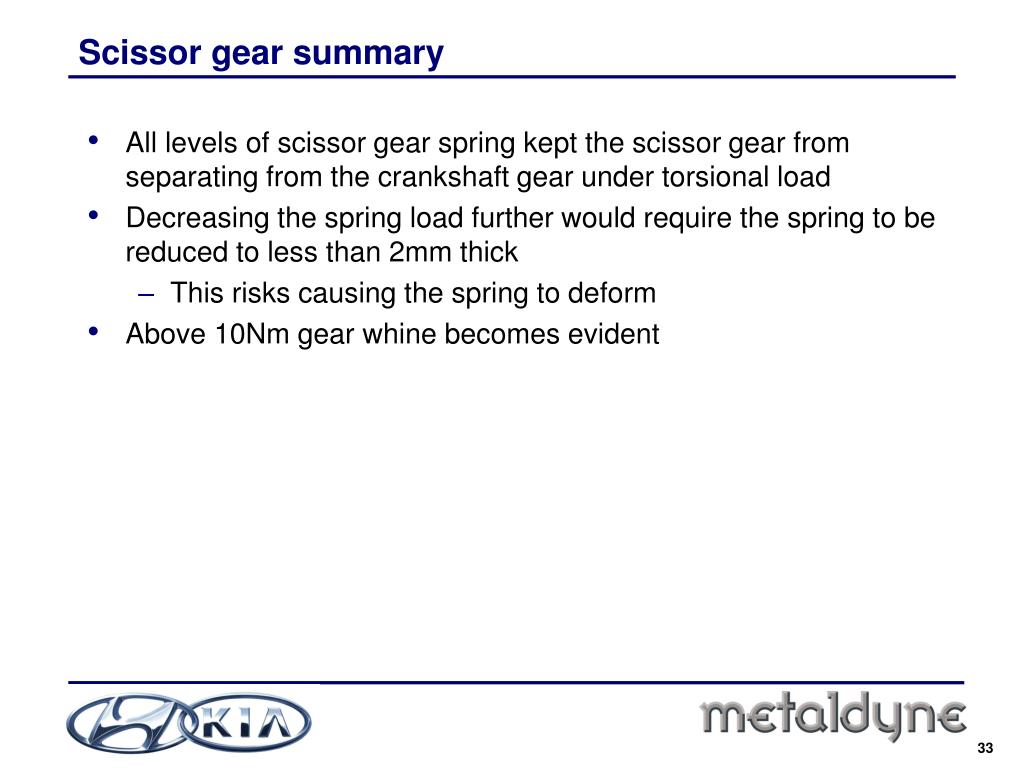

Scissor gear summary • All levels of scissor gear spring kept the scissor gear from separating from the crankshaft gear under torsional load • Decreasing the spring load further would require the spring to be reduced to less than 2mm thick • This risks causing the spring to deform • Above 10Nm gear whine becomes evident

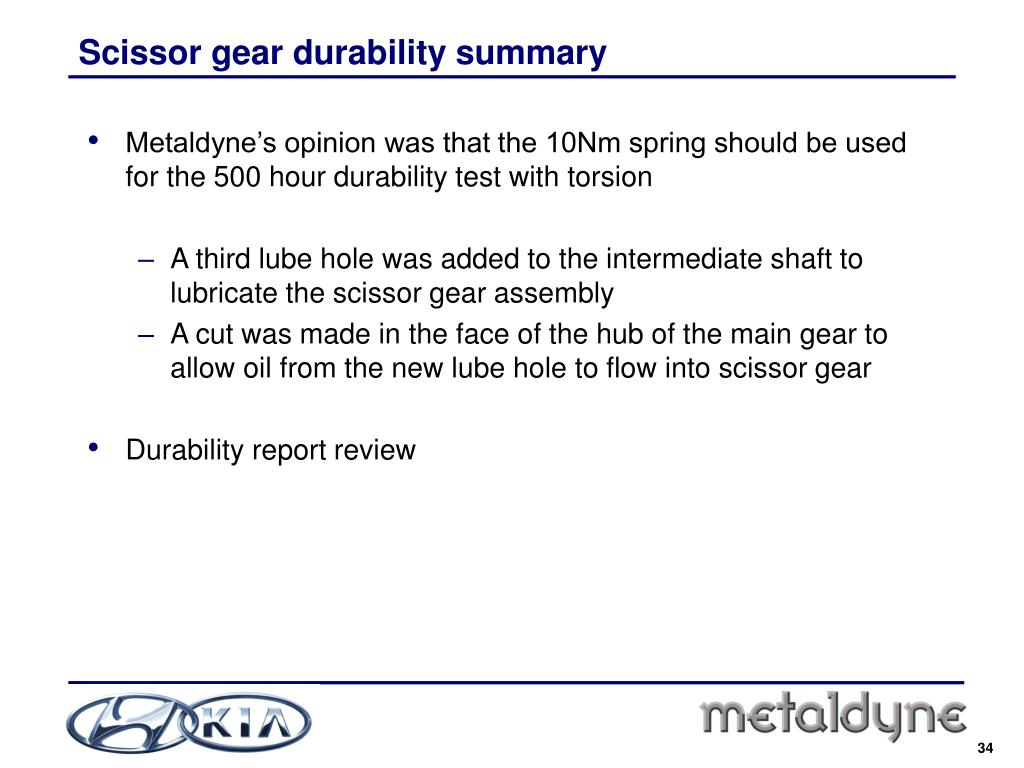

Scissor gear durability summary • Metaldyne’s opinion was that the 10Nm spring should be used for the 500 hour durability test with torsion • A third lube hole was added to the intermediate shaft to lubricate the scissor gear assembly • A cut was made in the face of the hub of the main gear to allow oil from the new lube hole to flow into scissor gear • Durability report review
Scissor gear current engine testing • HMC’s engine testing evaluation • HMC test plan

Plastic Inlet Tube • Plastic Inlet Tube Model Review • Timing • Testing • Metaldyne will be capable of testing the plastic inlet tube as proposed in HMC’s DVP&R document • Test oil specifications
