LCLS Commissioning Schedule and Startup Plan. Schedule Overview. Start XTOD commissioning. Time Now. 1st beam on Linac axis. Start Undulator commissioning. Start of Operations (X-Rays to Far Hall). UV Beam To cathode. Start LTU commissioning. CD-2a. CD-2b. FY2010. FY2003.
E N D
LCLS Commissioning Schedule and Startup Plan J. Welch, LCLS Commissioning Worskhop, SLAC

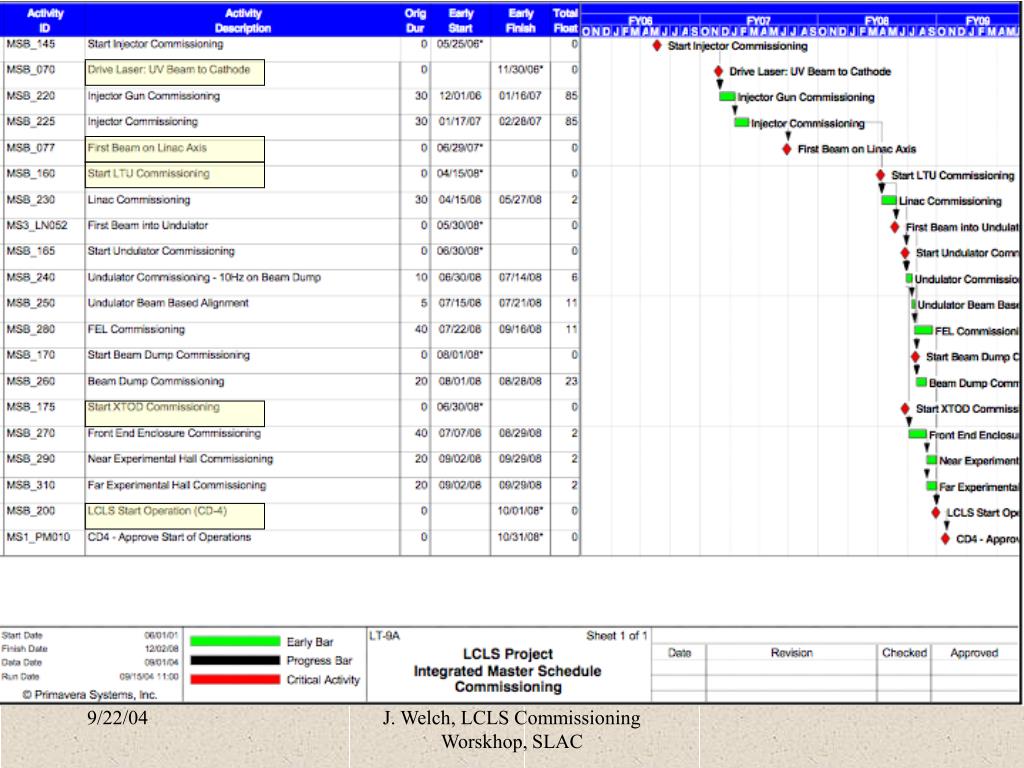

Schedule Overview Start XTOD commissioning Time Now 1st beam on Linac axis Start Undulator commissioning Start of Operations (X-Rays to Far Hall) UV Beam To cathode Start LTU commissioning CD-2a CD-2b FY2010 FY2003 2002 2003 FY2004 2004 FY2005 2005 FY2006 2006 FY2007 FY2008 FY2009 Project Engineering Design Long-Lead Procurement CD-3a CD-3b { CLOC CD-4 Beneficial Occupancies BTH, FH UH NH DUMP J. Welch, LCLS Commissioning Worskhop, SLAC
12/06 4/08 7/07 7/08 6 MeV 150 MeV 250 MeV 4.54 GeV 14.35 GeV Single beam Dumper Linac-X rf gun Linac-0 new Linac-1 Linac-2 Linac-3 X Ray Diag. Far Hall 21-1b 21-1d X 21-3b 24-6d 25-1a 30-8c Undulator DL-2 BC-1 BC-2 DL-1 BSY Tune up Dump Dump SLAC linac tunnel LTU J. Welch, LCLS Commissioning Worskhop, SLAC

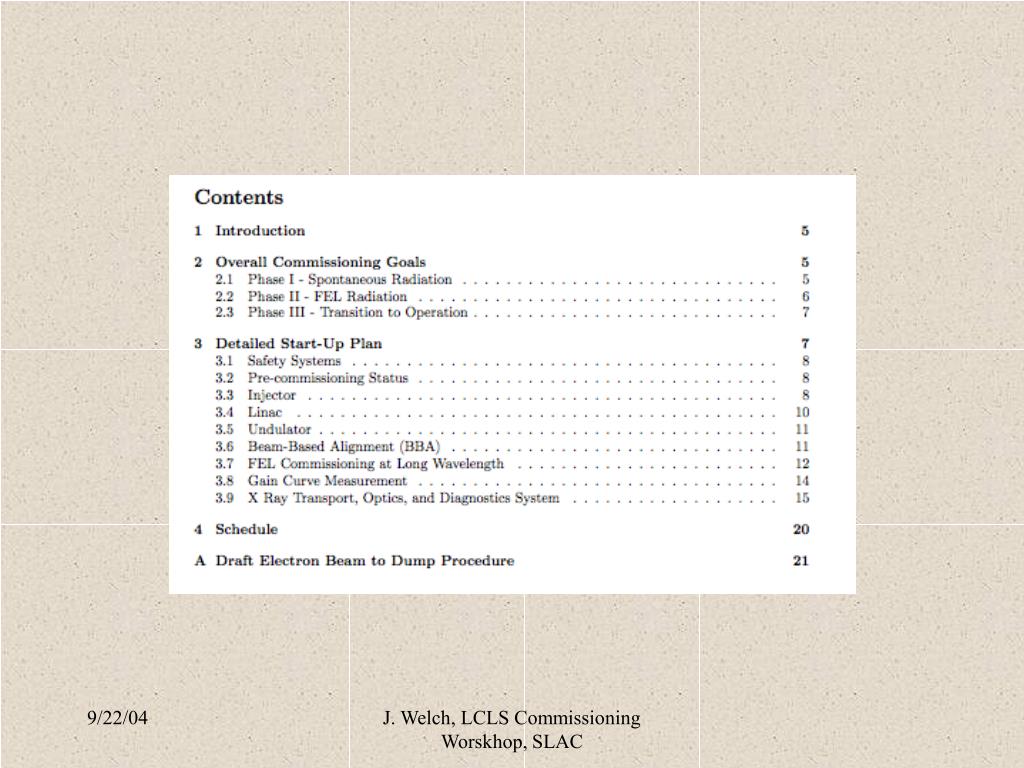

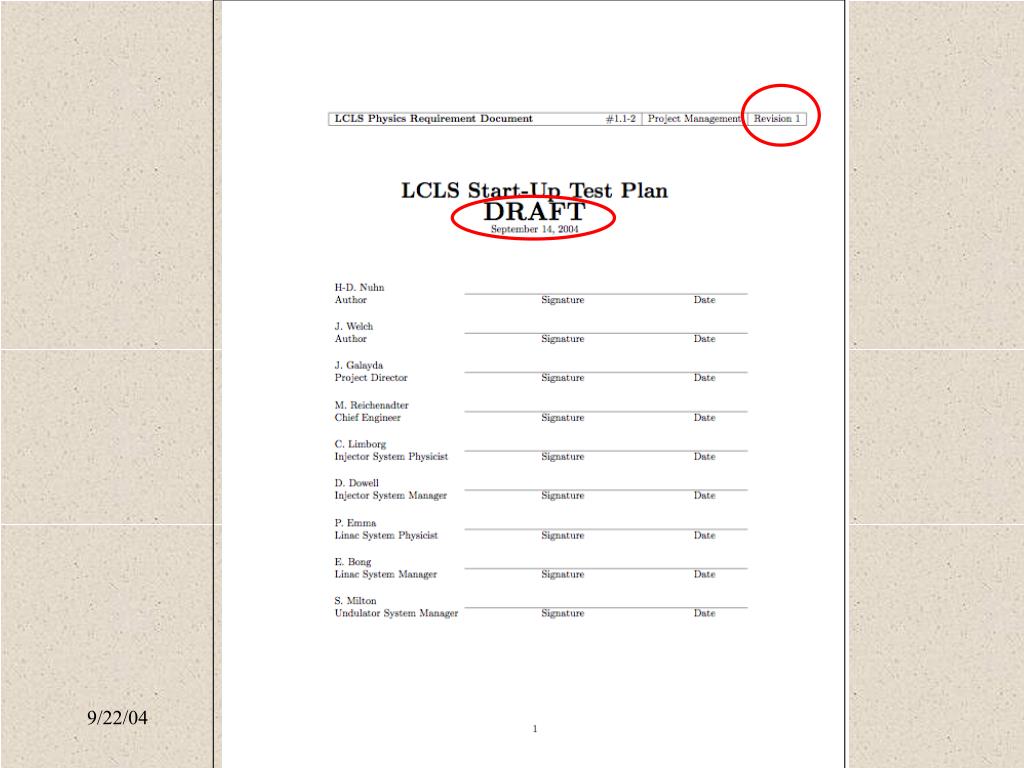

Startup Test PlanPRD 1.1-002 • Spells out our plan for turning on the LCLS systems. Currently working on rev-1. • Evolved from "Commissioning Document" discussed at previous workshop. • The editors continue to welcome your contributions! J. Welch, LCLS Commissioning Worskhop, SLAC

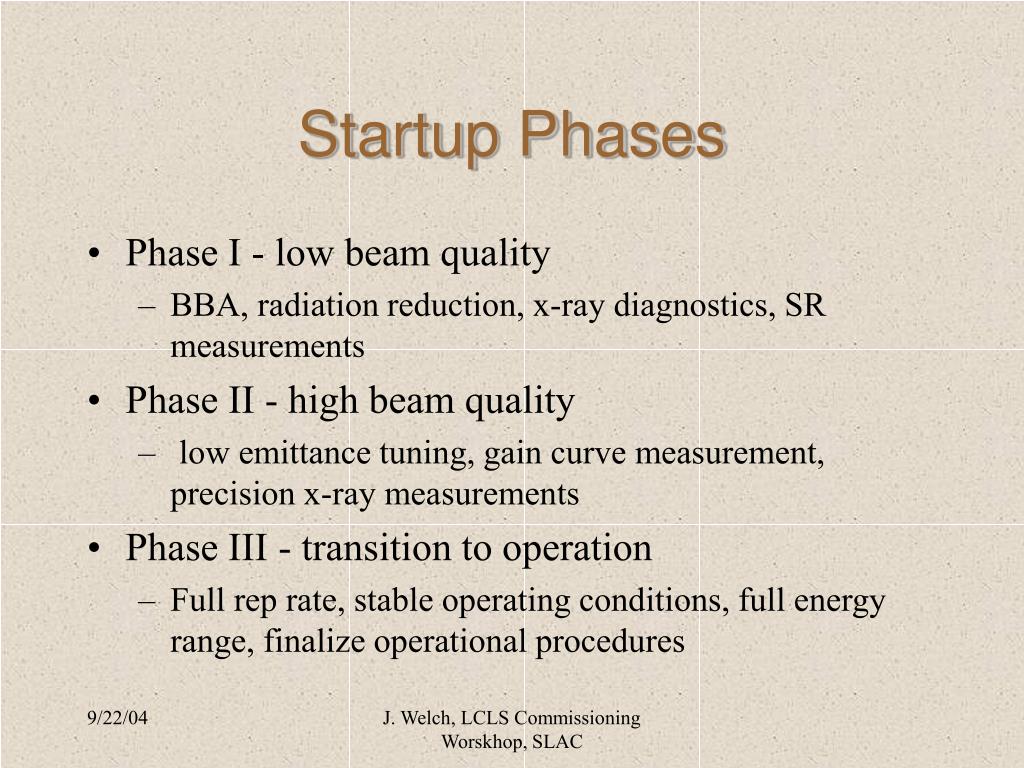

Startup Phases • Phase I - low beam quality • BBA, radiation reduction, x-ray diagnostics, SR measurements • Phase II - high beam quality • low emittance tuning, gain curve measurement, precision x-ray measurements • Phase III - transition to operation • Full rep rate, stable operating conditions, full energy range, finalize operational procedures J. Welch, LCLS Commissioning Worskhop, SLAC
End of Startup • Startup Plan goes well beyond "Start of Operations" which is met when X Rays are detected at the Far Hall • At the end of Phase III we leave the machine with operators who are then able to provide users with required beams on a daily basis. J. Welch, LCLS Commissioning Worskhop, SLAC

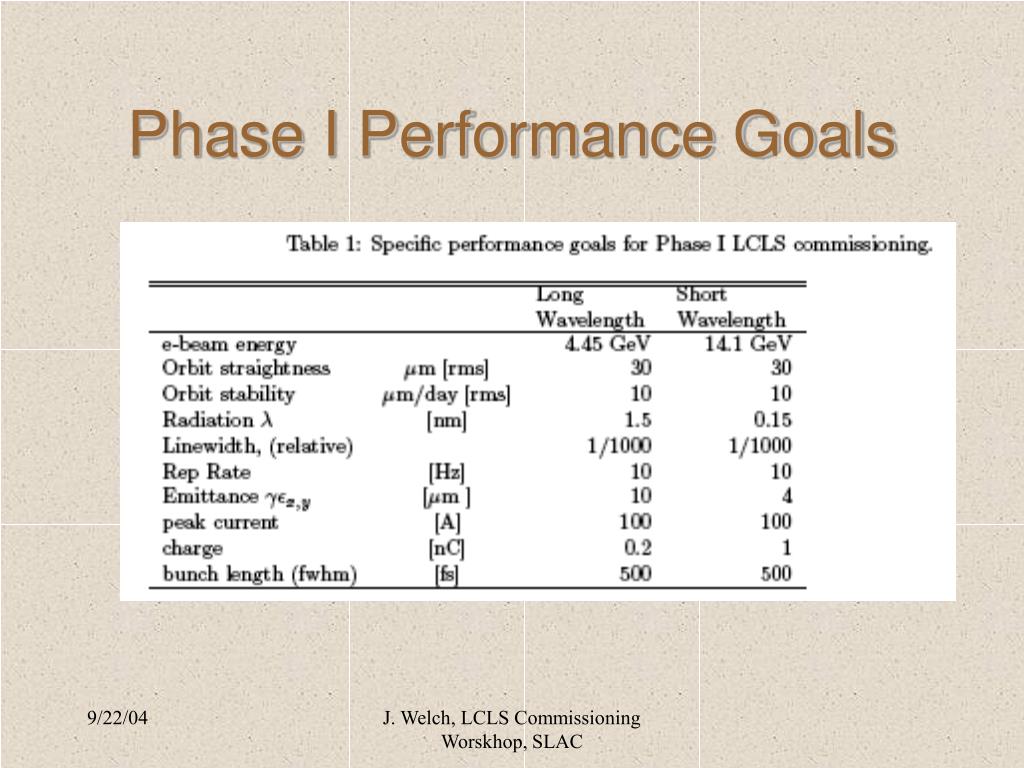

Phase I Performance Goals J. Welch, LCLS Commissioning Worskhop, SLAC

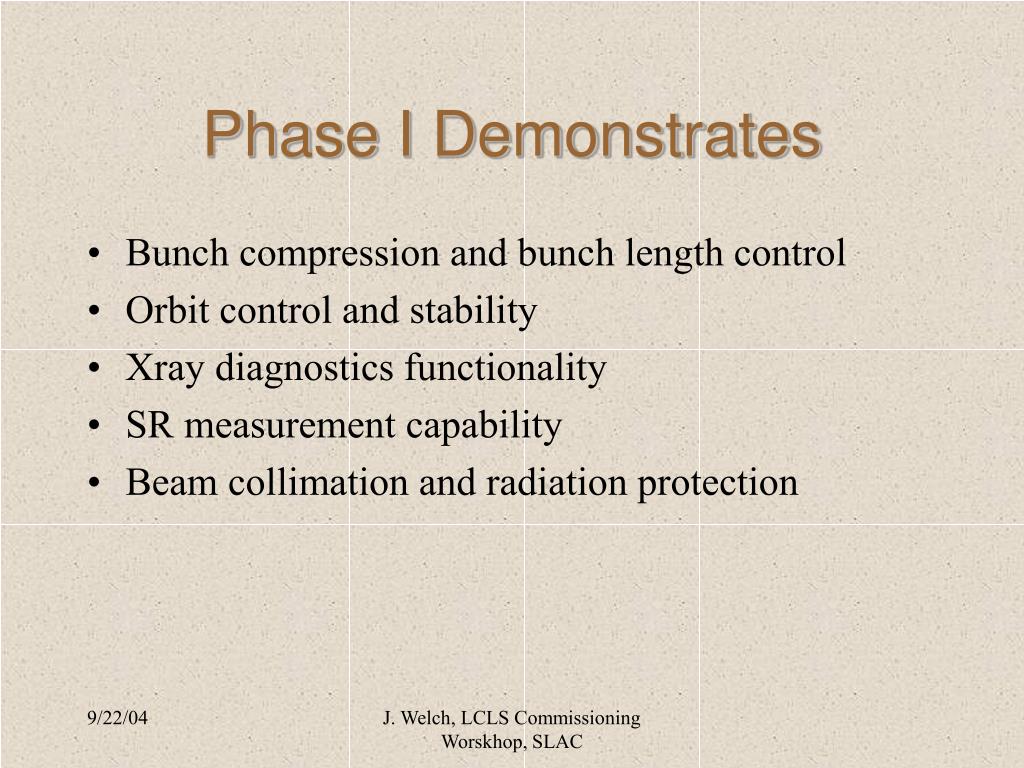

Phase I Demonstrates • Bunch compression and bunch length control • Orbit control and stability • Xray diagnostics functionality • SR measurement capability • Beam collimation and radiation protection J. Welch, LCLS Commissioning Worskhop, SLAC
Phase II Performance Goals J. Welch, LCLS Commissioning Worskhop, SLAC
Phase II Demonstrates • SASE FEL process is working • Requires • FEL quality orbit straightness and stability • Good linewidth • Good emittance • High bunch current • Gain length measurements • Areas of physics concern: CSR, instabilities, wakefield effects, new physics effects,… J. Welch, LCLS Commissioning Worskhop, SLAC

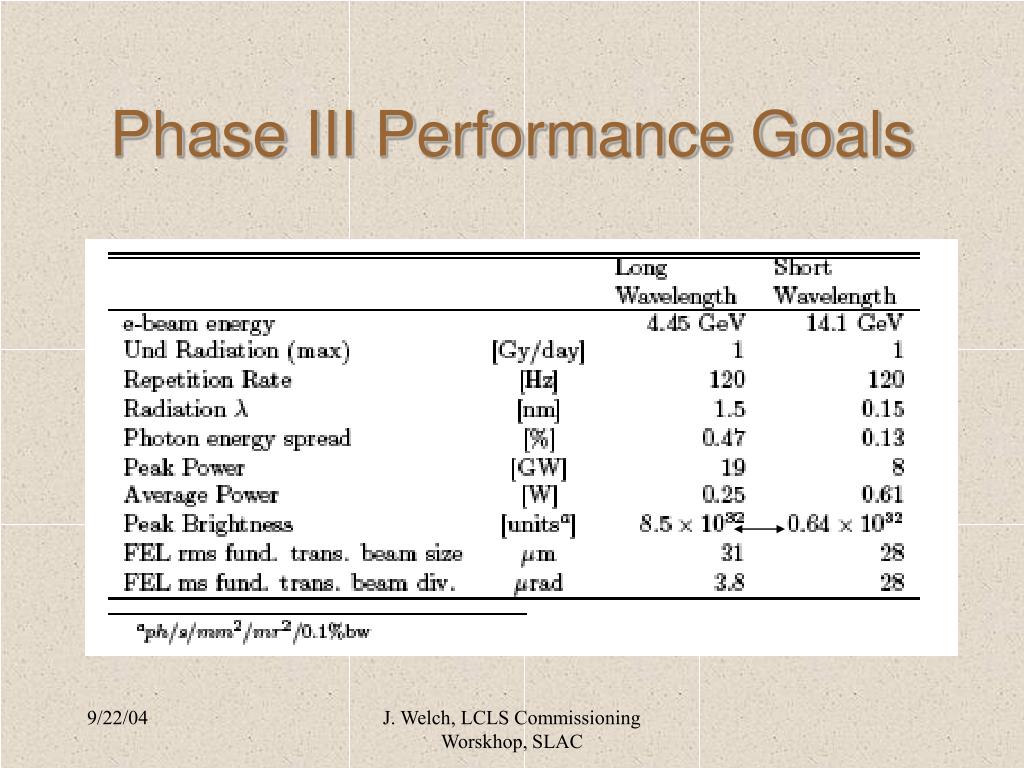

Phase III Performance Goals J. Welch, LCLS Commissioning Worskhop, SLAC
Completion of Phase III Demonstrates • We are ready to turn the machine over to the operators and the users • We need another project! J. Welch, LCLS Commissioning Worskhop, SLAC
