1 / 14

Celerant Consulting Business Game - Team Hermès

Celerant Consulting Business Game - Team Hermès. 29/01/10 - Arts & Métiers ParisTech. Summary. Objectives Global analysis Activities analysis Files delay in the design department Final suggestions. Objectives. Find the malfunctioning origins of the Supply Chain

liora
Télécharger la présentation

Celerant Consulting Business Game - Team Hermès

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. CelerantConsulting Business Game- Team Hermès 29/01/10 - Arts & Métiers ParisTech

  2. Summary • Objectives • Global analysis • Activities analysis • Files delay in the design department • Final suggestions

  3. Objectives • Find the malfunctioning origins of the Supply Chain • Give scenarios to improve it

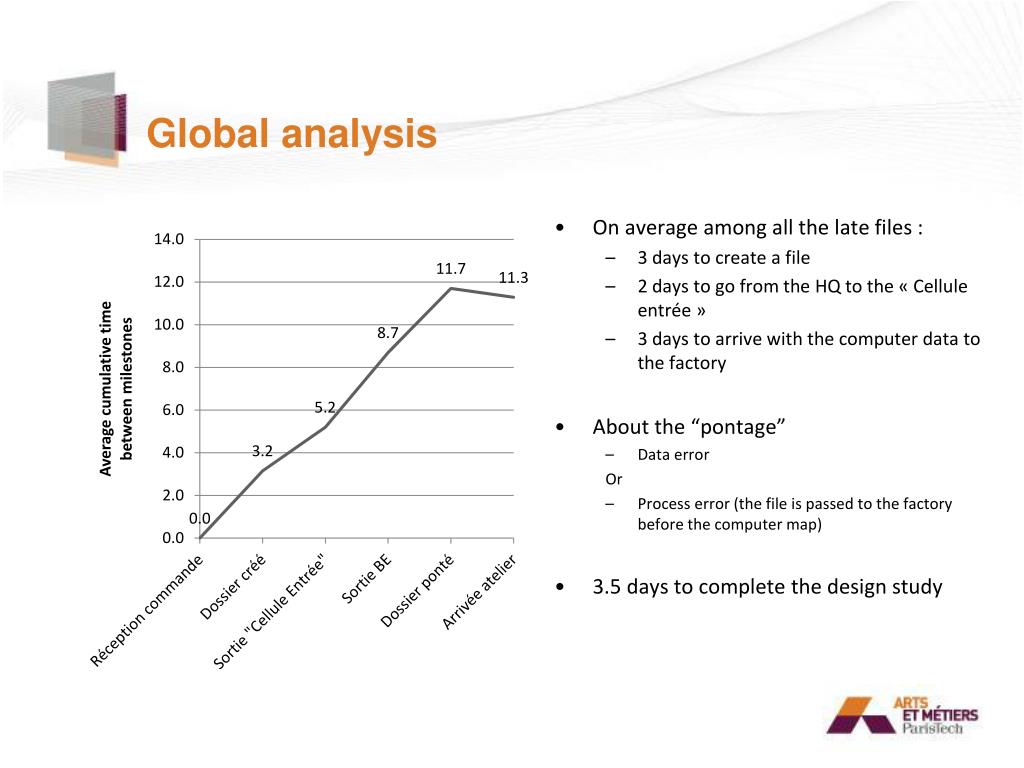

  4. Global analysis • On average among all the late files : • 3 days to create a file • 2 days to go from the HQ to the « Cellule entrée » • 3 days to arrive with the computer data to the factory • About the “pontage” • Data error Or • Process error (the file is passed to the factory before the computer map) • 3.5 days to complete the design study

  5. Global analysis • Too much time spent in the 2 first tasks • Time spent in the design department and the factory is only about 43% of the total time

  6. Suggestions • Reduce the stages before the design department • Too many people involved (4 departments) • Too long (5 days, 31%) • Could help to reduce misunderstandings • 3 days to set the plans on the computers • Could it be reduced?

  7. « BE-Chiffrage » Activities Analysis • The major part of the time is lost (47%) • Unjustified modification: • Errors in design • No Reference on drawings • Unclear Needs Time distribution of the nomenclature department technician From 9:00 to 12:00

  8. « Chargé d'Affaires » ActivitiesAnalysis Time distribution of the business manager • One fifth of the time is lost (21%) • Lost time due to : • Information missing • Components missing • Calls to correct erroneous information From 8:33 to 12:00

  9. Suggestions • Improve the quality of the information exchange with the design department • No error in the drawings • Less missing information or components

  10. Files delays in the design department • The more files to process in a day the higher the delay • 10 files ≈ 15% files are late • 30 files ≈ 45% files are late • Quotes are more often latethan orders • 40% of the quotes are late • Vs 15% for the orders • 30% of the files are at least one day late

  11. Files delays within the design department • Lack of quality in transmitting information affects differently the departments, on average: • Every file in the nomenclature department is delayed by 53 min • Every file in the Setting-up department is delayed by 117 min • Top 4 causes of delays is also changed accordingly to the department

  12. Final suggestions (1/2) • Reduce the delay of the files in the design department • Every file is delayed by 53 min or 117 min depending on the dep. • What could be the main causes to tackle in the design department? • The clarity of the need expression (19 min & 27 min) • The surface treatment & color (14 min & 6 min) • Drawings on computer (42 min)

  13. Final suggestions (2/2) • Reduce the stages number before the design department • 4 departments involved, 5 days long • Reduce the time needed to get the drawings on the computer • 3 days long • Improve the quality of the information exchange with the design department • 47% of the technician time & 21% of the business manager time is “lost”

  14. Thank you for your attention Do you have any question ?

More Related
