Project Management Dr. Ron Lembke Operations Management
What’s a Project? • Changing something from the way it is to the desired state • Never done one exactly like this • Many related activities • Focus on the outcome • Regular teamwork focuses on the work process
Examples of Projects • Building construction • New product introduction • Software implementation • Training seminar • Research project
Why are projects hard? • Resources- • People, materials • Planning • What needs to be done? • How long will it take? • What sequence? • Keeping track of who is supposedly doing what, and getting them to do it
IT Projects • Half finish late and over budget • Nearly a third are abandoned before completion • The Standish Group, in Infoworld • Get & keep users involved & informed • Watch for scope creep / feature creep
Pinion Pine Power Plant • DOE Clean Coal • Air-blown Integrated Gasification Combined Cycle • Kellogg/Rust/Westinghouse gasifier • GE Frame 6FA combustion turbine • $335.9m, half DOE, half SPP
Coal Gasification • Coal Gasification (new) • Coal into Low Heat Value (LHV) gas 130 btus/standard foot • Crushed coal and limestone absorbs sulfur • Hot gas desulfirized • Particulate removal • Gas Fed into turbine • Tested fine on nat gas
Technology Development • Ash created in gasification, collected • Hot-gas cleanup (new technology) • SO2 in collected in calcium sulfate • Hot-gas filter, then to combustion turbine • Fines combustor burns particles bottom of filter • Main problem was filter-fines removal • Never operated more than 24 hrs. • Tried 24 times to start it. Eventually mothballed
Project Scheduling • Establishing objectives • Determining available resources • Sequencing activities • Identifying precedence relationships • Determining activity times & costs • Estimating material & worker requirements • Determining critical activities
Project Personnel Structure • Pure project “Skunk Works” • Functional Project • Matrix Project

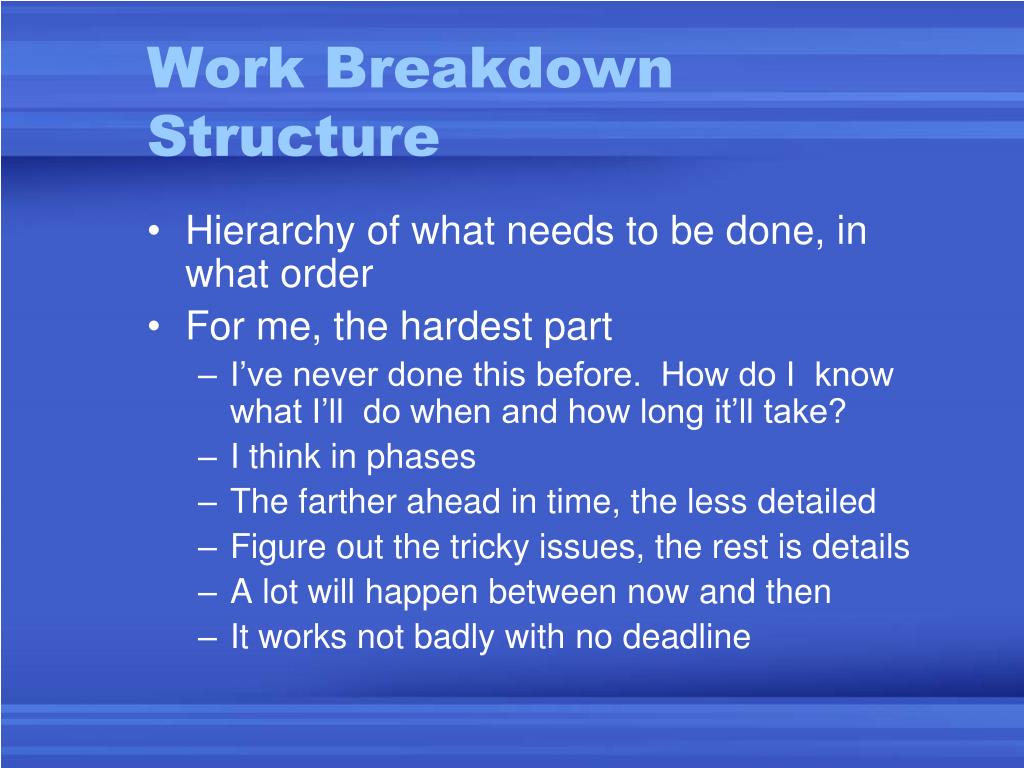

Work Breakdown Structure • Hierarchy of what needs to be done, in what order • For me, the hardest part • I’ve never done this before. How do I know what I’ll do when and how long it’ll take? • I think in phases • The farther ahead in time, the less detailed • Figure out the tricky issues, the rest is details • A lot will happen between now and then • It works not badly with no deadline
W D Mudroom Remodel D • Big-picture sequence easy: • Demolition • Framing • Plumbing • Electrical • Drywall, tape & texture • Slate flooring • Cabinets, lights, paint • Hard: can a sink fit? W

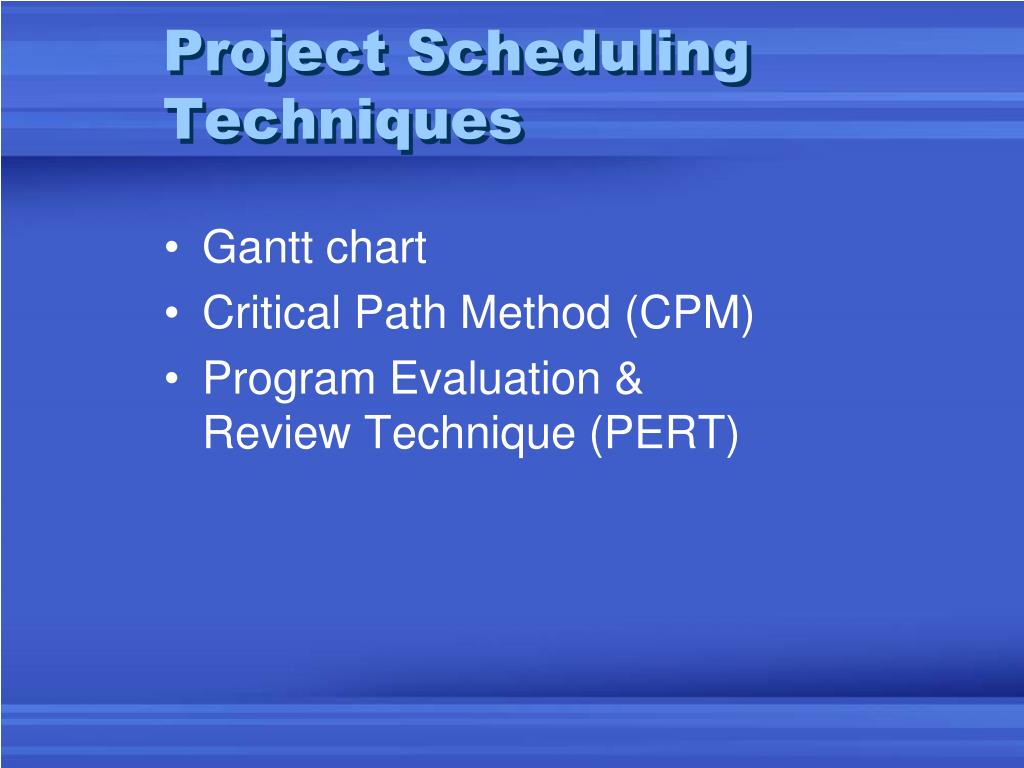

Project Scheduling Techniques • Gantt chart • Critical Path Method (CPM) • Program Evaluation & Review Technique (PERT)
PERT & CPM • Network techniques • Developed in 1950’s • CPM by DuPont for chemical plants • PERT by U.S. Navy for Polaris missile • Consider precedence relationships & interdependencies • Each uses a different estimate of activity times
Questions Answered by PERT & CPM • Completion date? • On schedule? Within budget? • Probability of completing by ...? • Critical activities? • Enough resources available? • How can the project be finished early at the least cost?

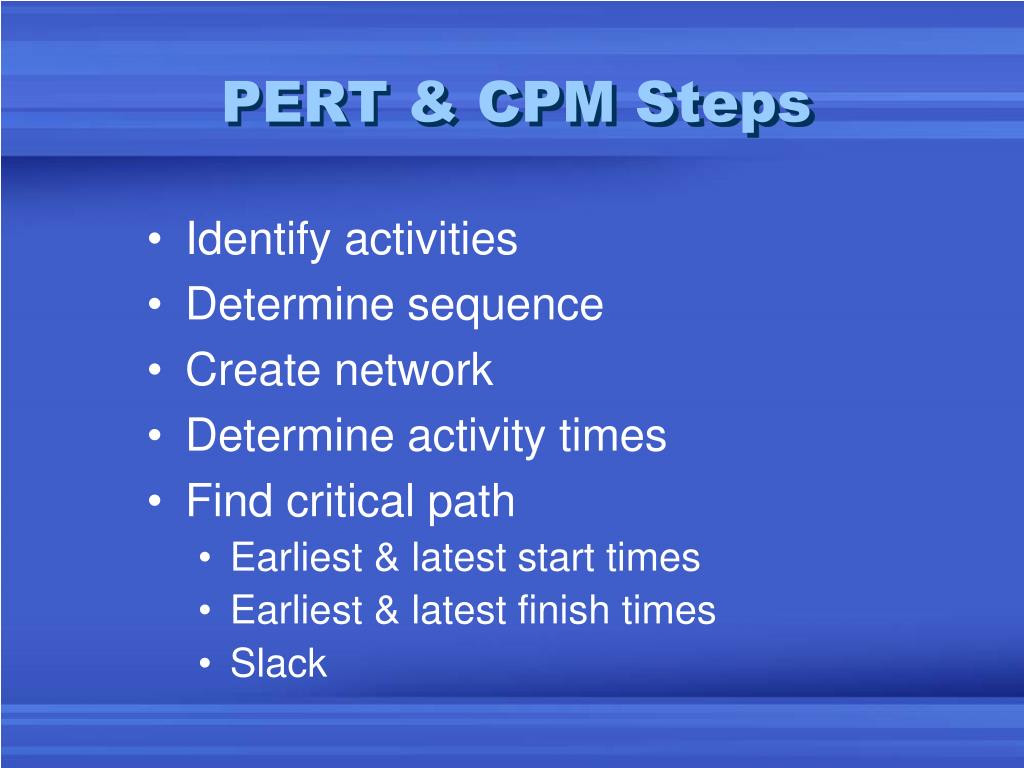

PERT & CPM Steps • Identify activities • Determine sequence • Create network • Determine activity times • Find critical path • Earliest & latest start times • Earliest & latest finish times • Slack
1 2 3 Activity on Node (AoN) Project: Obtain a college degree (B.S.) Receive diploma Attend class, study etc. Enroll 1 month 4? Years 1 day
1 2 3 4 Activity on Arc (AoA) Project: Obtain a college degree (B.S.) Attend class, study, etc. Receive diploma Enroll 1 month 4,5 ? Years 1 day
1 2 3 4 AoA Nodes have meaning Project: Obtain a college degree (B.S.) GraduatingSenior Applicant Student Alum
We’ll use Activity on Node 3 2 1 4 1-2 must be done before 2-3 or 3-4 can start

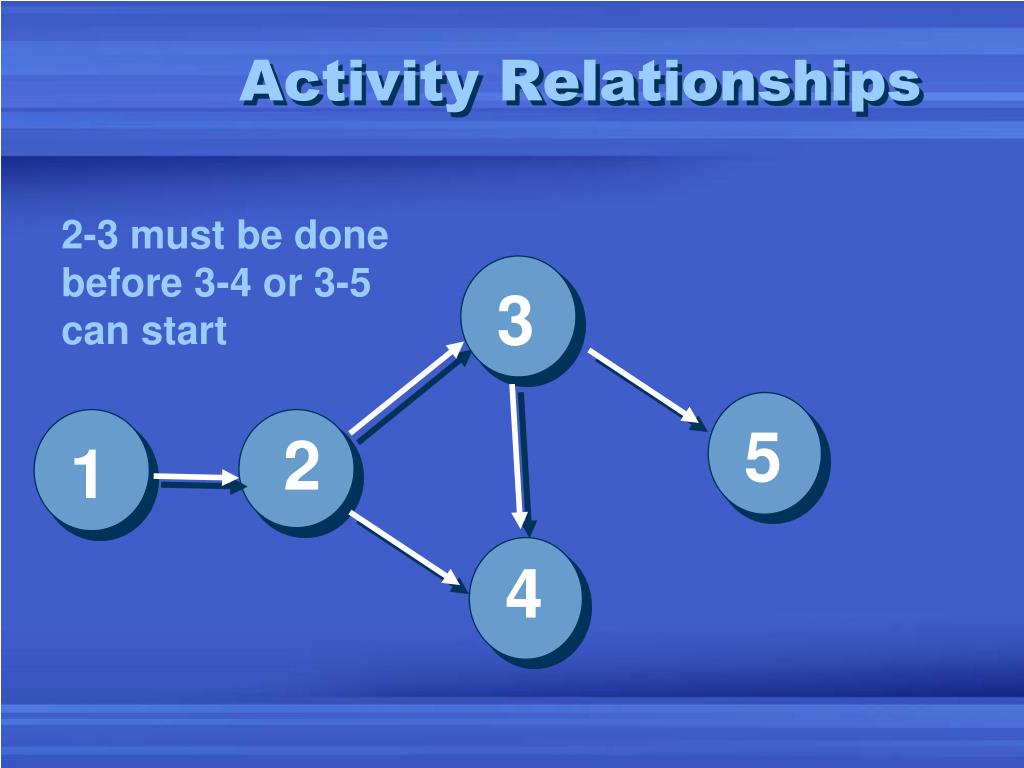

Activity Relationships 2-3 must be done before 3-4 or 3-5 can start 3 5 2 1 4

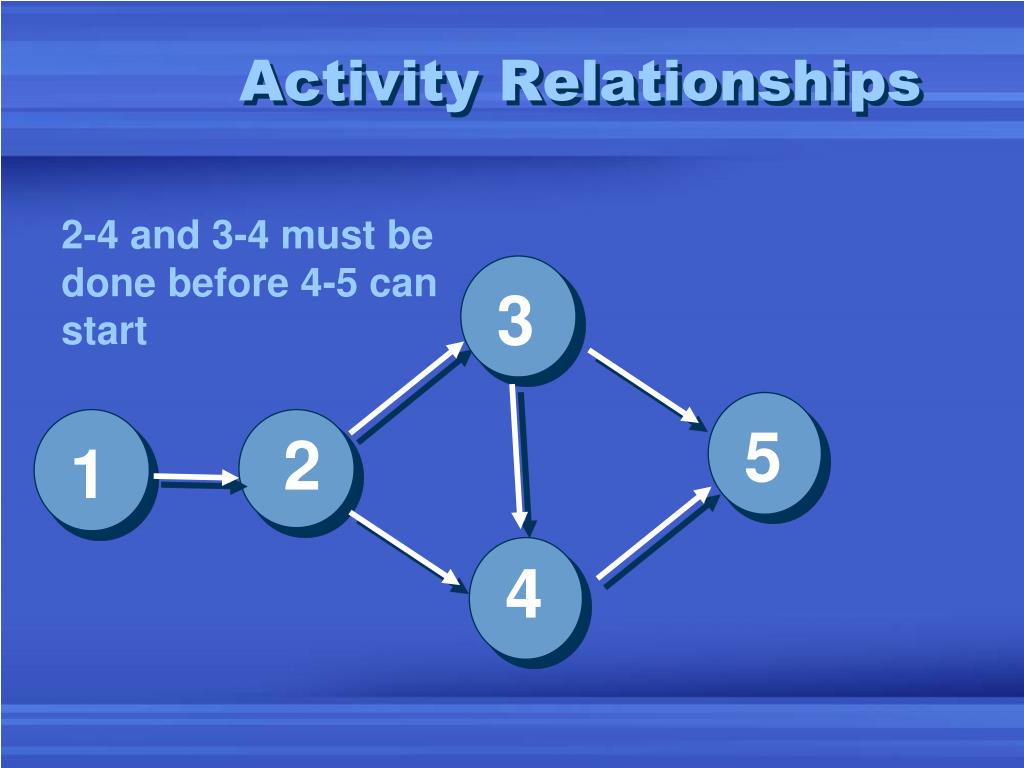

Activity Relationships 2-4 and 3-4 must be done before 4-5 can start 3 5 2 1 4
Network Example You’re a project manager for Bechtel. Construct the network. Activity Predecessors A --B A C AD B E BF C G DH E, F

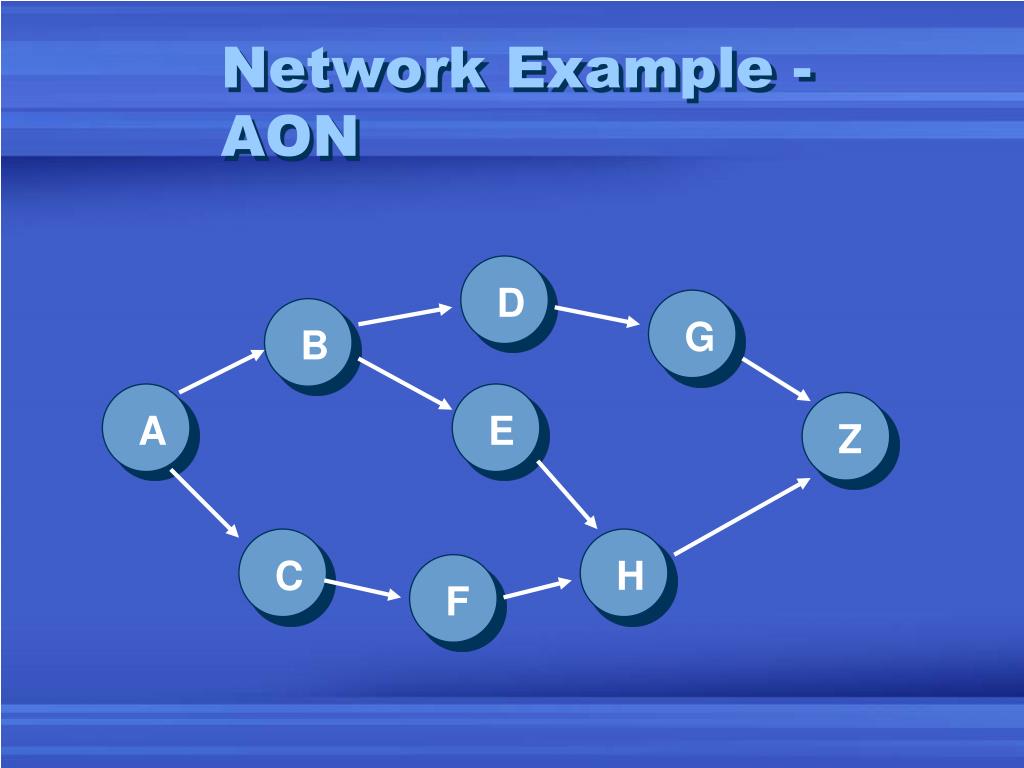

A C E F B D G H Z Network Example - AON
7 2 9 5 1 3 6 8 Network Example - AOA G D B E A H C F 4
2 2 3 1 5 3 1 4 4 AOA Diagrams A precedes B and C, B and C precede D B A D C B A C D Add a phantom arc for clarity.
Critical Path Analysis • Provides activity information • Earliest (ES) & latest (LS) start • Earliest (EF) & latest (LF) finish • Slack (S): Allowable delay • Identifies critical path • Longest path in network • Shortest time project can be completed • Any delay on activities delays project • Activities have 0 slack

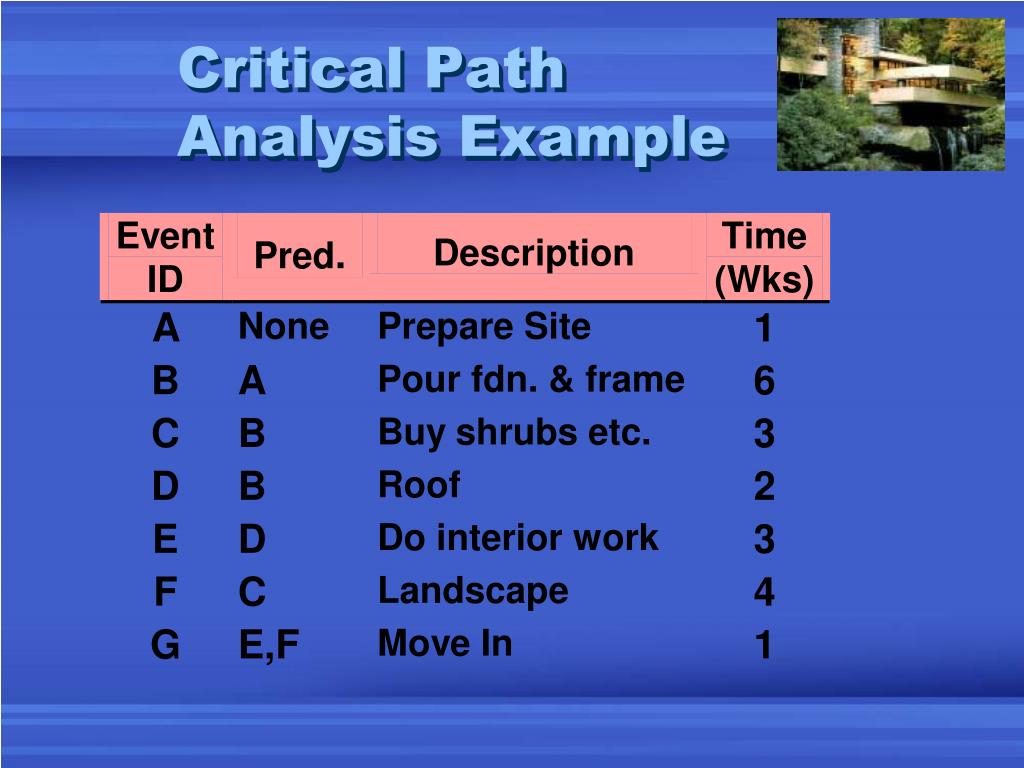

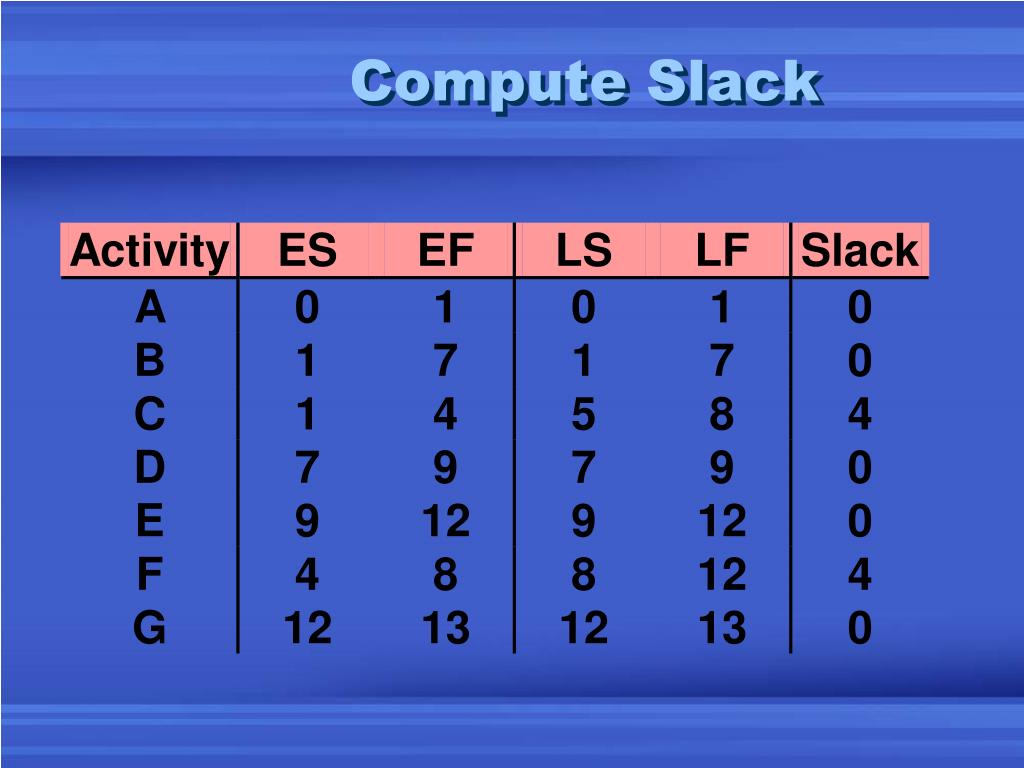

Network Solution B D E A G 2 6 3 1 1 C F 3 4
Earliest Start & Finish Steps • Begin at starting event & work forward • ES = 0 for starting activities • ES is earliest start • EF = ES + Activity time • EF is earliest finish • ES = Maximum EF of all predecessors for non-starting activities

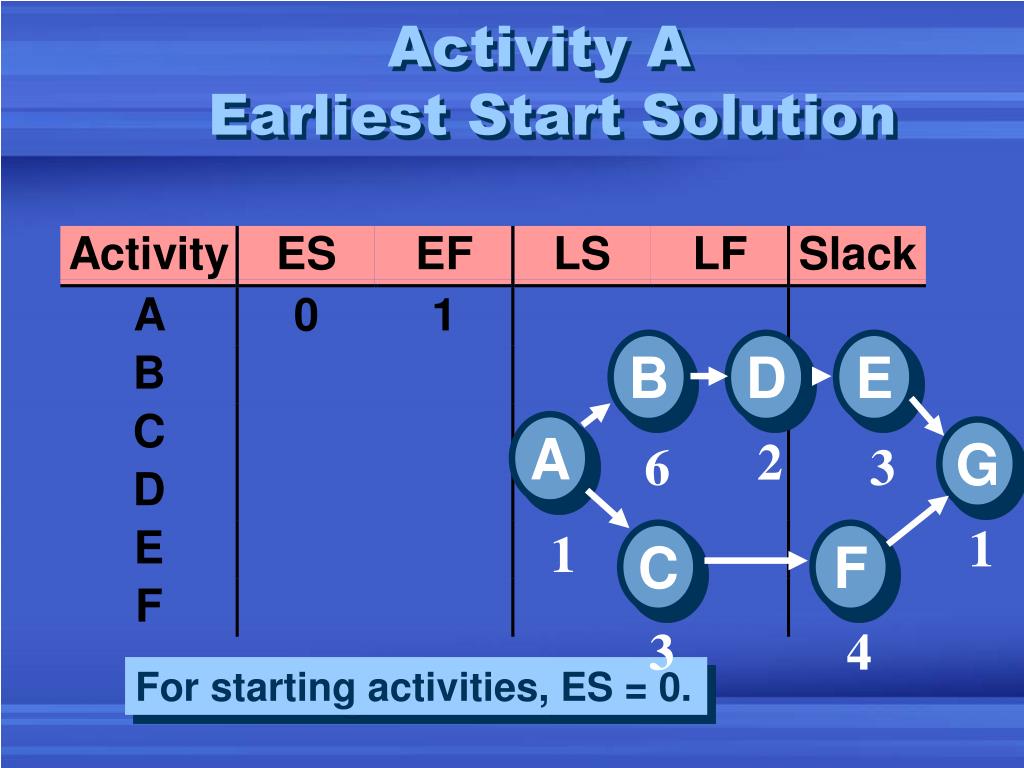

B D E A G 2 6 3 1 1 C F 3 4 Activity A Earliest Start Solution For starting activities, ES = 0.
B D E A G 2 6 3 1 1 C F 3 4 Earliest Start Solution
Latest Start & Finish Steps • Begin at ending event & work backward • LF = Maximum EF for ending activities • LF is latest finish; EF is earliest finish • LS = LF - Activity time • LS is latest start • LF = Minimum LS of all successors for non-ending activities

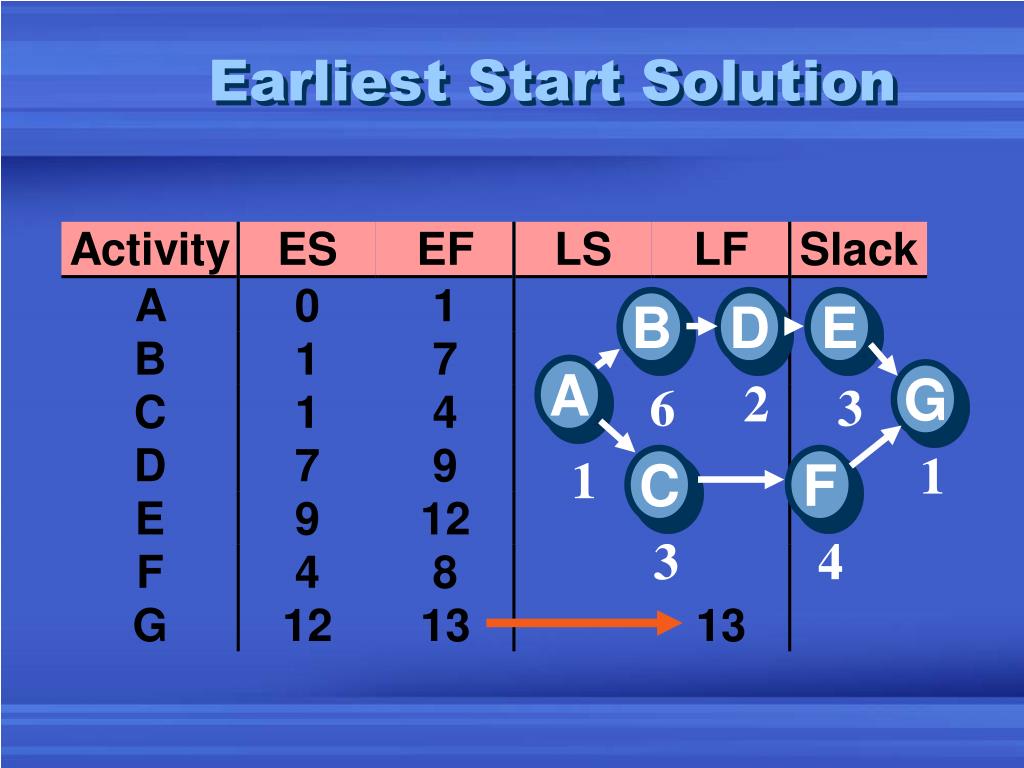

B D E A G 2 6 3 1 1 C F 3 4 Earliest Start Solution
B D E A G 2 6 3 1 1 C F 3 4 Latest Finish Solution

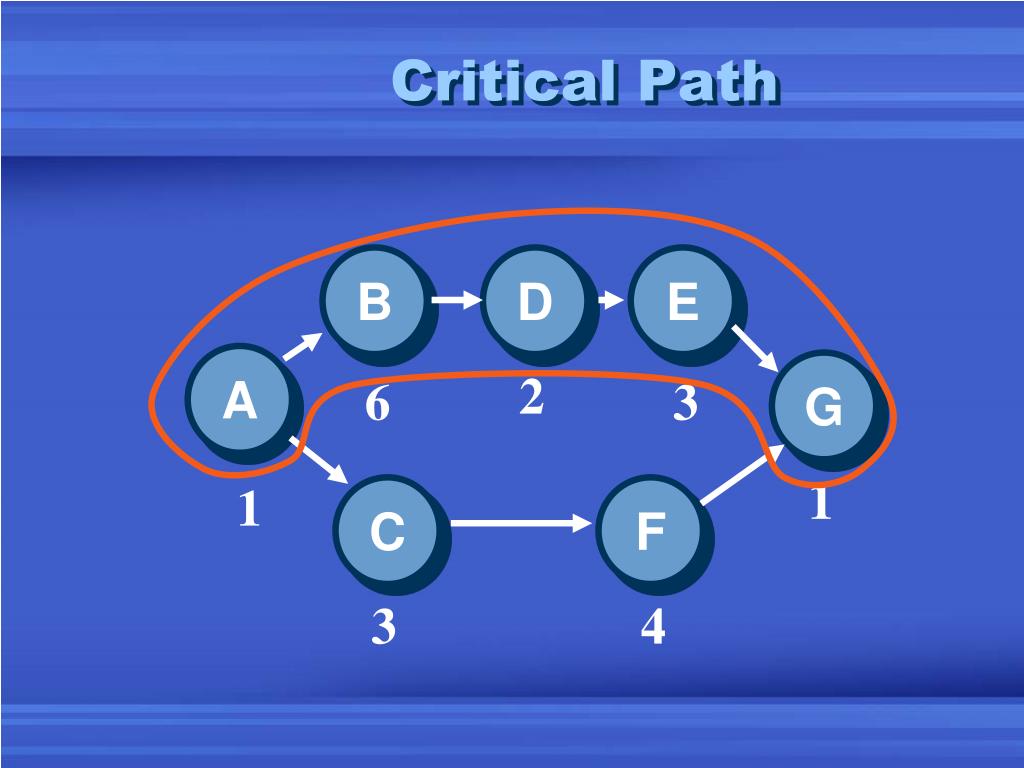

B D E A G 2 6 3 1 1 C F 3 4 Critical Path
New notation • Compute ES, EF for each activity, Left to Right • Compute, LF, LS, Right to Left ES EF C 7 LS LF
Exhibit 7.6, p.195 F 8 C 7 A 21 G 2 B 5 D 2 E 5
Exhibit 7.6, p.195 21 28 28 36 F 8 C 7 0 21 36 38 A 21 G 2 28 33 21 26 26 28 B 5 D 2 E 5 F cannot start until C and D are done. G cannot start until both E and F are done.
Exhibit 7.6, p.195 21 28 28 36 F 8 C 7 21 28 28 36 0 21 36 38 A 21 G 2 0 21 36 38 28 33 21 26 26 28 B 5 D 2 E 5 21 26 26 28 31 36 E just has to be done in time for G to start at 36, so it has slack. D has to be done in time for F to go at 28, so it has no slack.

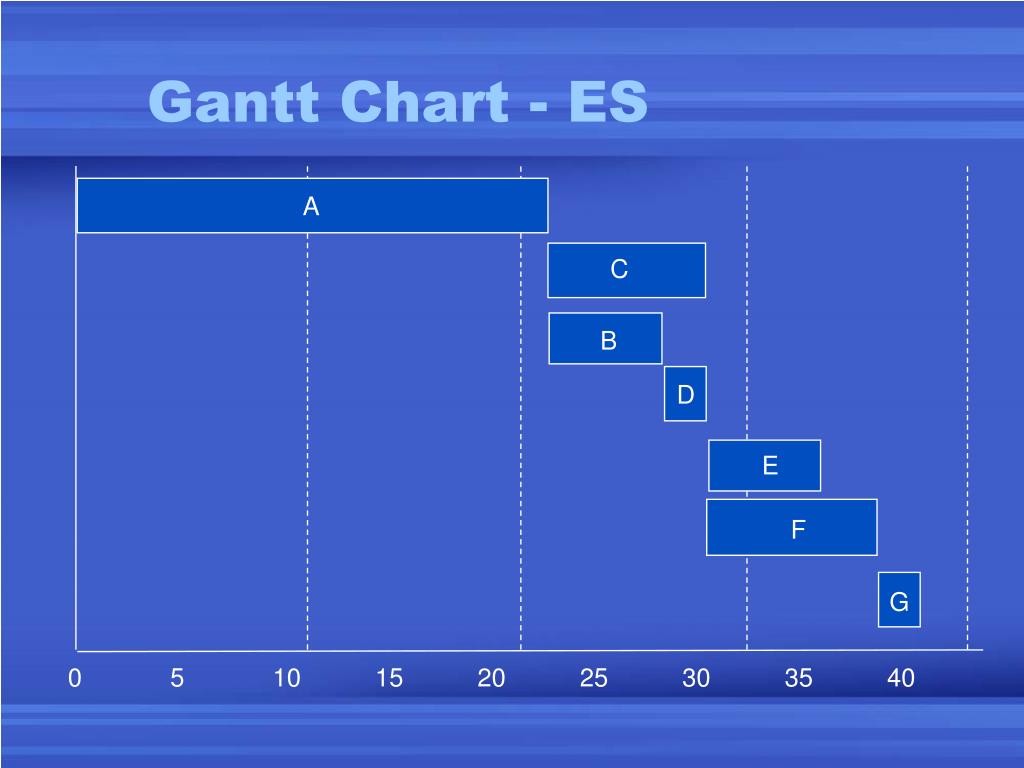

Gantt Chart - ES A C B D E F G 0 5 10 15 20 25 30 35 40

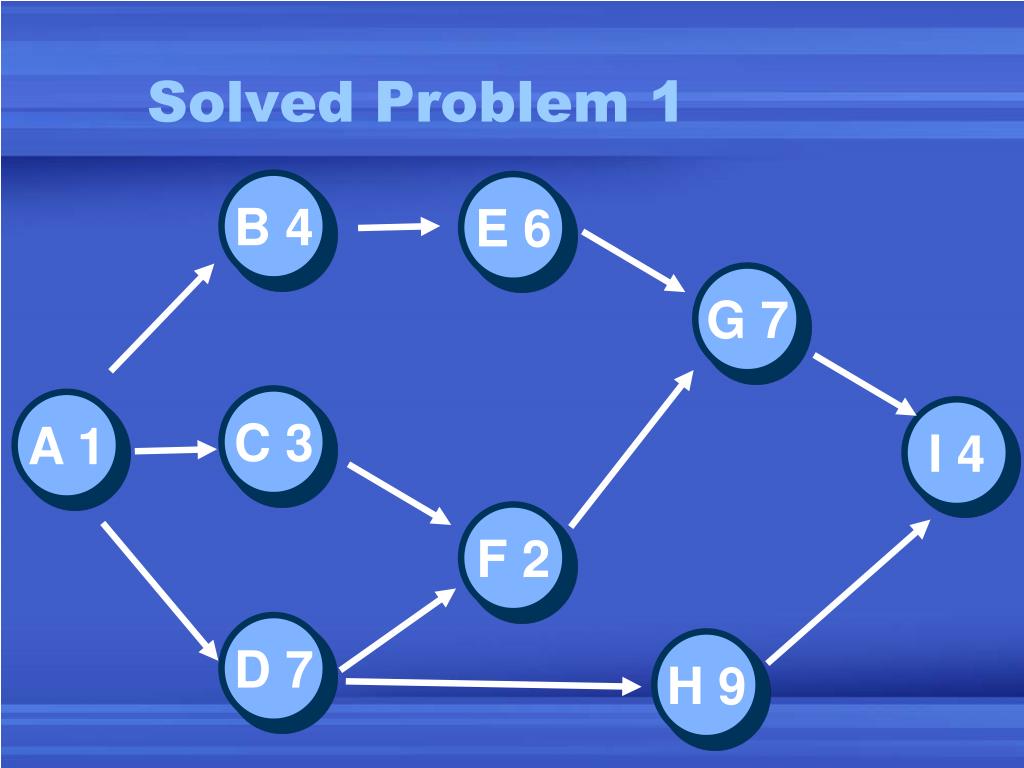

Solved Problem 1 B4 E6 G7 C3 A 1 I4 F2 D7 H9
Solved Problem 1 1 5 511 B4 E6 1118 1 5 511 G7 1118 1 4 0 1 1822 C3 A 1 I4 6 9 0 1 810 1822 F2 1 8 911 817 D7 H9 2 9 918
