This proposal presents the HMAC-based Tamper Evident Encryption (HTEE) scheme as a novel approach to ensuring data integrity and confidentiality in database environments. HTEE combines encryption and tamper detection into a streamlined process, eliminating the need for end-users to configure separate systems. This project seeks to improve upon previous encryption methodologies by implementing an efficient algorithm that utilizes hash functions for secure integer encryption. Key goals include performance enhancement, tamper detection, and comprehensive testing of the proposed system.
E N D
Ensuring data integrity with tamper evident encryption of integers using keyed Hash Message Authentication Code Master’s Project Proposal Brad Baker September 28, 2009 UCCS Brad Baker - Master's project proposal

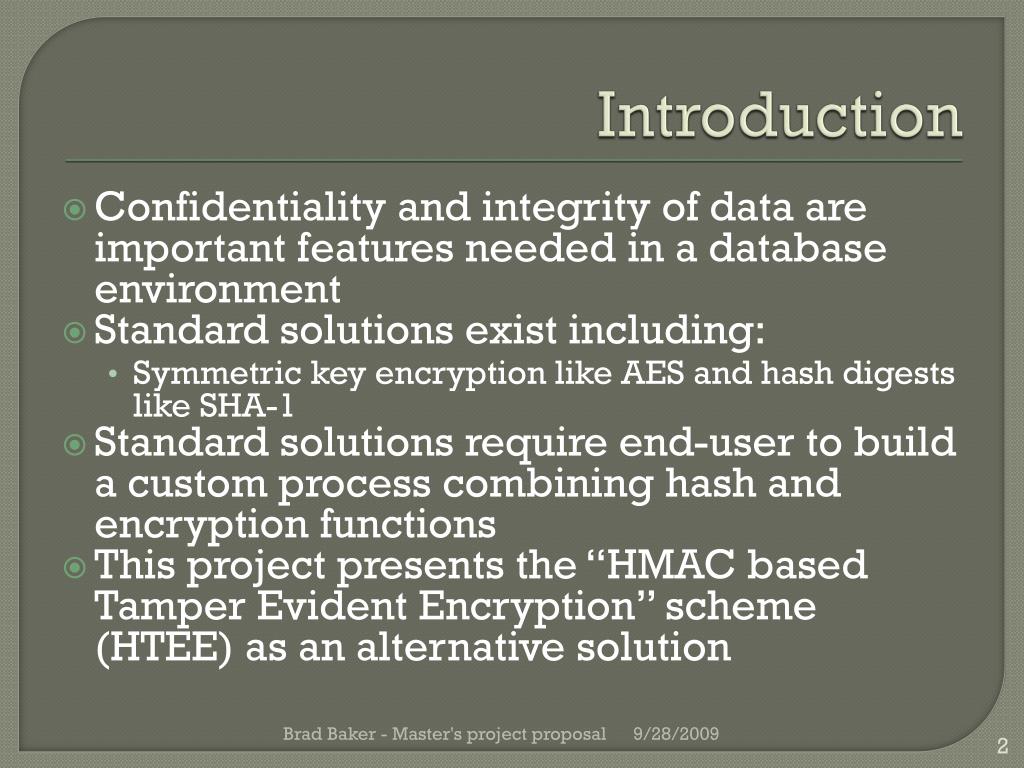

Introduction • Confidentiality and integrity of data are important features needed in a database environment • Standard solutions exist including: • Symmetric key encryption like AES and hash digests like SHA-1 • Standard solutions require end-user to build a custom process combining hash and encryption functions • This project presents the “HMAC based Tamper Evident Encryption” scheme (HTEE) as an alternative solution Brad Baker - Master's project proposal
Motivation • The motivation for this project is: • To provide a one-step encryption and tamper detection process for the end user • To provide a one-column solution to confidentiality and integrity • To provide a degree of performance improvement • To improve on a previously published work which introduced the HMAC based encryption/decryption process. • To explore alternative uses to hash digests and HMACincluding the ability to invert the digest Brad Baker - Master's project proposal

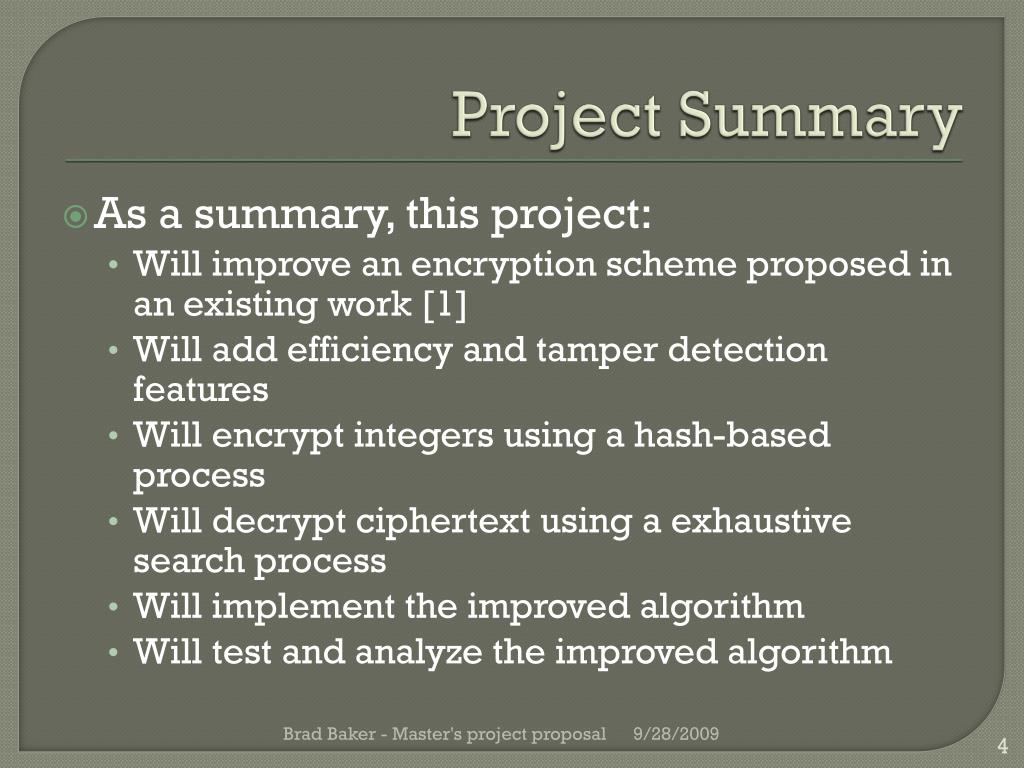

Project Summary • As a summary, this project: • Will improve an encryption scheme proposed in an existing work [1] • Will add efficiency and tamper detection features • Will encrypt integers using a hash-based process • Will decrypt ciphertext using a exhaustive search process • Will implement the improved algorithm • Will test and analyze the improved algorithm Brad Baker - Master's project proposal
Prior Work and Motivation • Prior work, Summer 2009: • Studied, implemented and tested a HMAC based encryption scheme proposed in [1] • The scheme operated on integer plaintext values, breaking them into a bucket and remainder • The scheme did not support range queries, and was inefficient in the design for encryption and decryption. • A detailed analysis and results are available in [2] Brad Baker - Master's project proposal
Project Overview • The original HMAC based encryption scheme appears to be unique: it uses a hash for two-way encryption • This is done by limiting the plaintext domain and performing exhaustive decryption searches • The strength of the algorithm is variable per implemented hash function • HMAC is a keyed-hash algorithm, see [3] and [4] • This project will improve the proposed algorithm • Efficiency updates will be included • The use of hash ciphertext will be leveraged to provide tamper detection of ciphertext values Brad Baker - Master's project proposal

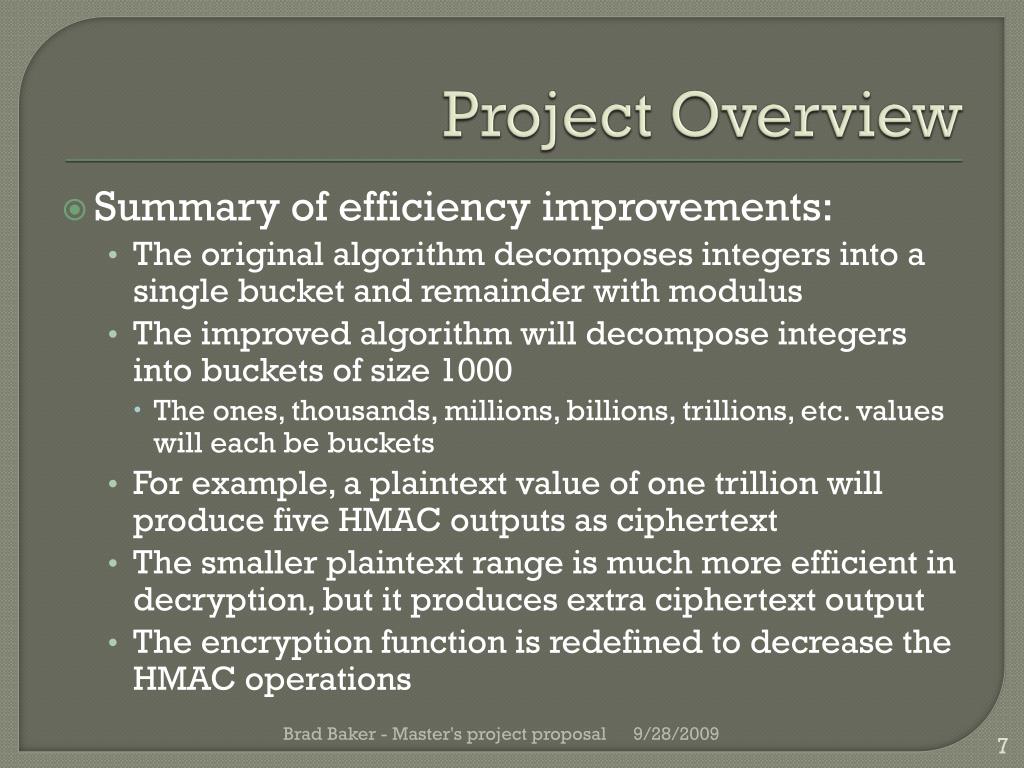

Project Overview • Summary of efficiency improvements: • The original algorithm decomposes integers into a single bucket and remainder with modulus • The improved algorithm will decompose integers into buckets of size 1000 • The ones, thousands, millions, billions, trillions, etc. values will each be buckets • For example, a plaintext value of one trillion will produce five HMAC outputs as ciphertext • The smaller plaintext range is much more efficient in decryption, but it produces extra ciphertext output • The encryption function is redefined to decrease the HMAC operations Brad Baker - Master's project proposal

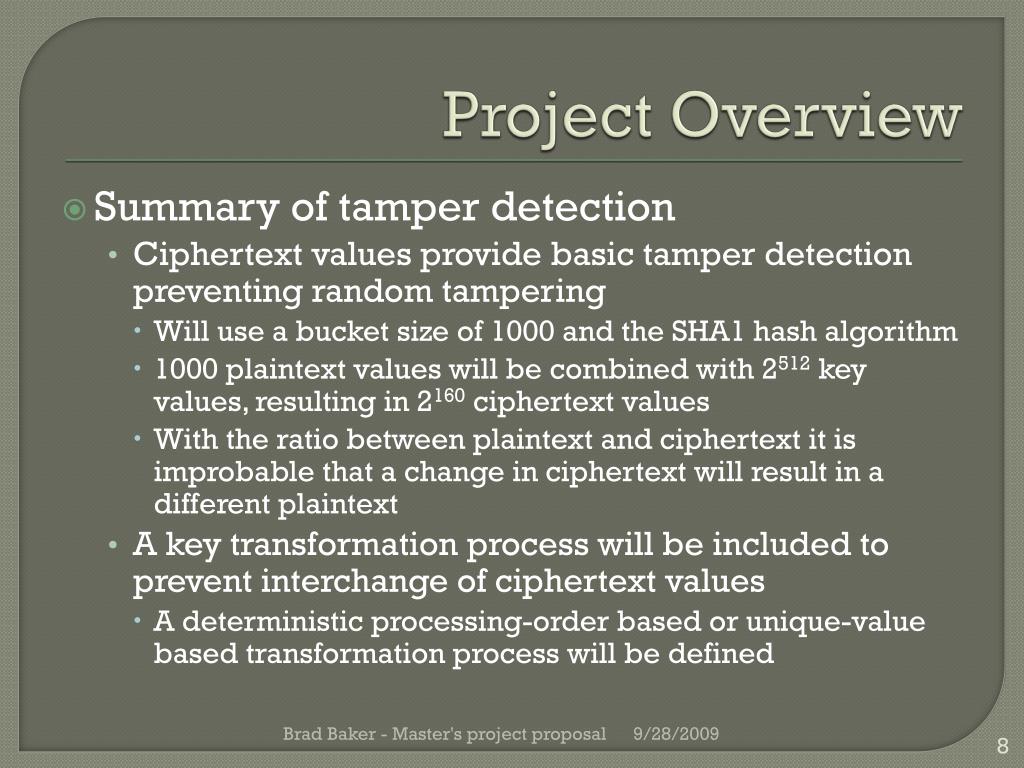

Project Overview • Summary of tamper detection • Ciphertext values provide basic tamper detection preventing random tampering • Will use a bucket size of 1000 and the SHA1 hash algorithm • 1000 plaintext values will be combined with 2512 key values, resulting in 2160 ciphertext values • With the ratio between plaintext and ciphertext it is improbable that a change in ciphertext will result in a different plaintext • A key transformation process will be included to prevent interchange of ciphertext values • A deterministic processing-order based or unique-value based transformation process will be defined Brad Baker - Master's project proposal

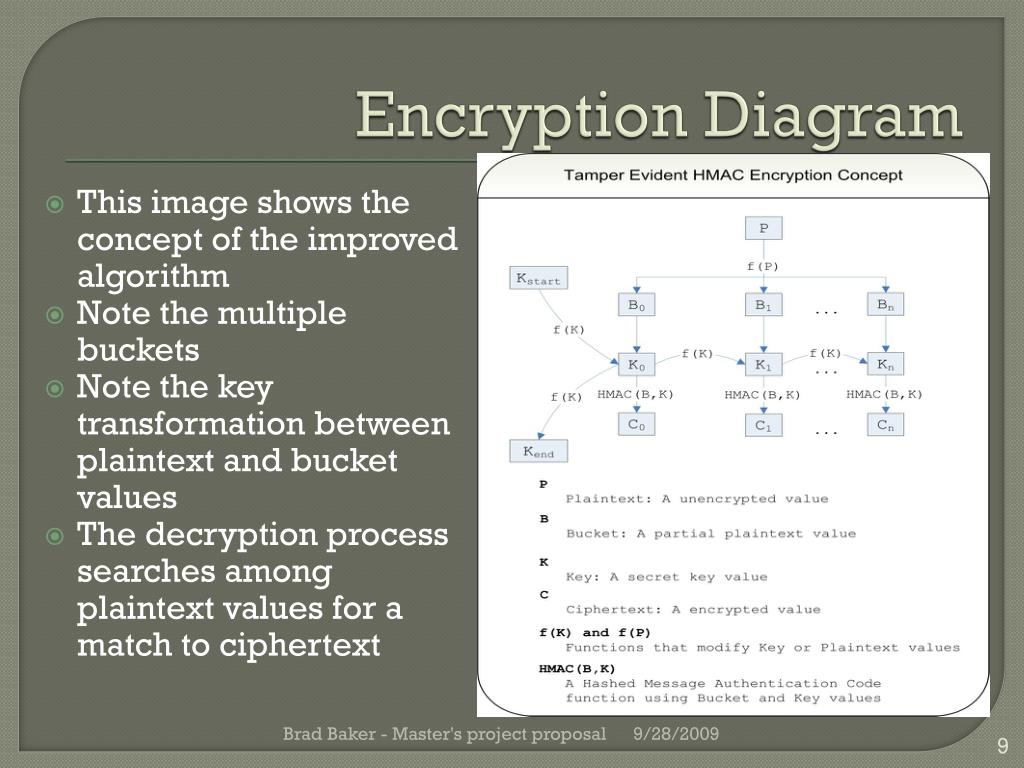

Encryption Diagram • This image shows the concept of the improved algorithm • Note the multiple buckets • Note the key transformation between plaintext and bucket values • The decryption process searches among plaintext values for a match to ciphertext Brad Baker - Master's project proposal

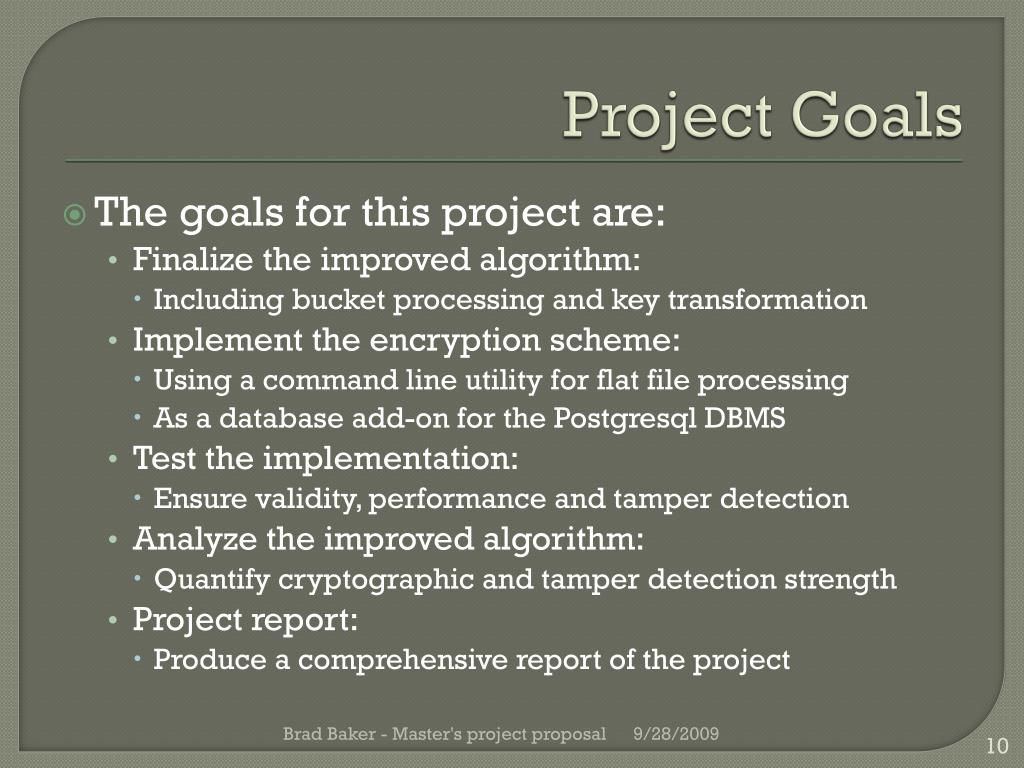

Project Goals • The goals for this project are: • Finalize the improved algorithm: • Including bucket processing and key transformation • Implement the encryption scheme: • Using a command line utility for flat file processing • As a database add-on for the Postgresql DBMS • Test the implementation: • Ensure validity, performance and tamper detection • Analyze the improved algorithm: • Quantify cryptographic and tamper detection strength • Project report: • Produce a comprehensive report of the project Brad Baker - Master's project proposal

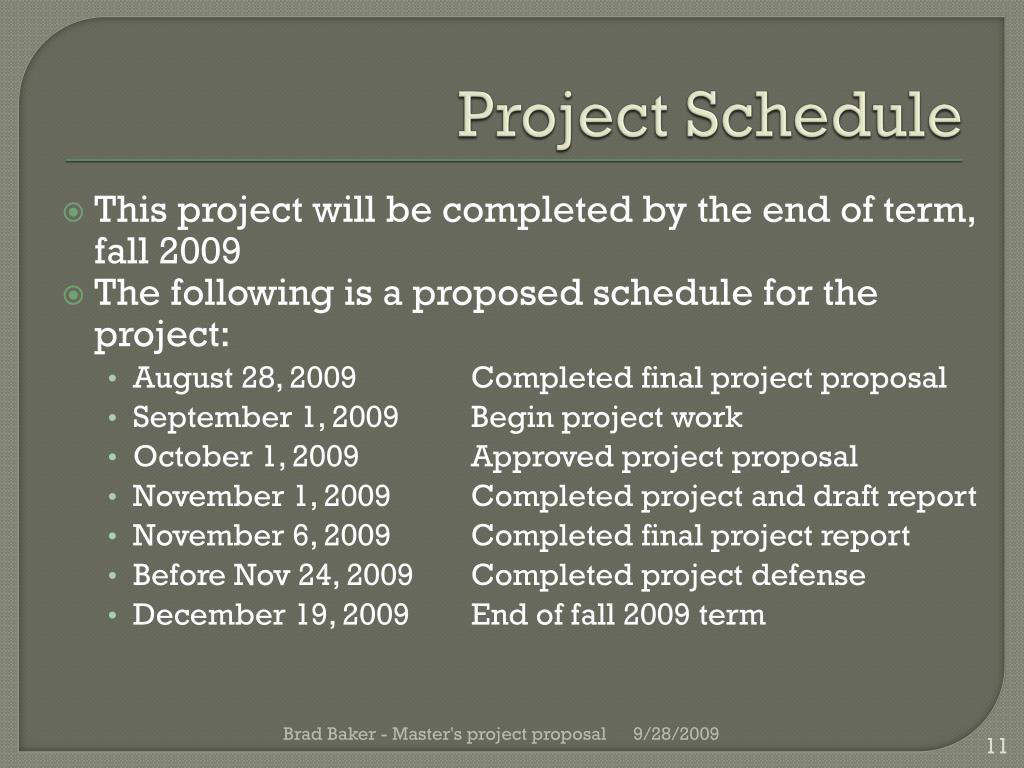

Project Schedule • This project will be completed by the end of term, fall 2009 • The following is a proposed schedule for the project: • August 28, 2009 Completed final project proposal • September 1, 2009 Begin project work • October 1, 2009 Approved project proposal • November 1, 2009 Completed project and draft report • November 6, 2009 Completed final project report • Before Nov 24, 2009 Completed project defense • December 19, 2009 End of fall 2009 term Brad Baker - Master's project proposal

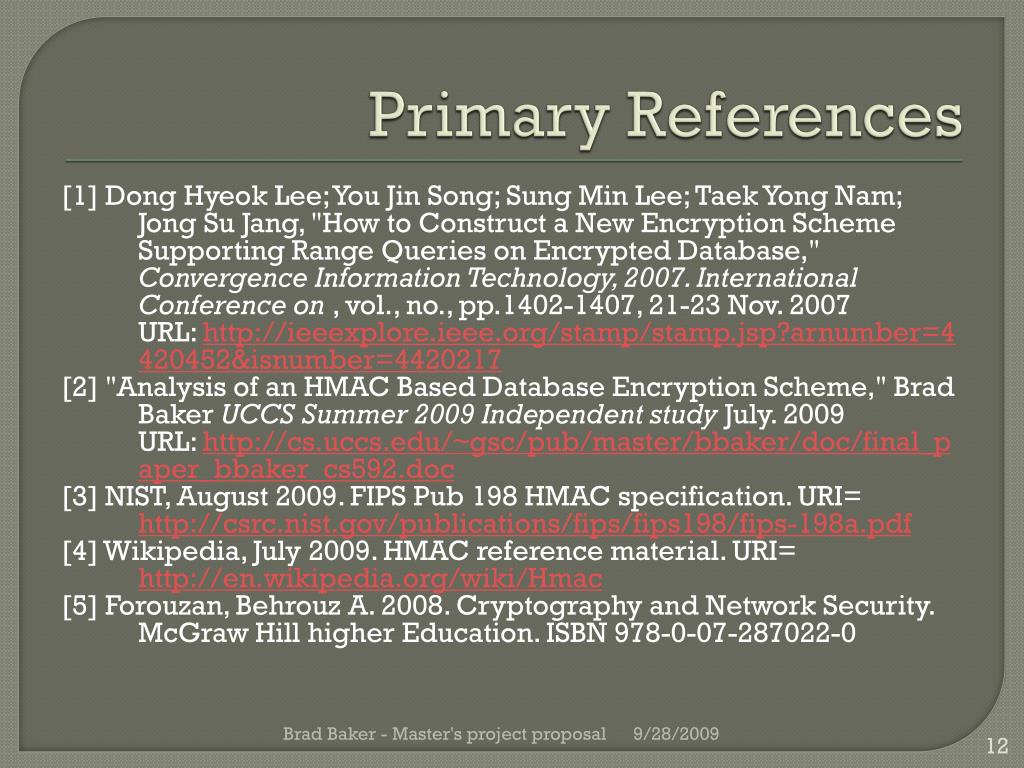

Primary References [1] Dong Hyeok Lee; You Jin Song; Sung Min Lee; Taek Yong Nam; Jong Su Jang, "How to Construct a New Encryption Scheme Supporting Range Queries on Encrypted Database," Convergence Information Technology, 2007. International Conference on , vol., no., pp.1402-1407, 21-23 Nov. 2007URL: http://ieeexplore.ieee.org/stamp/stamp.jsp?arnumber=4420452&isnumber=4420217 [2] "Analysis of an HMAC Based Database Encryption Scheme," Brad Baker UCCS Summer 2009 Independent study July. 2009URL: http://cs.uccs.edu/~gsc/pub/master/bbaker/doc/final_paper_bbaker_cs592.doc [3] NIST, August 2009. FIPS Pub 198 HMAC specification. URI= http://csrc.nist.gov/publications/fips/fips198/fips-198a.pdf [4] Wikipedia, July 2009. HMAC reference material. URI= http://en.wikipedia.org/wiki/Hmac [5] Forouzan, Behrouz A. 2008. Cryptography and Network Security. McGraw Hill higher Education. ISBN 978-0-07-287022-0 Brad Baker - Master's project proposal
