Update on ETI's Retail Access in SPP - Stakeholder Meeting Summary, September 16, 2008

This update summarizes the key activities and decisions from the SPP Stakeholder Meeting held on September 16, 2008, in Austin, TX. Notable outcomes include confirmation from ERCOT regarding the use of existing processes for retail access, utilizing SCR 727 data extracts. The estimated costs for software development to aggregate ERCOT's retail data in line with SPP Settlement systems have been received, and the team is developing final cost estimates for system changes, labor, and staffing involved in the implementation.

marged
Télécharger la présentation

Update on ETI's Retail Access in SPP - Stakeholder Meeting Summary, September 16, 2008

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Status Update: Retail Open Access for ETI within SPP Stakeholder Meeting September 16th, 2008 Austin, TX

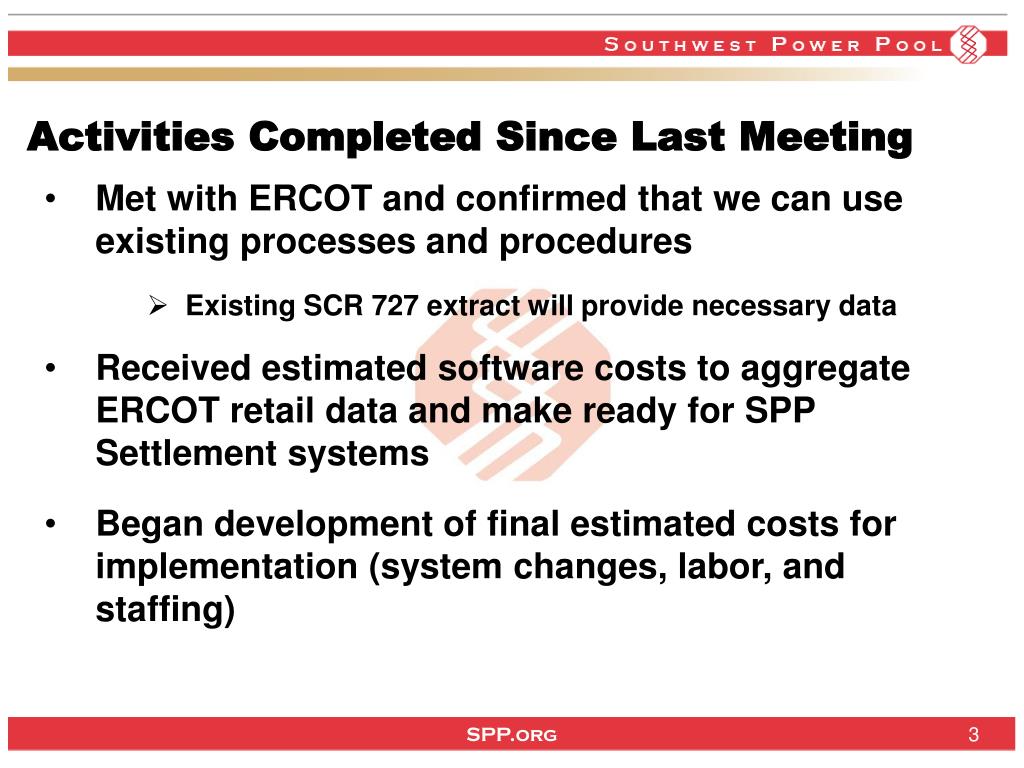

  2. Activities Completed Since Last Meeting • Met with ERCOT and confirmed that we can use existing processes and procedures • Existing SCR 727 extract will provide necessary data • Received estimated software costs to aggregate ERCOT retail data and make ready for SPP Settlement systems • Began development of final estimated costs for implementation (system changes, labor, and staffing)

  3. REPs As TC - Functions

  4. REPs As TC - Functions

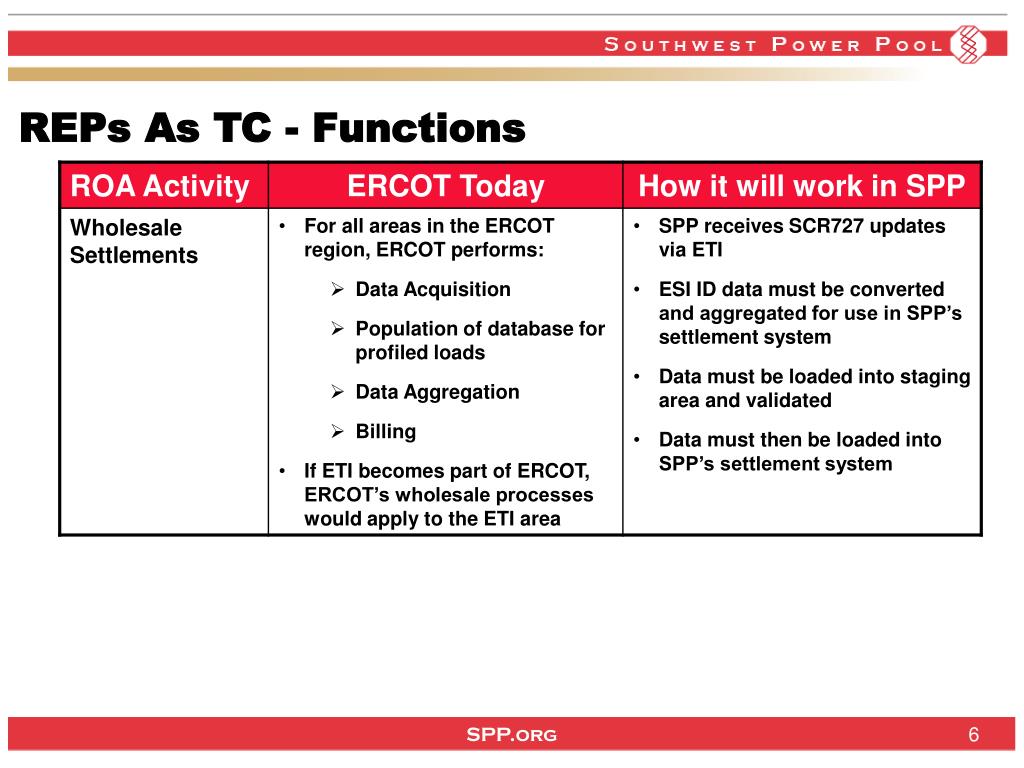

  5. REPs As TC - Functions

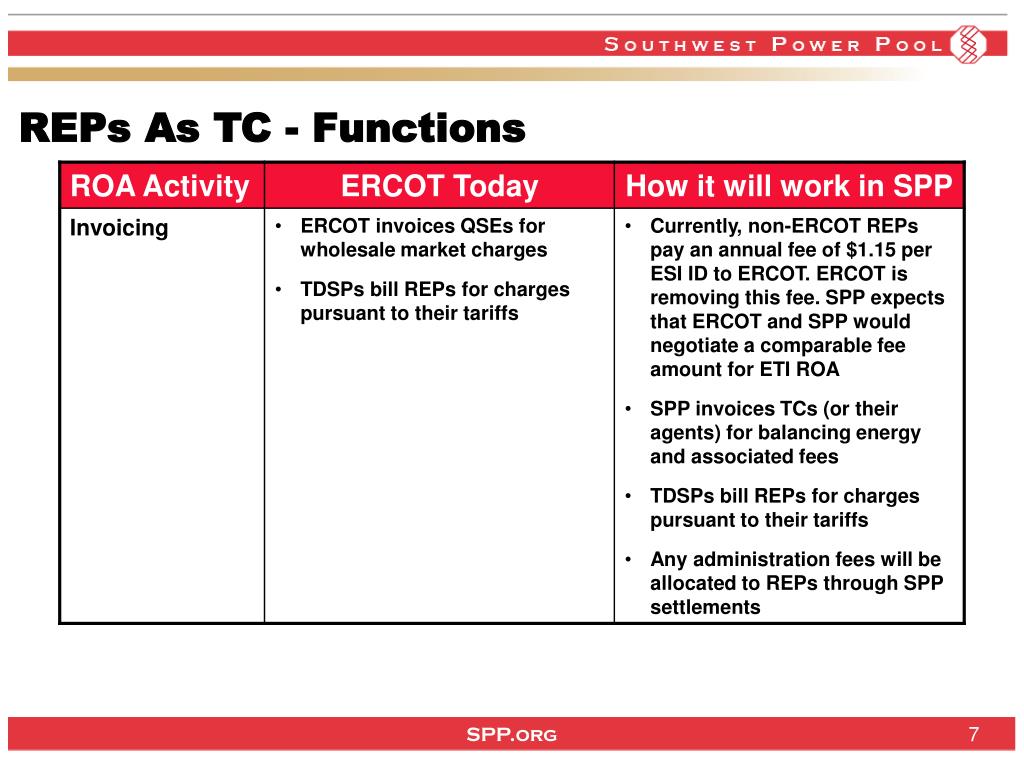

  6. REPs As TC - Functions

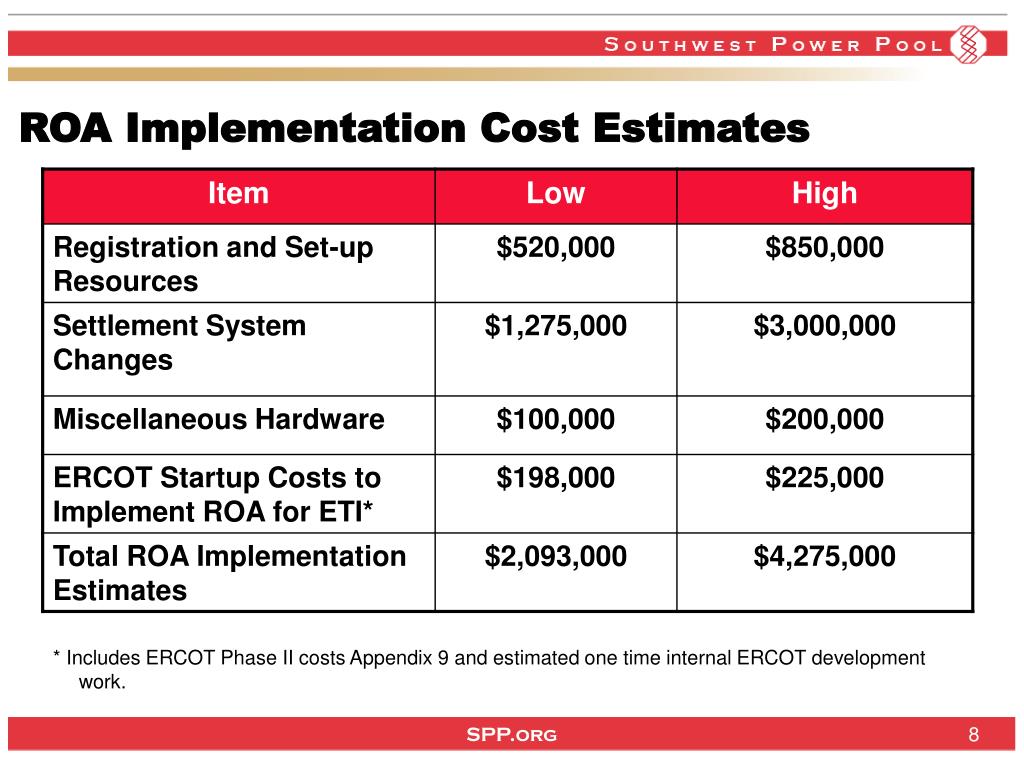

  7. ROA Implementation Cost Estimates * Includes ERCOT Phase II costs Appendix 9 and estimated one time internal ERCOT development work.

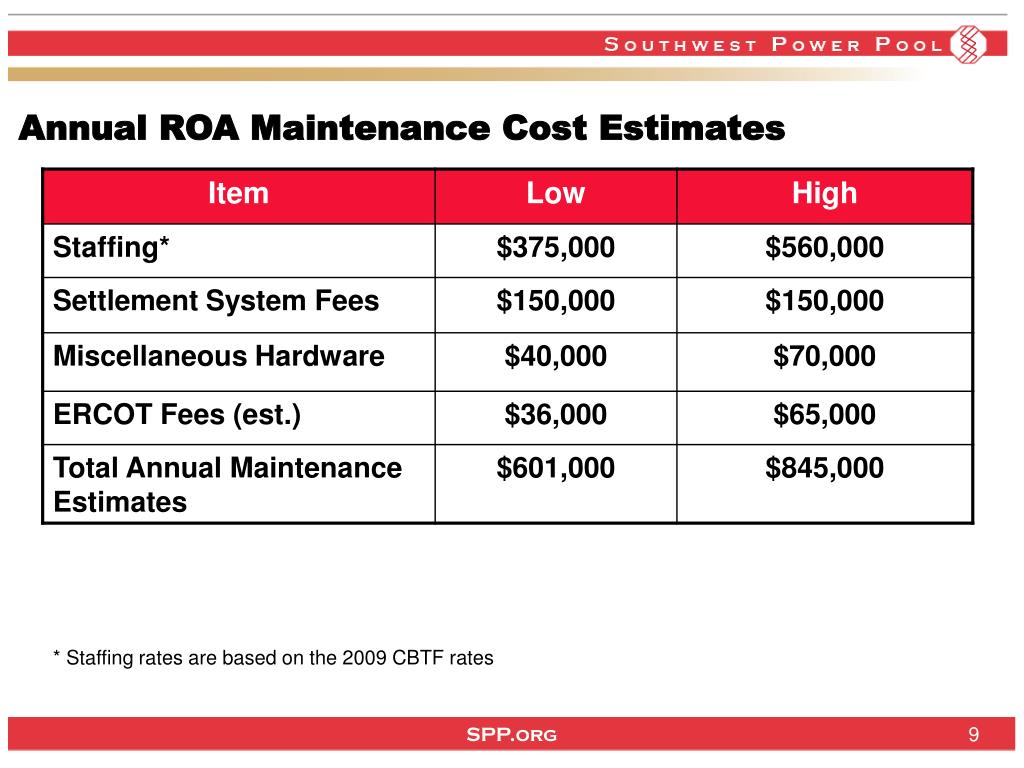

  8. Annual ROA Maintenance Cost Estimates * Staffing rates are based on the 2009 CBTF rates

  9. Questions?

  10. Beth MillerAccenture484.716.1706beth.miller@ accenture.com
