Home Automation with Mobile Control and Security
130 likes | 376 Vues
Home Automation with Mobile Control and Security. Project Advisors: Prof. Omer Farook Co advisor Glenmount Global Solutions Terry Primrose P.E. Project Group: Christian Nelson, Justin Lasecki and James Roach. Abstract.
Home Automation with Mobile Control and Security
E N D
Presentation Transcript
Home Automation with Mobile Control and Security Project Advisors: Prof. Omer Farook Co advisor Glenmount Global Solutions Terry Primrose P.E. Project Group: Christian Nelson, Justin Lasecki and James Roach
Abstract • To design a home automation system with security and control and monitoring by mobile application.
Inspiration/Similar Companies • Security • Mobile accessibility • Laziness
Function • Light, Fan, Door Lock, Window and Blind control • Temperature control and monitoring for each room • Total control via mobile application and in home panel • Security

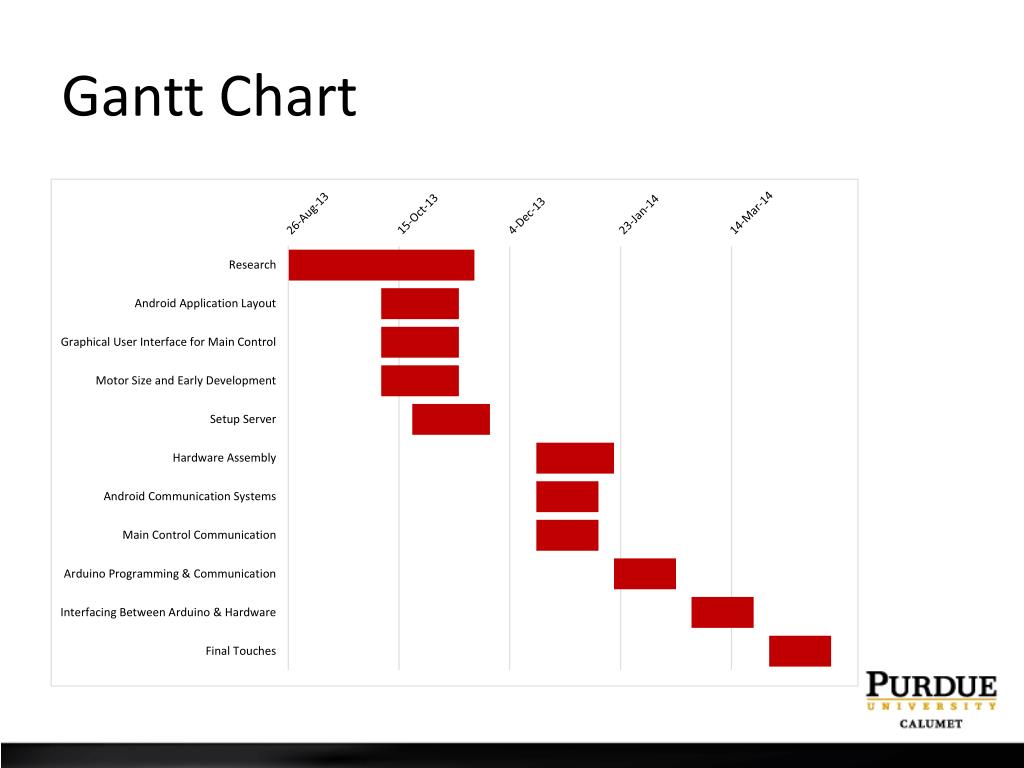

Accomplishments and Questions • Full house control • Questions?
