  1. Andrew Hall, Permit Manager, DAPC Permit Processing Goals for 2012

  2. Topics • Statistics on current installation permit status • Installation Goals for 2012 • Statistics on current operating permit status • Operating Permit Goals for 2012

  3. Installation Permit Status

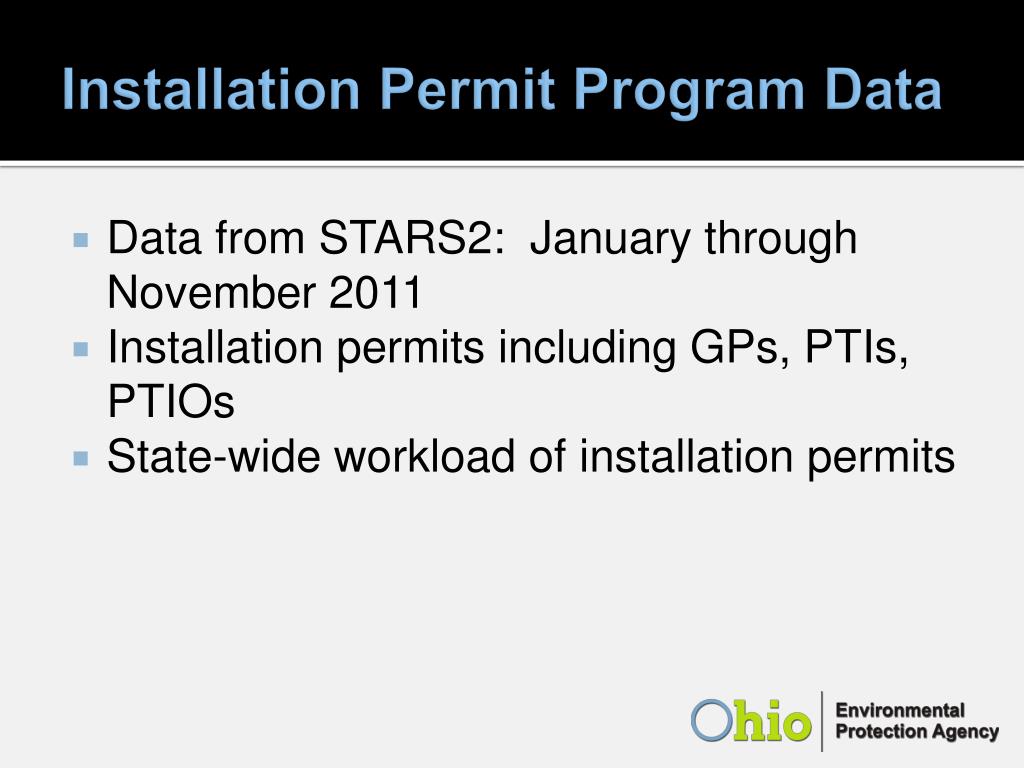

  4. Installation Permit Program Data • Data from STARS2: January through November 2011 • Installation permits including GPs, PTIs, PTIOs • State-wide workload of installation permits

  5. Installation Permits Processed • 585 Installation permits (GP & Non) • Included 1421 EUs • ~2.4 EU per Installation Permit • 95.8 avg OEPA days • 120.4 avg Total days

  6. Installation Permits Processed

  7. Installation Permits Workload

  8. 2012 Installation Permit Goals

  9. Installation Permit Goal Basis • Reduce workload to “no backlog” level • Reduce number of “old” permits • Meet 14-day Completeness review goal • Continue timely processing of CO reviews • Further develop high priority “high communication” process • Process Section Manager identified high priority permits using “high communication” process

  10. Tracking of DO/LAA 2012 Install Goals • Tracked through STARS2 Report • Management Reports… • Permits Status… • DO/LAA: select one • Types: PTI & PTIO • Reasons: Initial Installation & Chapter 31 Mod & Not Yet Assigned

  11. DO/Laa 2011 Install Goals *As of November 30, 2011, Old = DO/LAA/CO workflow >180

  12. Central Office Goals • Continue current practice of limited review and rapid turn-around (CO goal) • Develop guidance concerning when the “high communication” process is to be used, the process used and a revised fee procedure (CO goal) • Develop guidance concerning processing of “old” permits

  13. Operating Permit Workload and Goals

  14. First Two Charts • Gives actual number of TitleVs and non Title Vs issued • Shows all of 2010 plus through Sept. 2011 • Gives 5 month rolling numbers • Shows doubling production from 2010 rate

  15. Title V Renewals Processed

  16. Non Title V Renewals Issued

  17. Table • Table has been revised based on recent STARS2 data • Total renewal needed has dropped due to DO/LAA work to clean up data. • This means # of needed renewals per 6-month period for each DO/LAA has changed (dropped) from previous chart.

  18. Table • 7/1/11 to 12/31/11 data is up to end of November data. • 07/01/11 to 12/31/11 data does not include 01/01/11 to 06/30/11 data (not cumulated in that column).

  19. 01/01/11 to 10/31/11 Issued Permits 19

  20. Charts from Table Data • Charts do not take into account renewal permits that were: • Removed because they don’t need permits • Changed to other permit types • Removed from renewal category

  21. Title V Chart 21

  22. Non Title V Chart 22

  23. Summary of Table Data • Overall 2011 Title V goals on track • 38 Final Title V’s issued –vs- 48 needed in 7/1/11 to 12/31/11 period • 17 Title V PPs remain on November 30th • Fed 45-day waiver for PPs? • Making good progress on non-Title V Renewals: 394 –vs- 456 needed

  24. Charts to track remaining renewals • These charts track remaining renewals needing process vs. goals • Goals are the same as previous chart, just reversed to number of renewals remaining instead of cumulative number of permits needing processed.

  25. Charts to track remaining renewals • Charts do take into account renewal permits where it has been determined they no longer need to be processed. • So far, on track. • Will be more difficult as time goes on and we work on more difficult permits

  26. COBacklog Renewal work • First Round Volunteers – April, 2011 • -eight staff • - concrete batch plants, bodyshops, petroleum bulk plants, drycleaners, grain dryers/elevators, GDFs • Second Round – October, 2011 • - another eight staff • - new categories: storage tanks, electroplaters, degreasers, incinerators/crematoriums • 23 backlog permits issued to-date • 33 backlog permits to PBR to-date

  27. Current GPs Available • Active General Permits Available • See:  http://www.epa.ohio.gov/dapc/genpermit/genpermits.aspx • Aggregate Processing (2) • Boilers (14) • Compression Ignition Internal Combustion Engine (11) • PerchloroethyleneDrycleaning Operations (2) • Mineral Extraction (1) • Miscellaneous Metal Parts Painting Lines (7) • Paved Roadways and Parking Areas (4) • Ready Mix Concrete Batch Plants (2) • Storage Piles (2) • Unpaved Roadways and Parking Areas (2) • Tub Grinders (1) • Compression Ignition Internal Combustion Engine (2)

  28. Update on GP Work • General Permits Currently Under Development • Agricultural Digester (3) – comment period ended 11/28 • Oil/Gas well Site Production Operations (1) – comment period ended 11/28 • Petroleum Solvent Drycleaners (5) • Petroleum Loading Racks (2)

  29. Wrap-up • Questions?
