Transmission Transparency Workshop
210 likes | 334 Vues
On July 10, 2008, a significant workshop focused on the Northwest Gas Regional Initiative was held to strengthen transparency in the European gas market. Engaging all stakeholders from nine member states and beyond, this initiative aims to enhance gas trade and consumption efficiency. The workshop highlighted transparency, capacity, and investment objectives, addressing crucial issues such as gas flows, transmission capacity, and data publication. Stakeholder feedback is essential for refining implementation processes, with deadlines set for progress reports by the end of 2008.
Transmission Transparency Workshop
E N D
Presentation Transcript
Transmission Transparency Workshop European Strategy and Environment 10 July 2008

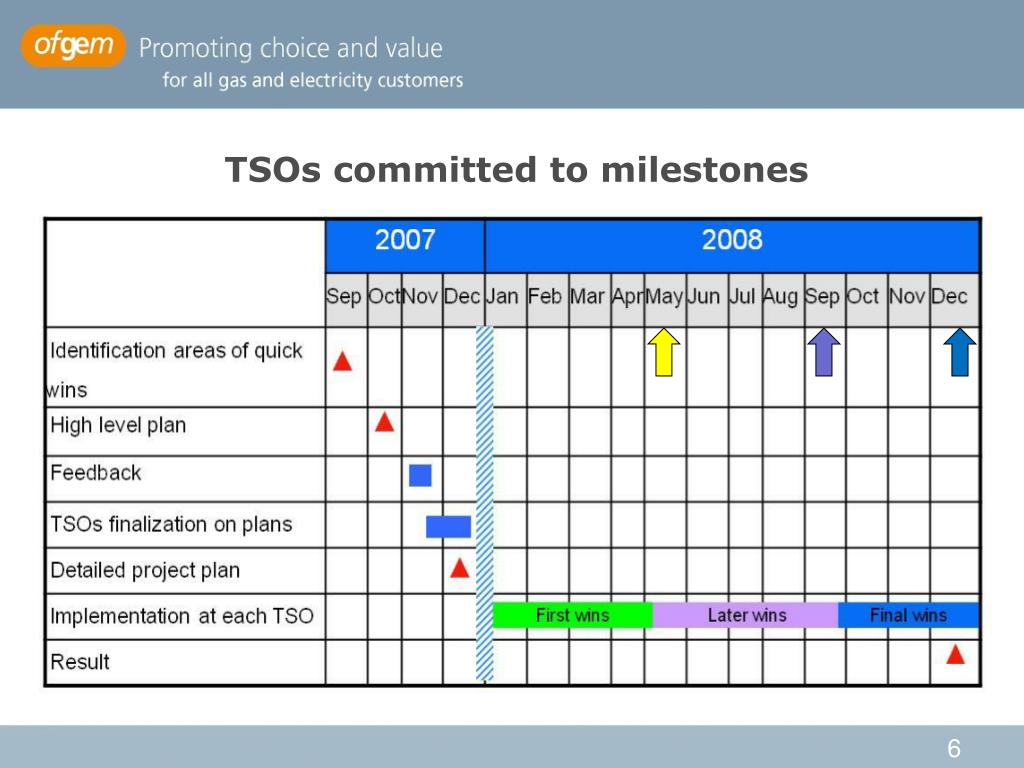

NW Gas Regional Initiative • Regional Initiatives • Started Spring 2006 • Practical bottom up approach to reform • Engage all stakeholders • North West Region • Nine Members (+ Norway) • Majority of European gas trade and consumption • Transparency • One of three priority areas • Transparency • Capacity • Investment Objective: overcome barriers to gas trade between Member States on a non-discriminatory basis
Participating TSOs Denmark France Ireland Netherlands Germany Belgium ? United Kingdom Sweden Northern Ireland

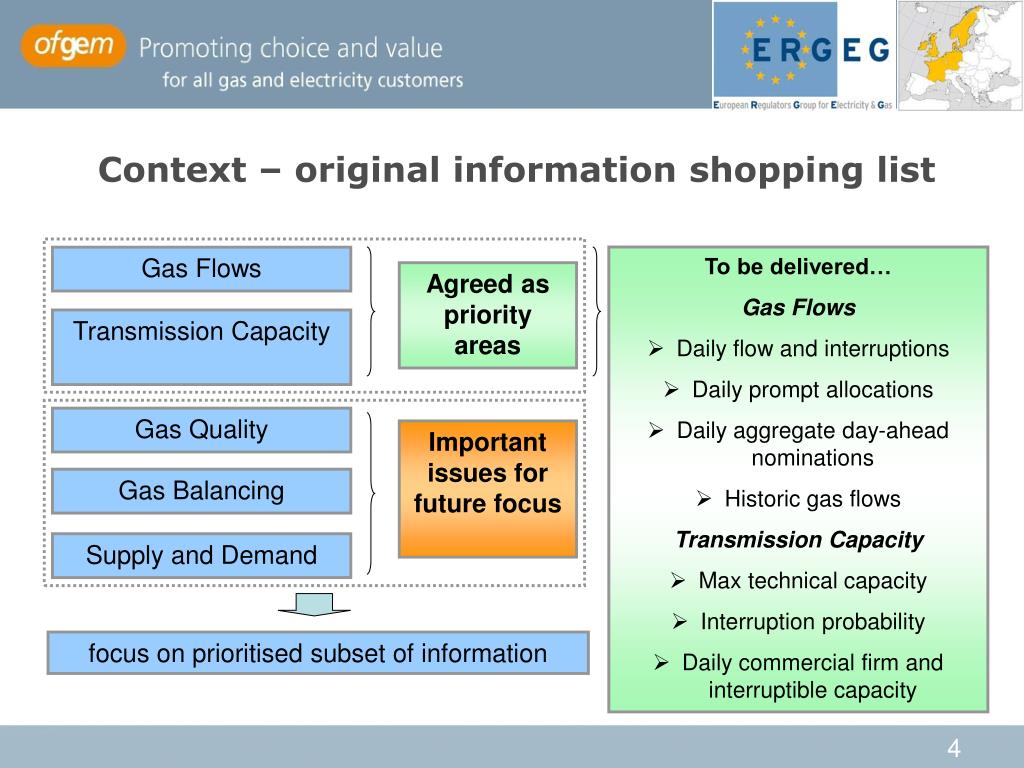

Context – original information shopping list • To be delivered… • Gas Flows • Daily flow and interruptions • Daily prompt allocations • Daily aggregate day-ahead nominations • Historic gas flows • Transmission Capacity • Max technical capacity • Interruption probability • Daily commercial firm and interruptible capacity Gas Flows Agreed as priority areas Transmission Capacity Gas Quality Important issues for future focus Gas Balancing Supply and Demand focus on prioritised subset of information

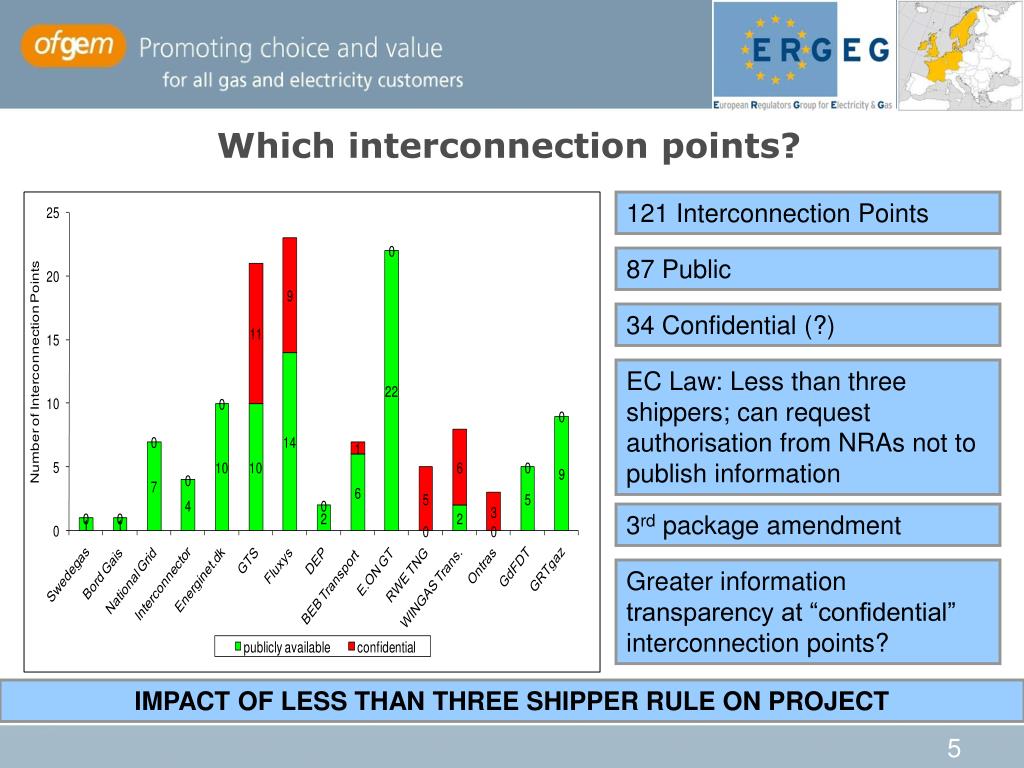

Which interconnection points? 121 Interconnection Points 87 Public 34 Confidential (?) EC Law: Less than three shippers; can request authorisation from NRAs not to publish information 3rd package amendment Greater information transparency at “confidential” interconnection points? IMPACT OF LESS THAN THREE SHIPPER RULE ON PROJECT

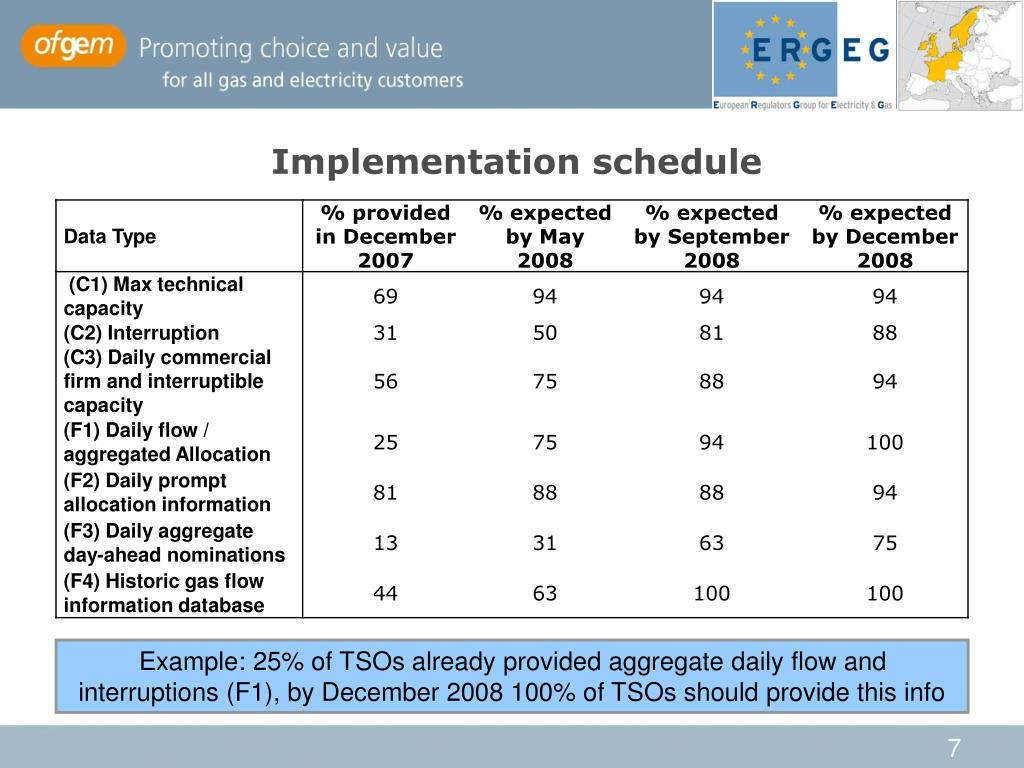

Implementation schedule Example: 25% of TSOs already provided aggregate daily flow and interruptions (F1), by December 2008 100% of TSOs should provide this info
Implementation progress: May 2008 MIXED PROGRESS: ON TRACK IN 3 BUT BEHIND SCHEDULE ON 4

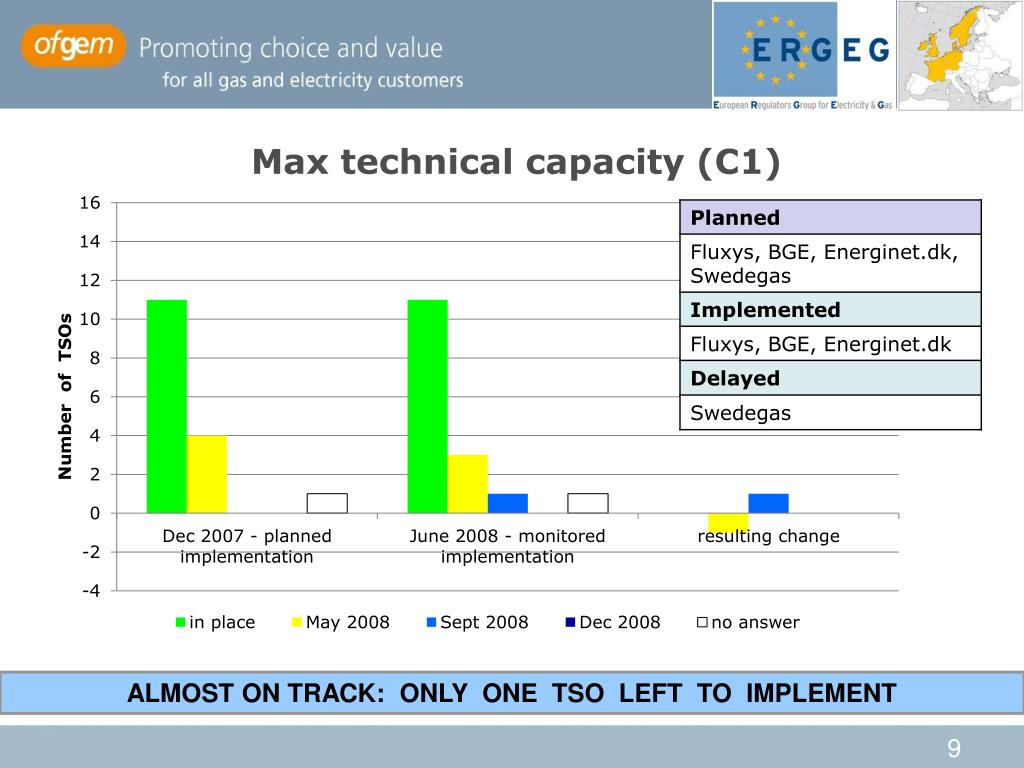

Max technical capacity (C1) ALMOST ON TRACK: ONLY ONE TSO LEFT TO IMPLEMENT

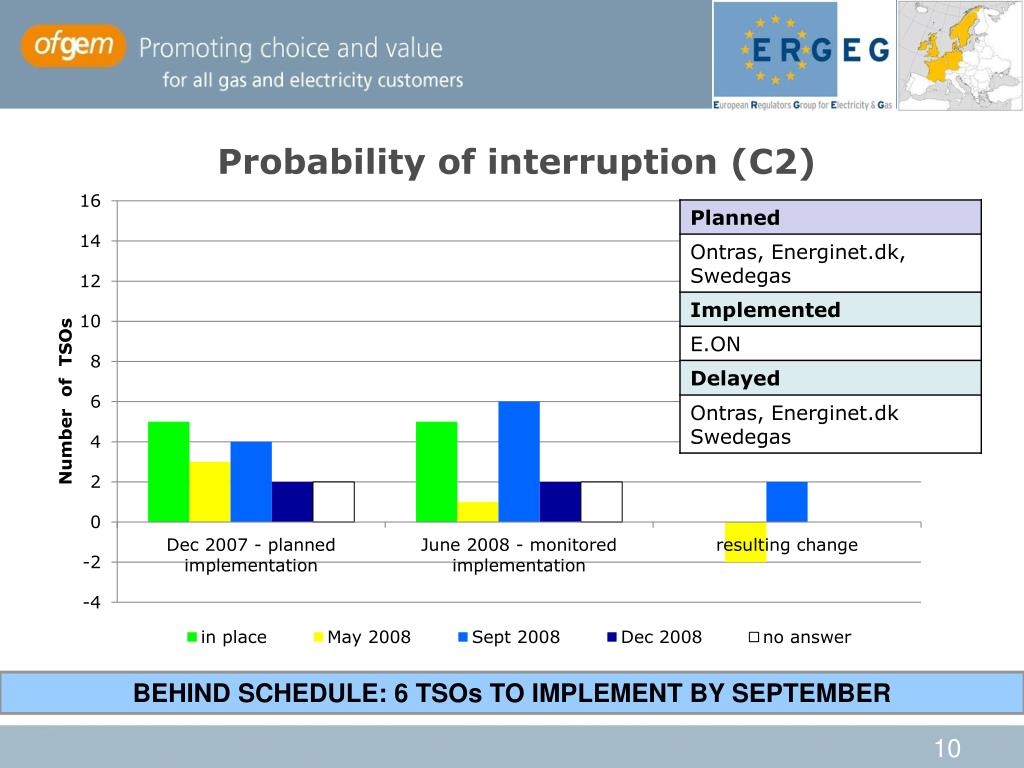

Probability of interruption (C2) BEHIND SCHEDULE: 6 TSOs TO IMPLEMENT BY SEPTEMBER
Daily commercial firm and interruptible capacity (C3) ROUGHLY ON TRACK: ONE TSO IMLPEMENTED EARLY ONE TSO FAILED

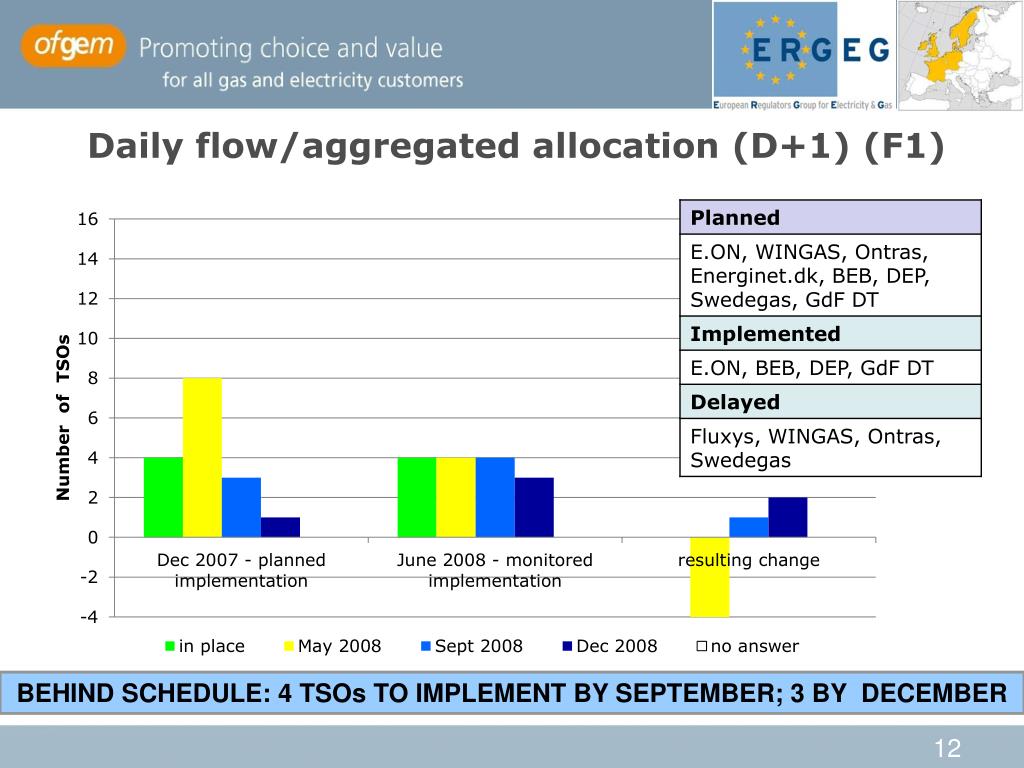

Daily flow/aggregated allocation (D+1) (F1) BEHIND SCHEDULE: 4 TSOs TO IMPLEMENT BY SEPTEMBER; 3 BY DECEMBER

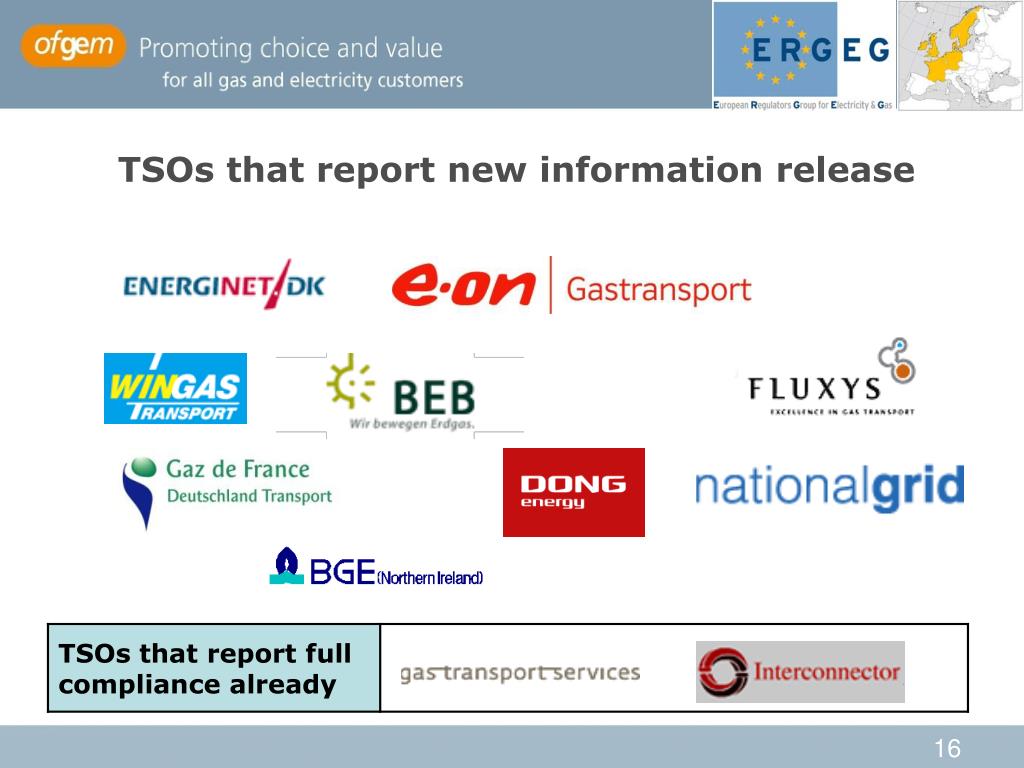

Daily prompt allocation information (F2) ON TRACK: ALL TSOs NOW REPORT TO PROVIDE THIS INFORMATION
Daily aggregate day ahead nominations (F3) BEHIND SCHEDULE: 3 TSOs PROVIDE NO ANSWER ON IMPLEMENTATION

Historic gas flow database (F4) ON TRACK: 5 TSOs STILL NEED TO IMPLEMENT THIS INFORMATION

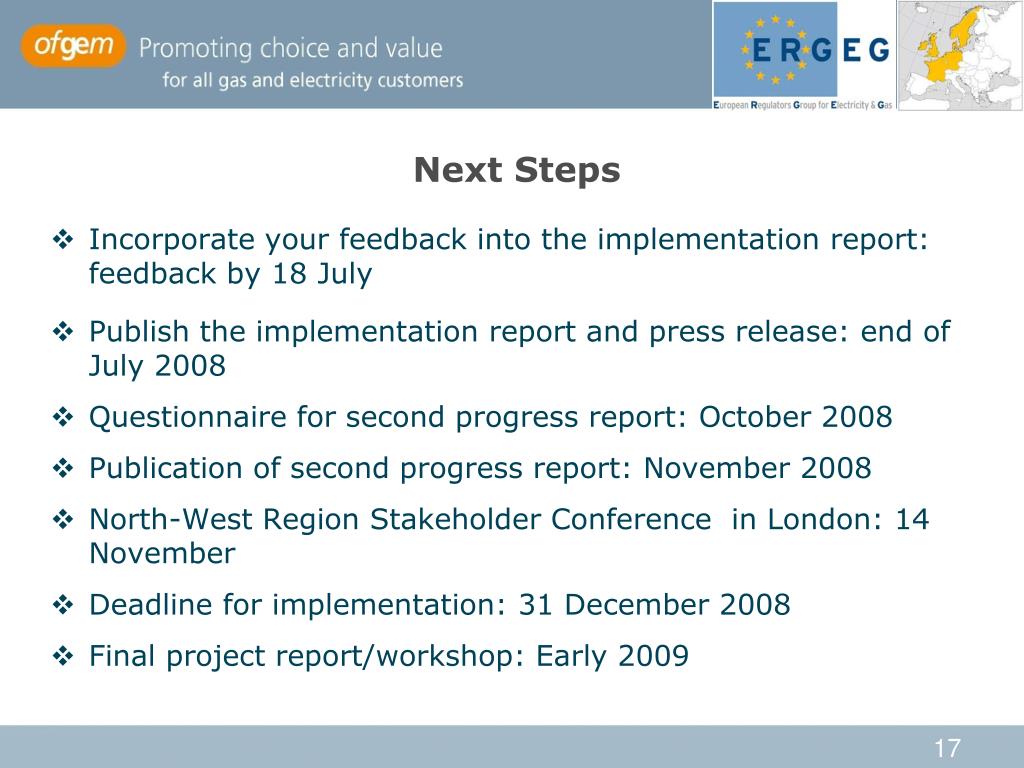

Next Steps • Incorporate your feedback into the implementation report: feedback by 18 July • Publish the implementation report and press release: end of July 2008 • Questionnaire for second progress report: October 2008 • Publication of second progress report: November 2008 • North-West Region Stakeholder Conference in London: 14 November • Deadline for implementation: 31 December 2008 • Final project report/workshop: Early 2009
Key issues Implementation accuracy • At which interconnection points will the relevant data be published? • Are the definitions for each data type appropriate? • Has there been any further progress since May? User views • Network user feedback on accessibility and usefulness of the data • Improvements to project management and reporting • Any other key issues? TSO feedback • Reasons for delays in releasing new data • Re-confirmation of implementation commitment
Risks to successful project? • How will we handle delays in project implementation? • First implementation report and press release to be published at the end of July • Second and final implementation reports published in November and early 2009 • Updates at GRI Stakeholder(November 2008) and Madrid Fora • Escalation of concerns? • National regulators to engage with TSOs • Engage Programme Boardin project implementation • Timelines to be revised?
BIG THANK YOU TO ALL STAKEHOLDERS! PROJECT WOULD NOT BE POSSIBLE WITHOUT POSITIVE AND ACTIVE PARTICIPATION OF ALL THOSE INVOLVED WANT POSITIVE OUTCOME FOR EVERYBODY
