Online Overview

Online Overview. L. Coney – UCR MICE CM35 – Feb 2013. Also in This Session:. Controls & Monitoring – Pierrick DAQ – Yordan Online MAUS – Alex Richards MICE Computing – Chris Rogers Will leave the specifics to them.. Note: Online focus here – Operations focus tomorrow.

nevan
Télécharger la présentation

Online Overview

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Online Overview L. Coney – UCR MICE CM35 – Feb 2013

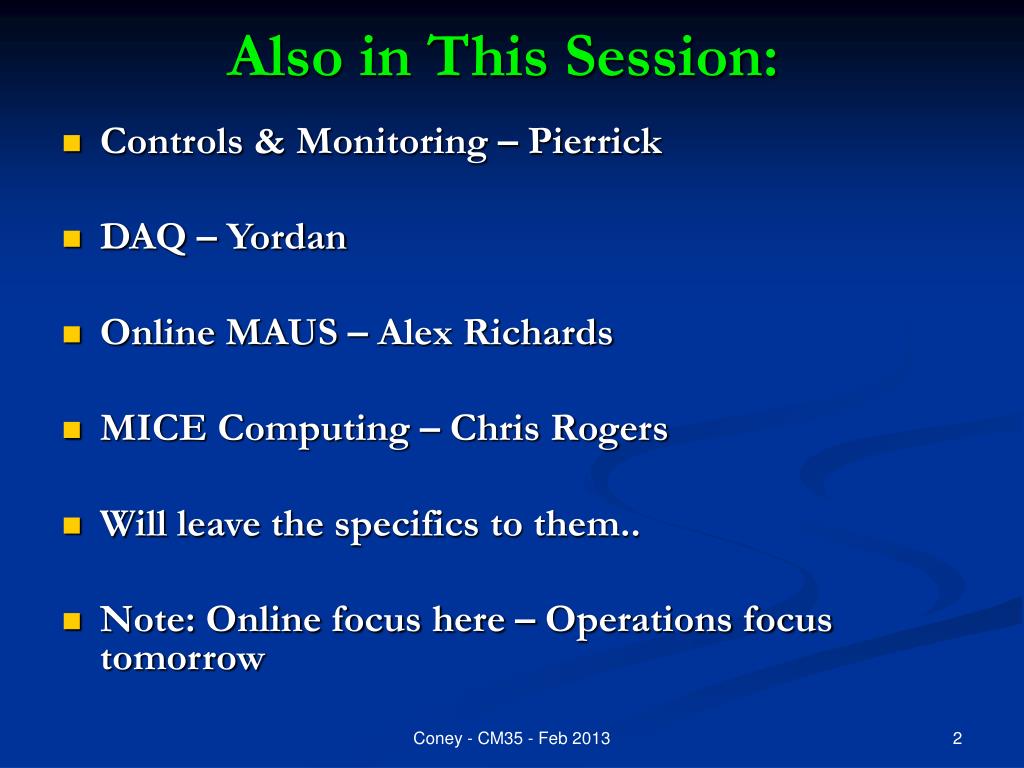

  2. Also in This Session: • Controls & Monitoring – Pierrick • DAQ – Yordan • Online MAUS – Alex Richards • MICE Computing – Chris Rogers • Will leave the specifics to them.. • Note: Online focus here – Operations focus tomorrow Coney - CM35 - Feb 2013

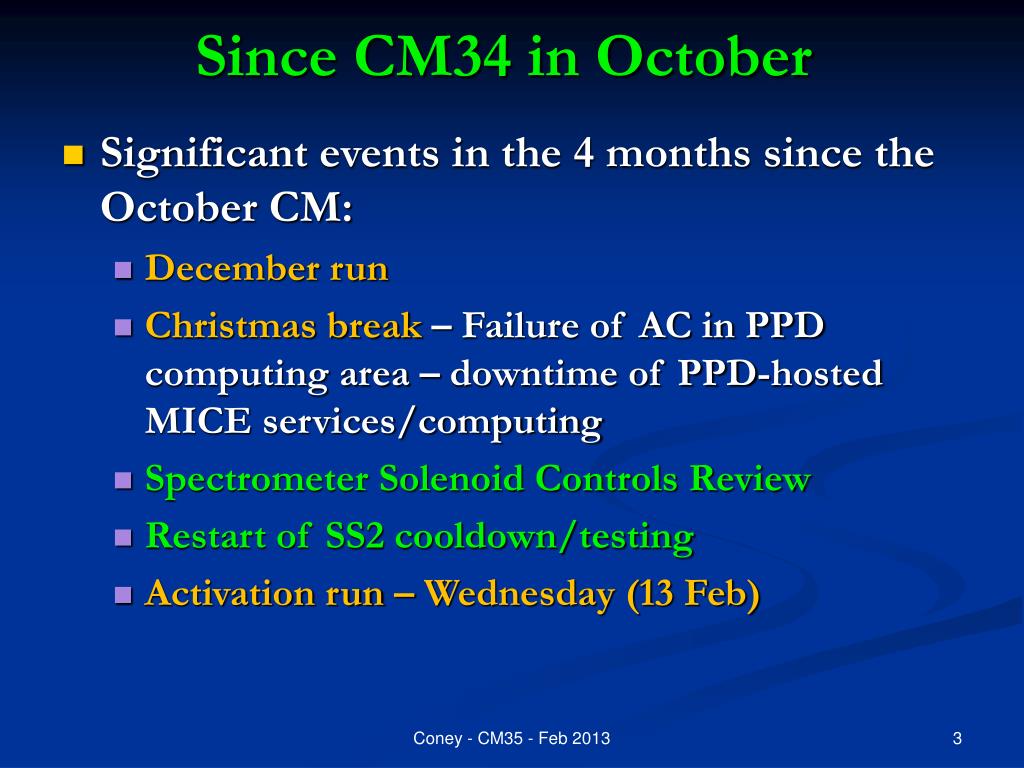

  3. Since CM34 in October • Significant events in the 4 months since the October CM: • December run • Christmas break – Failure of AC in PPD computing area – downtime of PPD-hosted MICE services/computing • Spectrometer Solenoid Controls Review • Restart of SS2 cooldown/testing • Activation run – Wednesday (13 Feb) Coney - CM35 - Feb 2013

  4. December Run • Did not go smoothly • Similar to October run issues • Problems with DAQ • Worked initially but problems developed • Unable to solve remotely • Problems with C&M • HV control applications • Run Control • Problems with Online Monitoring – gone • Prompted evaluation of reliability within Online Systems • Need develop more robust pre-run procedures for DAQ, C&M, Online Reconstruction • Need DAQ pulser trigger • Need higher priority on documentation • More than one person to solve problems – must do better on handover of information Coney - CM35 - Feb 2013

  5. December Run • Need fake data (more than cosmics) – test full chain of DAQ, unpacker, Online Reco • fake signals from TOFs? – no LED system ‘yet’ • Tracker will have LEDs • Emphasized the need for additional expertise • Personnel changes: • New network village manager – Chris Brew (RAL) • New RAL network liaison – Antony Wilson (RAL) • New DAQ deputy – David Adey (FNAL) • New Online Monitoring owner – Rhys Gardner (Brunel grad student) • New C&M deputy – ??????????? Coney - CM35 - Feb 2013

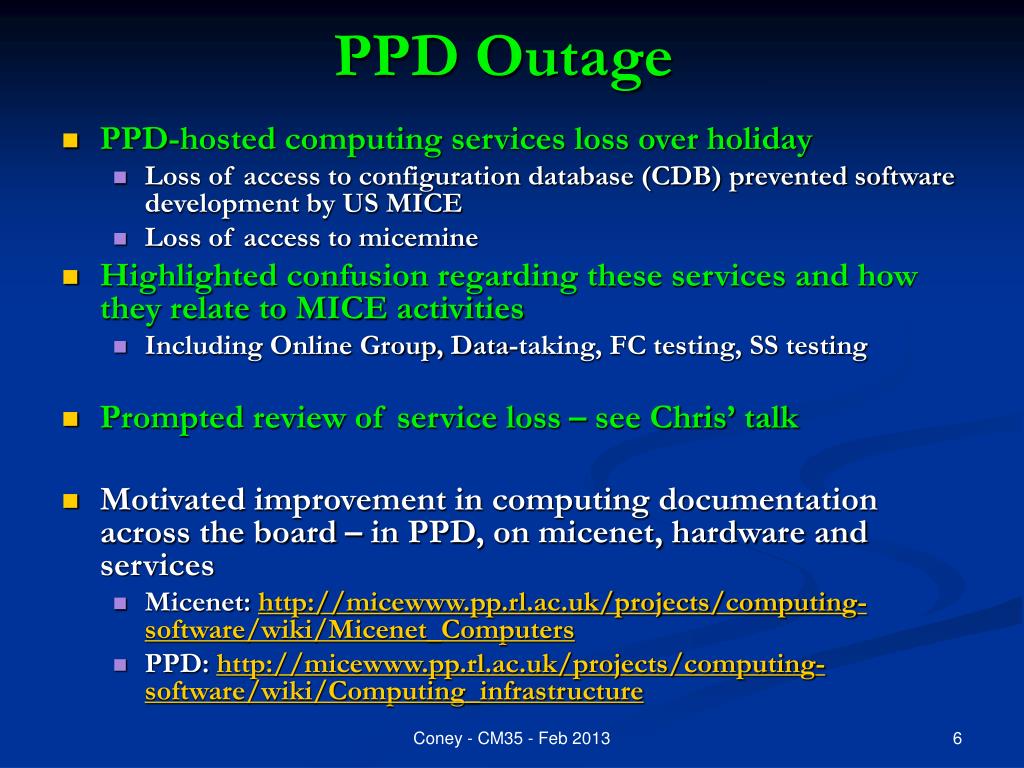

  6. PPD Outage • PPD-hosted computing services loss over holiday • Loss of access to configuration database (CDB) prevented software development by US MICE • Loss of access to micemine • Highlighted confusion regarding these services and how they relate to MICE activities • Including Online Group, Data-taking, FC testing, SS testing • Prompted review of service loss – see Chris’ talk • Motivated improvement in computing documentation across the board – in PPD, on micenet, hardware and services • Micenet: http://micewww.pp.rl.ac.uk/projects/computing-software/wiki/Micenet_Computers • PPD: http://micewww.pp.rl.ac.uk/projects/computing-software/wiki/Computing_infrastructure Coney - CM35 - Feb 2013

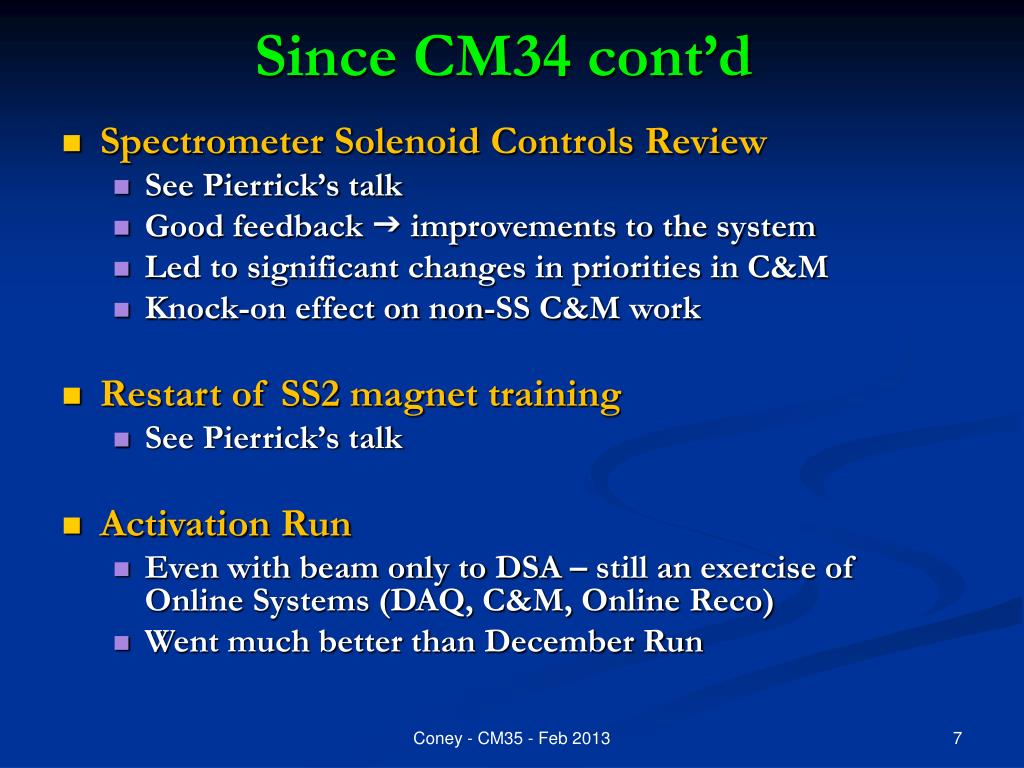

  7. Since CM34 cont’d • Spectrometer Solenoid Controls Review • See Pierrick’s talk • Good feedback g improvements to the system • Led to significant changes in priorities in C&M • Knock-on effect on non-SS C&M work • Restart of SS2 magnet training • See Pierrick’s talk • Activation Run • Even with beam only to DSA – still an exercise of Online Systems (DAQ, C&M, Online Reco) • Went much better than December Run Coney - CM35 - Feb 2013

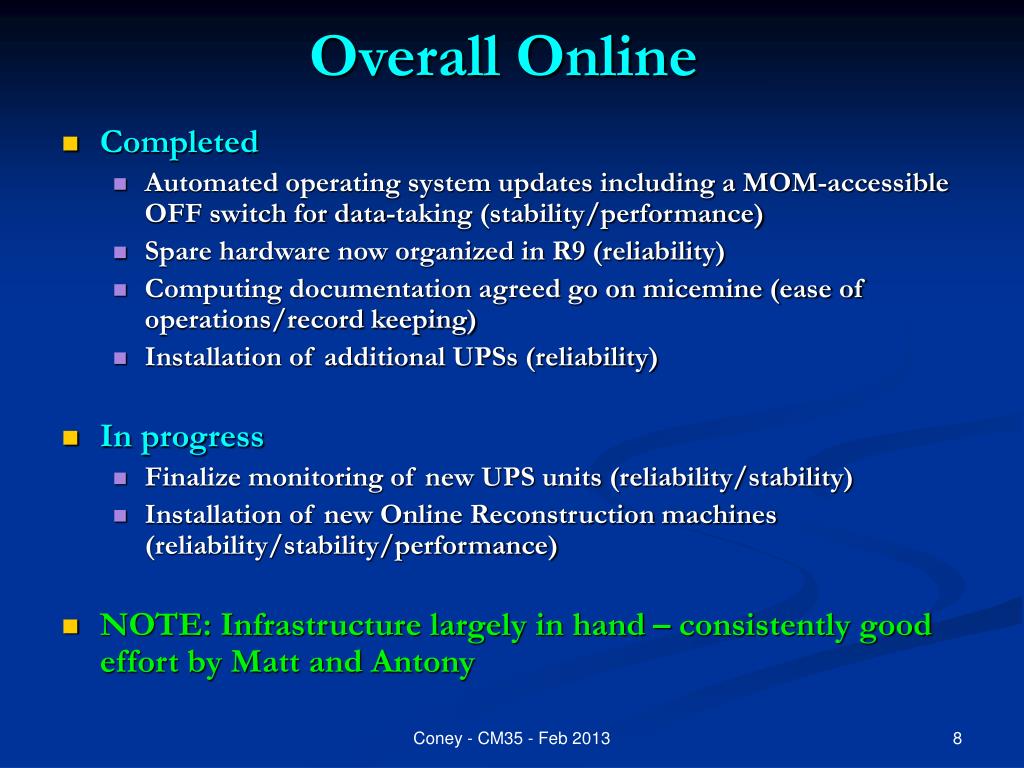

  8. Overall Online • Completed • Automated operating system updates including a MOM-accessible OFF switch for data-taking (stability/performance) • Spare hardware now organized in R9 (reliability) • Computing documentation agreed go on micemine (ease of operations/record keeping) • Installation of additional UPSs (reliability) • In progress • Finalize monitoring of new UPS units (reliability/stability) • Installation of new Online Reconstruction machines (reliability/stability/performance) • NOTE: Infrastructure largely in hand – consistently good effort by Matt and Antony Coney - CM35 - Feb 2013

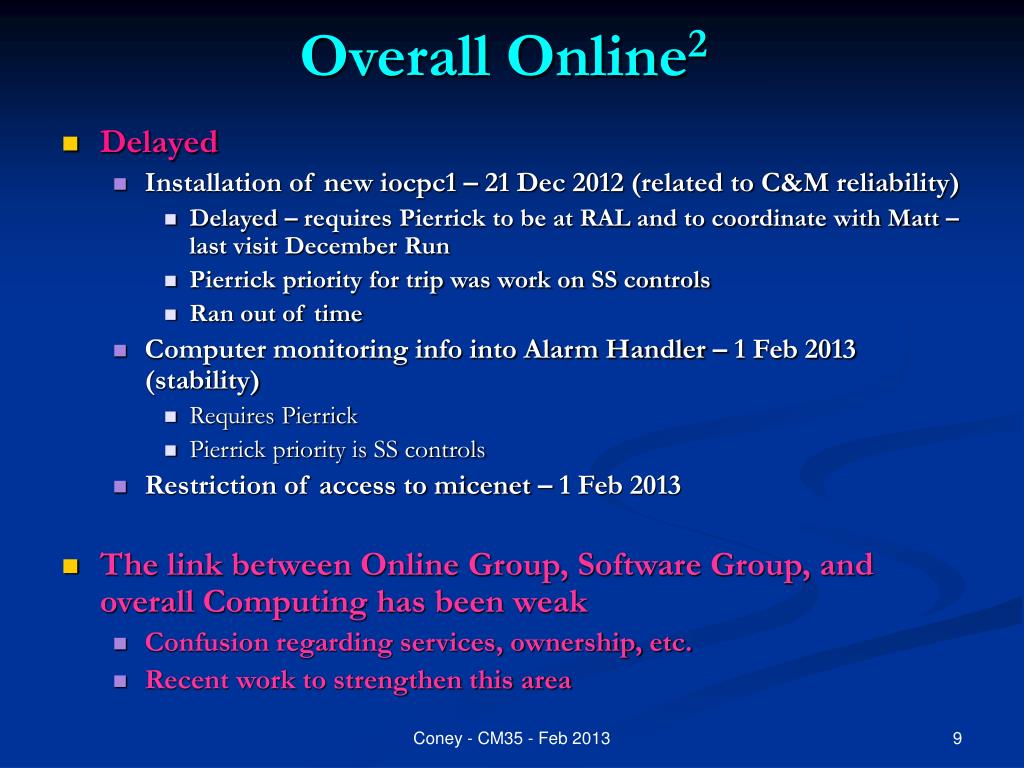

  9. Overall Online2 • Delayed • Installation of new iocpc1 – 21 Dec 2012 (related to C&M reliability) • Delayed – requires Pierrick to be at RAL and to coordinate with Matt – last visit December Run • Pierrick priority for trip was work on SS controls • Ran out of time • Computer monitoring info into Alarm Handler – 1 Feb 2013 (stability) • Requires Pierrick • Pierrick priority is SS controls • Restriction of access to micenet – 1 Feb 2013 • The link between Online Group, Software Group, and overall Computing has been weak • Confusion regarding services, ownership, etc. • Recent work to strengthen this area Coney - CM35 - Feb 2013

  10. MICE must be able to take data without connection to services or computing external to micenet Strengths Use primary CDB – located in MLCR Can store data in MLCR for days (so far none deleted from local storage although is all on GRID) Use local EPICS, Alarm Handler, and Archiver for C&M DAQ local Online Reco uses local MAUS installation Weaknesses Elog – hosted on PPD – useful but not critical Micemine – hosted on PPD – run plans, documentation, etc. – useful but not critical Data g GRID (see above) External expert access – Archiver, EPICS gateway, mousehole – convenience rather than necessity Conclusions Current arrangement of services works well MICE data-taking not at risk Online Systems 1 Other Computing Coney - CM35 - Feb 2013

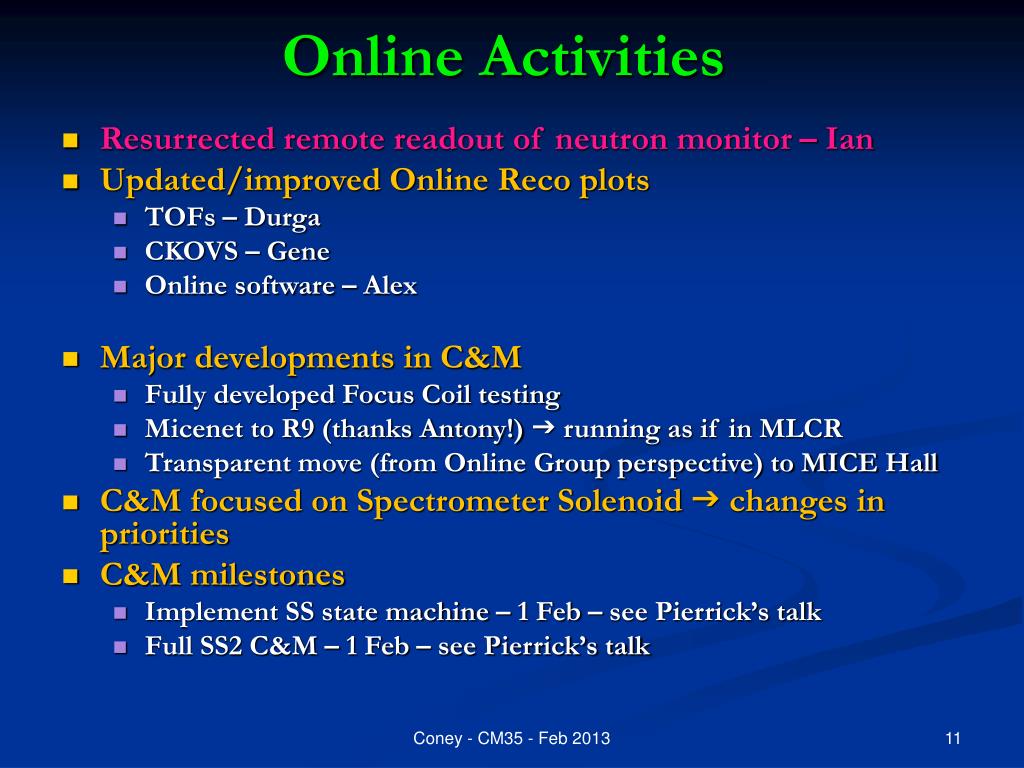

  11. Online Activities • Resurrected remote readout of neutron monitor – Ian • Updated/improved Online Reco plots • TOFs – Durga • CKOVS – Gene • Online software – Alex • Major developments in C&M • Fully developed Focus Coil testing • Micenet to R9 (thanks Antony!) g running as if in MLCR • Transparent move (from Online Group perspective) to MICE Hall • C&M focused on Spectrometer Solenoid g changes in priorities • C&M milestones • Implement SS state machine – 1 Feb – see Pierrick’s talk • Full SS2 C&M – 1 Feb – see Pierrick’s talk Coney - CM35 - Feb 2013

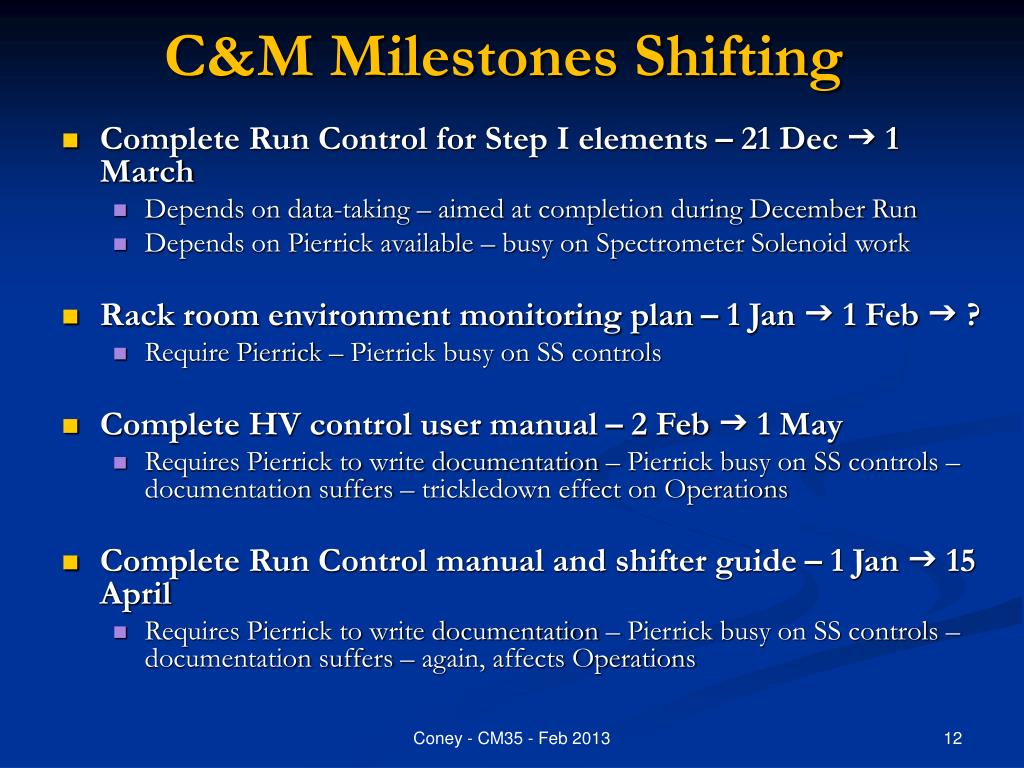

  12. C&M Milestones Shifting • Complete Run Control for Step I elements – 21 Dec g 1 March • Depends on data-taking – aimed at completion during December Run • Depends on Pierrick available – busy on Spectrometer Solenoid work • Rack room environment monitoring plan – 1 Jan g 1 Feb g ? • Require Pierrick – Pierrick busy on SS controls • Complete HV control user manual – 2 Feb g 1 May • Requires Pierrick to write documentation – Pierrick busy on SS controls – documentation suffers – trickledown effect on Operations • Complete Run Control manual and shifter guide – 1 Jan g 15 April • Requires Pierrick to write documentation – Pierrick busy on SS controls – documentation suffers – again, affects Operations Coney - CM35 - Feb 2013

  13. C&M Milestones cont’d • Bench test pneumatic proton absorber controls – 1 April g 1 May • Requires Pierrick – busy on SS controls • Install pneumatic proton absorber controls – 15 April g maybe 1 June • Requires Pierrick – busy • Requires ISIS shutdown: April 1-28 or June 17-30 • Implement DS state-based Alarm Handler – 1 Feb g 15 June • Priority for first state-based system shifted from DS to SS • New HV control – 15 Jan g 1 May • Requires Pierrick & slow communication with CAEN – Pierrick busy • FC C&M review – 15 Feb • Depends on Pierrick availability and travel capability – not happening today • WE NEED ANOTHER C&M PERSON! Coney - CM35 - Feb 2013

  14. Online Reco • Improved TOF & CKOV online plots – 21 Dec 2012 – DONE • Requires data-taking with beam to completely vet new plots – therefore tied into December Run • Install new online reco machines – 1 Feb 2013 • Likely to finish roughly on time – required new order by UniGeneve – installation now during Yordan’s MOM term • KL online plots – 15 April 2013 g 1 June 2013 • No real online plot participation by KL group • Anticipate possible KL plots available after PID paper done? • EMR online plots – 15 April 2013 g 1 June 2013 • EMR schedule slipped – online plots follow hardware completion • NOTE: KL online plots is a guess – no participation = no plots = no info Coney - CM35 - Feb 2013

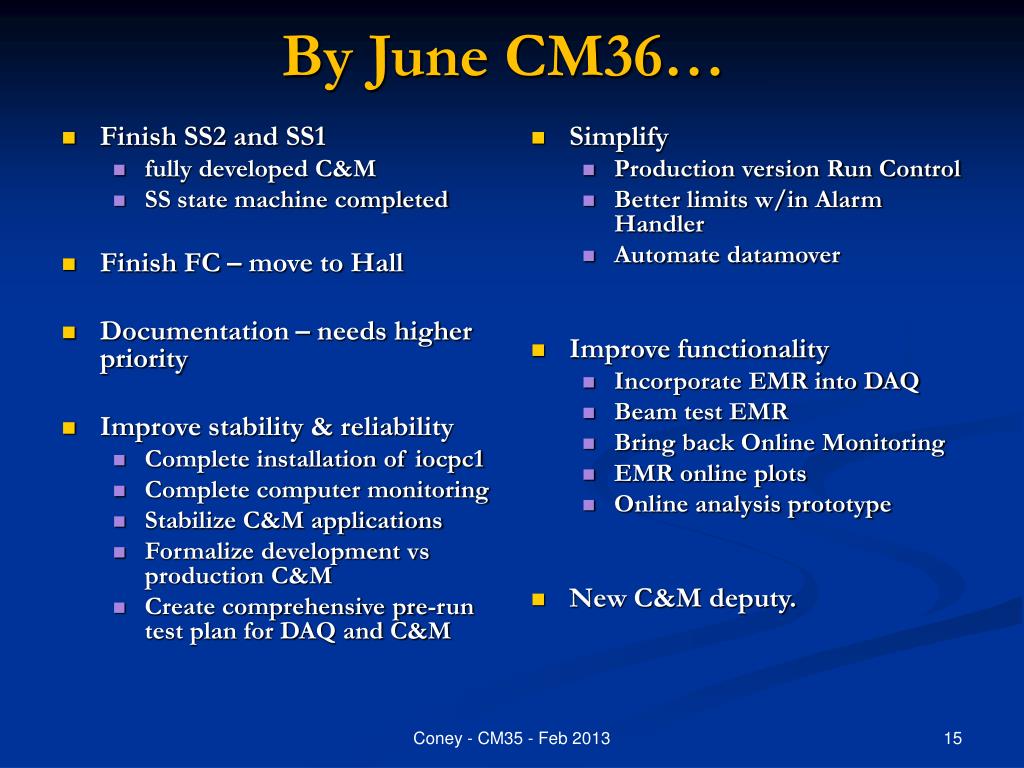

  15. Finish SS2 and SS1 fully developed C&M SS state machine completed Finish FC – move to Hall Documentation – needs higher priority Improve stability & reliability Complete installation of iocpc1 Complete computer monitoring Stabilize C&M applications Formalize development vs production C&M Create comprehensive pre-run test plan for DAQ and C&M Simplify Production version Run Control Better limits w/in Alarm Handler Automate datamover Improve functionality Incorporate EMR into DAQ Beam test EMR Bring back Online Monitoring EMR online plots Online analysis prototype New C&M deputy. By June CM36… Coney - CM35 - Feb 2013

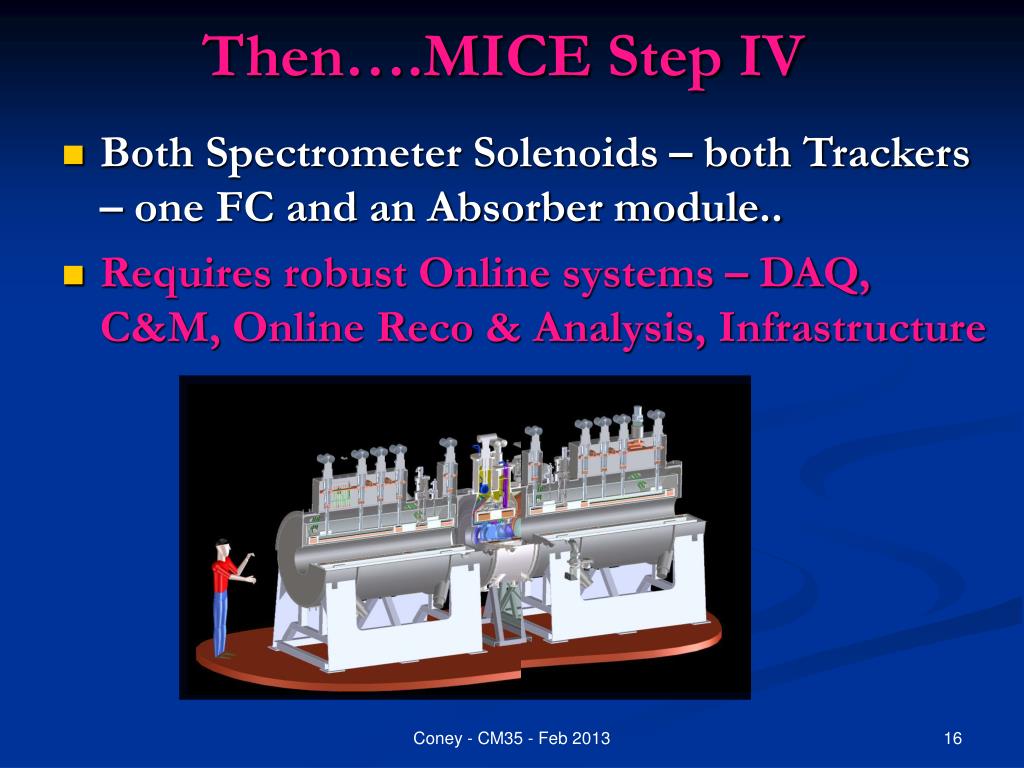

  16. Then….MICE Step IV • Both Spectrometer Solenoids – both Trackers – one FC and an Absorber module.. • Requires robust Online systems – DAQ, C&M, Online Reco & Analysis, Infrastructure Coney - CM35 - Feb 2013

  17. Coney - CM35 - Feb 2013
