This document outlines the structured implementation of the SiteManager system by the Oklahoma Department of Transportation (ODOT). Featuring a centralized agency structure with 2,450 employees across 8 field divisions, ODOT's goal is to enhance contract management by replacing the CAS/FieldManager with SiteManager. The implementation methodology is detailed in phases, focusing on construction and materials analysis, business process reorganization, user training, and user acceptance testing. The project emphasizes stakeholder engagement, customization, and continuous improvement through selected implementation lessons learned.
E N D
SiteManager Implementation Oklahoma Department of Transportation Charles Thurmon

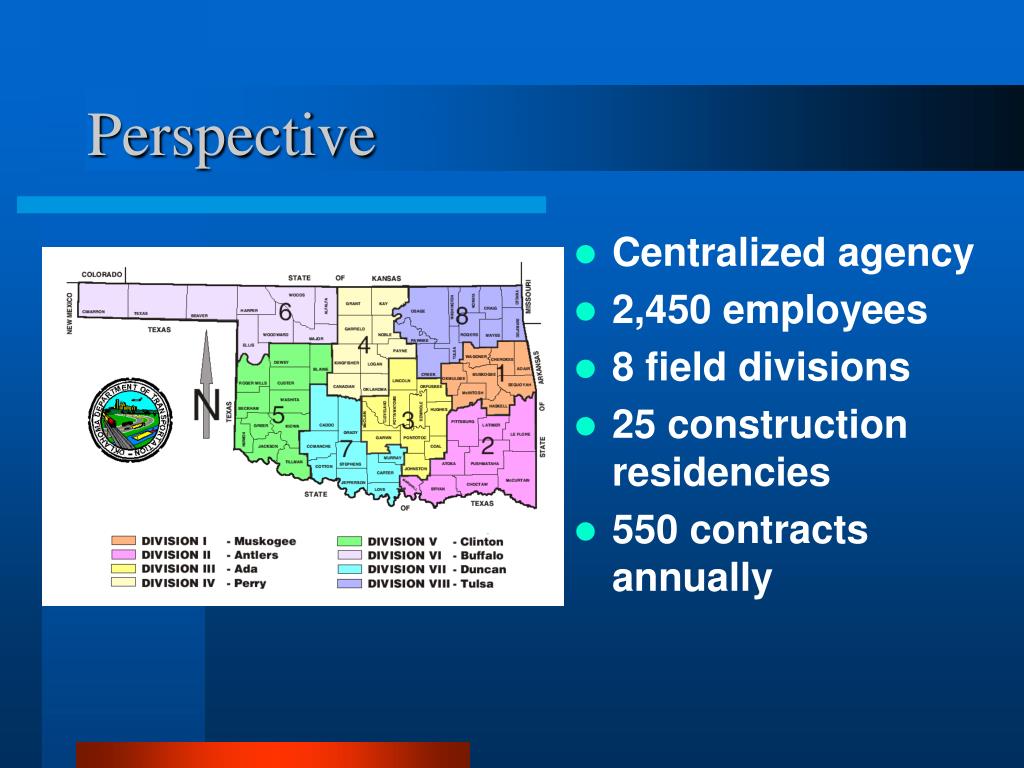

Perspective • Centralized agency • 2,450 employees • 8 field divisions • 25 construction residencies • 550 contracts annually
Implementation Goals • Install SiteManager • Discontinue the use of CAS/FieldManager • Obtain user buy-in

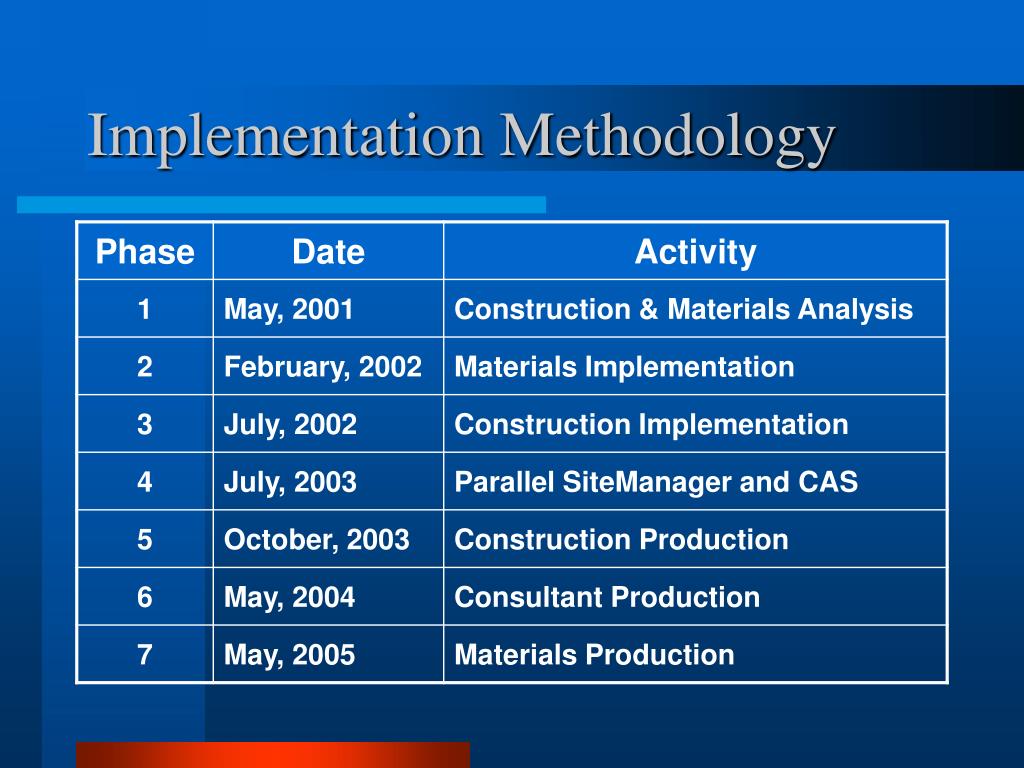

Implementation Methodology • Phase 1 - Construction & Materials analysis • Defined implementation cause • Defined current Construction and Materials processes • Defined our stakeholders and relational processes • Cost analysis
Implementation Methodology • Phase II – Materials Implementation • Began material code decisions • Began defining material test templates • Began populating the inspector and tester tables • Began populating system code tables for materials • Began populating producer/supplier tables • Business process reorganization
Implementation Methodology • Phase II – Other Activities • Created issues and resolutions document • Test environment created • SiteManager Support System created • Obtained PowerBuilder
Implementation Methodology • Phase III – Construction Implementation • InSite team formed • Construction decisions • Change and transition management • Customized RTF reports • User acceptance testing
Implementation Methodology • Phase III – Construction Implementation • Support hierarchy defined • Plug-ins developed • Generic field customizations • SiteXchange • Extract files for financial system

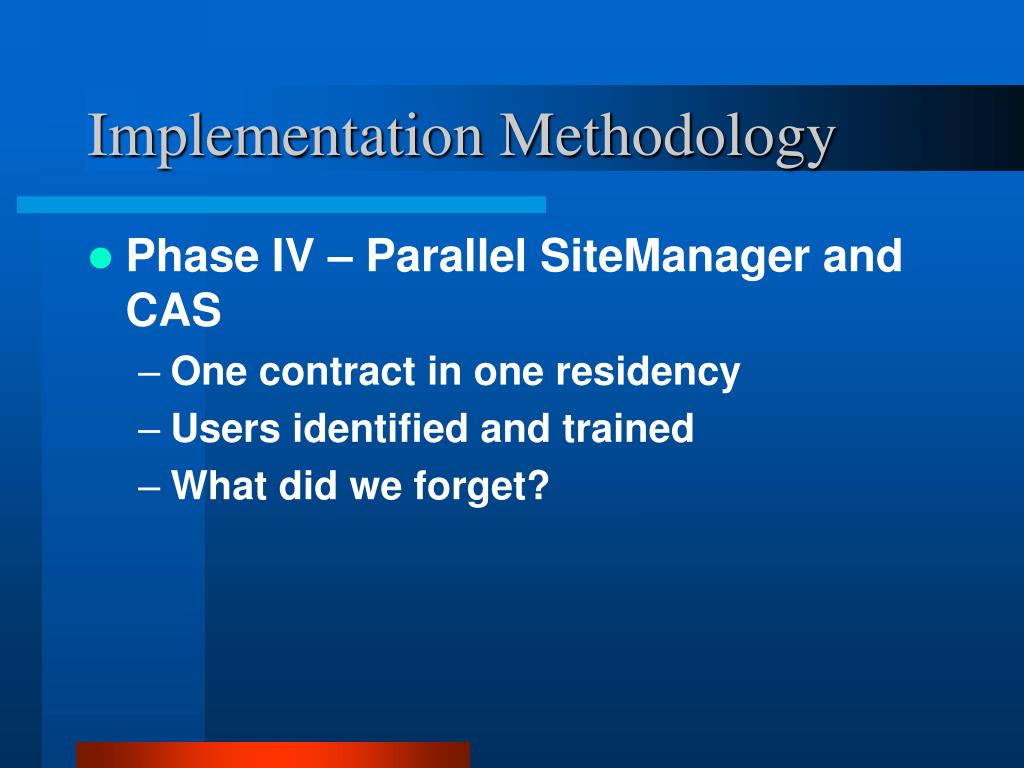

Implementation Methodology • Phase IV – Parallel SiteManager and CAS • One contract in one residency • Users identified and trained • What did we forget?
Implementation Methodology • Phase V – Production • Will begin in October • One or two field divisions per month • Assessment period
Implementation Methodology • Phase VI – Consultant Production • Security agreement letter • Network securities • Installation of SiteManager • Training & Support
Implementation Methodology • Phase VII – Materials Production • Begin using materials functionality of SiteManager
InSite Organization • 18 members • Resident Engineers, IT Personnel, Assistant Division Engineers, Auditors • SiteManager & system administration training • ITI liaisons • Held monthly meetings
Change Orders Civil Rights Communications Contract Activation/Subcontracts Contract Finalization/Final Estimate Process Contract Materials Daily Work Reports Division Analysis DWR Templates FieldManager/SiteManager Interface Division Analysis DWR Templates Financial Management Systems Progressive Estimate/Time Charges Technical Issues 1 Technical Issues 2 Technical Issues 3 Training InSite Committees
InSite Member Responsibilities • Determine process and procedure • Determine necessary reports • Populate system code tables • Determine policy
Lessons Learned • Implementation Team(InSite) • Define resolution hierarchy • Include appropriate and knowledgeable team members • Establish accountability • Select members with leadership skills • Have regular meetings • Get SiteManager training ASAP
Lessons Learned • Communications • Electronic bulletin board • Road shows • Access & Centerline segments • DWR & Materials Templates • Start ASAP • Obtain and learn PowerBuilder
Lessons Learned • Training • Establish policies and procedures first • Customized training materials • “Just-in-time” training • Office experts
