Extension of Rescheduling based on Minimal Graph Cut

Extension of Rescheduling based on Minimal Graph Cut. Mari án Lekavý and Pavol N ávrat. Slovak University of Technology Faculty of Informatics and Information Technologies. Presentation outline. Rescheduling RAPORT overview The rescheduling algorithm Future and Conclusions. Rescheduling.

Télécharger la présentation

Extension of Rescheduling based on Minimal Graph Cut

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Extension of Reschedulingbased onMinimal Graph Cut Marián Lekavý and Pavol Návrat Slovak University of TechnologyFaculty of Informatics and Information Technologies

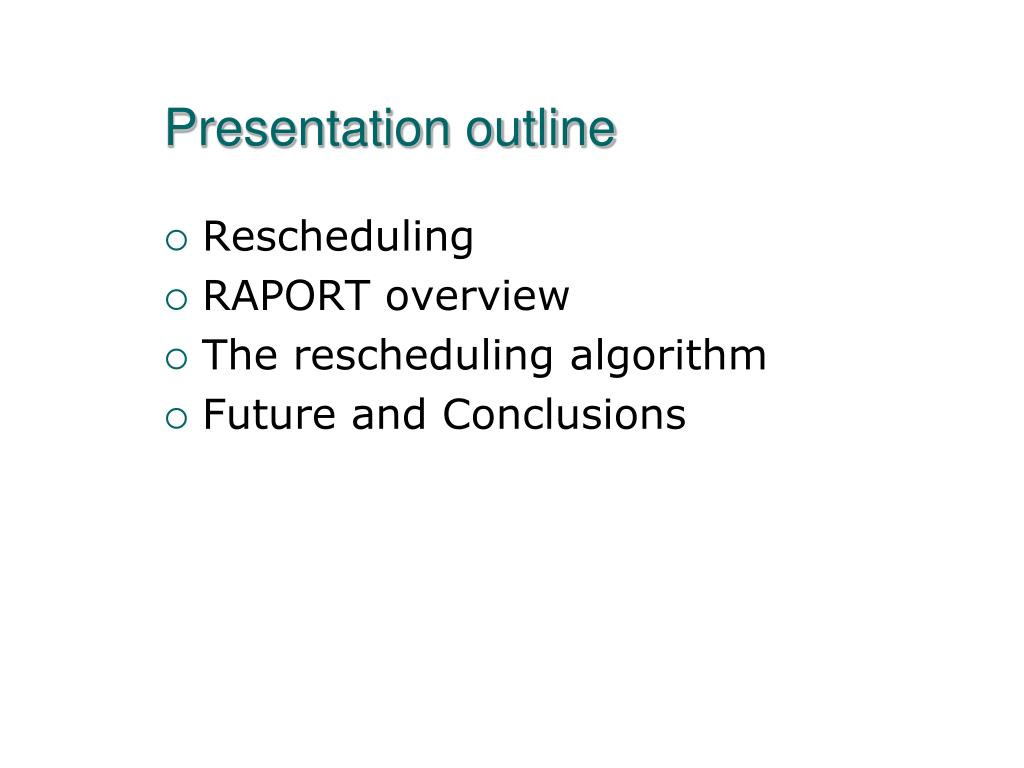

  2. Presentation outline • Rescheduling • RAPORT overview • The rescheduling algorithm • Future and Conclusions

  3. Rescheduling • Schedule is not 100% respected • Move/shorten activities • Minimize the cost of rescheduling

  4. Rescheduling • Approaches • Enforce schedule • Include all possibilities • New schedule • Modify the old schedule

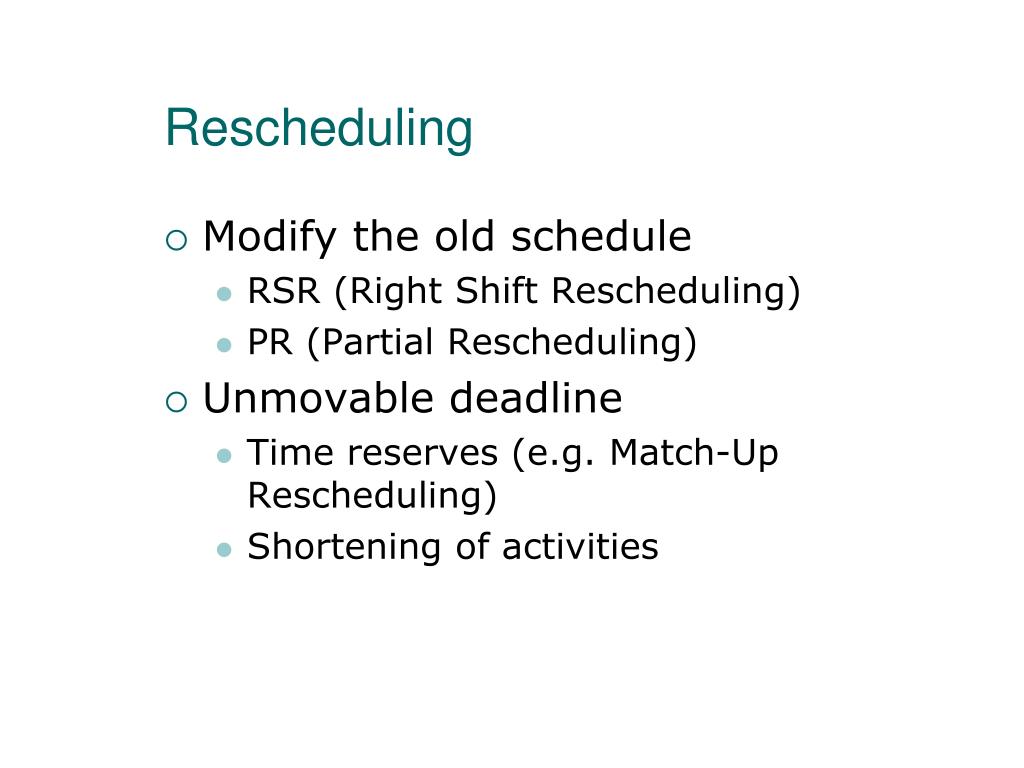

  5. Rescheduling • Modify the old schedule • RSR (Right Shift Rescheduling) • PR (Partial Rescheduling) • Unmovable deadline • Time reserves (e.g. Match-Up Rescheduling) • Shortening of activities

  6. RAPORT • Workflow system • Support formilitary exercise preparation • Tasks of the RAPORT system • Provide necessary information • Support collaboration • Adapt the schedule • Collect users’ experience

  7. RAPORT • Activities and documents in the RAPORT system

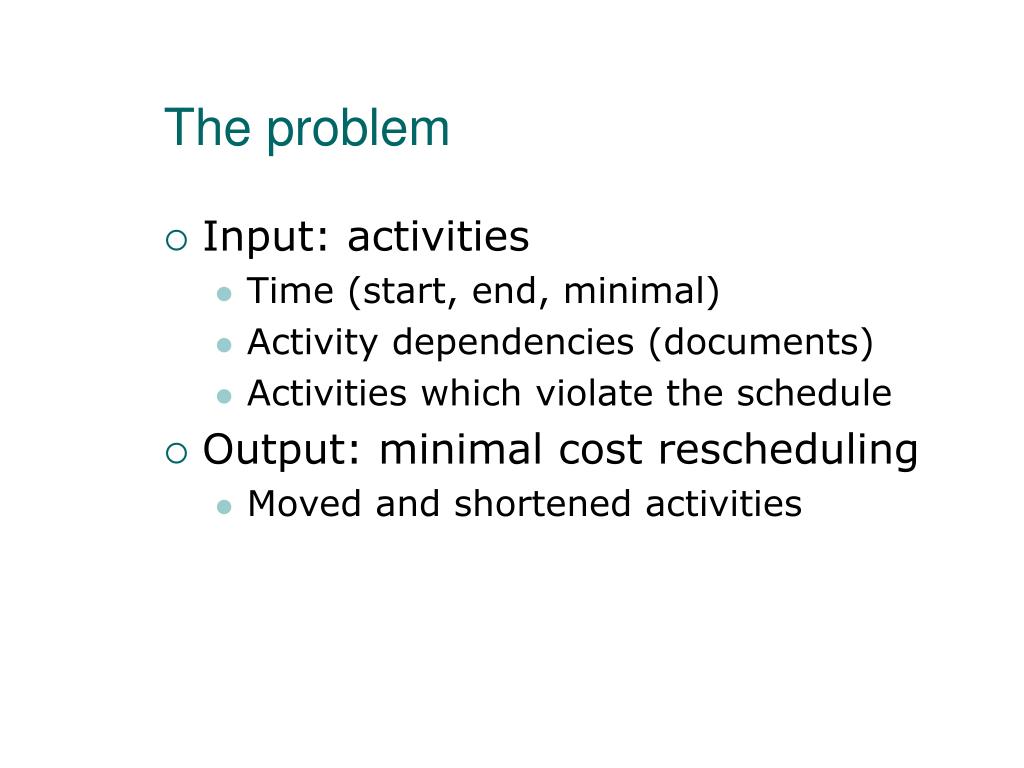

  8. The problem Increase the end time of some activity (activities) while not moving the final deadline. • Move activities • Shorten activities

  9. The problem • Input: activities • Time (start, end, minimal) • Activity dependencies (documents) • Activities which violate the schedule • Output: minimal cost rescheduling • Moved and shortened activities

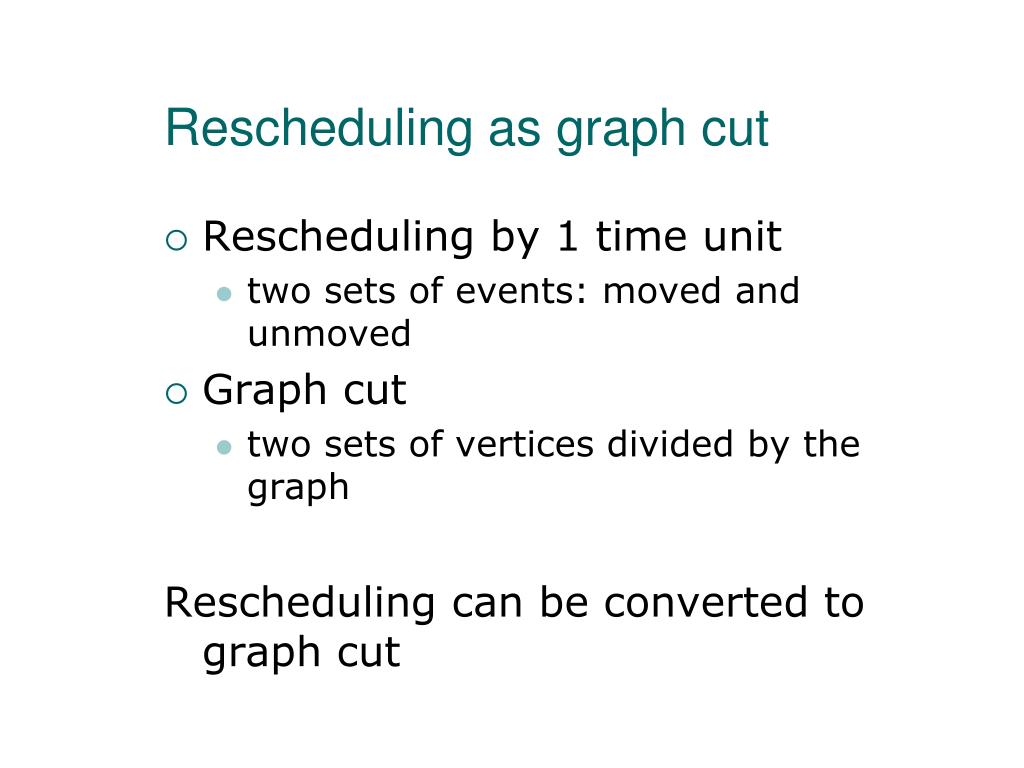

  10. Rescheduling as graph cut • Rescheduling by 1 time unit • two sets of events: moved and unmoved • Graph cut • two sets of vertices divided by the graph Rescheduling can be converted to graph cut

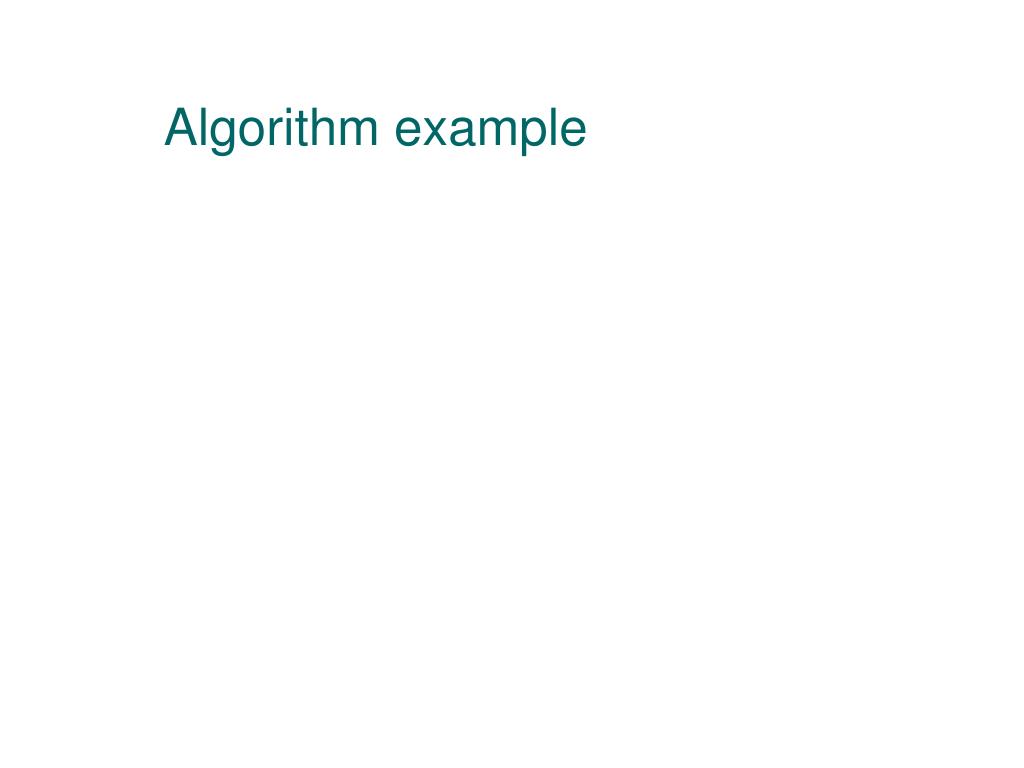

  11. Algorithm example

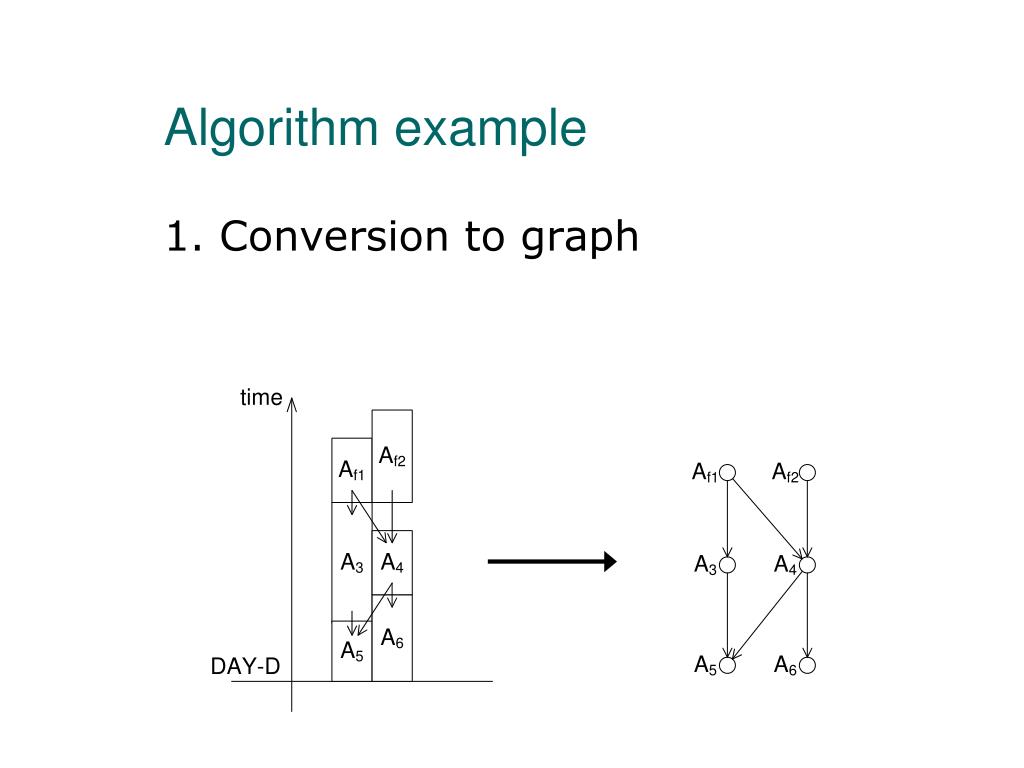

  12. Algorithm example 1. Conversion to graph

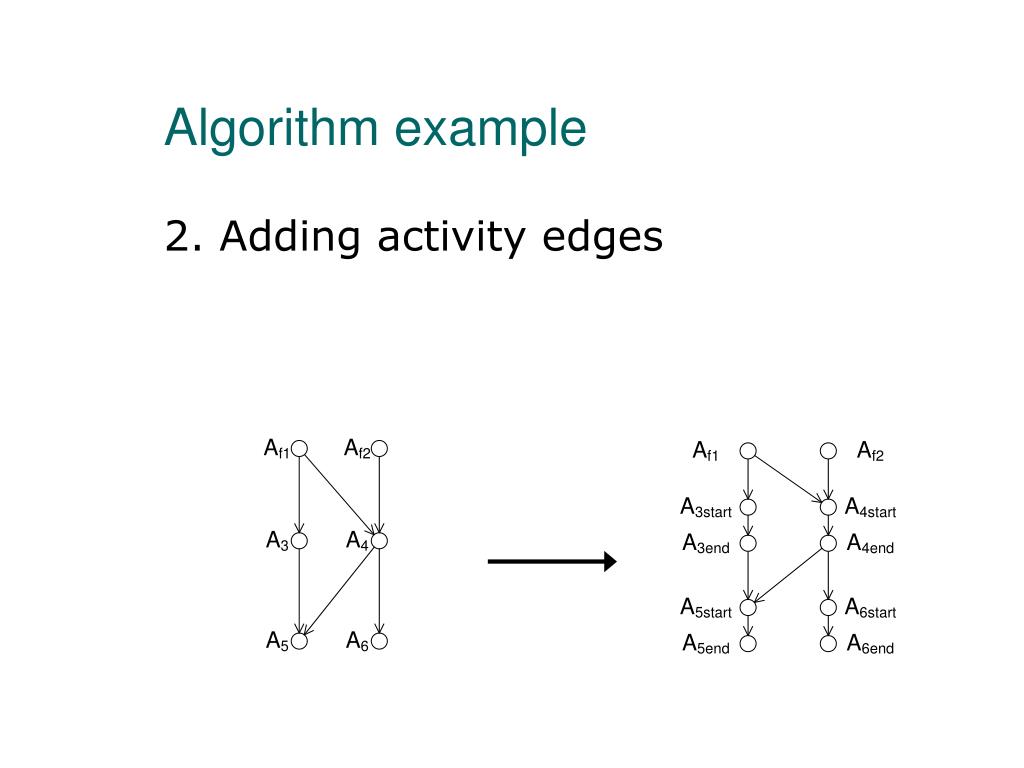

  13. Algorithm example 2. Adding activity edges

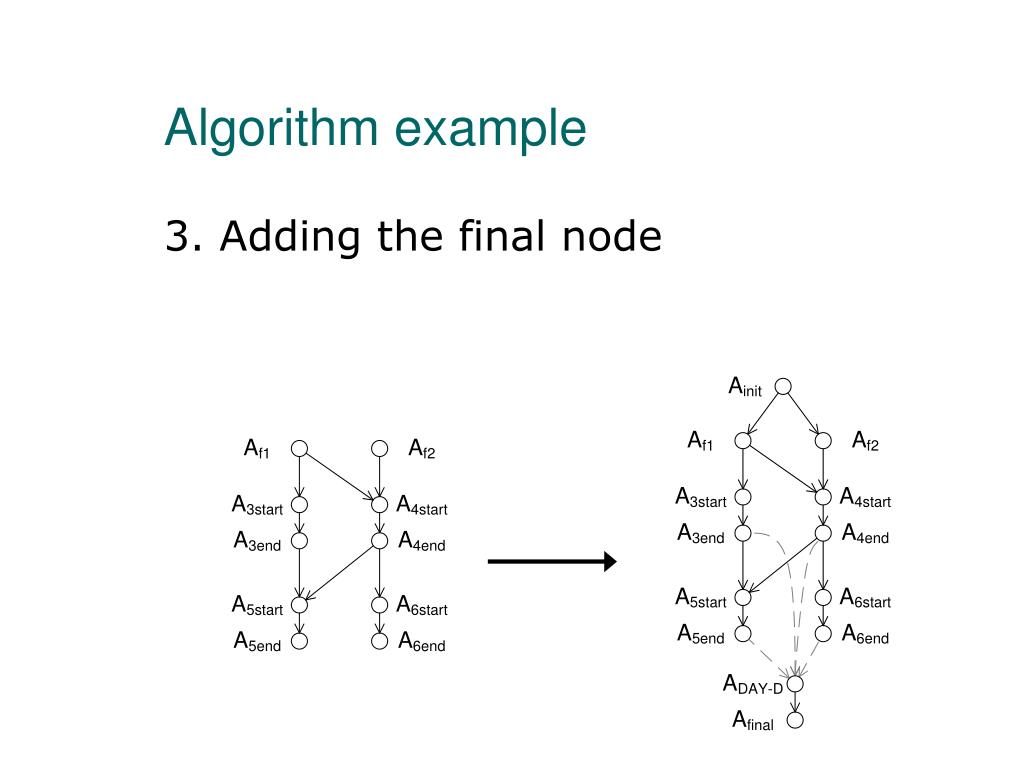

  14. Algorithm example 3. Adding the final node

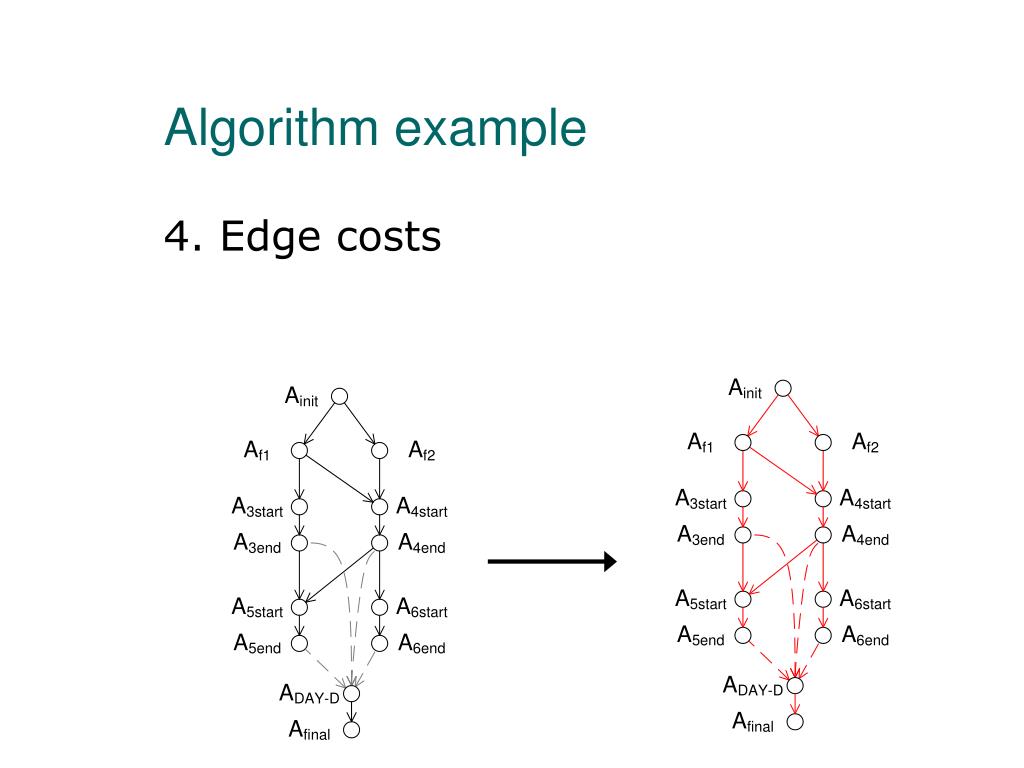

  15. Algorithm example 4. Edge costs

  16. Algorithm example 5. Find the minimal cut

  17. Algorithm example 6. Moving of activities

  18. Edge costs • Abort the failed activity • ∞ • Shorten an activity • 1/∞ • Shorten a dependence • 0/∞ • Move an activity • 0.001/∞ • Move the deadline • ∞

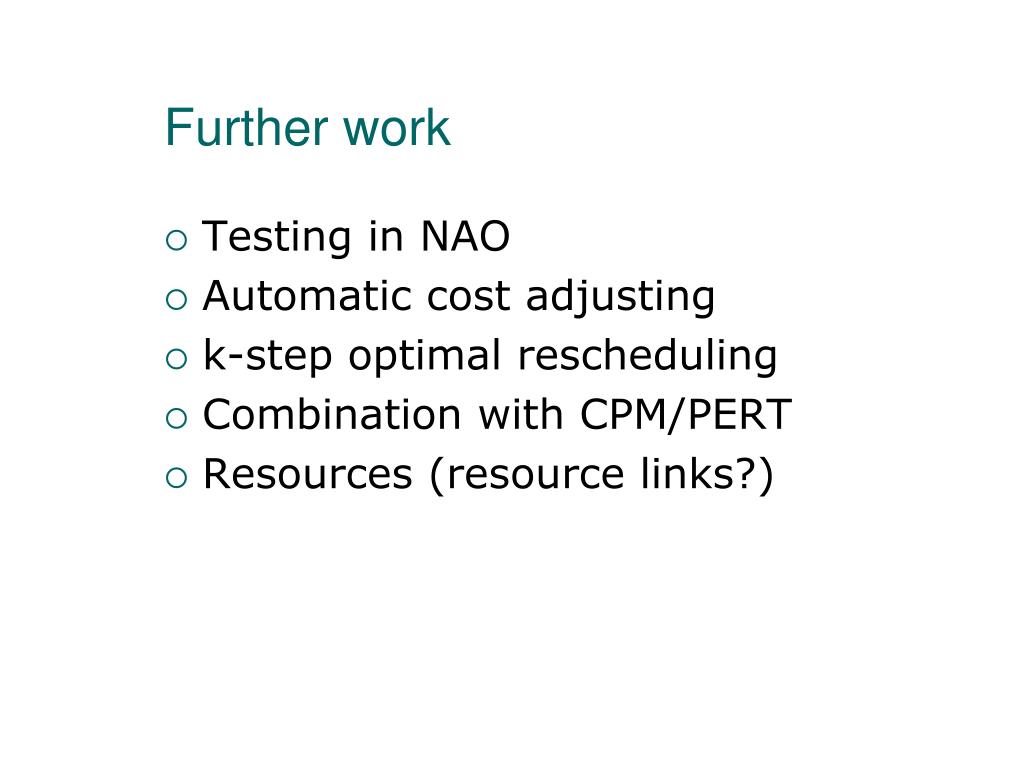

  19. Further work • Testing in NAO • Automatic cost adjusting • k-step optimal rescheduling • Combination with CPM/PERT • Resources (resource links?)

  20. Conclusions • Every rescheduling corresponds to agraph cut • New rescheduling algorithm • Minimal cost of change • Works with moving and shortening ofactivities

  21. Thank you
