  1. Open Workbench By Wilmer Arellano Spring 2008

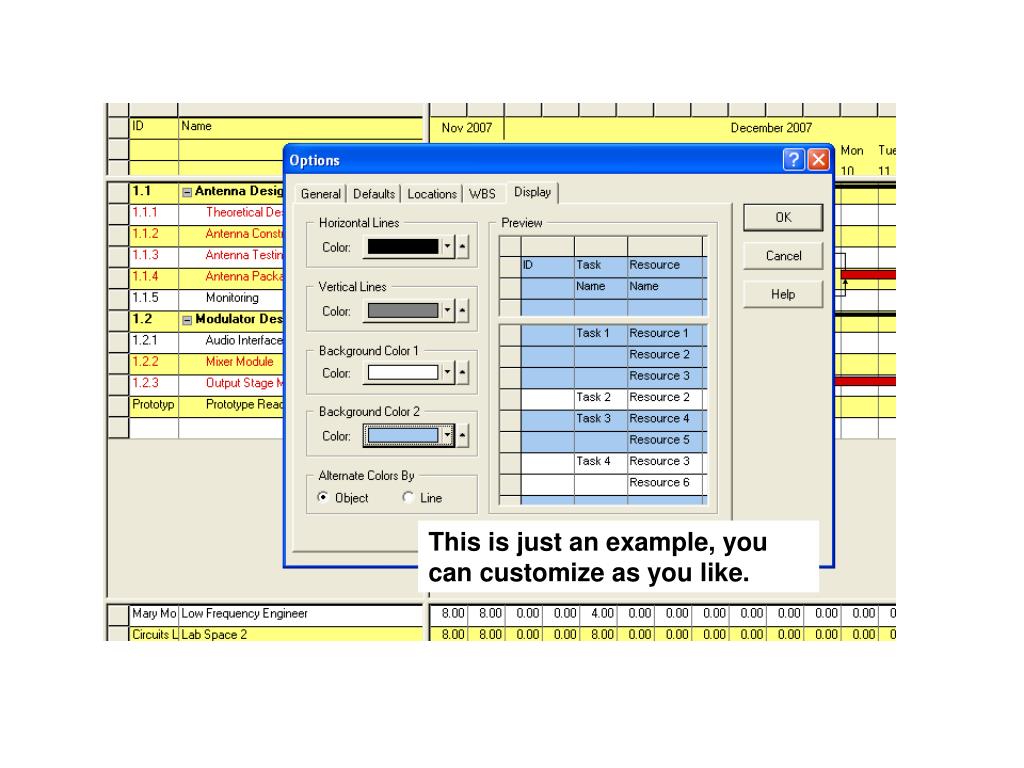

  2. This is just an example, you can customize as you like.

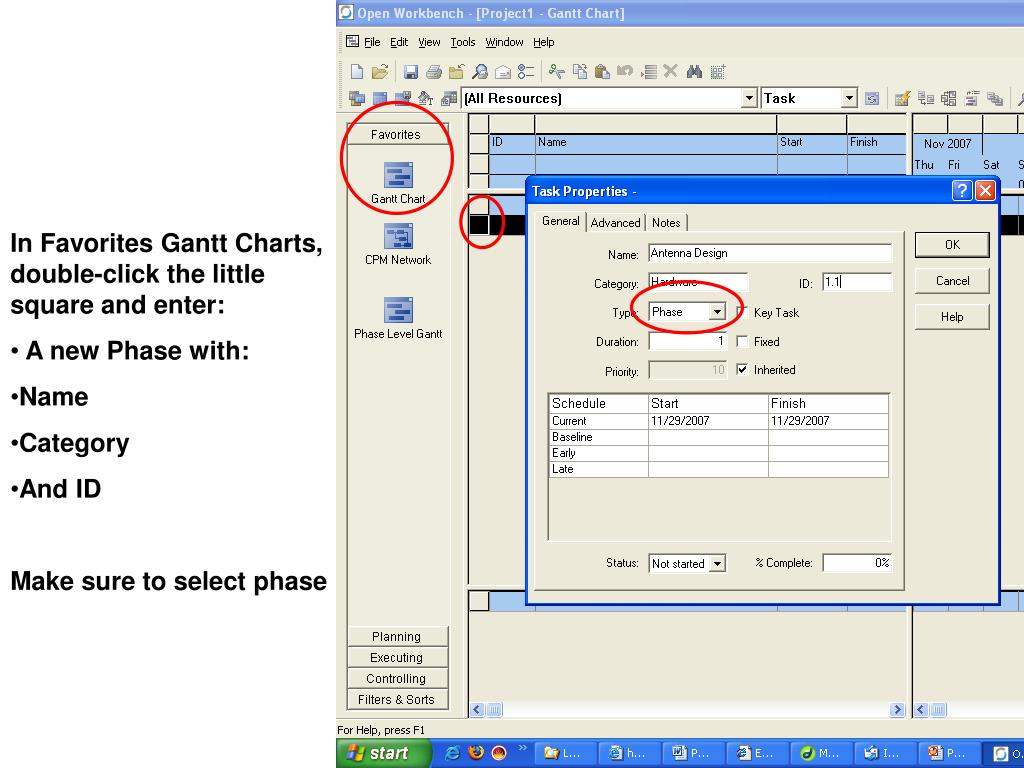

  3. In Favorites Gantt Charts, double-click the little square and enter: • A new Phase with: • Name • Category • And ID • Make sure to select phase

  4. The first phase has been created

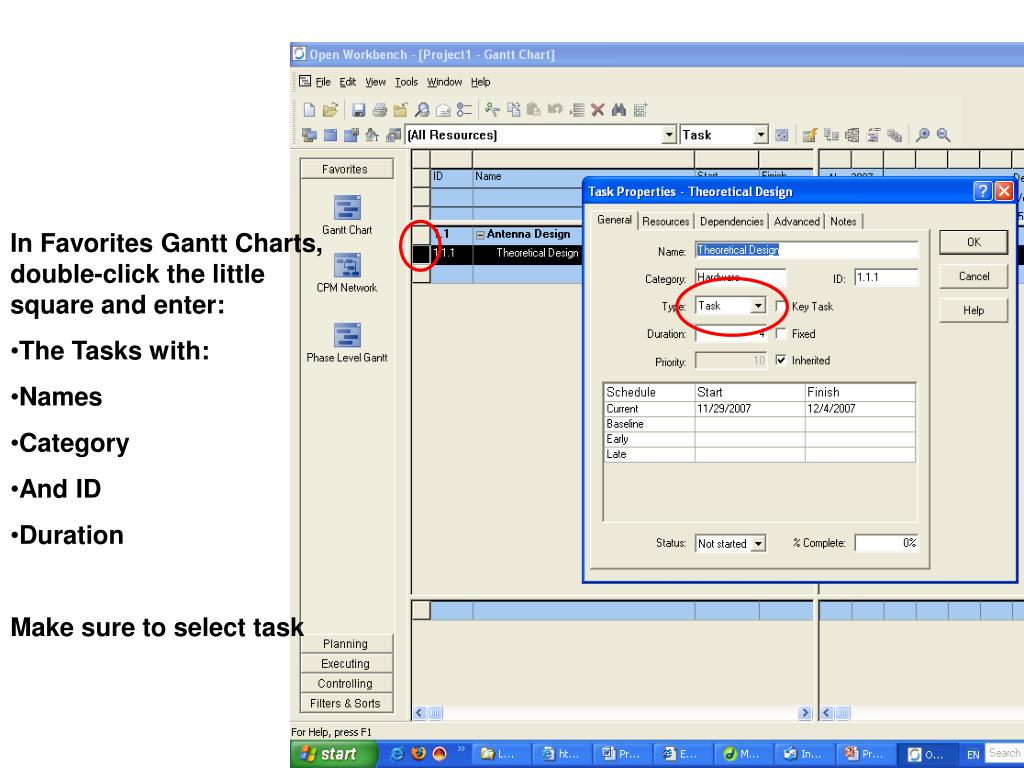

  5. In Favorites Gantt Charts, double-click the little square and enter: • The Tasks with: • Names • Category • And ID • Duration • Make sure to select task

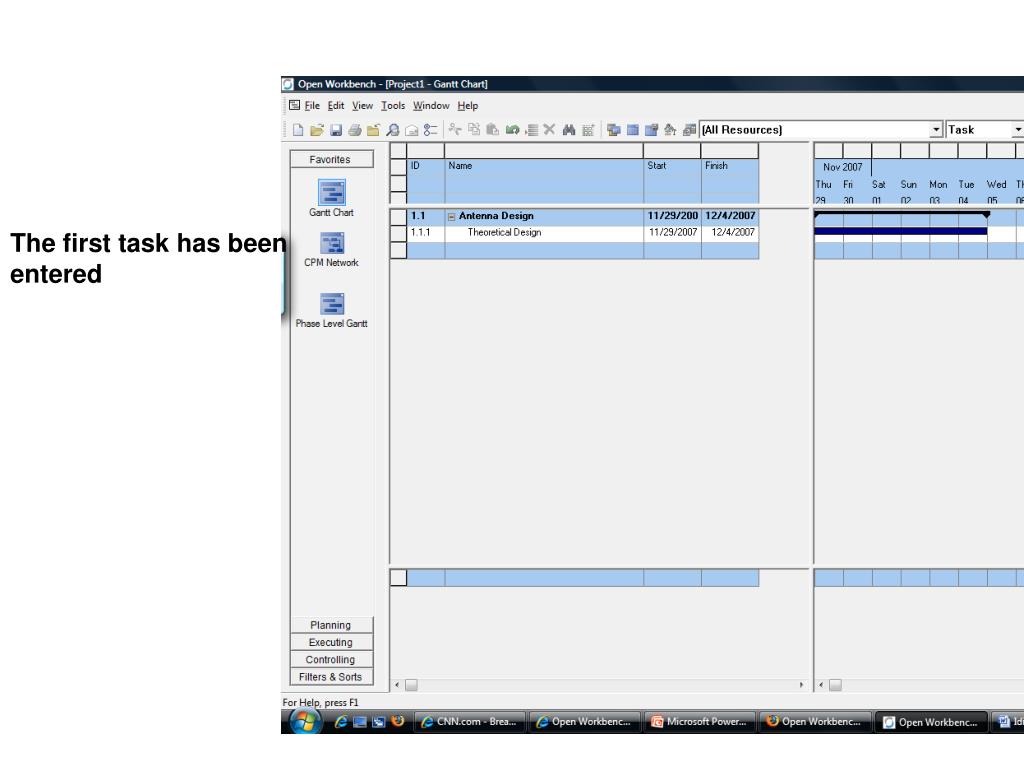

  6. The first task has been entered

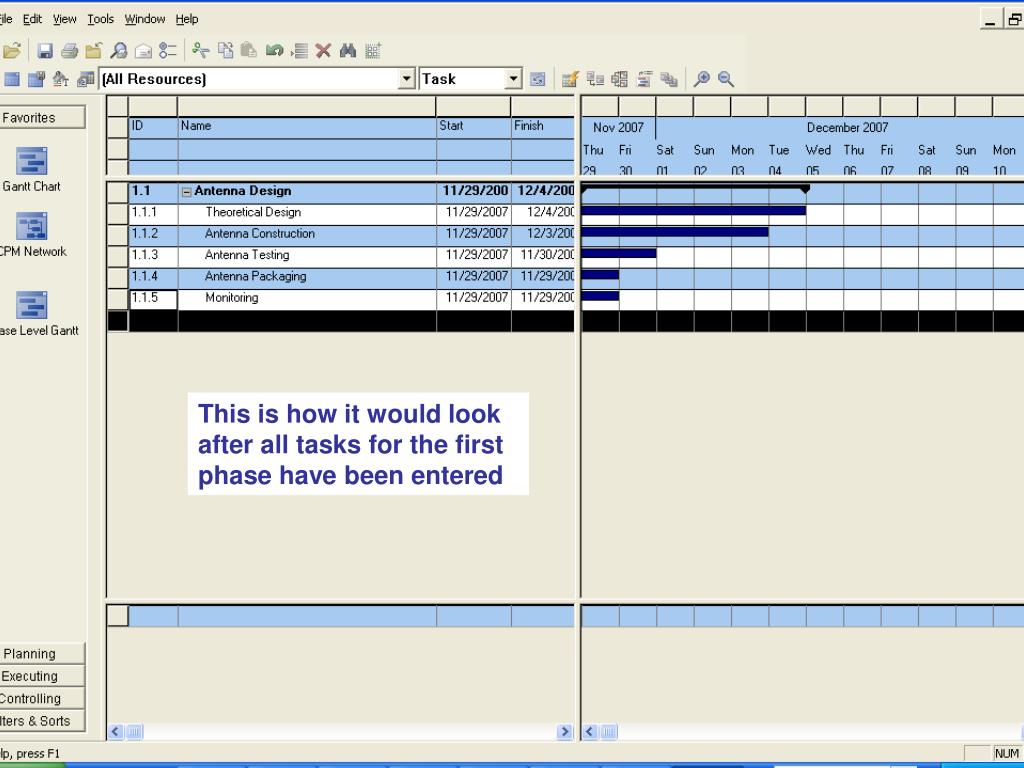

  7. This is how it would look after all tasks for the first phase have been entered

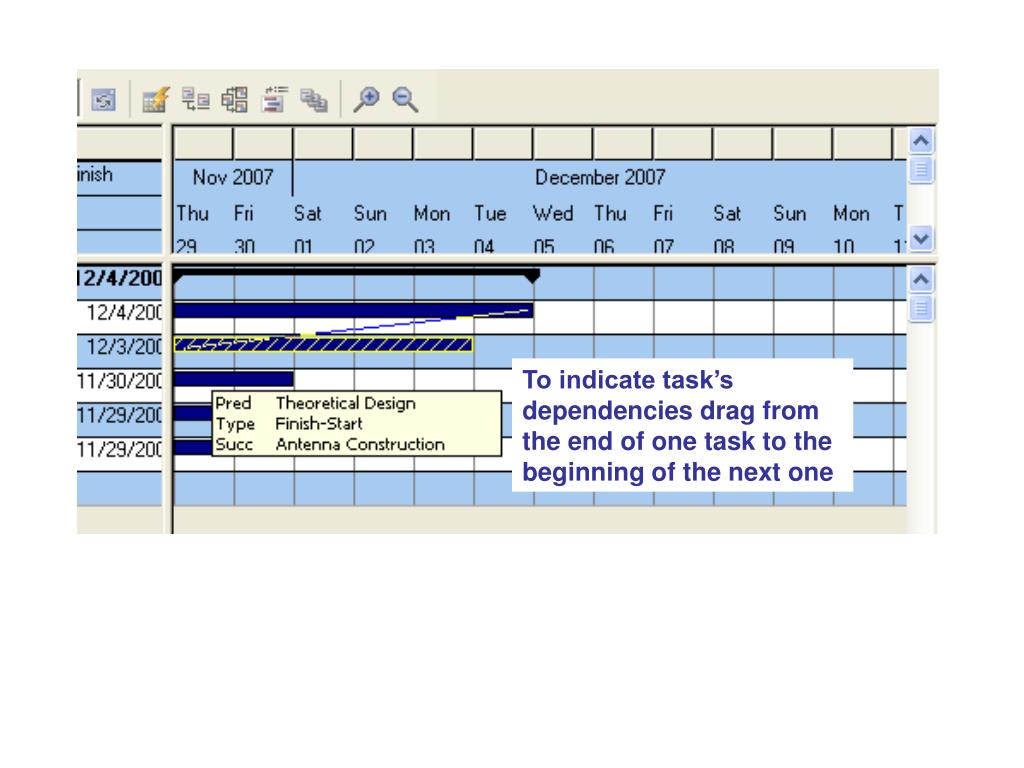

  8. To indicate task’s dependencies drag from the end of one task to the beginning of the next one

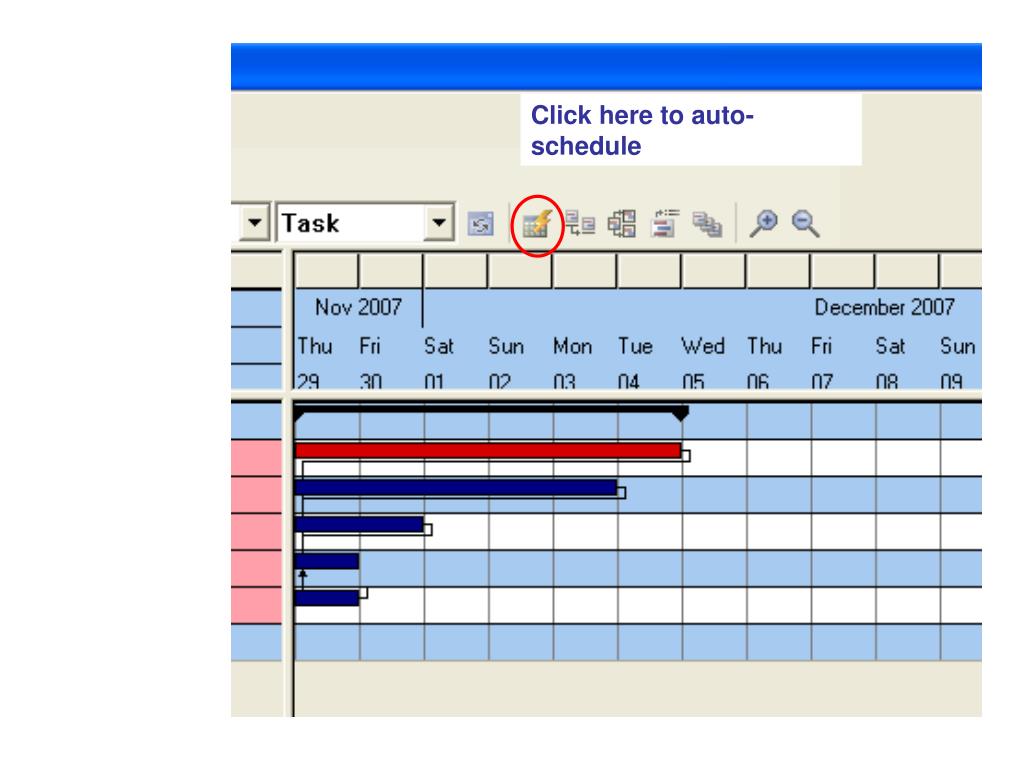

  9. Click here to auto-schedule

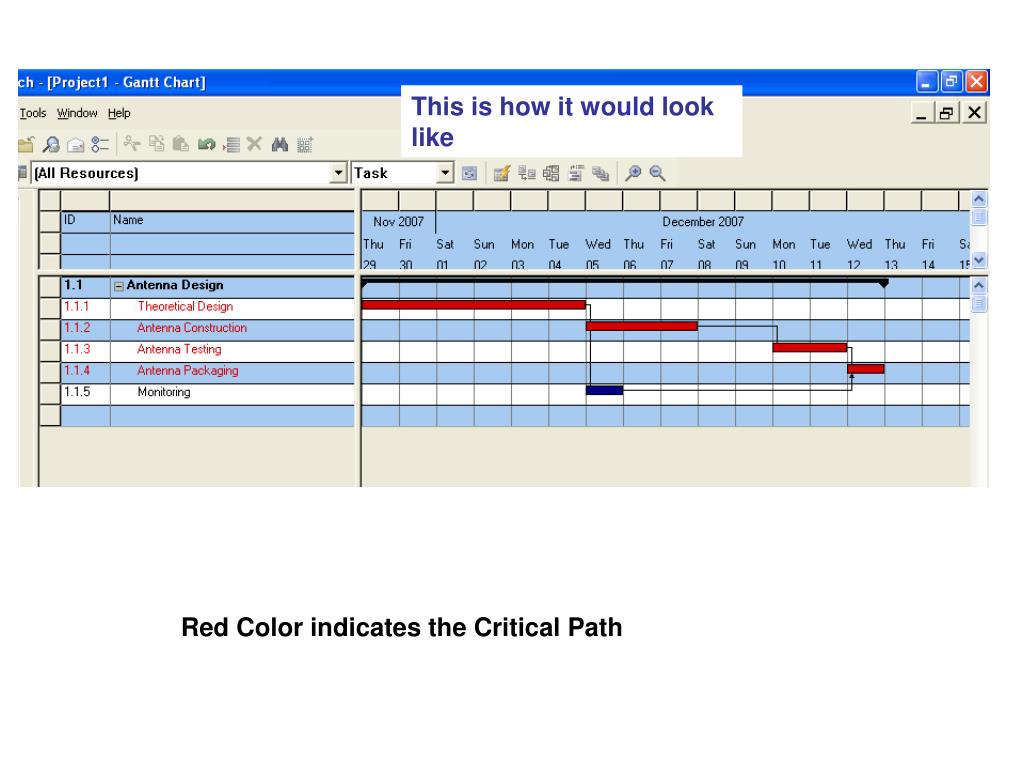

  10. This is how it would look like Red Color indicates the Critical Path

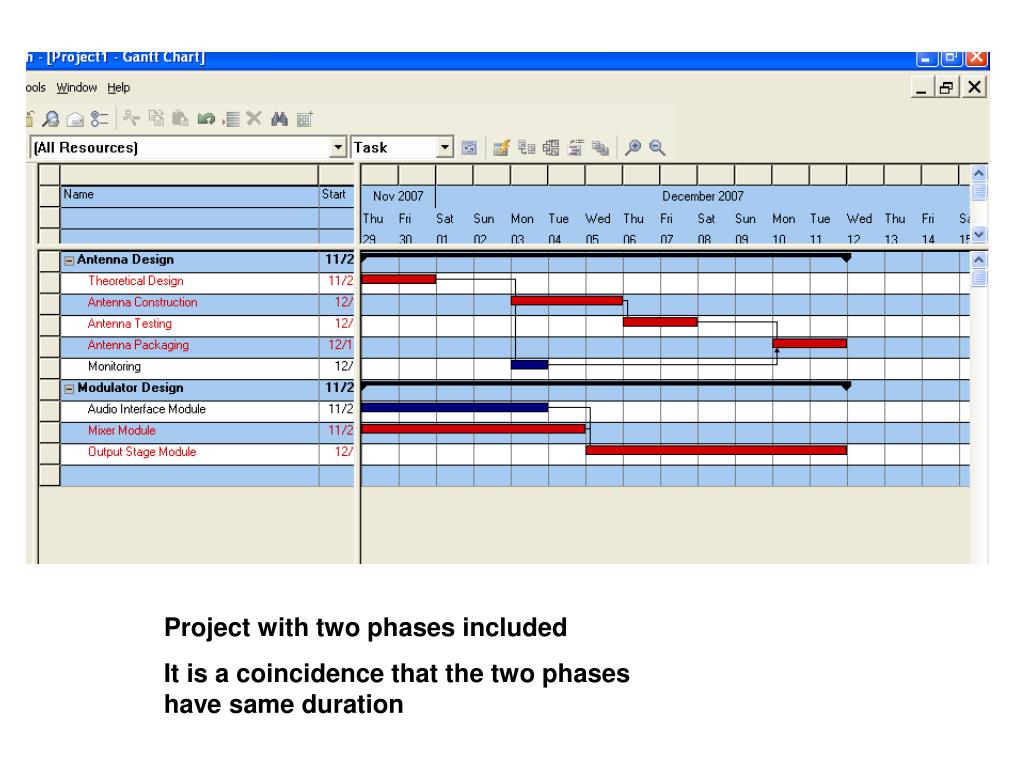

  11. Project with two phases included It is a coincidence that the two phases have same duration

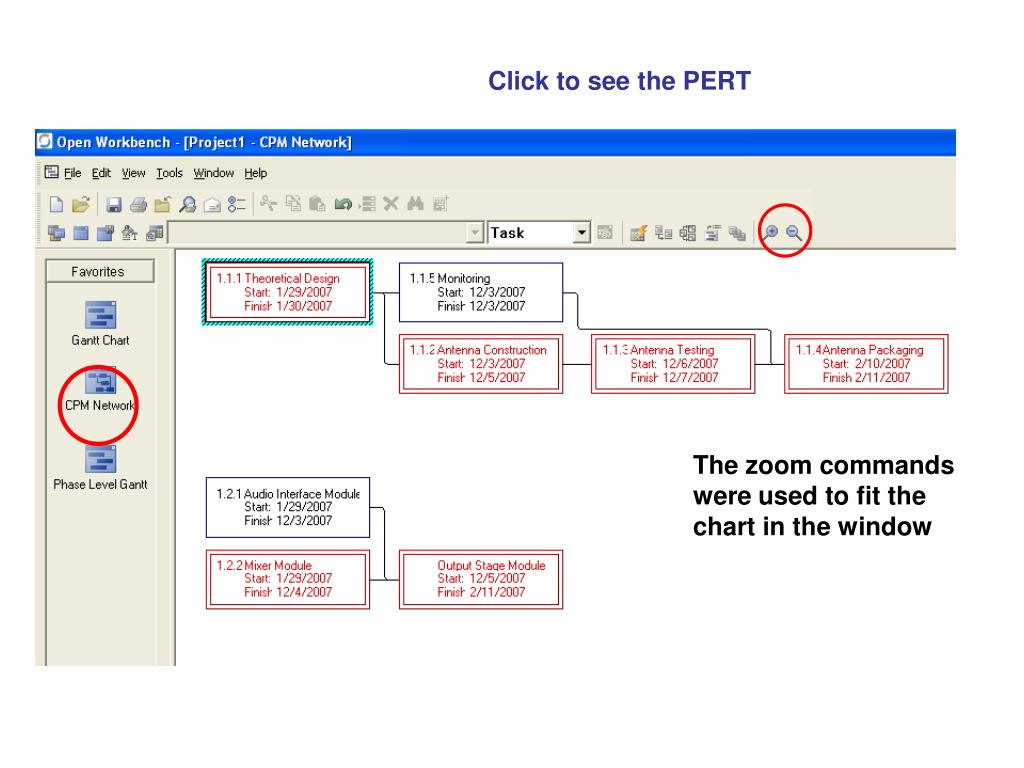

  12. The zoom commands were used to fit the chart in the window Click to see the PERT

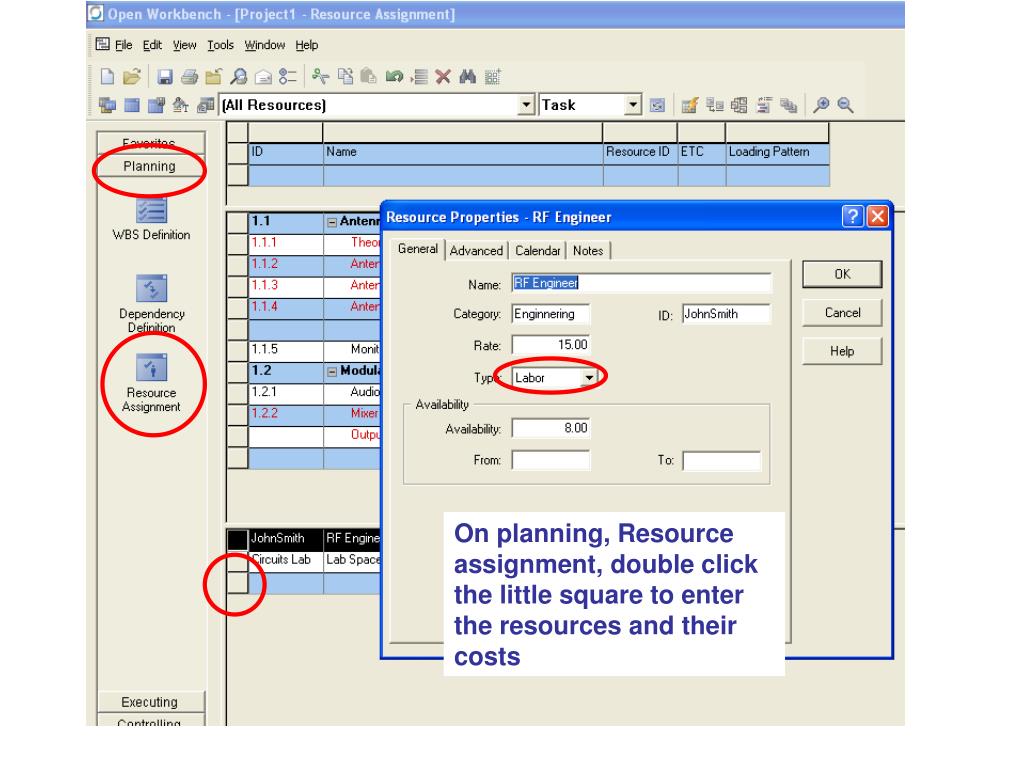

  13. On planning, Resource assignment, double click the little square to enter the resources and their costs

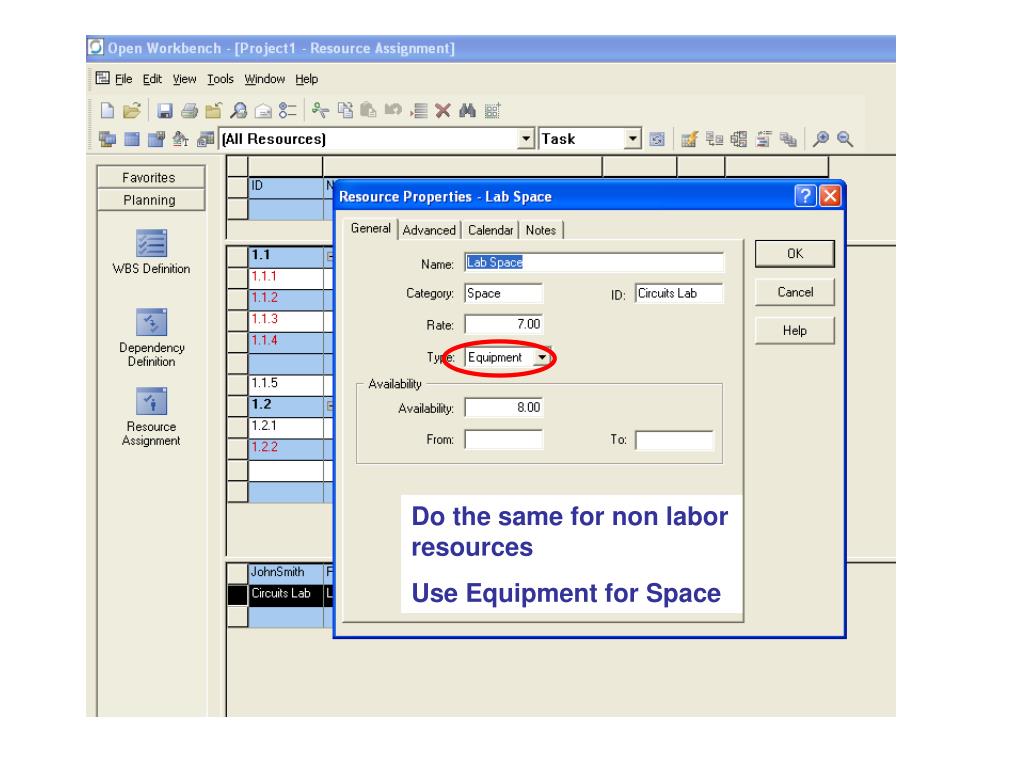

  14. Do the same for non labor resources Use Equipment for Space

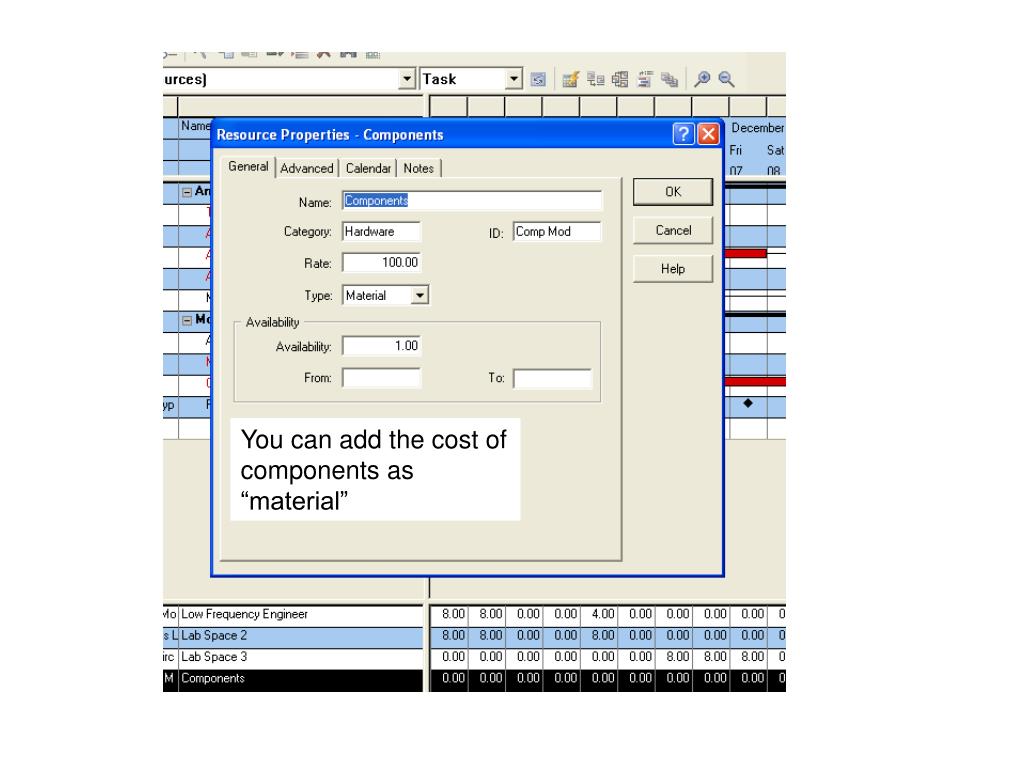

  15. You can add the cost of components as “material”

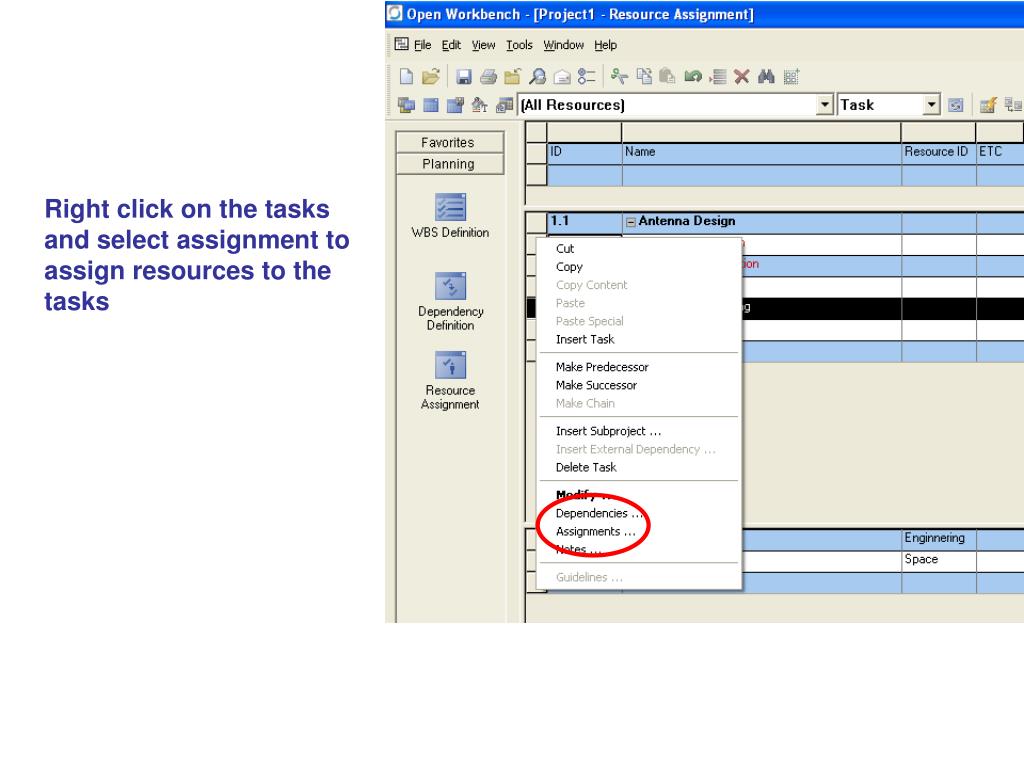

  16. Right click on the tasks and select assignment to assign resources to the tasks

  17. Right click on the tasks and select assignment to assign resources to the tasks. Enter estimated hours in Estimate

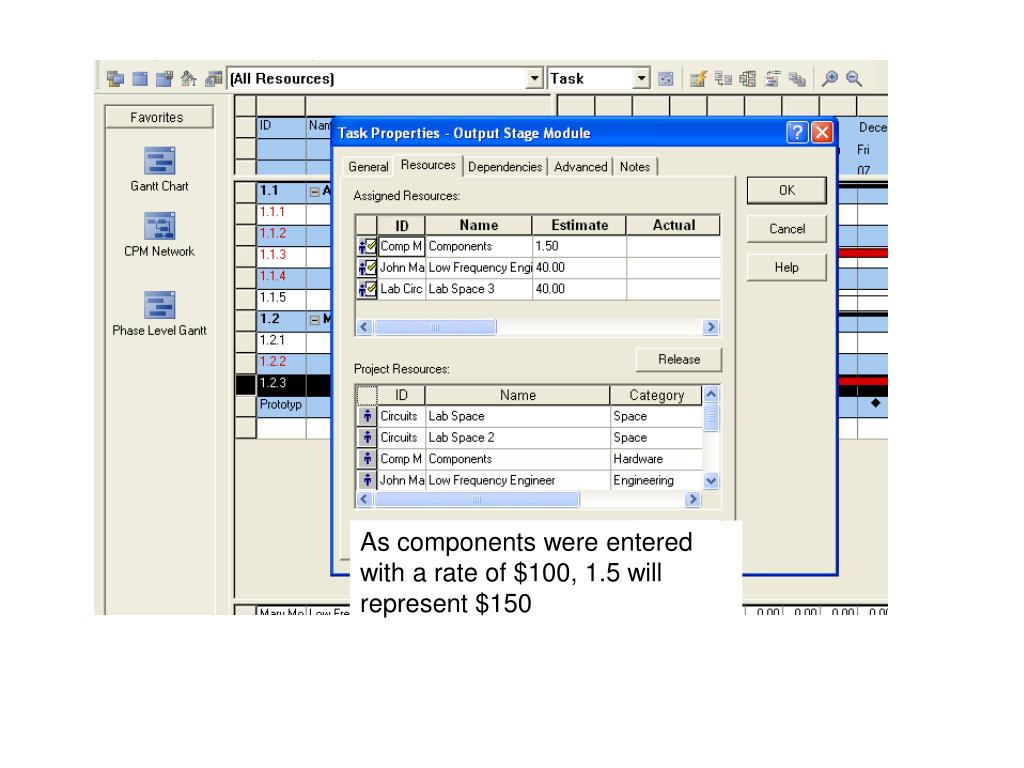

  18. As components were entered with a rate of $100, 1.5 will represent $150

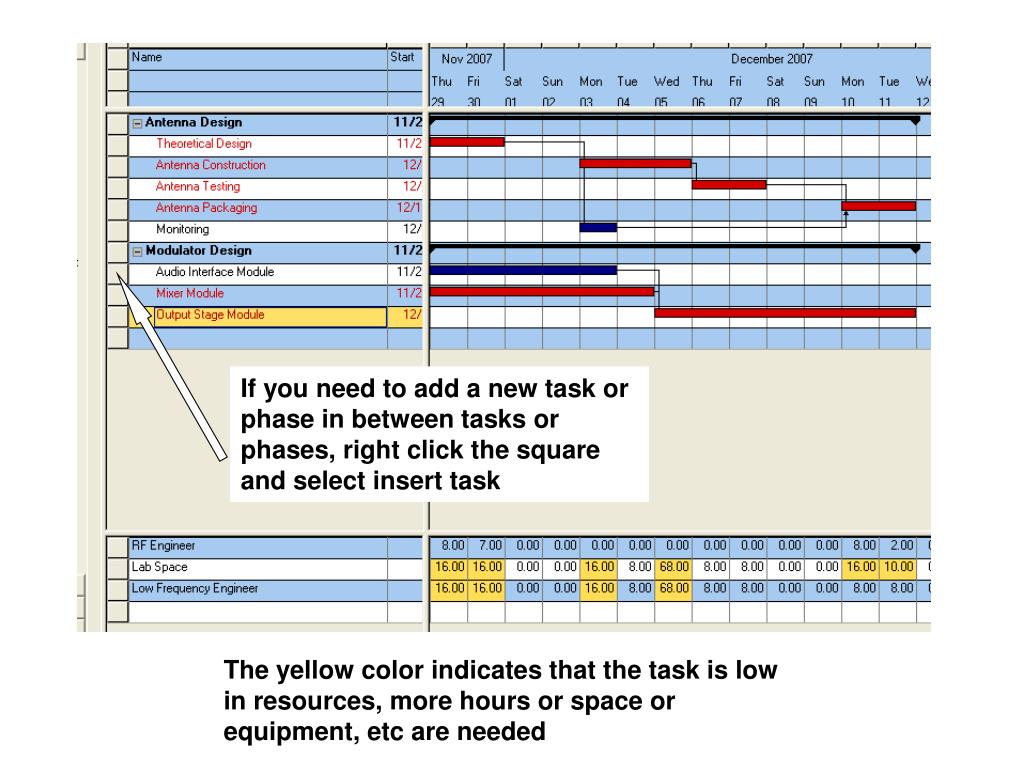

  19. If you need to add a new task or phase in between tasks or phases, right click the square and select insert task The yellow color indicates that the task is low in resources, more hours or space or equipment, etc are needed

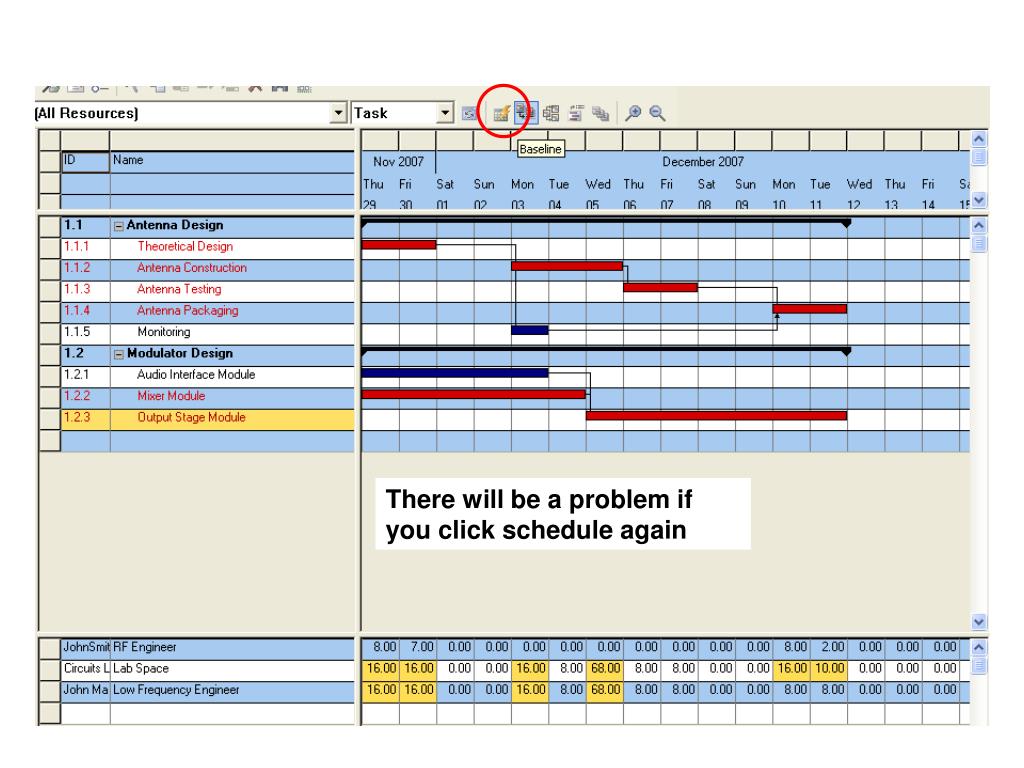

  20. There will be a problem if you click schedule again

  21. The zoom commands were used to fit the chart in the window As the Audio Interface Module and the Mixer Module were using the same resources, they were converted to sequential. You would need to add more resources to keep the tasks in parallel

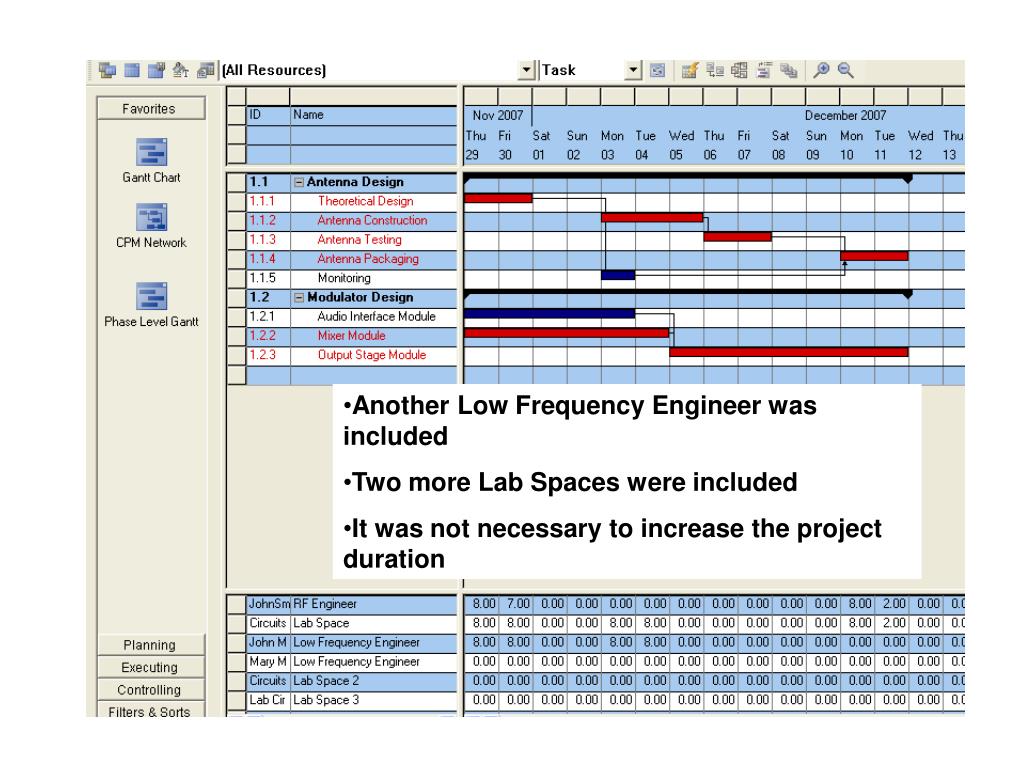

  22. Another Low Frequency Engineer was included • Two more Lab Spaces were included • It was not necessary to increase the project duration

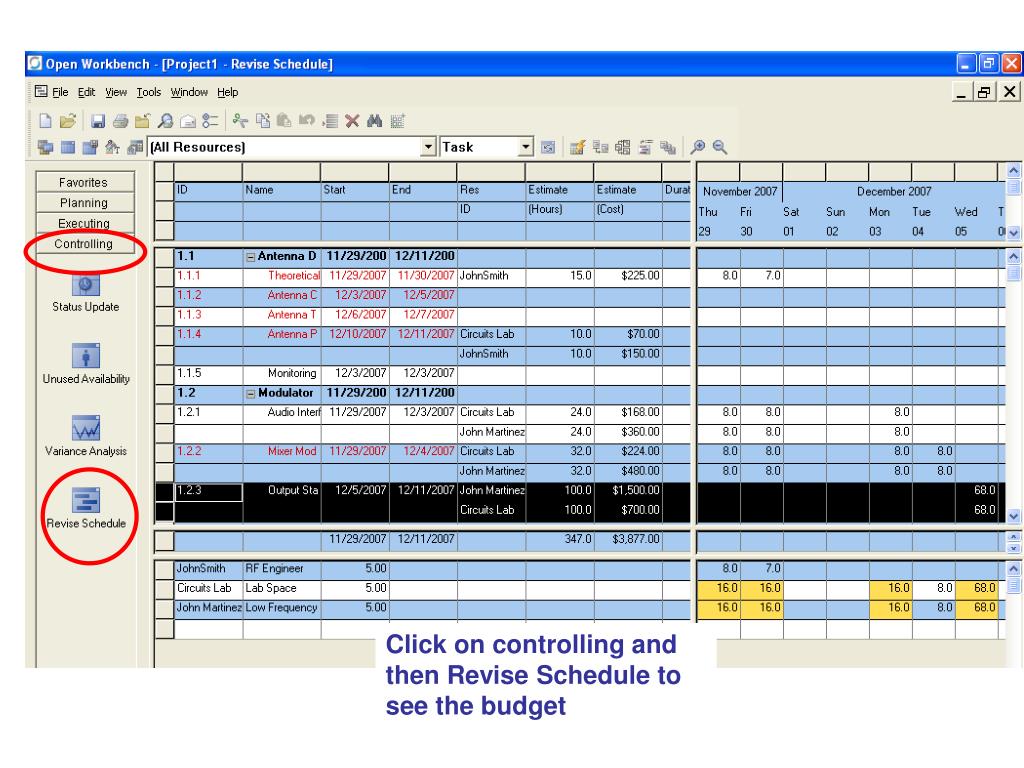

  23. Click on controlling and then Revise Schedule to see the budget

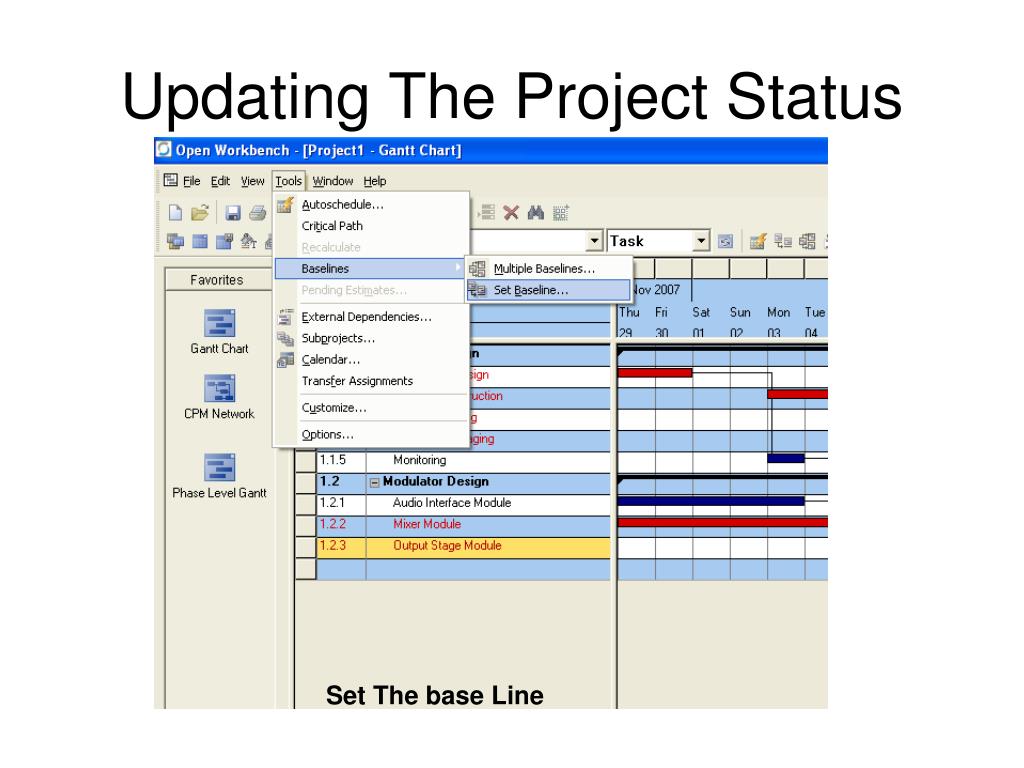

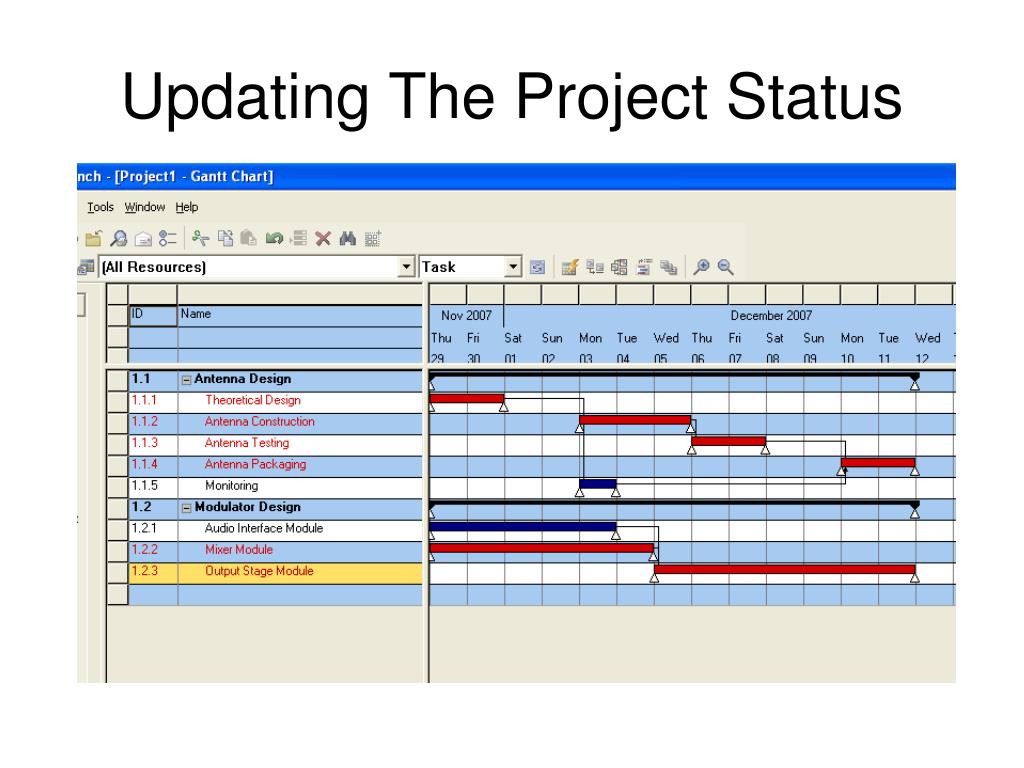

  24. Updating The Project Status Set The base Line

  25. Updating The Project Status

  26. Updating The Project Status

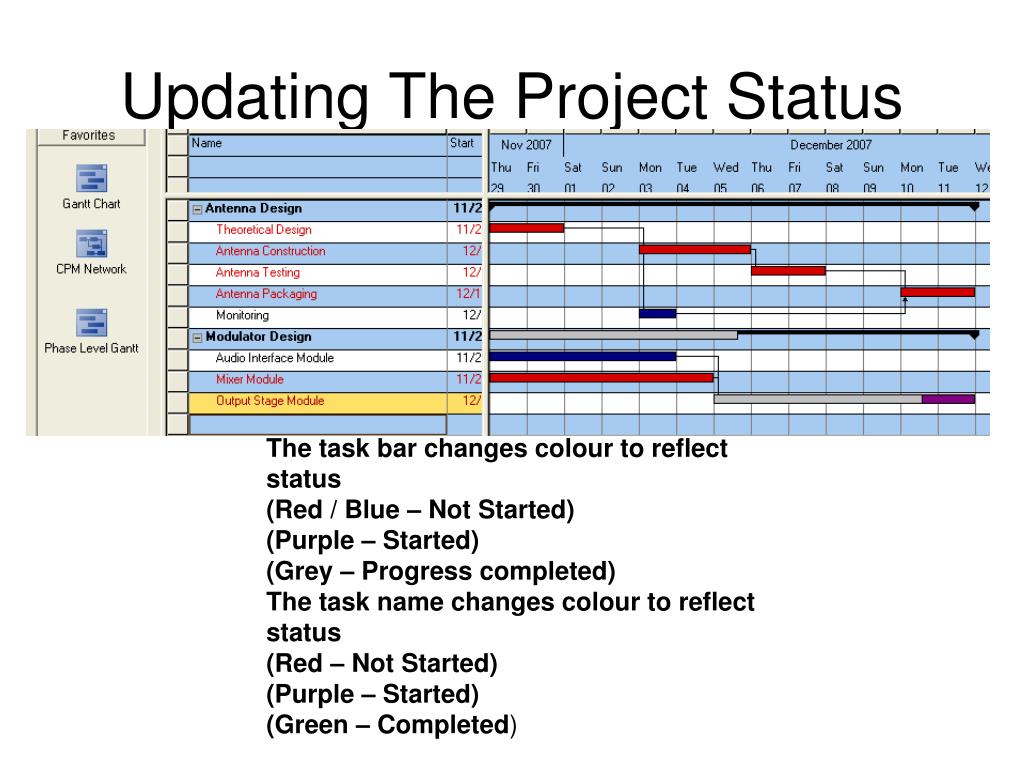

  27. Updating The Project Status The task bar changes colour to reflect status (Red / Blue – Not Started)(Purple – Started)(Grey – Progress completed) The task name changes colour to reflect status (Red – Not Started)(Purple – Started)(Green – Completed)

  28. Updating The Project Status If the task is completed enter 0 in Estimate

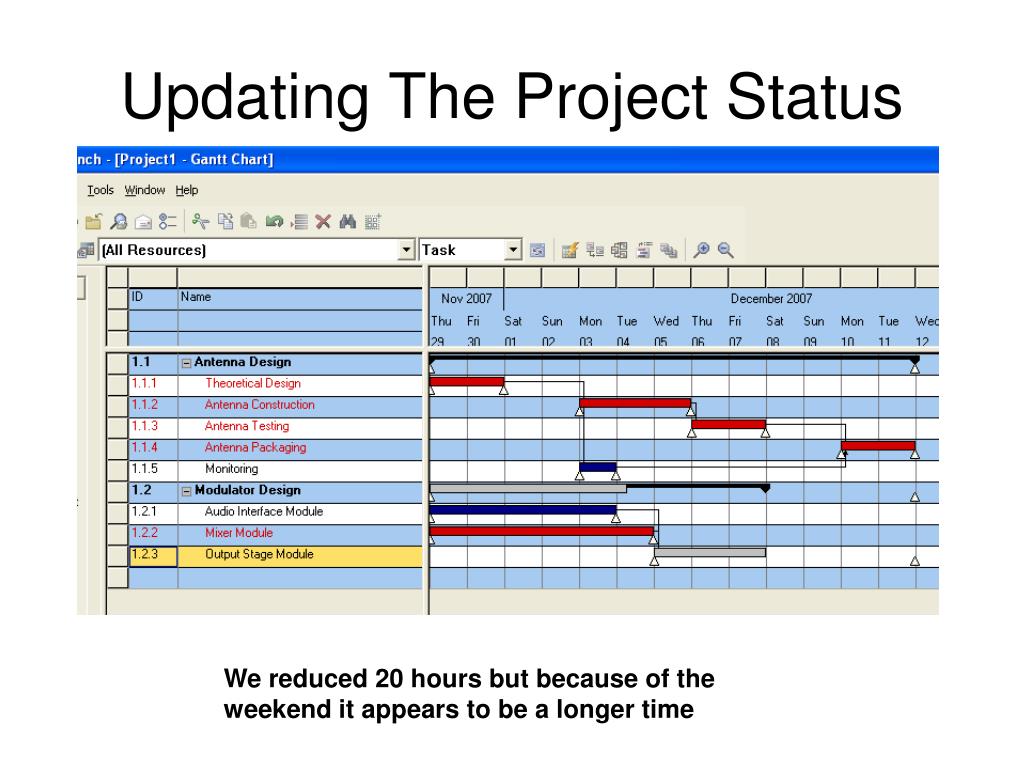

  29. Updating The Project Status We reduced 20 hours but because of the weekend it appears to be a longer time

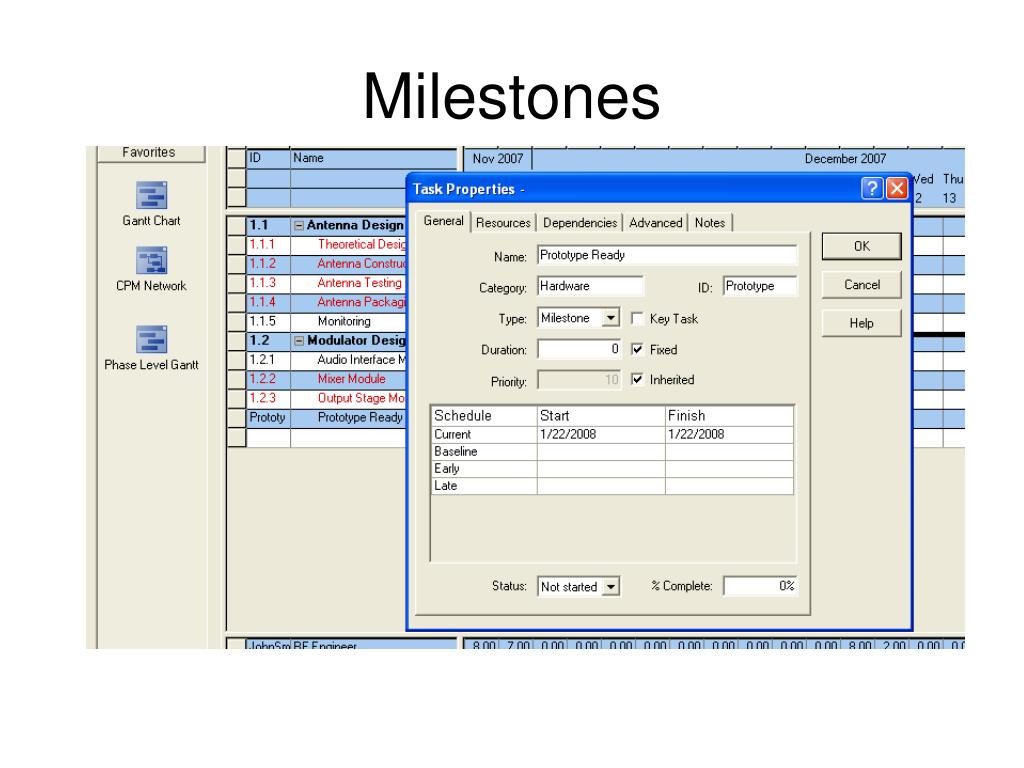

  30. Milestones

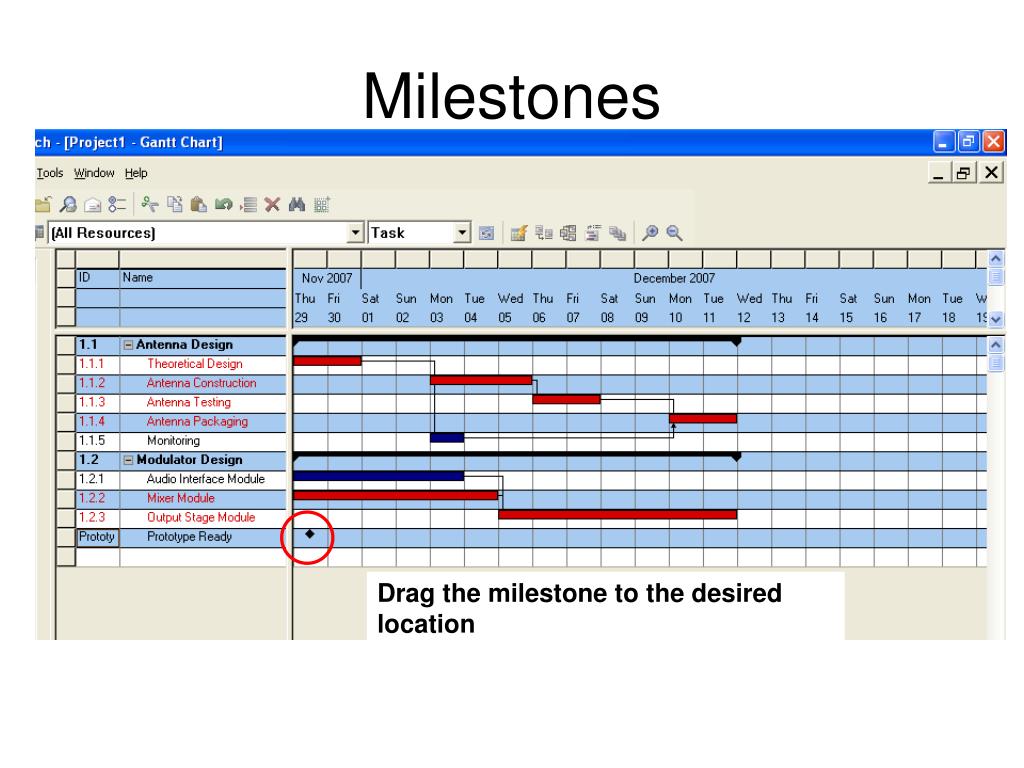

  31. Milestones Drag the milestone to the desired location

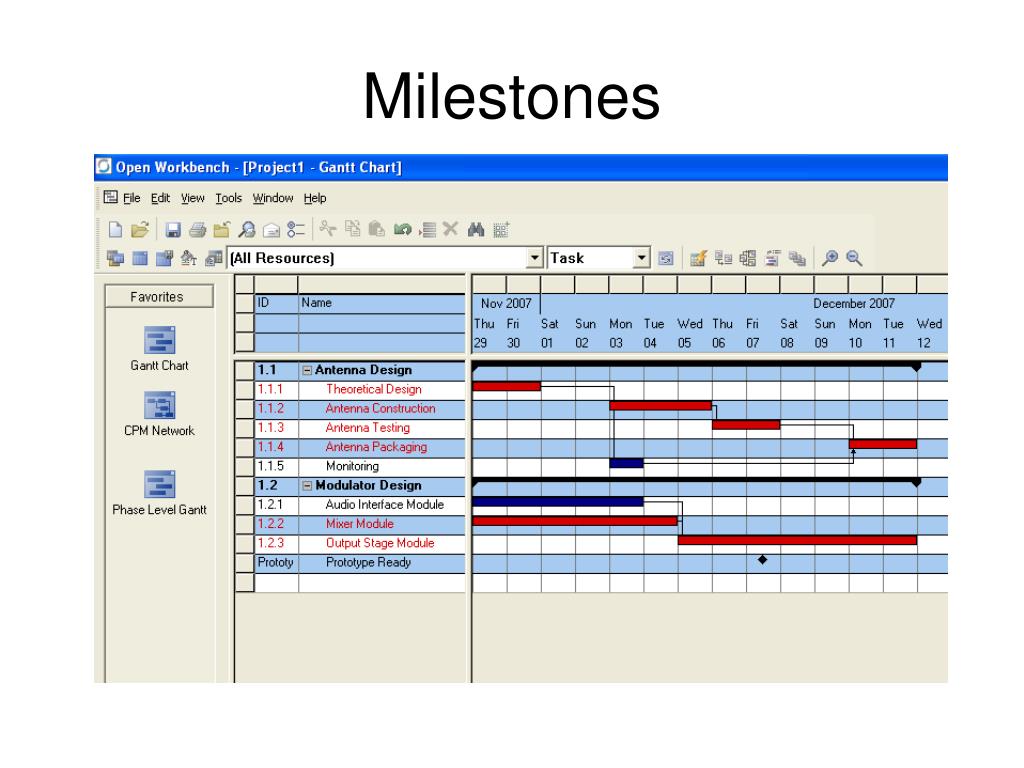

  32. Milestones

  33. Copy and Paste Table cells can be copied and pasted into excel By the way, this is a representation of the WBS

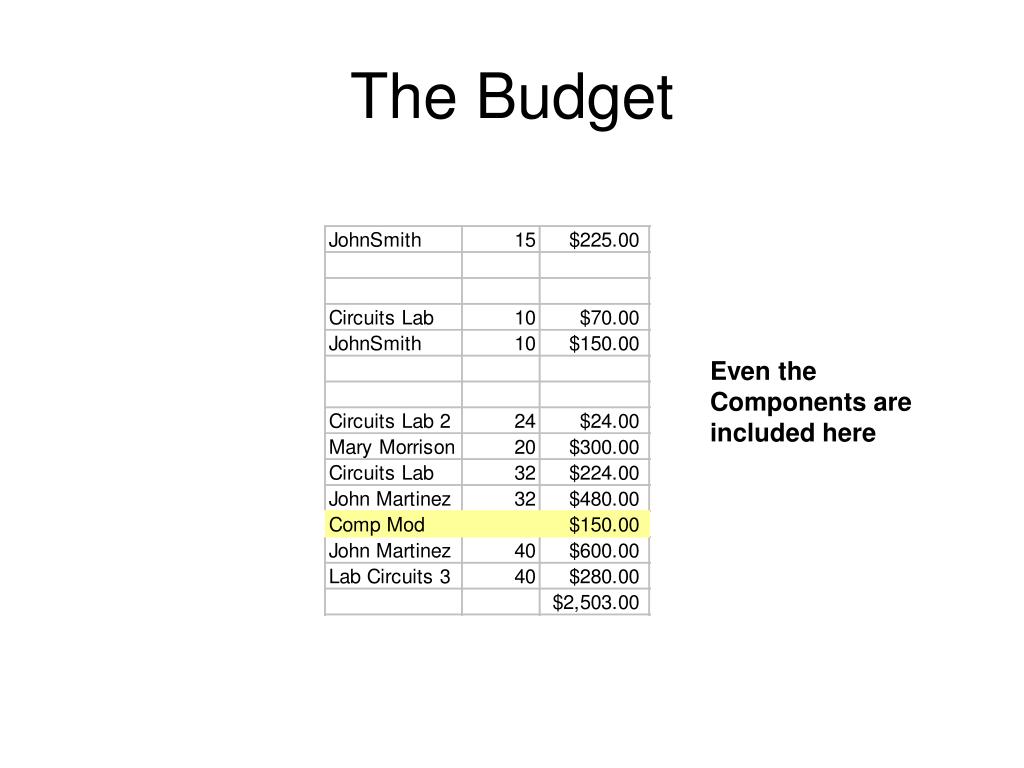

  34. The Budget Even the Components are included here

  35. & Questions Answers
