PER-005 Update Impact on Operators

PER-005 Update Impact on Operators. System Operator Conference April 17-19 and May 1-3, 2012 Columbia, SC Margaret Stambach Manager, Training Services SERC Reliability Corp. Learning Objectives. At the conclusion of this training session, you should be able to:

Télécharger la présentation

PER-005 Update Impact on Operators

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. PER-005 UpdateImpact on Operators System Operator Conference April 17-19 and May 1-3, 2012 Columbia, SC Margaret Stambach Manager, Training Services SERC Reliability Corp.

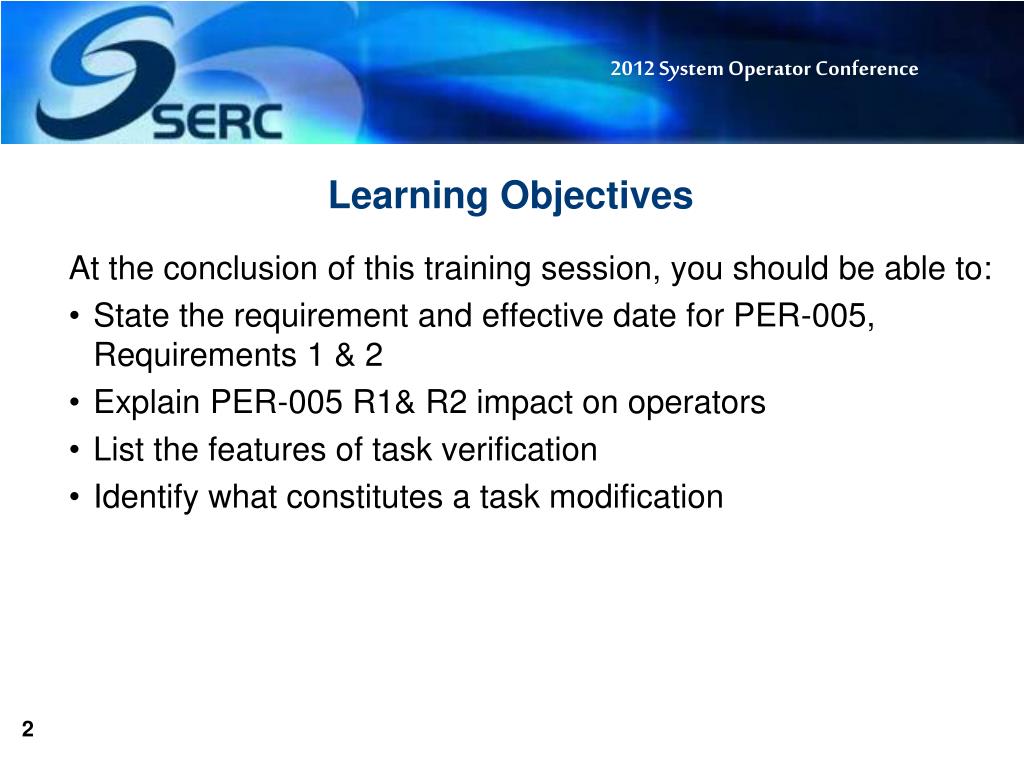

  2. Learning Objectives At the conclusion of this training session, you should be able to: • State the requirement and effective date for PER-005, Requirements 1 & 2 • Explain PER-005 R1& R2 impact on operators • List the features of task verification • Identify what constitutes a task modification

  3. Outline of Topics • FERC Order 742 – approved standards & effective dates • PER-005 R1 and R2 • Meaning of Reliability-Related Task • Procedures for Task Verification • When Must a Task Be Modified and Operators Re-Verified?

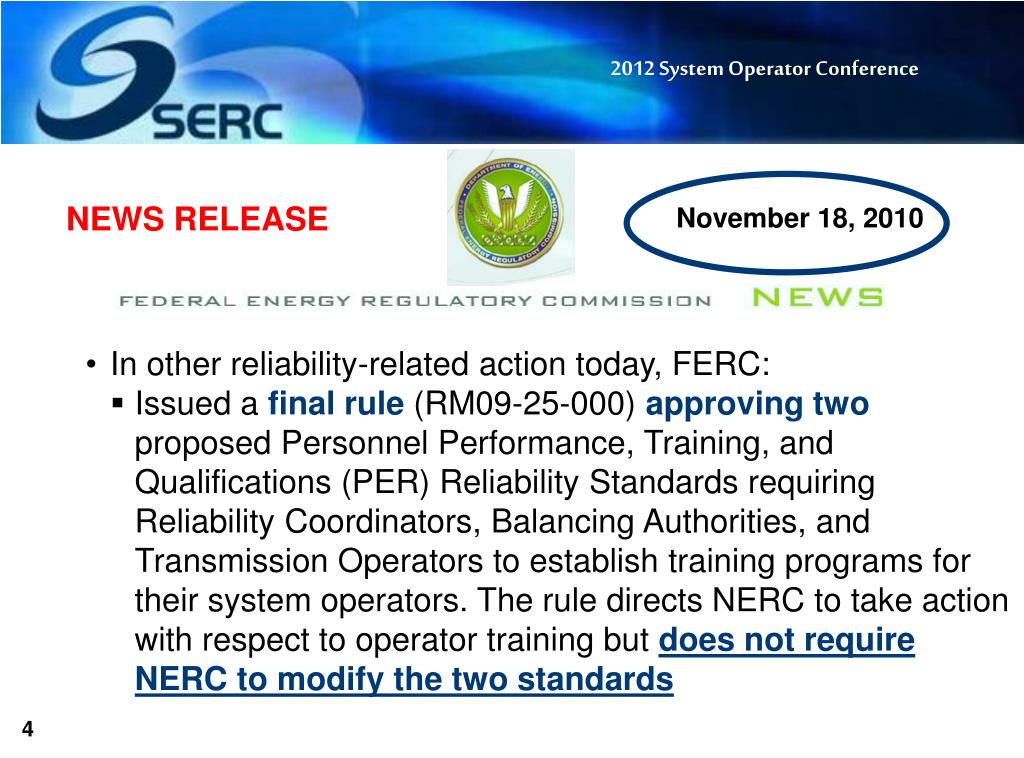

  4. NEWS RELEASE November 18, 2010 • In other reliability-related action today, FERC: • Issued a final rule (RM09-25-000) approving two proposed Personnel Performance, Training, and Qualifications (PER) Reliability Standards requiring Reliability Coordinators, Balancing Authorities, and Transmission Operators to establish training programs for their system operators. The rule directs NERC to take action with respect to operator training but does not require NERC to modify the two standards

  5. FERC Order 742Which Two Standards Are Approved? • PER-005-1 System Personnel Training • Applicable entities: • RCs • BAs • TOPs • PER-004-2 Reliability Coordination - staffing • Applicable entity: • RCs Significant change over previous training standard, PER-002

  6. Implementation TimelineSystem Personnel Training Standards Only R3 in Effect Right Now

  7. R1 & R2 – the “Real Meat” of PER-005 – Go into Effect in One Year! (4-1-13) Entities must use a “systematic approach” to develop a training program based on the job tasks that you perform Sounds simple, but……

  8. There Are many “Pieces” to a Systematic Approach to Training (SAT) • Develop a list of “reliability-related” job tasks • Develop learning objectives for each task • Design training courses to meet those learning objectives • Implement the training program (using appropriate methods like classroom, simulation, field trips, etc) • Evaluate the training program and correct any deficiencies.

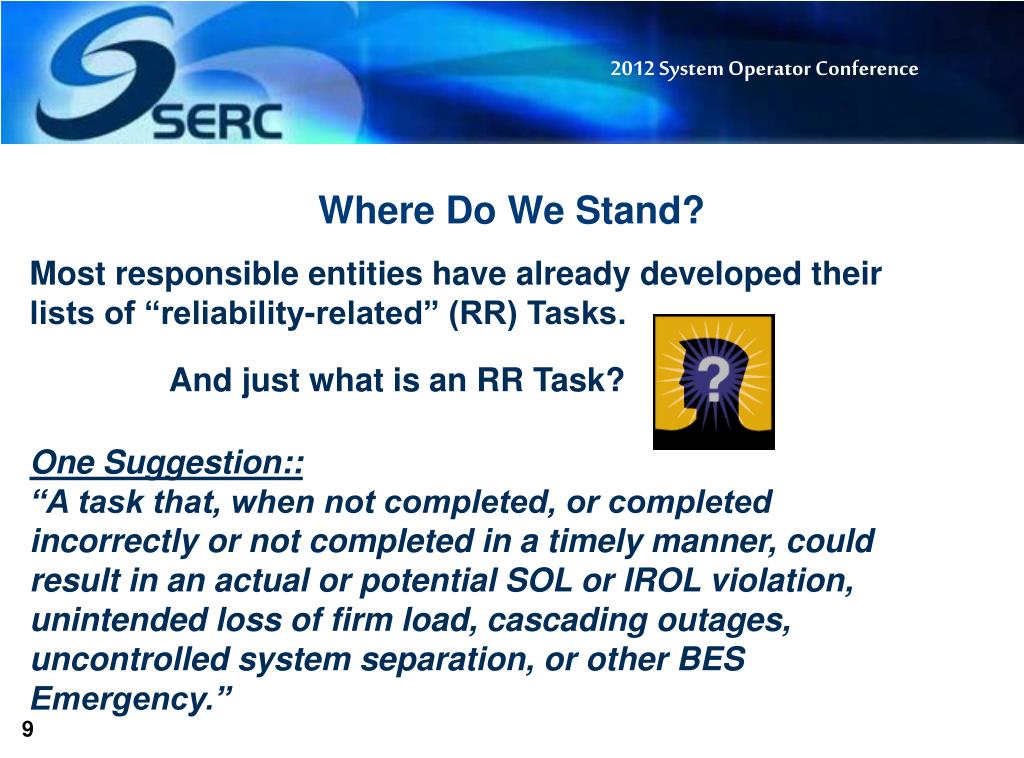

  9. Where Do We Stand? Most responsible entities have already developed their lists of “reliability-related” (RR) Tasks. And just what is an RR Task? One Suggestion:: “A task that, when not completed, or completed incorrectly or not completed in a timely manner, could result in an actual or potential SOL or IROL violation, unintended loss of firm load, cascading outages, uncontrolled system separation, or other BES Emergency.”

  10. Example of BA RR Task: Monitor ACE and respond to loss of supply or DCS event by applying operating reserves within allowable time frames If reserves are not applied in a timely manner following loss of generation, the reliability of the Bulk Electric System is at risk!

  11. Does the Development of a List of RR Tasks Affect You as an Operator? ……. Not really! As an operator, you still perform all the tasks necessary to protect the system, whether there is a task list or not! ……. But what about PER-005 R2?

  12. PER-005, REQUIREMENT 2: Task Verification of Performance Your entity must verify your ability to perform each task on the list at least one time, so this requirement does affect you….

  13. PER-005, REQUIREMENT 2: Task Verification of Performance • Tasks that are performed frequently could be observed by a qualified evaluator and documented as complete if you perform the task successfully. • Tasks that are performed infrequently may require checkout on a simulator or in the classroom with table-top exercises to assure your capability to perform the task.

  14. PER-005, REQUIREMENT 2: Task Verification of Performance • Task Verification should involve: • Acceptable level of accomplishment for each task. • Written Task Verification Guide – with content/plan for the activity. • Observation check lists. • Qualified Trainer/Evaluator.

  15. Acceptable Level of Accomplishment • This is the measurable outcome (action) associated with a task and its standards for completion. • What does the System Operator need to demonstrate or discuss and how well? • Example: Make the correct decision to approve, postpone or modify an equipment outage request.

  16. Written Guide for Task Verification • Guide contains: • Evaluator & operator activities • Task objectives • Training content • Resources (equipment, material, etc.) • References • Useful document for both evaluator and operator being verified on a task.

  17. Observation Checklists • Operator must be checked off as successfully completing each step of the task. • Checklist can be part of Task Verification Guide. • Document evidence that System Operator has achieved the objective of each task and can perform said task satisfactorily!

  18. Qualified Task Evaluator • Experienced and knowledgeable staff must verify task performance. • Evaluators should have both: • Competence at performing the reliability-related tasks. • Skill in communicating and guiding others.

  19. Task Verification Guide Example (Performance Check List)

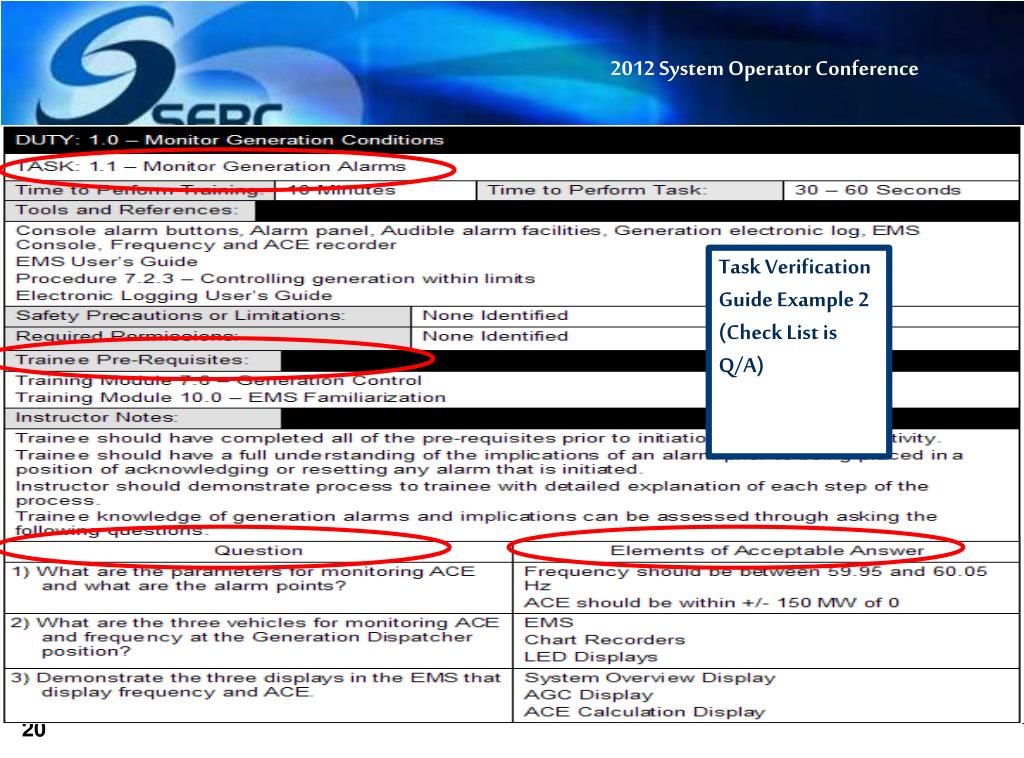

  20. OJT Guide – Example 1 Task Verification Guide Example 2 (Check List is Q/A)

  21. PER-005, REQUIREMENT 2: Task Verification of Performance PER-005 R2.1 also provides for task modification or the addition of new tasks. Within 6 months of a new or modified task, you must be verified on that task.

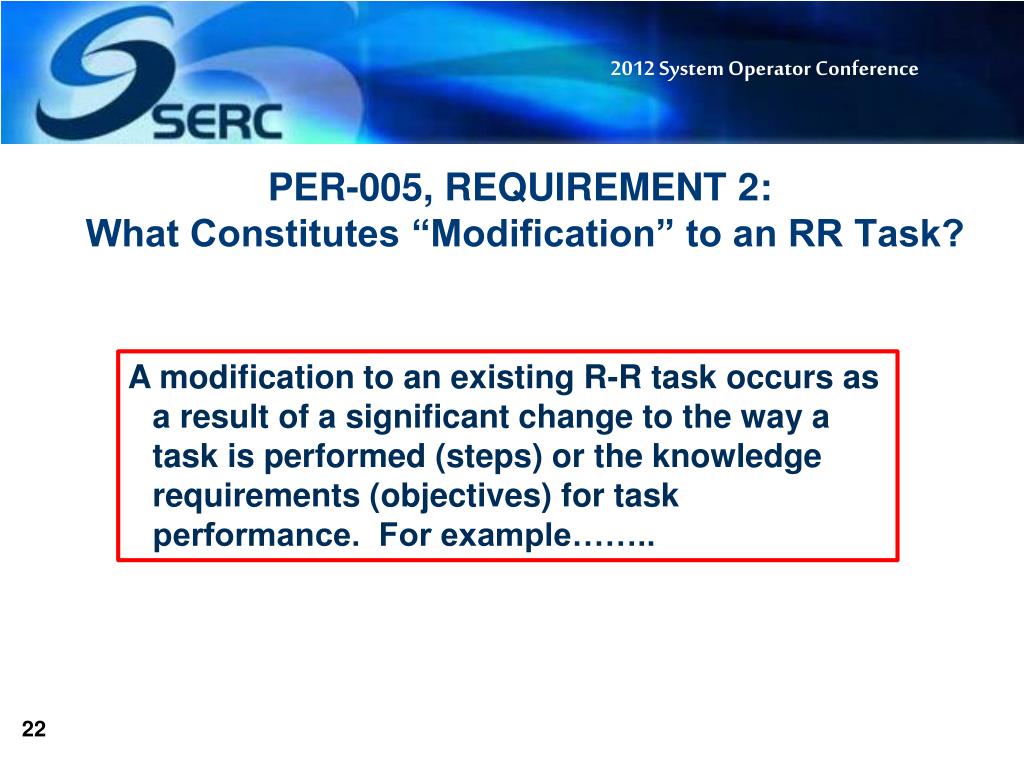

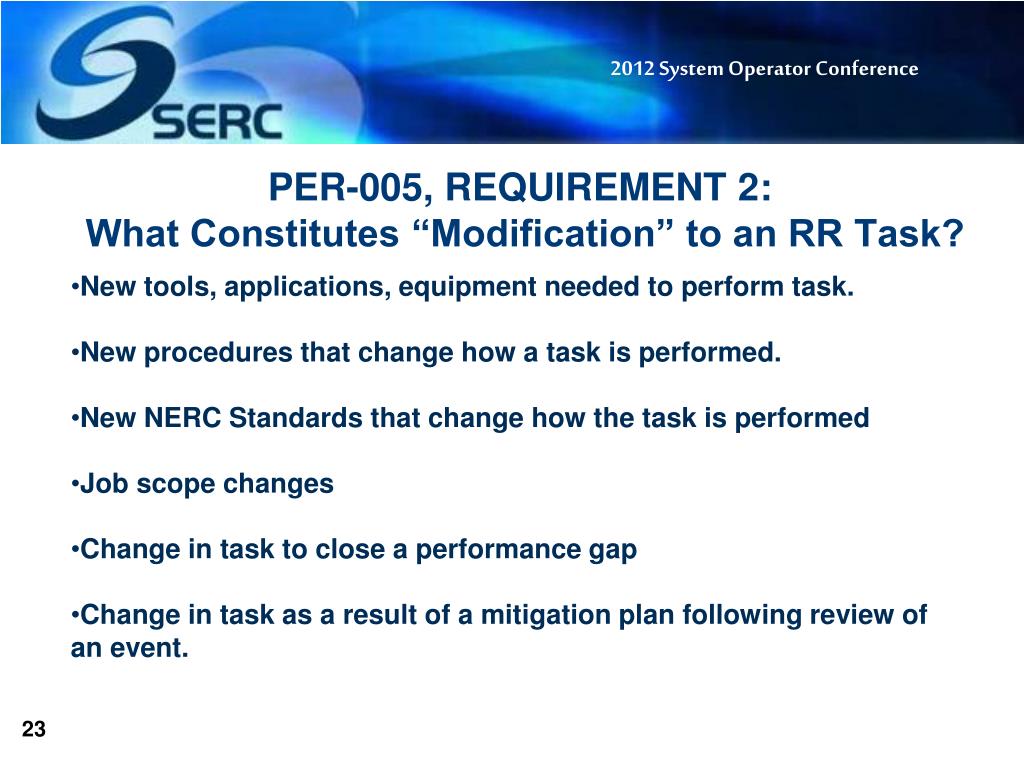

  22. PER-005, REQUIREMENT 2: What Constitutes “Modification” to an RR Task? A modification to an existing R-R task occurs as a result of a significant change to the way a task is performed (steps) or the knowledge requirements (objectives) for task performance. For example……..

  23. PER-005, REQUIREMENT 2: What Constitutes “Modification” to an RR Task? • New tools, applications, equipment needed to perform task. • New procedures that change how a task is performed. • New NERC Standards that change how the task is performed • Job scope changes • Change in task to close a performance gap • Change in task as a result of a mitigation plan following review of an event.

  24. Where Do we Stand With Task Verification? On Track to Meet April 1, 2013 Effective Date?

  25. Summary • PER-005 R1 requires a training program be developed based on a systematic approach. R2 requires each operator be verified on each RR task at least once. Both R1 & R2 are effective April 1, 2013. • PER-005 R2 has the biggest impact on operators, since each operator must be verified that they are capable or performing each RR task successfully.

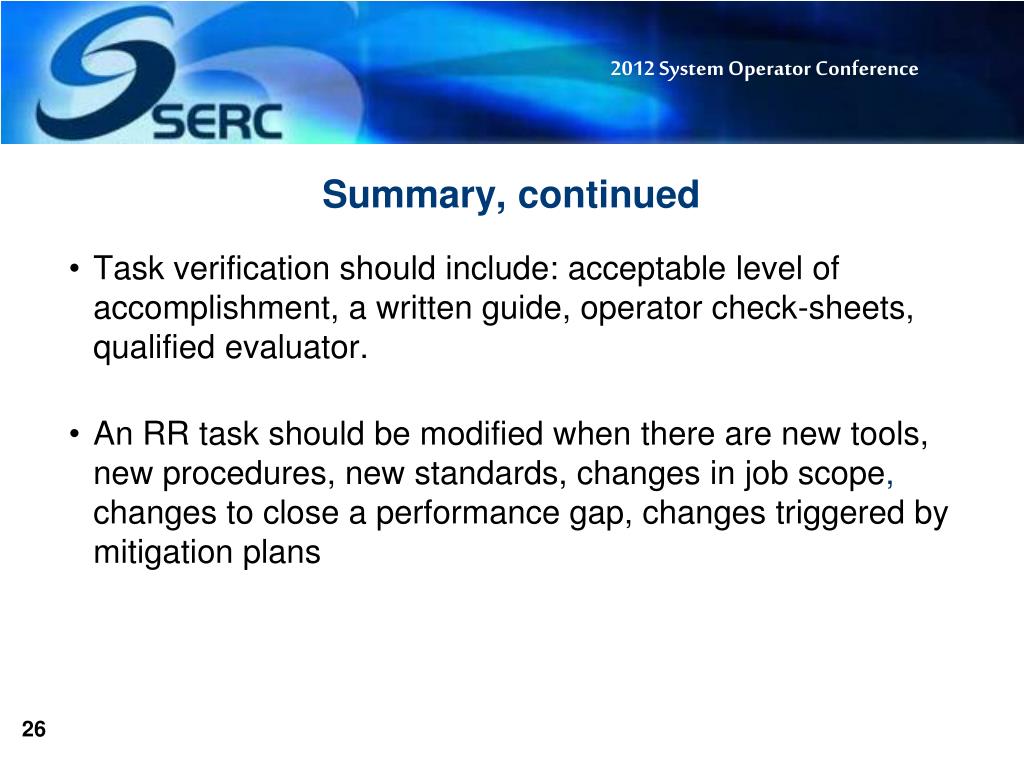

  26. Summary, continued • Task verification should include: acceptable level of accomplishment, a written guide, operator check-sheets, qualified evaluator. • An RR task should be modified when there are new tools, new procedures, new standards, changes in job scope, changes to close a performance gap, changes triggered by mitigation plans

  27. Questions?
