CE 405 - SCHEDULING

DESCRIPTION

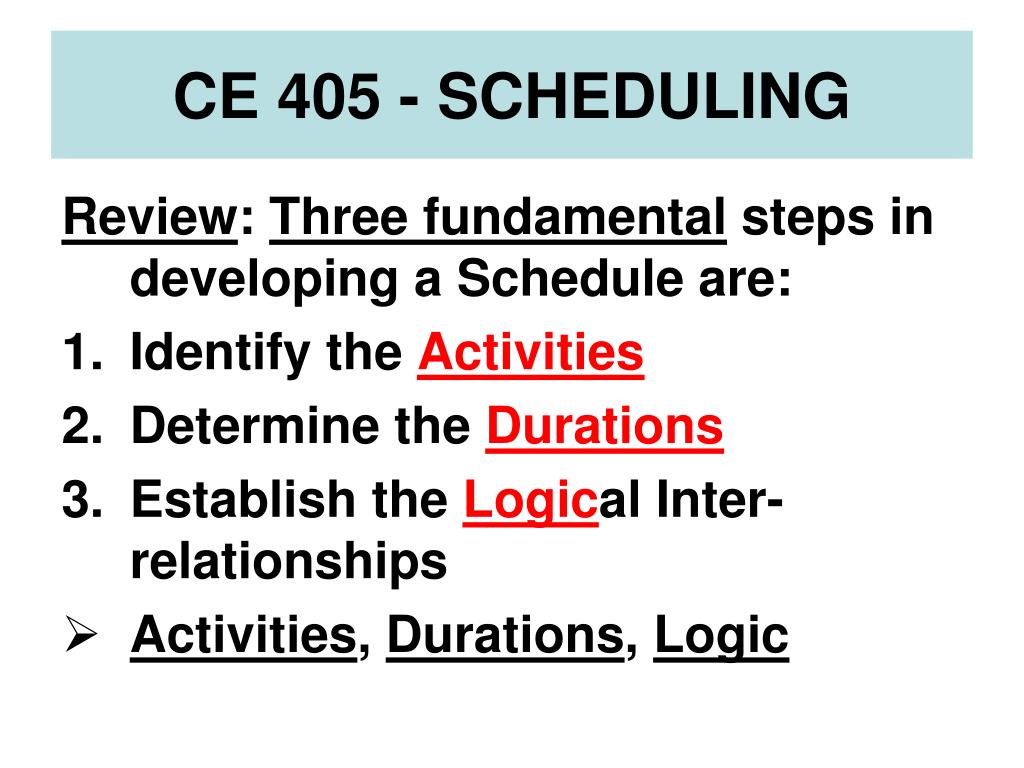

CE 405 - SCHEDULING. Review : Three fundamental steps in developing a Schedule are: Identify the Activities Determine the Durations Establish the Logic al Inter-relationships Activities , Durations , Logic. CE 405 - SCHEDULING. Activities , Durations , Logic

1 / 95

Télécharger la présentation

CE 405 - SCHEDULING

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. CE 405 - SCHEDULING Review: Three fundamental steps in developing a Schedule are: • Identify the Activities • Determine the Durations • Establish the Logical Inter-relationships • Activities, Durations, Logic

  2. CE 405 - SCHEDULING Activities, Durations, Logic • None of these three is really a single, stand-alone operation • Experienced Schedulers often think of these three processes as a single process – especially the relation of durations to logic

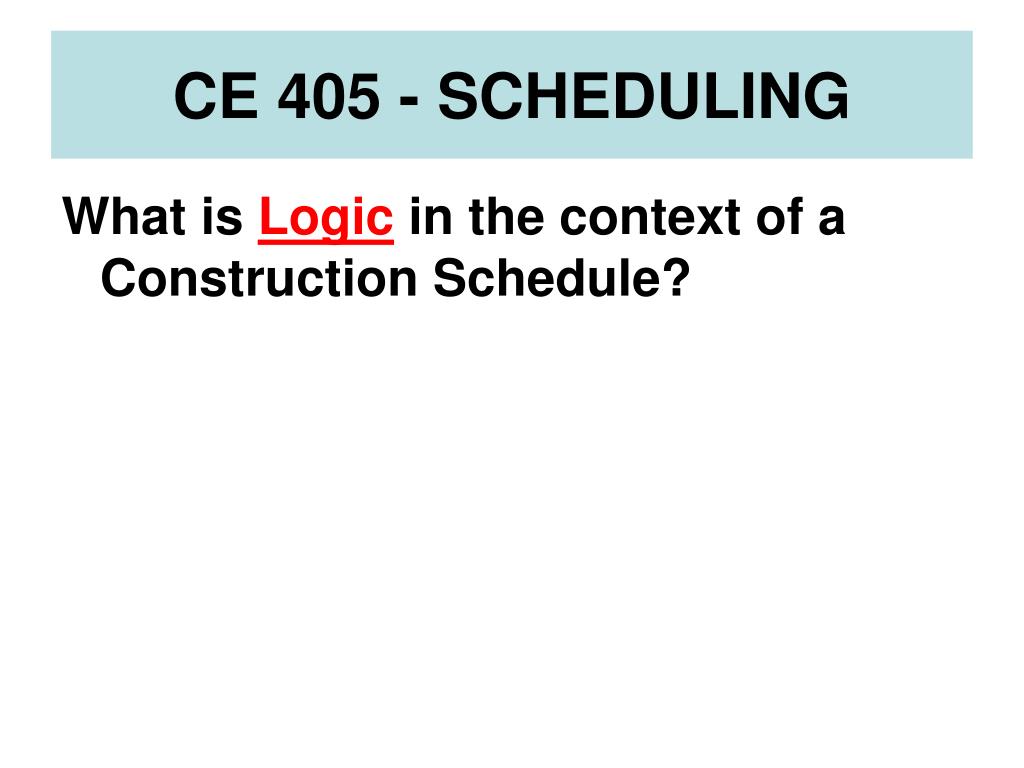

  3. CE 405 - SCHEDULING What is Logic in the context of a Construction Schedule?

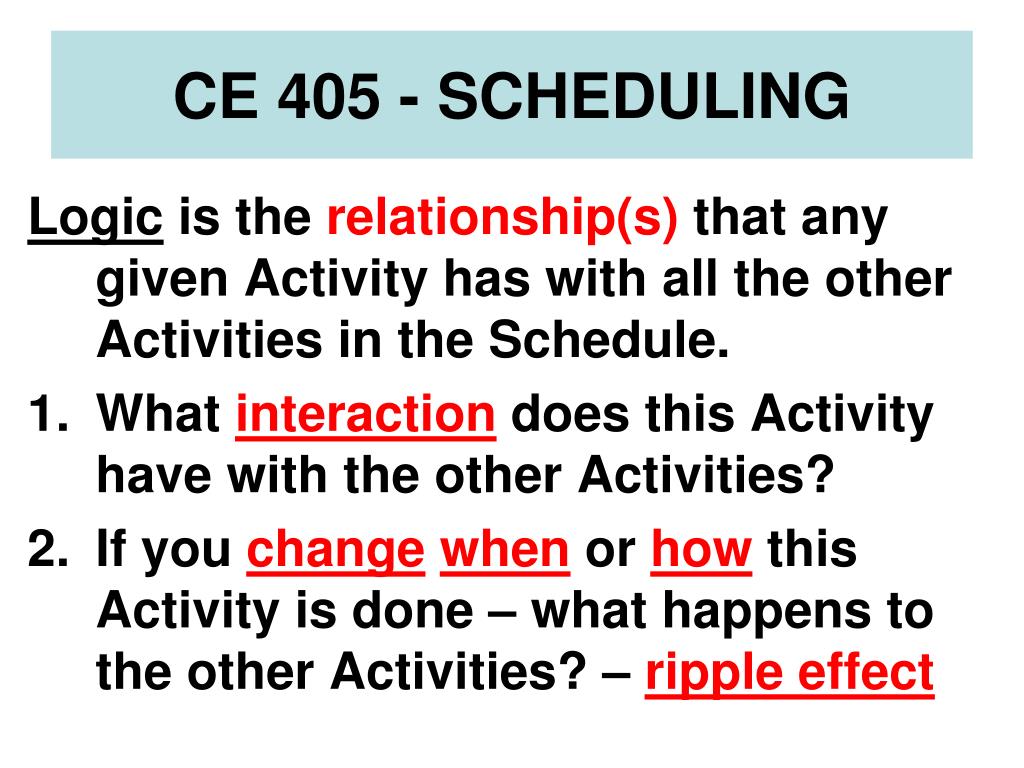

  4. CE 405 - SCHEDULING Logic is the relationship(s) that any given Activity has with all the other Activities in the Schedule. • What interaction does this Activity have with the other Activities? • If you changewhen or how this Activity is done – what happens to the other Activities? – ripple effect

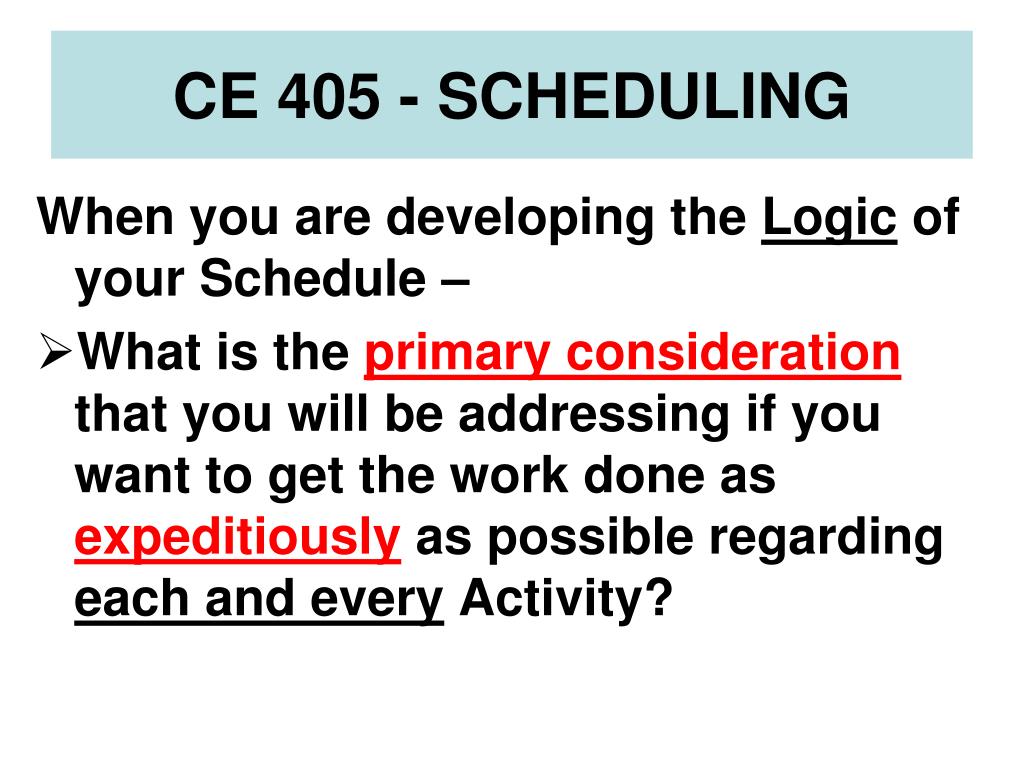

  5. CE 405 - SCHEDULING When you are developing the Logic of your Schedule – • What is the primary consideration that you will be addressing if you want to get the work done as expeditiously as possible regarding each and every Activity?

  6. CE 405 - SCHEDULING Expedited Logic? • What Activities must be completed before I can Start work on this Activity • What Activities can be worked on at the same time that I am working on this Activity.

  7. CE 405 - SCHEDULING The three terms that pertain to the Logic of your Schedule are: • Dependencies

  8. CE 405 - SCHEDULING The three terms that pertain to the Logic of your Schedule are: • Dependencies • Sequential work

  9. CE 405 - SCHEDULING The three terms that pertain to the Logic of your Schedule are: • Dependencies • Sequential work • Concurrent work

  10. CE 405 - SCHEDULING What is your definition of Dependencies in a Schedule?

  11. CE 405 - SCHEDULING Definition of Dependencies? • What work (Activities) must be completed before I can start work on this Activity [Predecessors] • What work (Activities) can not start until work on this Activity is completed [Successors]

  12. Predecessor - controls the start or finish of another activity • Successor - depends on the start or finish of another activity Predecessor to Act. B Successor to Act. B 10-3

  13. CE 405 - SCHEDULING What is your definition of Sequence?

  14. CE 405 - SCHEDULING Definition of Sequence? • A group (string or chain) of Activities that proceed in a logical order – the preceding Activity has to be Substantially Complete before the follow-on Activity can start

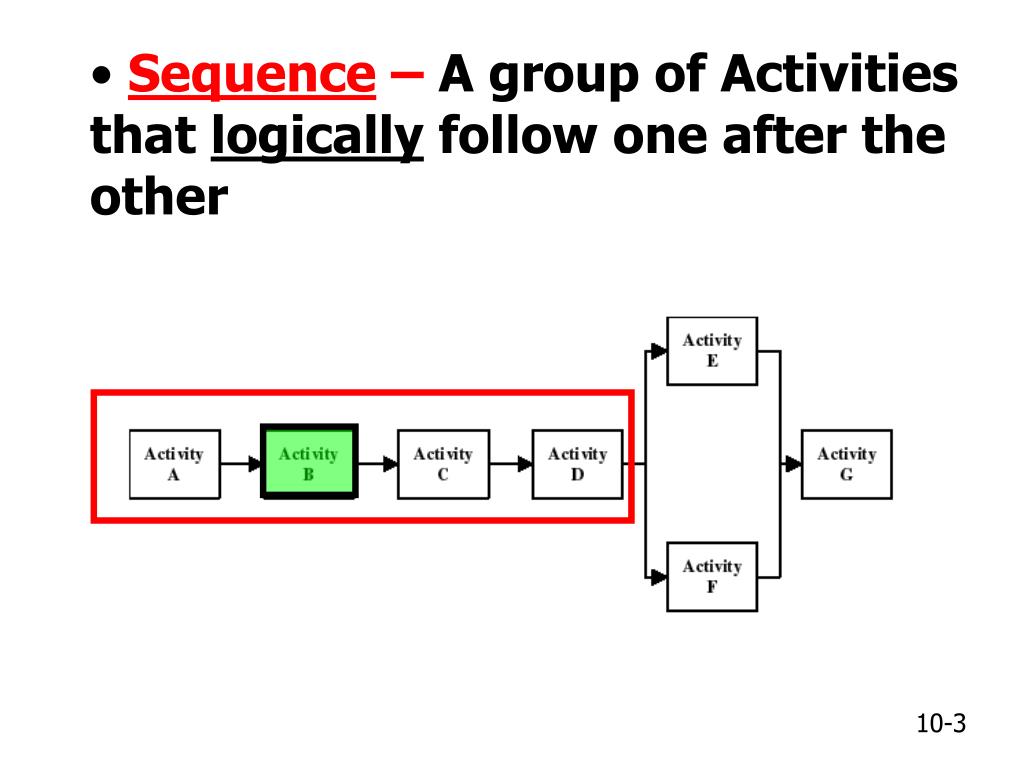

  15. Sequence – A group of Activities that logically follow one after the other 10-3

  16. CE 405 - SCHEDULING Review: The term Substantially Complete was used on the preceding slide – what does it mean in relation to a Construction Activity (not the job as a whole)?

  17. CE 405 - SCHEDULING Substantially Complete is when work on a given Activity has proceeded to the point that work on following Activities can Start. • Work on a CMU block wall can start even if the forms have not been stripped off the footings

  18. CE 405 - SCHEDULING What would be the Activity Sequence for a CMU foundation wall?

  19. CE 405 - SCHEDULING Activity Sequence for foundation wall? • Survey/Layout • Excavate • Form/Place Footing • Lay CMU block • Each Successor Activity logically follows the Predecessor Activity

  20. CE 405 - SCHEDULING The third term associated with logic is concurrent – what does this mean?

  21. CE 405 - SCHEDULING Definition of concurrent? • What other Activities can be worked on at the same time that work is proceeding on this Activity?

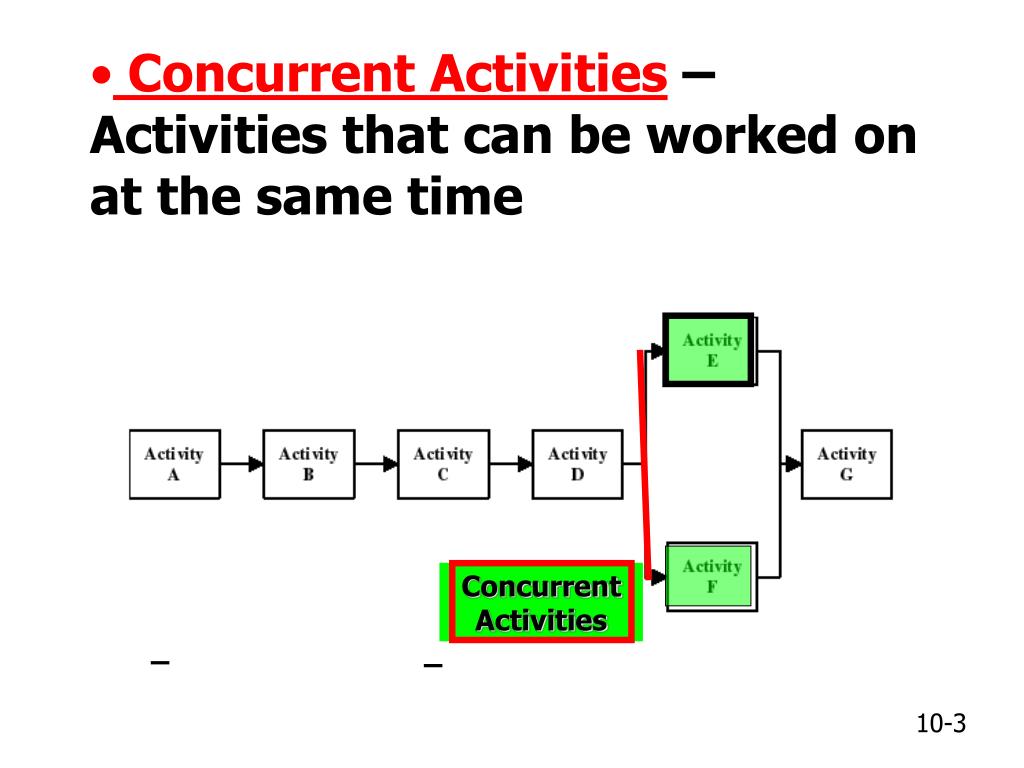

  22. Concurrent Activities – Activities that can be worked on at the same time Concurrent Activities 10-3

  23. CE 405 - SCHEDULING Definition of concurrent? • After a building is dried-in and the interior is painted – what would be some of the concurrent Activities that could be worked on? • First of all – what does dried-inmean?

  24. CE 405 - SCHEDULING Dried-in definition? • All work necessary to “waterproof” the interior is complete • Shingles are on, doors and windows are in, siding/fascia/soffits are done, etc.

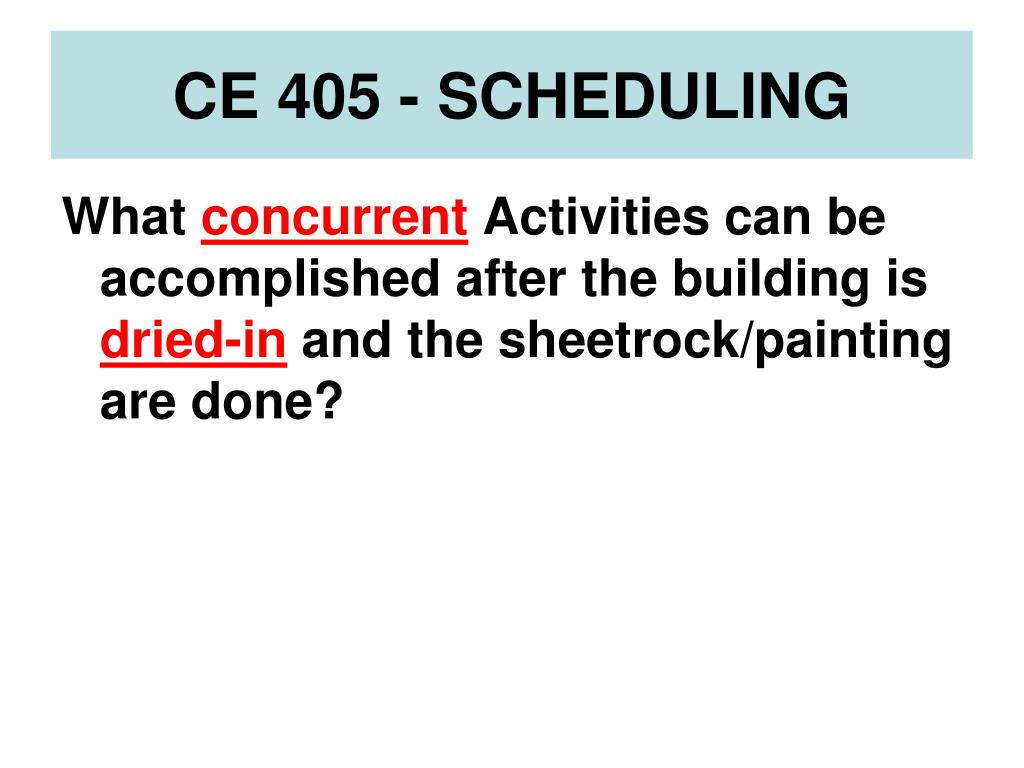

  25. CE 405 - SCHEDULING What concurrent Activities can be accomplished after the building is dried-inand the sheetrock/painting are done?

  26. CE 405 - SCHEDULING Concurrent Activities after dried-in? • Interior finishes – baseboard, trim • Finish electrical work/fixtures • Finish mechanical/HVAC • Finish plumbing • Cabinetry • Flooring

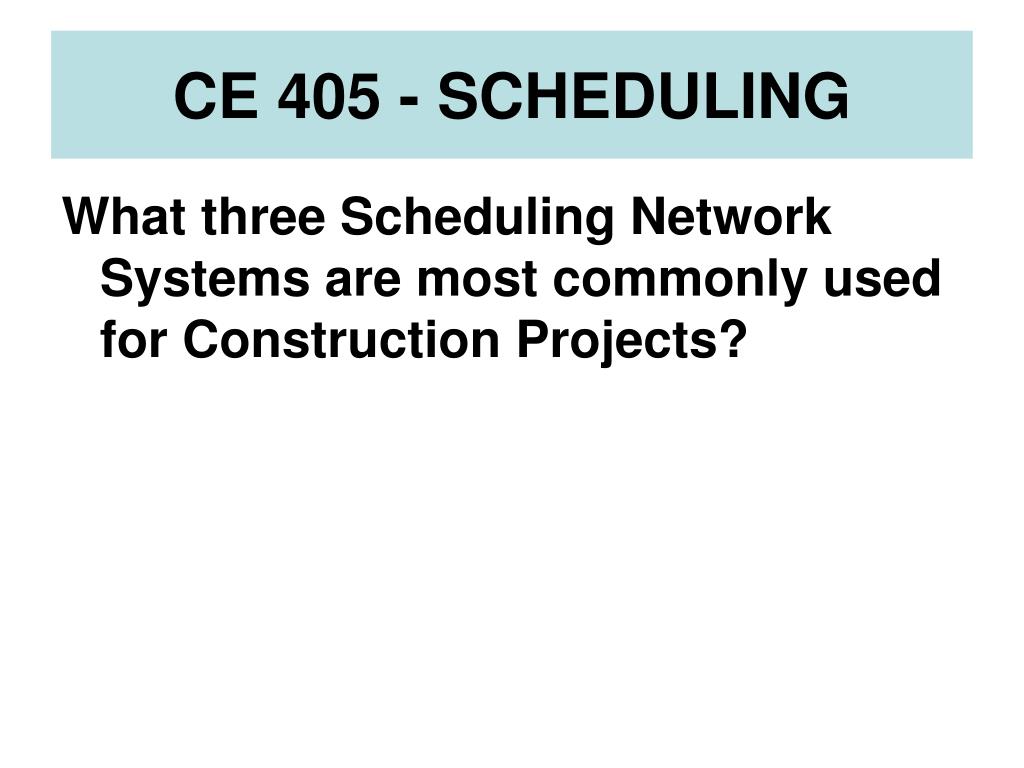

  27. CE 405 - SCHEDULING What three Scheduling Network Systems are most commonly used for Construction Projects?

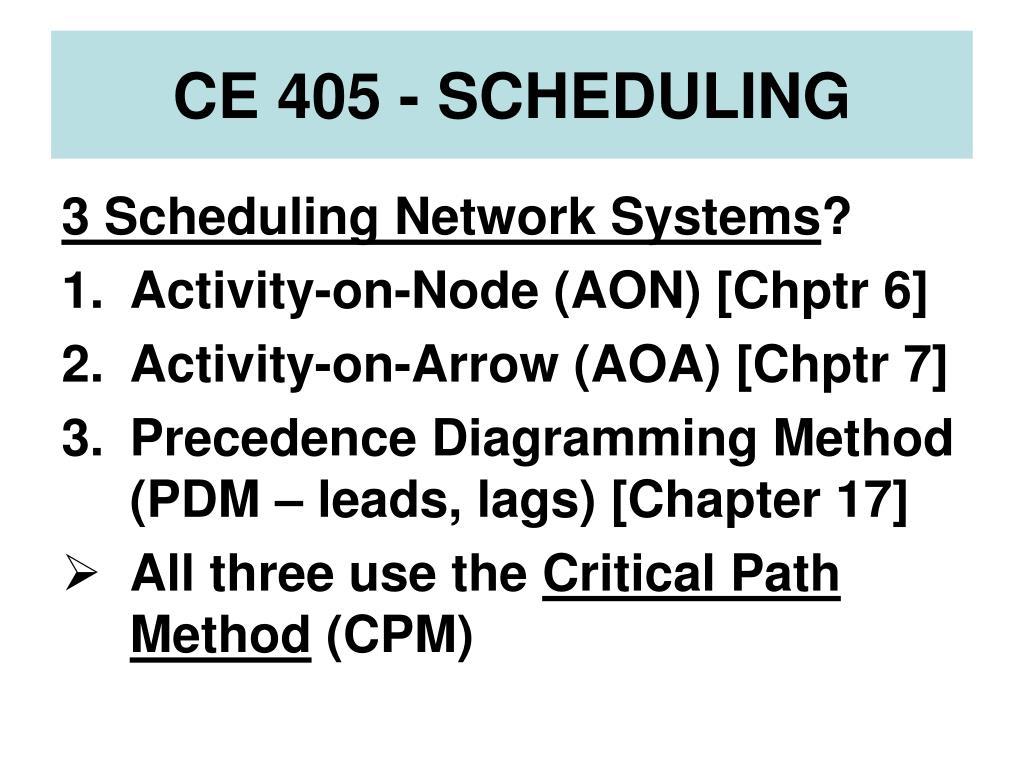

  28. CE 405 - SCHEDULING 3 Scheduling Network Systems? • Activity-on-Node (AON) [Chptr 6] • Activity-on-Arrow (AOA) [Chptr 7] • Precedence Diagramming Method (PDM – leads, lags) [Chapter 17] • All three use the Critical Path Method (CPM)

  29. CE 405 – SCHEDULINGCRITICAL PATH Critical Path Method (CPM) handout • Logic Boxes – numerous layouts • Combination Convention • BOTD + EOTD [Primavera]

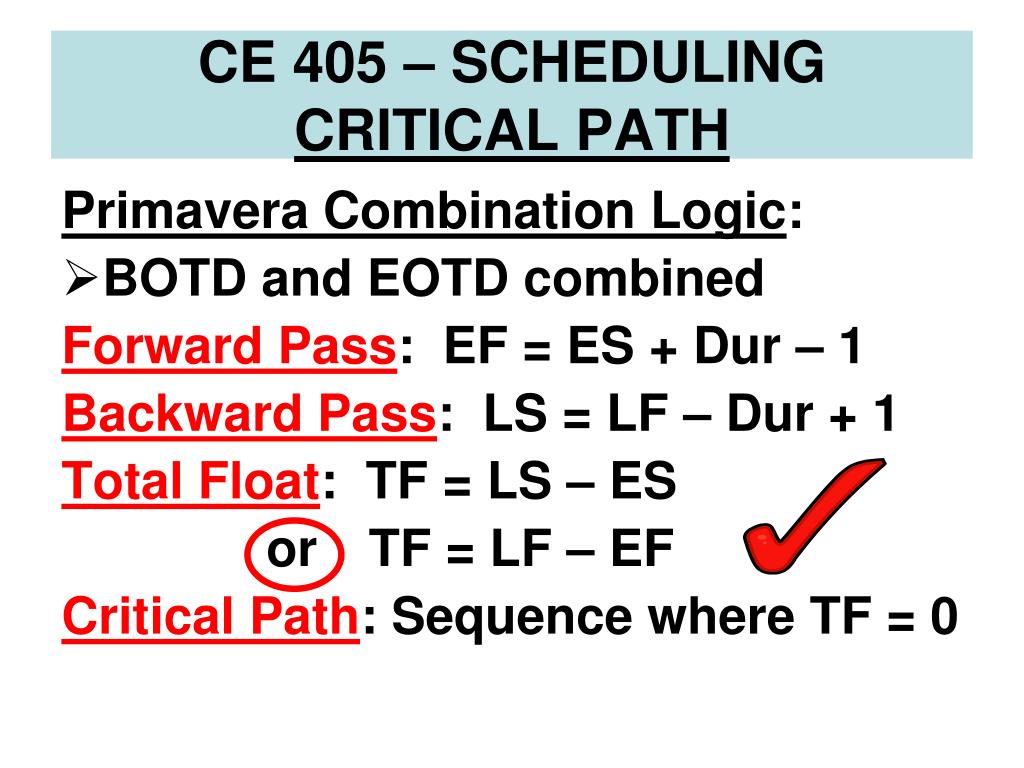

  30. CE 405 – SCHEDULINGCRITICAL PATH Primavera Combination Logic: • BOTD and EOTD combined Forward Pass: EF = ES + Dur – 1 Backward Pass: LS = LF – Dur + 1 Total Float: TF = LS – ES or TF = LF – EF Critical Path: Sequence where TF = 0

  31. CE 405 - SCHEDULING Network Model Characteristics: 1. Discrete Activities 2. Deterministic (vs Probabilistic) Durations 3. DeterministicLogic 4. Activities “Flow” from Start to Finish

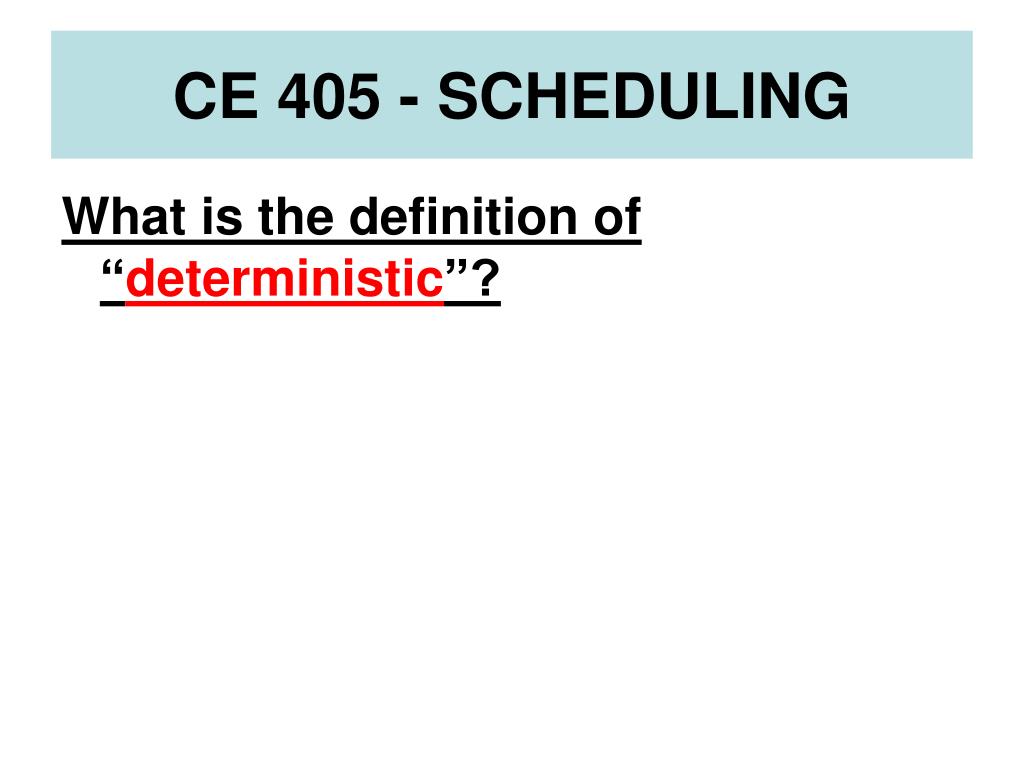

  32. CE 405 - SCHEDULING What is the definition of “deterministic”?

  33. CE 405 - SCHEDULING Definition of “deterministic”? • You have “pre-supposed” (i.e. made your mind up) that things will proceed in a preconceived manner to an all ready decided end result (i.e. a foregone conclusion) • Contrasted with “probabilistic”?

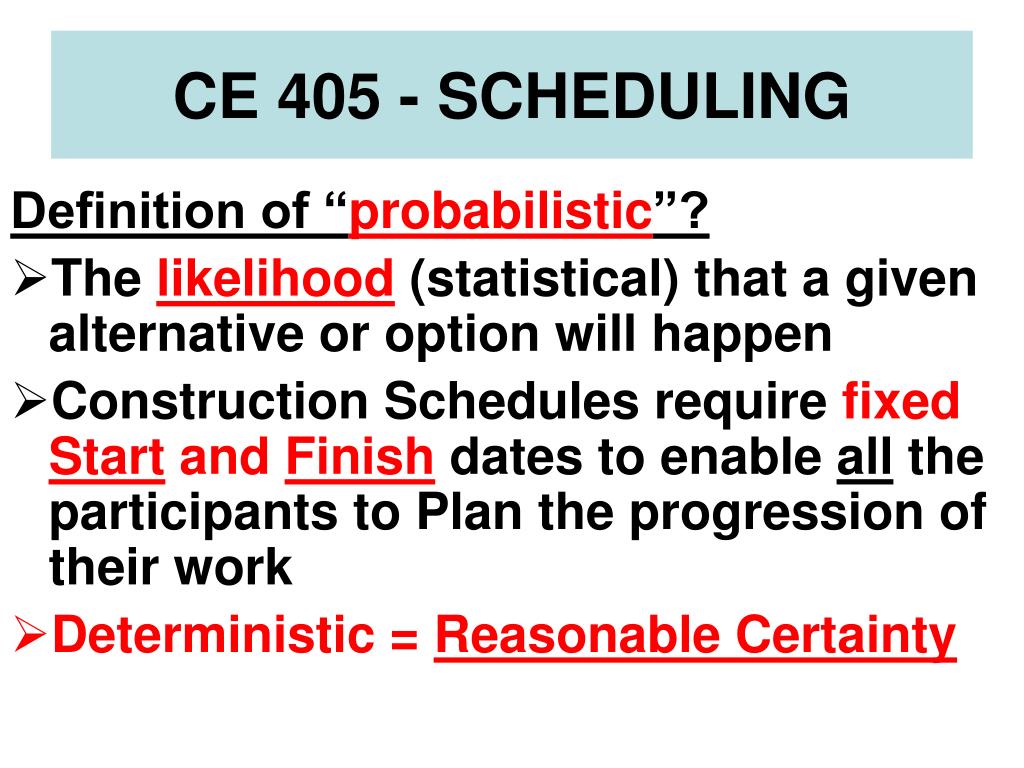

  34. CE 405 - SCHEDULING Definition of “probabilistic”? • The likelihood (statistical) that a given alternative or option will happen • Construction Schedules require fixed Start and Finish dates to enable all the participants to Plan the progression of their work • Deterministic = Reasonable Certainty

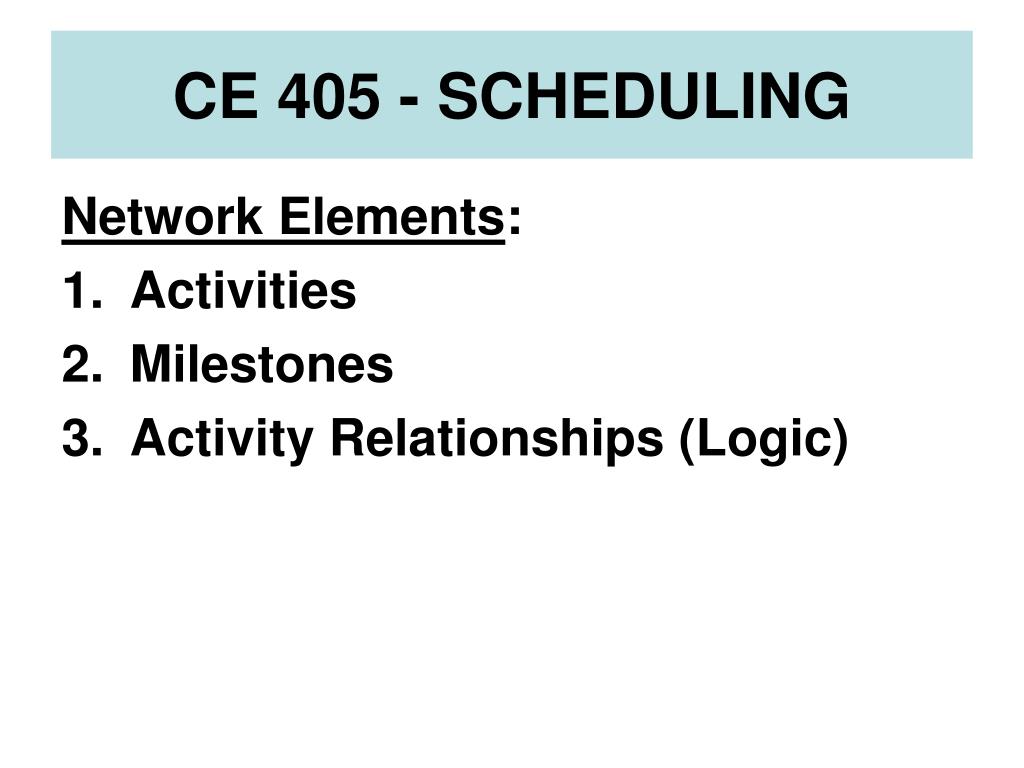

  35. CE 405 - SCHEDULING Network Elements: • Activities • Milestones • Activity Relationships (Logic)

  36. CE 405 - SCHEDULING Review: What is a Milestone?

  37. CE 405 - SCHEDULING Review: What is a Milestone? • A Milestone marks a “point-in-time” – but unlike an Activity, it does not consume any time within a Construction Schedule

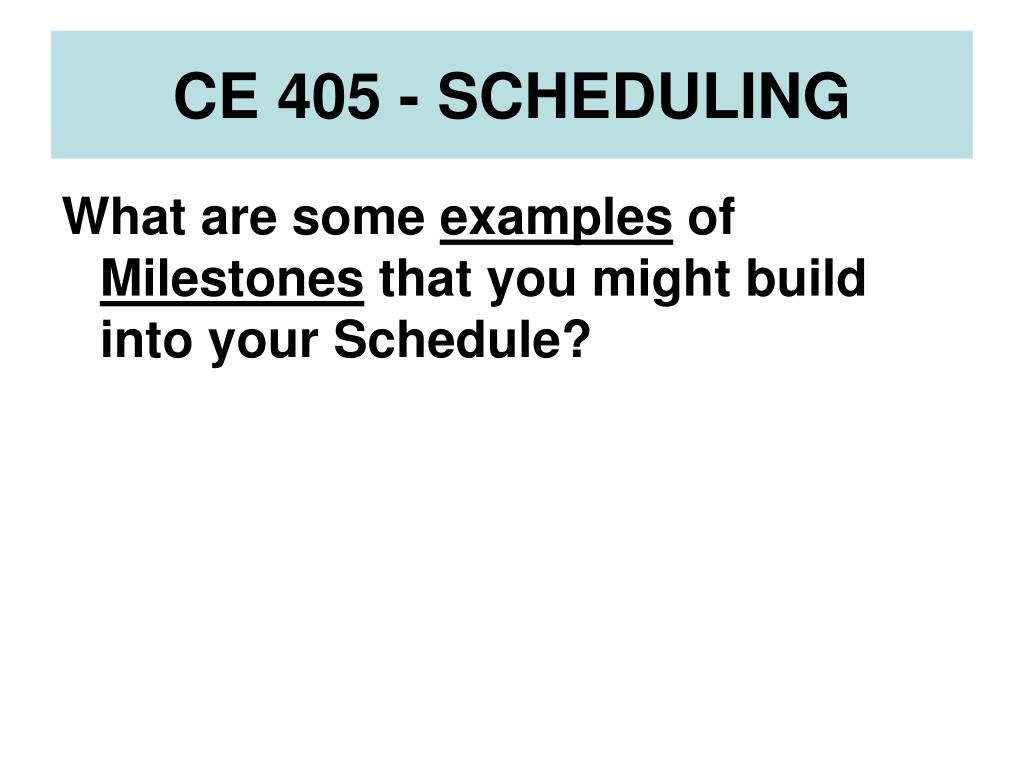

  38. CE 405 - SCHEDULING What are some examples of Milestones that you might build into your Schedule?

  39. CE 405 - SCHEDULING Examples of Milestones? • Notice to Proceed (NTP) • Usually considered to be the first day of your Schedule (Day 1)

  40. CE 405 - SCHEDULING Examples of Milestones? • Notice to Proceed (NTP) • Building “Dried-in”

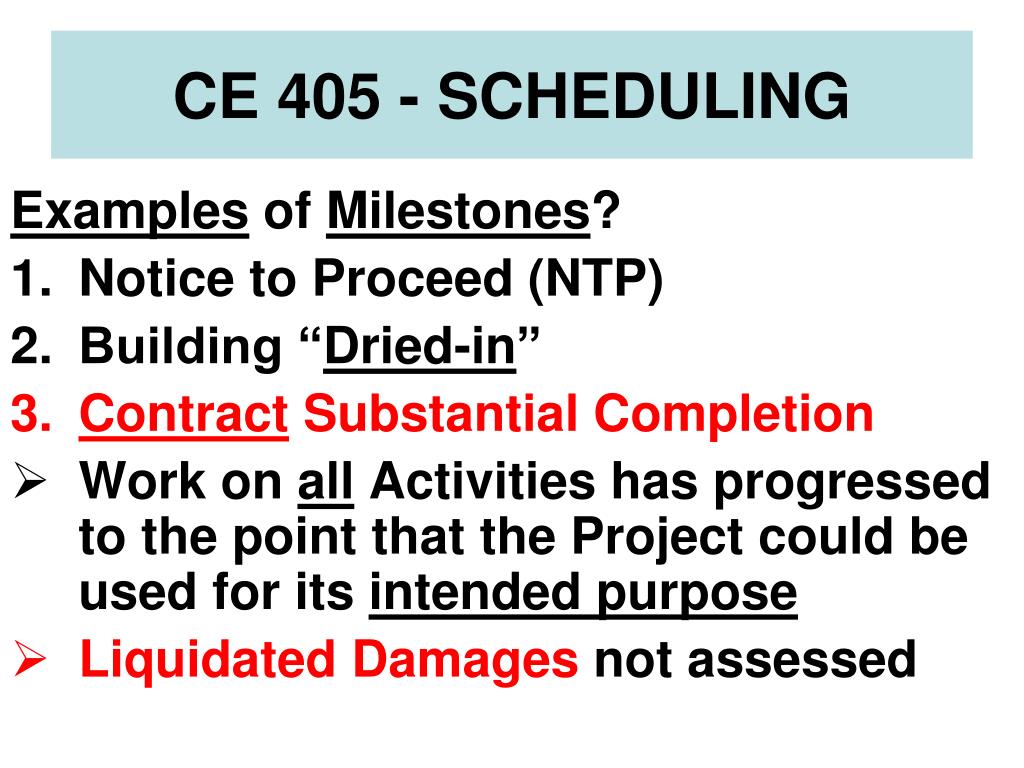

  41. CE 405 - SCHEDULING Examples of Milestones? • Notice to Proceed (NTP) • Building “Dried-in” • Contract Substantial Completion • Work on all Activities has progressed to the point that the Project could be used for its intended purpose • Liquidated Damages not assessed

  42. CE 405 - SCHEDULING Examples of Milestones? • Notice to Proceed (NTP) • Building “Dried-in” • Contract Substantial Completion • Project Complete • The Owner has accepted the work and will make Final Payment

  43. CE 405 - SCHEDULING Activity-On-Node (AON) Networks: • AON Networks are normally displayed as “boxes” connected with “lines”. The “lines” indicate some form of relationship between the “boxes” at each end.

  44. Red logic boxes = Critical Path • “X-ed” boxes means Activity is complete.

  45. CE 405 - SCHEDULING Primavera software is based on the generic Precedence Diagramming Method (PDM).

  46. CE 405 - SCHEDULING Activity-On-Node (AON) Networks: • By definition – preceding [Predecessor] Activities in an AON network must Finish before the following [Successor] Activity can Start. This is described as a “Finish-to-Start” relationship.

  47. CE 405 - SCHEDULING REVIEW: What were the four types of Activity Relationships that we covered during the Bar Chart discussion?

  48. CE 405 - SCHEDULING Four types of Activity Relationships: • Physical • Safety • Resource • Preferential

  49. CE 405 - SCHEDULING What is a Constraint in a Scheduling context?

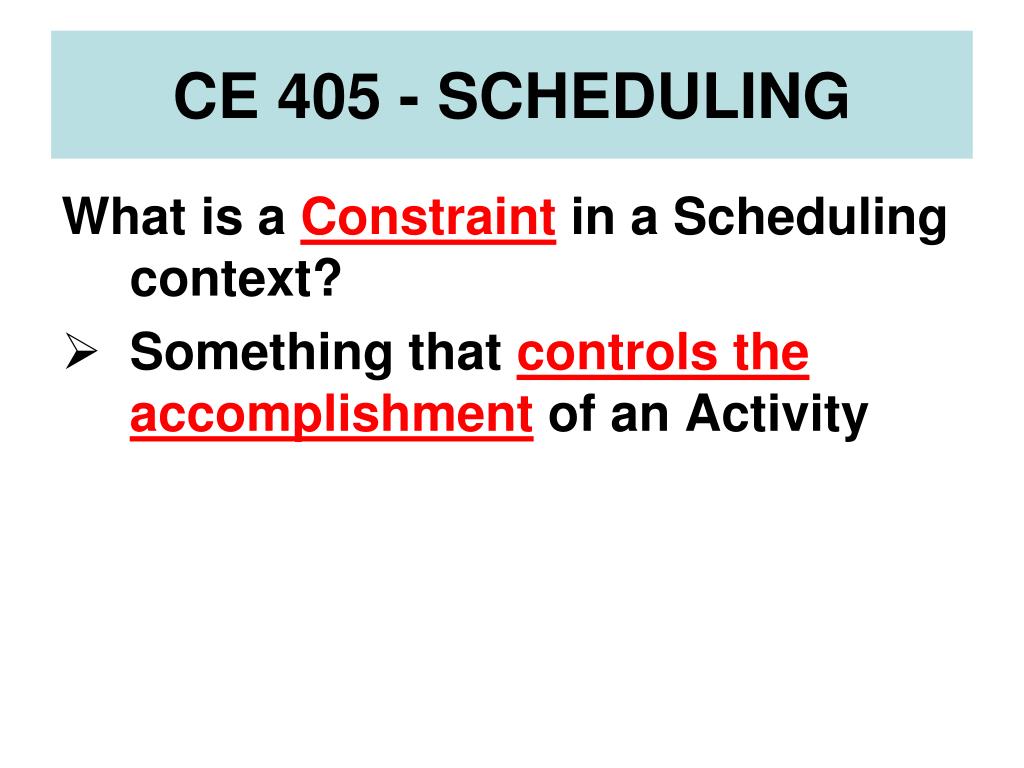

  50. CE 405 - SCHEDULING What is a Constraint in a Scheduling context? • Something that controls the accomplishment of an Activity
