> Operational Research >> Integer Programming >>> Branch and Bound method

pooky avatar
9 diapositives · 332 Views · Aug 30, 2014

> Operational Research >> Integer Programming >>> Branch and Bound method. John.woodward@nottingham.edu.cn. Person-Task Problem. 4 people {A,B,C,D} and 4 tasks {1,2,3,4} The table below shows the number of minutes for each person to complete each task. Each person does one task.

> Operational Research >> Integer Programming >>> Branch and Bound method - slide 1
01 / 9> Operational Research >> Integer Programming >>> Branch and Bound method
1 / 17

Télécharger la présentation

> Operational Research >> Integer Programming >>> Branch and Bound method
Une image / un lien ci-dessous est fourni (tel quel) pour télécharger la présentation

Politique de téléchargement : le contenu du site vous est fourni TEL QUEL pour votre information et votre usage personnel ; il ne peut être vendu, concédé sous licence ni partagé sur d’autres sites sans l’accord de son auteur.Le contenu vous est fourni TEL QUEL, pour votre information et votre usage personnel uniquement. Téléchargez la présentation en cliquant sur ce lien. Lors du téléchargement, si vous ne parvenez pas à télécharger une présentation, l’éditeur a peut-être supprimé le fichier de son serveur.Pendant le téléchargement, si vous ne parvenez pas à obtenir une présentation, le fichier a peut-être été supprimé par l’éditeur.

F I N

Plus de contenu associé

Transcription de la présentation
  1. > Operational Research>> Integer Programming >>> Branch and Bound method John.woodward@nottingham.edu.cn

  2. Person-Task Problem • 4 people {A,B,C,D} and 4 tasks {1,2,3,4} • The table below shows the number of minutes for each person to complete each task. • Each person does one task. • Each task needs an assigned a person. • Minimize total time taken. • How do we assign people to tasks? • E.g. ACDB =9+1+2+6 = 18 minutes in total. John Woodward Branch and Bound

  3. Example of Bounding Function • Example, calculate best value given partial assignment A??? • (A does task 1, other tasks are not yet assigned)? • The cost of assigning person A to task 1 is 9 minutes • Best unassigned person for • 2 is C (1), 3 is D (2), 4 is C (2) in (minutes) • Note that C is assigned twice! • Total time = (9+1+2+2) = 14 minutes. • We want to minimize so the bounding function is an underestimate. John Woodward Branch and Bound

  4. Branch and Bound Stage 1 Task 0 Task 1 Task 2 Task 3 Incumbent (best complete) solution None yet. PRUNED FEASIBLE PRUNED & FESIBLE John Woodward Branch and Bound

  5. Branch and Bound Stage 2 Task 0 Task 1 Task 2 Task 3 ACDC=14 Incumbent (best complete) solution CBDA = 13 Pruned as > 13 DCCC=8 BCDC=9 CBDA=13 promising Feasible so is1st incumbent. There is no point growing this node any more. PRUNED promising PRUNED & FESIBLE FEASIBLE John Woodward Branch and Bound

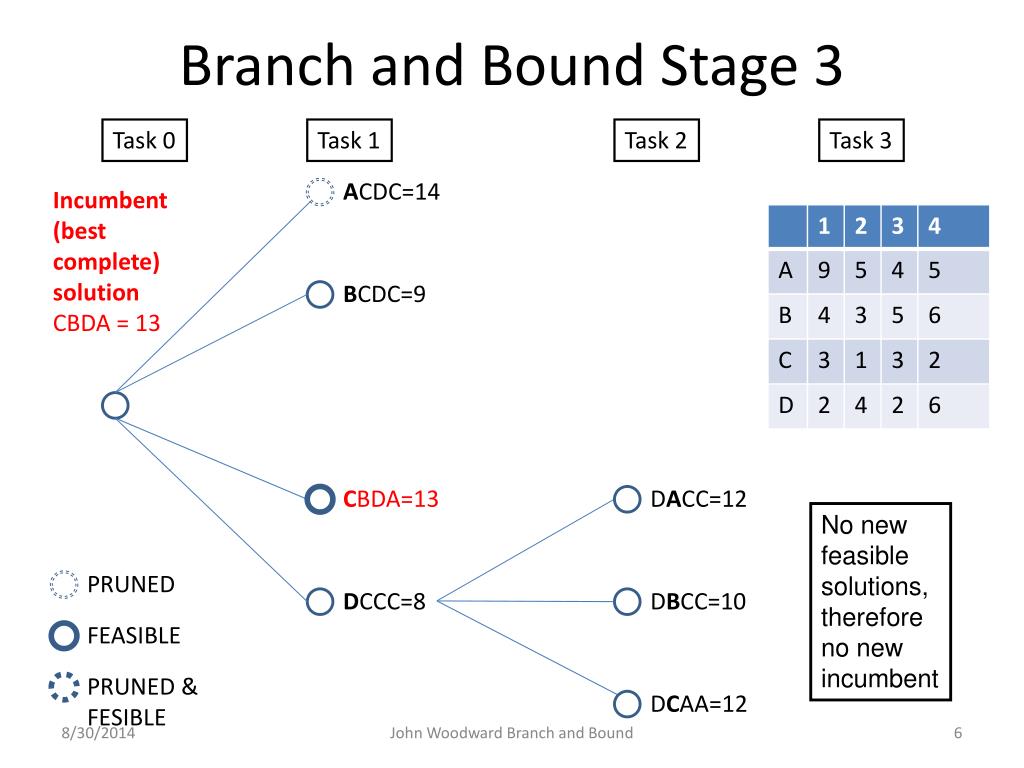

  6. Branch and Bound Stage 3 Task 0 Task 1 Task 2 Task 3 ACDC=14 Incumbent (best complete) solution CBDA = 13 DCCC=8 CBDA=13 BCDC=9 DACC=12 No new feasible solutions, therefore no new incumbent PRUNED DBCC=10 FEASIBLE PRUNED & FESIBLE DCAA=12 John Woodward Branch and Bound

  7. Branch and Bound Stage 4 Task 0 Task 1 Task 2 Task 3 ACDC=14 BADC=13 Incumbent (best complete) solution BCDA = 12 DCCC=8 DBCC=10 BCDA=12 BCDC=9 Feasible but Pruned as > 12 BDCC=13 CBDA=13 DACC=12 Pruned as > 12 PRUNED promising FEASIBLE PRUNED & FESIBLE DCAA=12 Pruned as > 12 John Woodward Branch and Bound

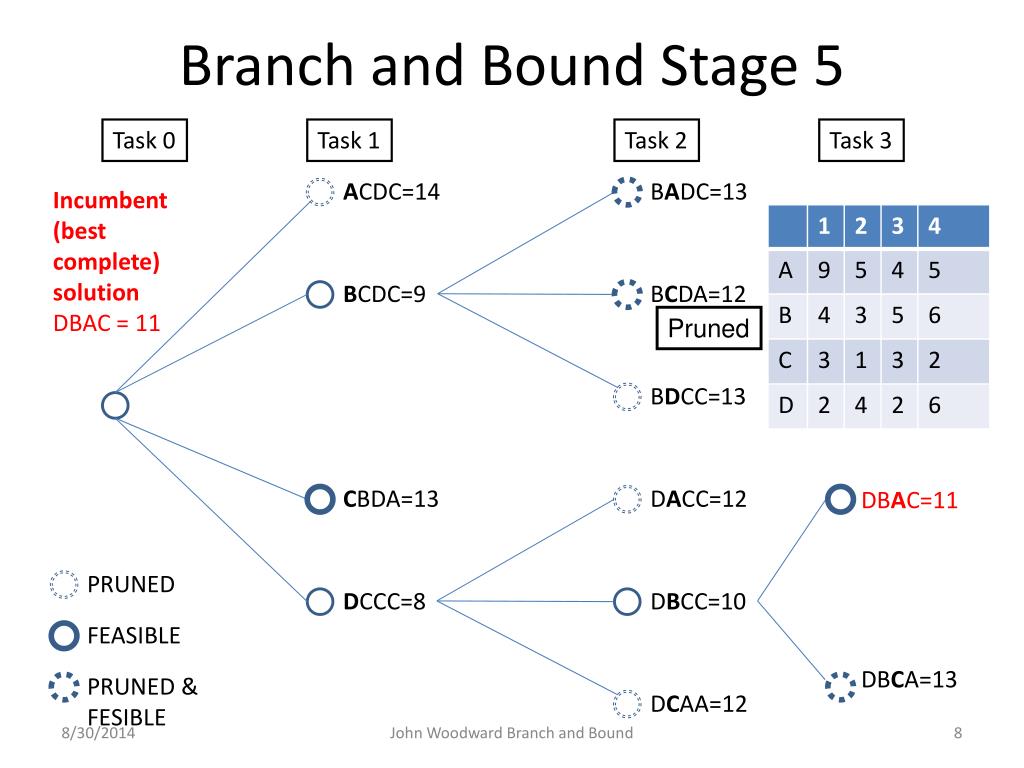

  8. Branch and Bound Stage 5 Task 0 Task 1 Task 2 Task 3 ACDC=14 BADC=13 Incumbent (best complete) solution DBAC = 11 CBDA=13 DBCC=10 DCCC=8 BCDC=9 BCDA=12 Pruned BDCC=13 DACC=12 DBAC=11 PRUNED FEASIBLE PRUNED & FESIBLE DBCA=13 DCAA=12 John Woodward Branch and Bound

  9. The End • Thank you for you attention • Any questions. John Woodward Branch and Bound
