The NSSDC Delivery Working Group convened in Washington, DC, to discuss progress on data delivery efforts and future steps. Key achievements included finalizing the electronic delivery process and establishing the Delivery Manifest generator prototype. Approximately 40% of the entire data holdings have been ingested into NSSDC, with significant volumes delivered from various disciplines, including Atmosphere, Geosciences, Imaging, and more. Future delivery processes were outlined, focusing on ongoing developments in operational software and delivery for improved efficiency.
E N D
NSSDC Delivery Working Group MC Face-to-Face Washington, DC March 25-26, 2010

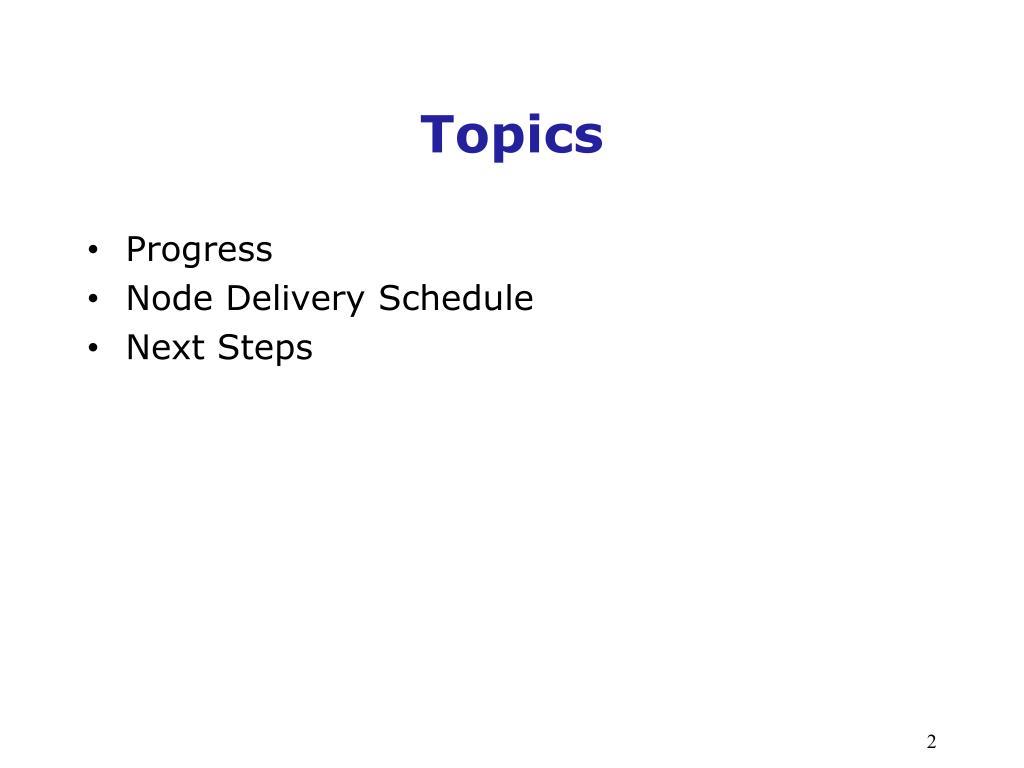

Topics • Progress • Node Delivery Schedule • Next Steps

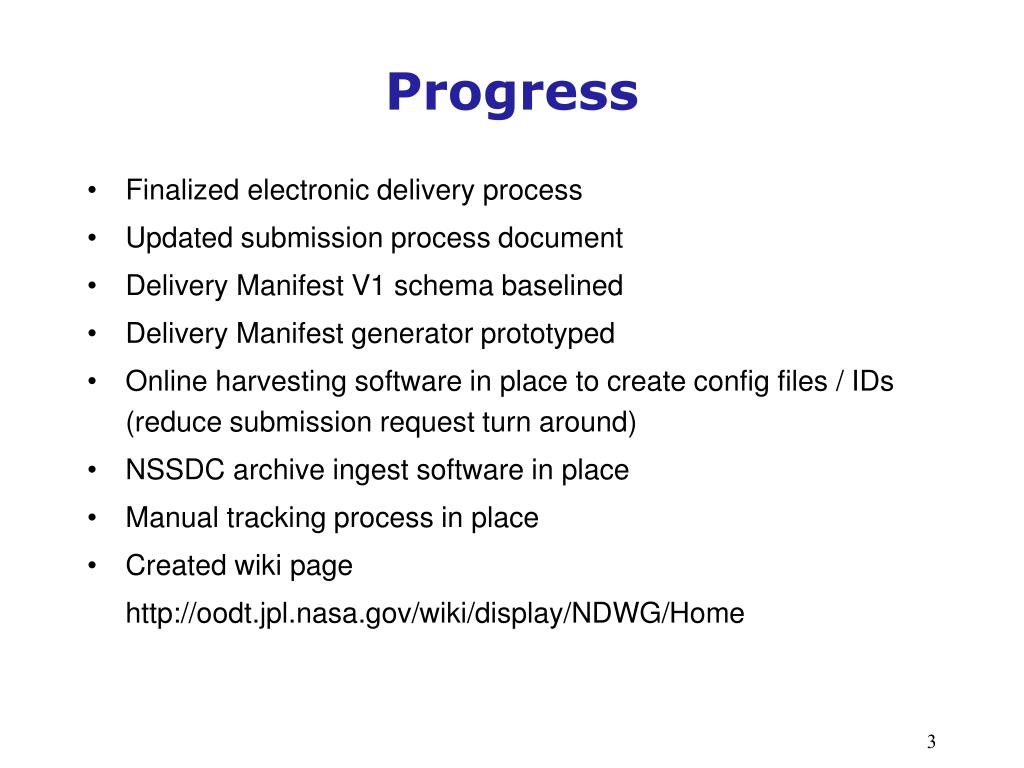

Progress • Finalized electronic delivery process • Updated submission process document • Delivery Manifest V1 schema baselined • Delivery Manifest generator prototyped • Online harvesting software in place to create config files / IDs (reduce submission request turn around) • NSSDC archive ingest software in place • Manual tracking process in place • Created wiki page http://oodt.jpl.nasa.gov/wiki/display/NDWG/Home

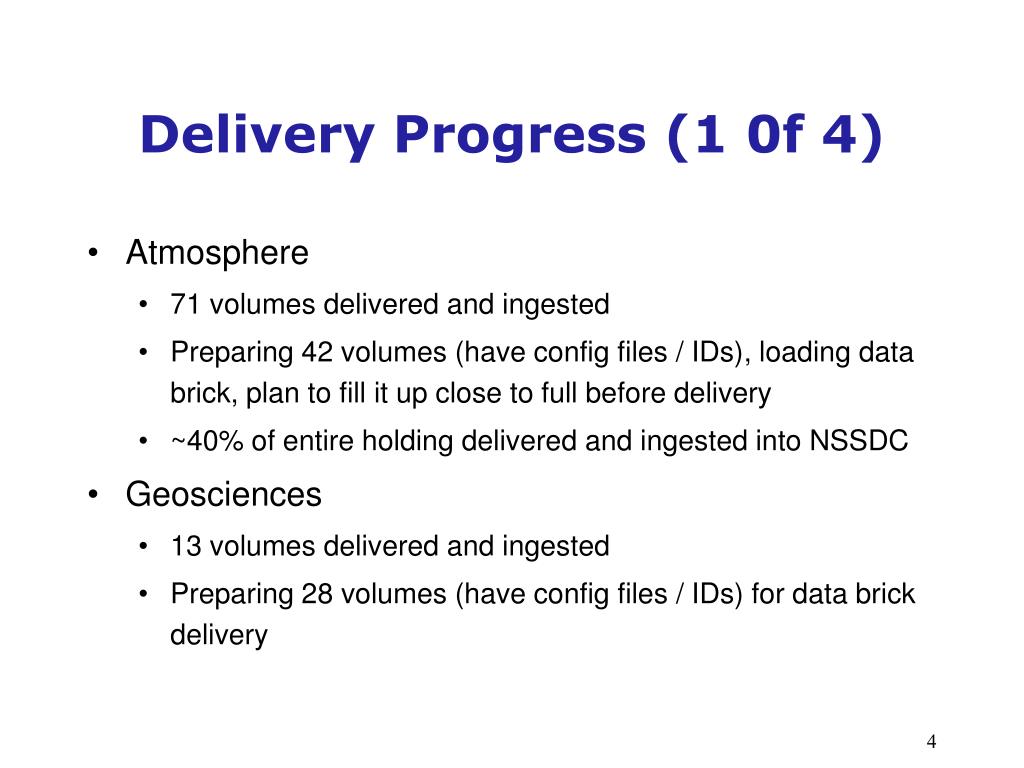

Delivery Progress (1 0f 4) • Atmosphere • 71 volumes delivered and ingested • Preparing 42 volumes (have config files / IDs), loading data brick, plan to fill it up close to full before delivery • ~40% of entire holding delivered and ingested into NSSDC • Geosciences • 13 volumes delivered and ingested • Preparing 28 volumes (have config files / IDs) for data brick delivery

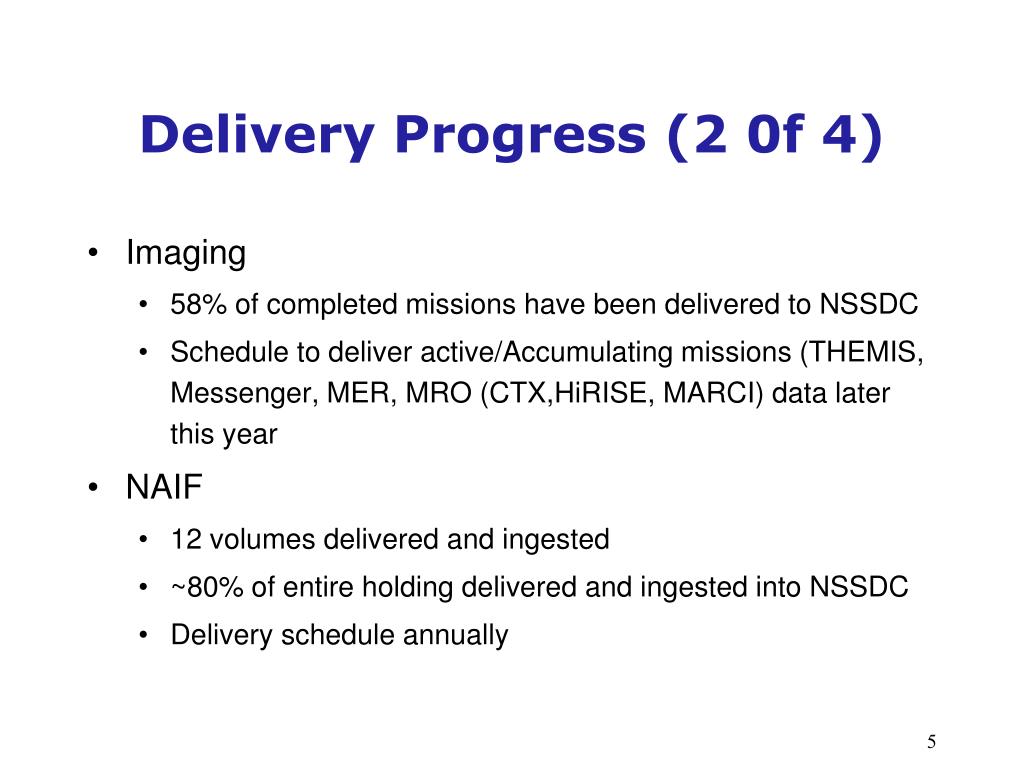

Delivery Progress (2 0f 4) • Imaging • 58% of completed missions have been delivered to NSSDC • Schedule to deliver active/Accumulating missions (THEMIS, Messenger, MER, MRO (CTX,HiRISE, MARCI) data later this year • NAIF • 12 volumes delivered and ingested • ~80% of entire holding delivered and ingested into NSSDC • Delivery schedule annually
Delivery Progress(3 0f 4) • PPI • 32 volumes delivered to NSSDC, 1 ingested • 31 volumes waiting for config files / IDs • Planning to send a copy of all data on hand on a data brick for safe keeping • RINGS • 13 volumes delivered and ingested with 3 volumes to be redelivered in near future • ~90% of entire holding delivered and ingested into NSSDC

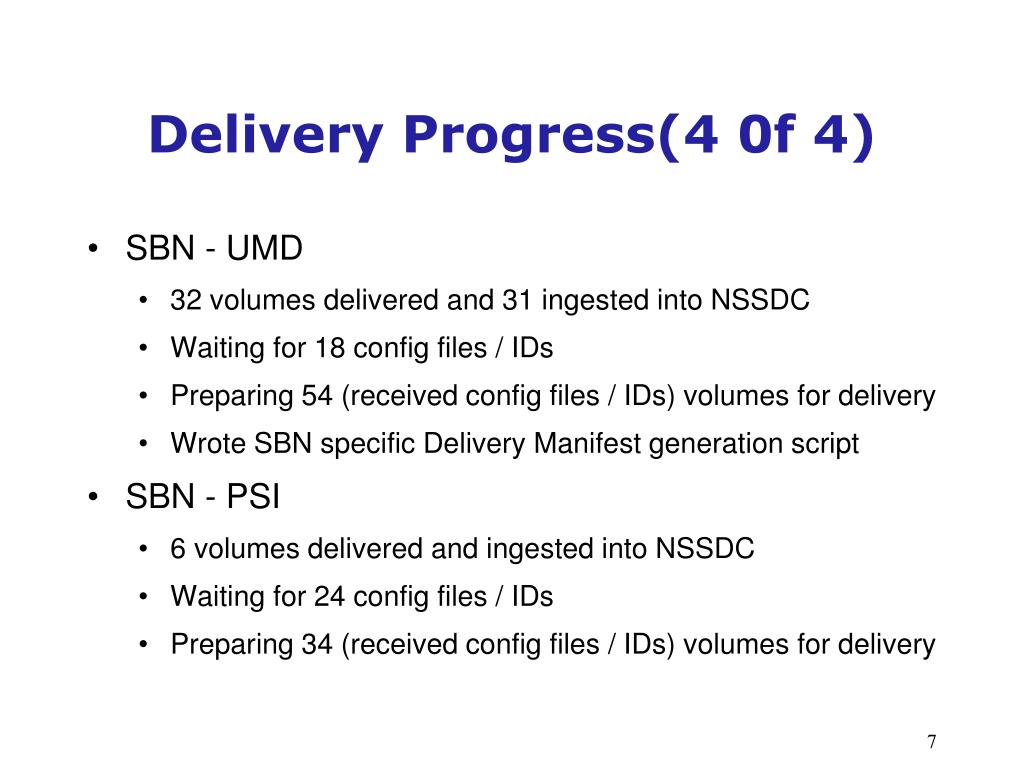

Delivery Progress(4 0f 4) • SBN - UMD • 32 volumes delivered and 31 ingested into NSSDC • Waiting for 18 config files / IDs • Preparing 54 (received config files / IDs) volumes for delivery • Wrote SBN specific Delivery Manifest generation script • SBN - PSI • 6 volumes delivered and ingested into NSSDC • Waiting for 24 config files / IDs • Preparing 34 (received config files / IDs) volumes for delivery
Next Steps • Node Future delivery • Periodically (annually), or on an as ready basis • Via data brick, electronically , or RAID as appropriate • Experiment and define RAID delivery process • Develop operational Delivery Manifest generation software
