LST Mechanical Design Review

LST Mechanical Design Review. Mechanical Installation Preparation H. James Krebs October 21, 2003. Mechanical Installation Preparation. IR-12 will be the location of most mechanical preparation work during 2004 & 2005 Why IR-12? IR-12 Hall is very similar to IR-2 Hall Same floor plan

radley
Télécharger la présentation

LST Mechanical Design Review

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. LST Mechanical Design Review Mechanical Installation Preparation H. James Krebs October 21, 2003 H.J. Krebs

  2. Mechanical Installation Preparation • IR-12 will be the location of most mechanical preparation work during 2004 & 2005 • Why IR-12? • IR-12 Hall is very similar to IR-2 Hall • Same floor plan • Identical 50/10 ton crane combination • We need space • IR-12 is empty • IR-2 is presently occupied with BaBar related items • Present status • 3 technical support staff now housed at IR-12 • Engineering offices are under construction • Estimated completion November 1 • Jim Krebs & Zohrab Vassilian move to IR-12 immediately after completion of this review H.J. Krebs

  3. IR-2 H.J. Krebs

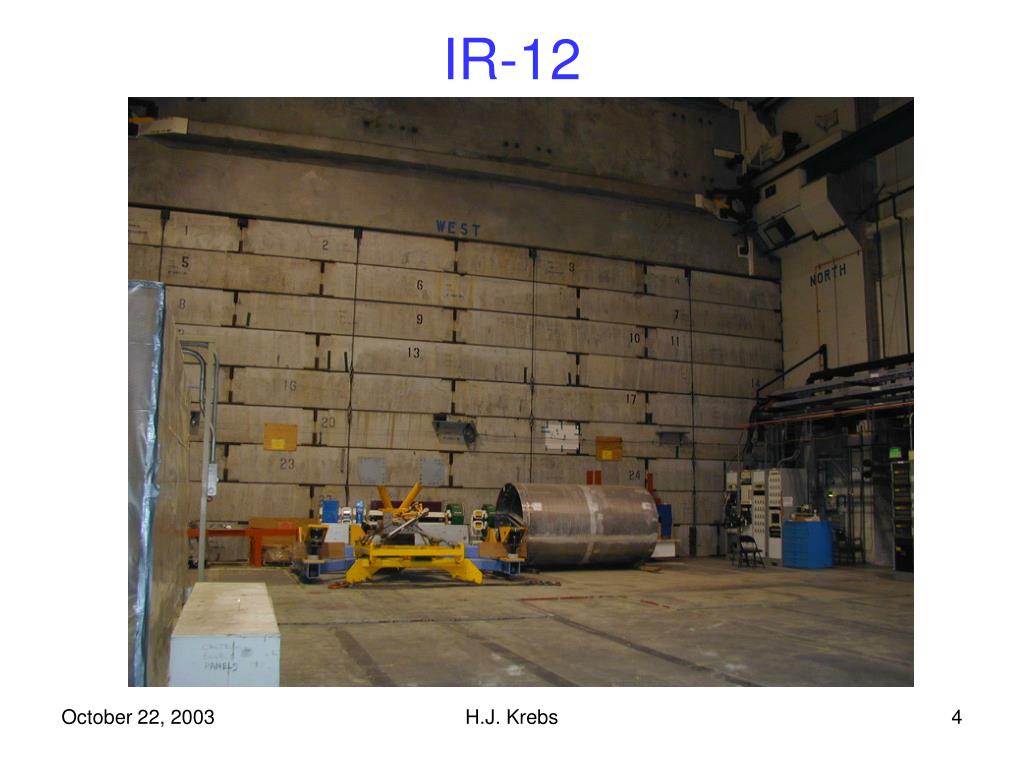

  4. IR-12 H.J. Krebs

  5. IR-12 Activities • Pre-installation preparation of brass plates • Radius corners • Drill & tap threaded holes for slide screws and swivel shackles • Adjust camber if necessary • Stage plates for assembly • BaBar model • Build a fairly crude but full scale mock-up of the forward end of BaBar including: • Barrel assembly simulating corner blocks removed • FWD end doors • FWD PEP pier • FWD PEP beam line H.J. Krebs

  6. H.J. Krebs

  7. H.J. Krebs

  8. 12” Thick (Z) Sextant Prototype H.J. Krebs

  9. Sextant Iron Cable Channel H.J. Krebs

  10. H.J. Krebs

  11. H.J. Krebs

  12. H.J. Krebs

  13. IR-12 Activities • Purpose of Model • Construct elevator platform • Test function • Check for interferences with end doors, beamline and PEP pier • Load test • Modify as necessary for corrections or improvements • Brass installation preparation • Test installation hardware • Load test • Practice brass plate installation • Brass push/pull test (see talk by Allen Constable) • LST detector installation preparation • Test installation hardware • Practice LST detector installation • A full Z length (3750mm) gap model exists for this H.J. Krebs

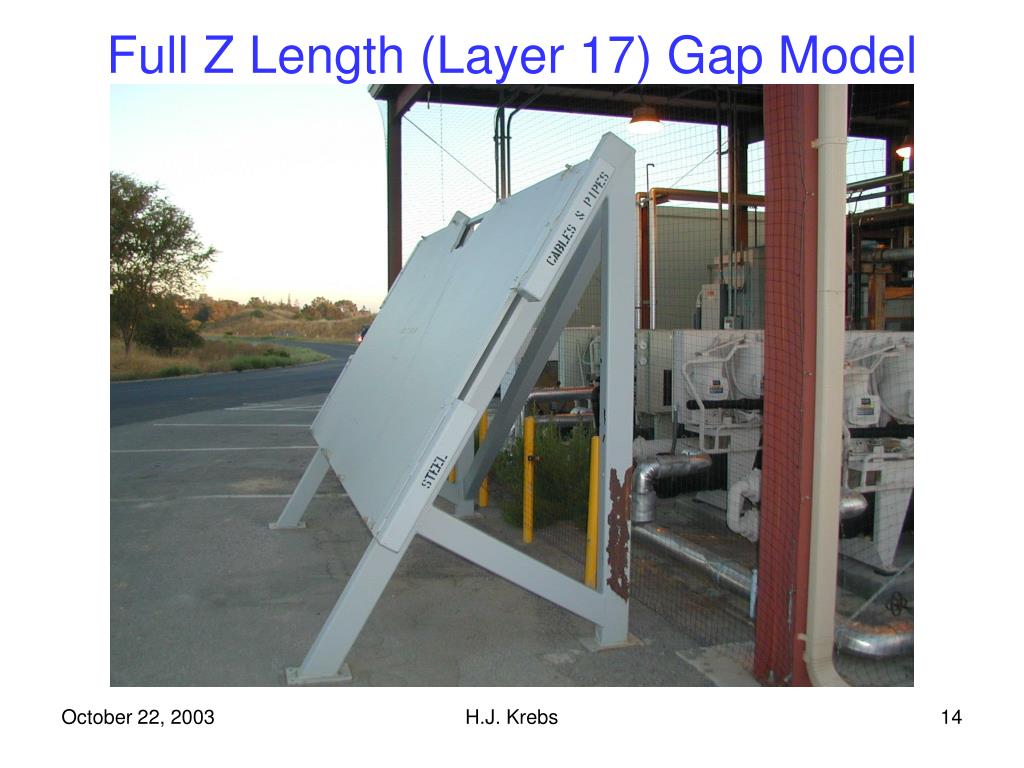

  14. Full Z Length (Layer 17) Gap Model H.J. Krebs

  15. Full Z Length (3750mm) Gap Model H.J. Krebs

  16. IR-12 Activities • Steel handling fixtures • Train technical support staff • Check centers of gravity • Determine appropriate rigging • Load test • Function test, if possible • Modify as needed H.J. Krebs

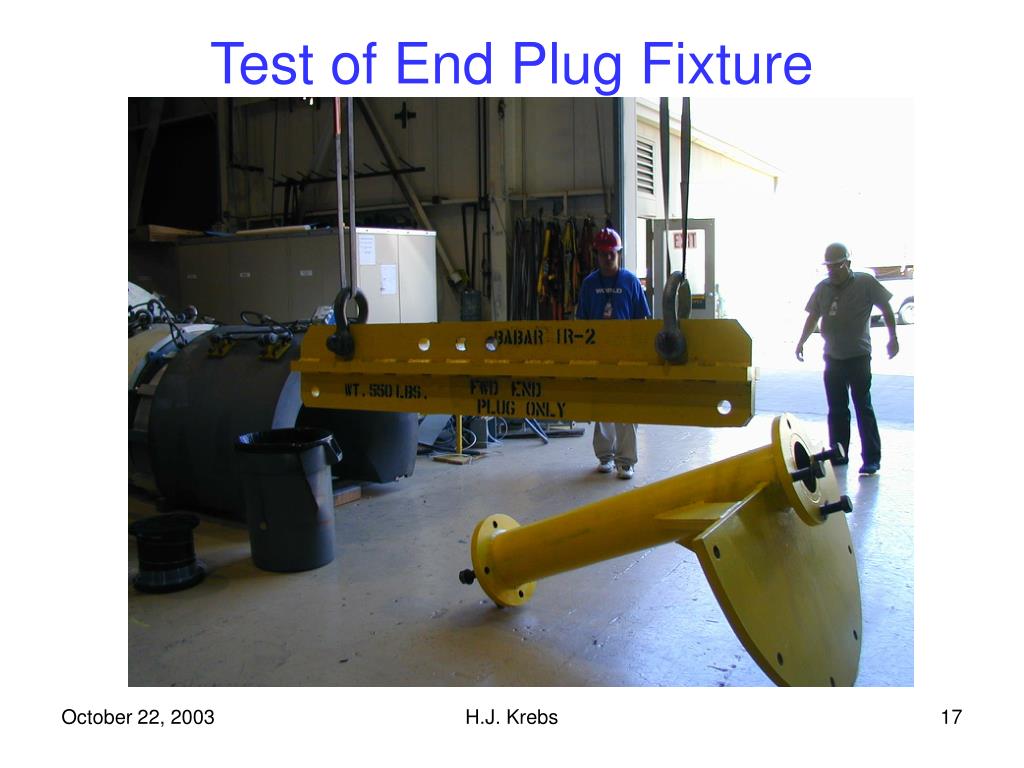

  17. Test of End Plug Fixture H.J. Krebs

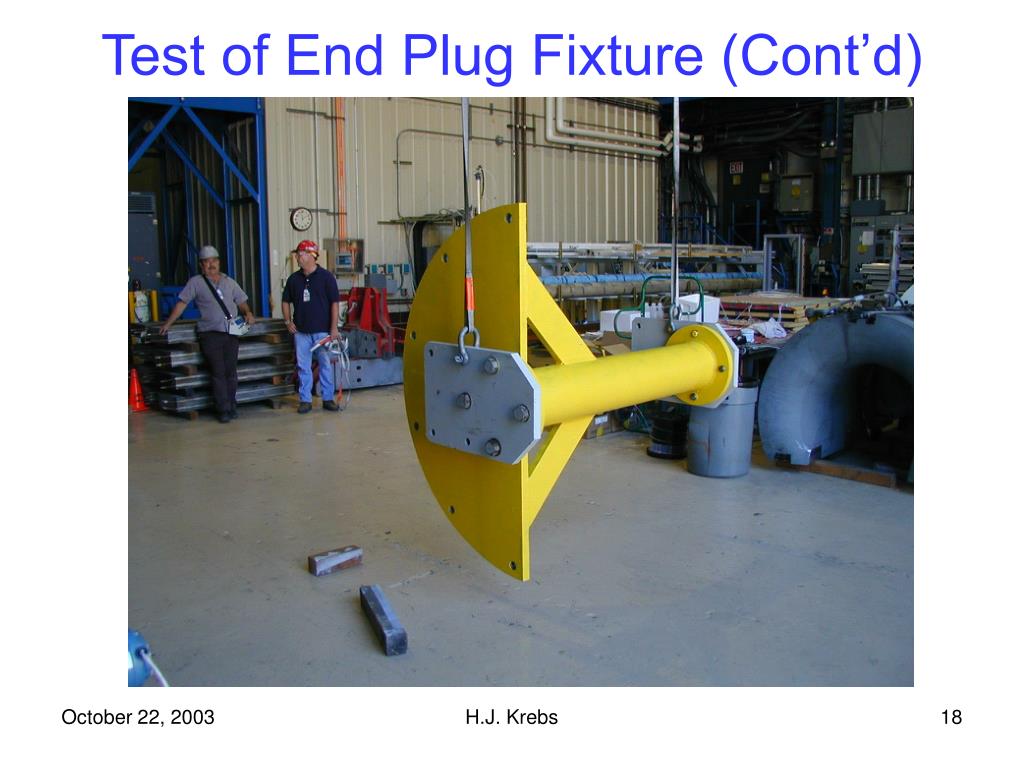

  18. Test of End Plug Fixture (Cont’d) H.J. Krebs

  19. Test of End Plug Fixture (Cont’d) H.J. Krebs

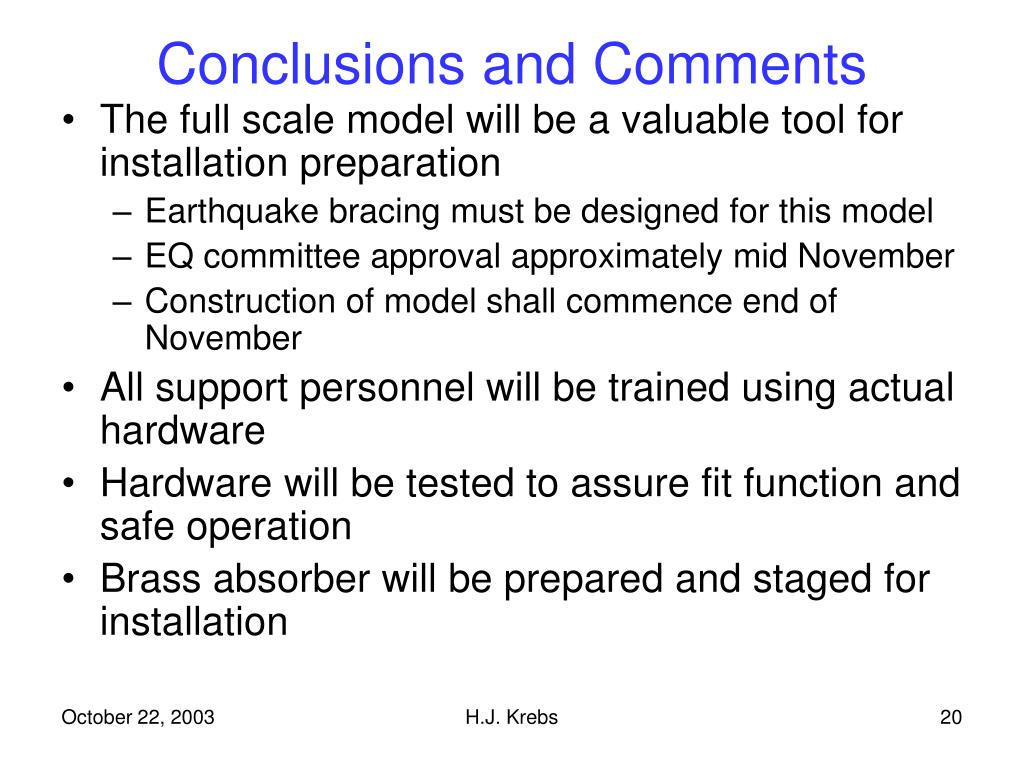

  20. Conclusions and Comments • The full scale model will be a valuable tool for installation preparation • Earthquake bracing must be designed for this model • EQ committee approval approximately mid November • Construction of model shall commence end of November • All support personnel will be trained using actual hardware • Hardware will be tested to assure fit function and safe operation • Brass absorber will be prepared and staged for installation H.J. Krebs
