rumor
Uploaded by
32 SLIDES
466 VUES
320LIKES

Transforming Natural Language to Machine Readable Format: MSE Project Overview

DESCRIPTION

This presentation details the MSE project aimed at employing natural language processing (NLP) to detect the structure and semantics of sentences, ultimately converting them into a machine-readable format. Key components include a clear project overview, requirements, Gantt chart, standards, and SQA plans. The focus is to accurately represent inputted text through a proprietary POS tagger, ensuring a user-friendly interface free from grammatical errors and ambiguity. The presentation also discusses cost estimation and project scheduling to meet development milestones.

1 / 32

Télécharger la présentation

Transforming Natural Language to Machine Readable Format: MSE Project Overview

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Natural Language to Machine Readable Format By: Damian Tamayo Presentation 1 – Oct. 12, 2009 CIS 895 – MSE Project

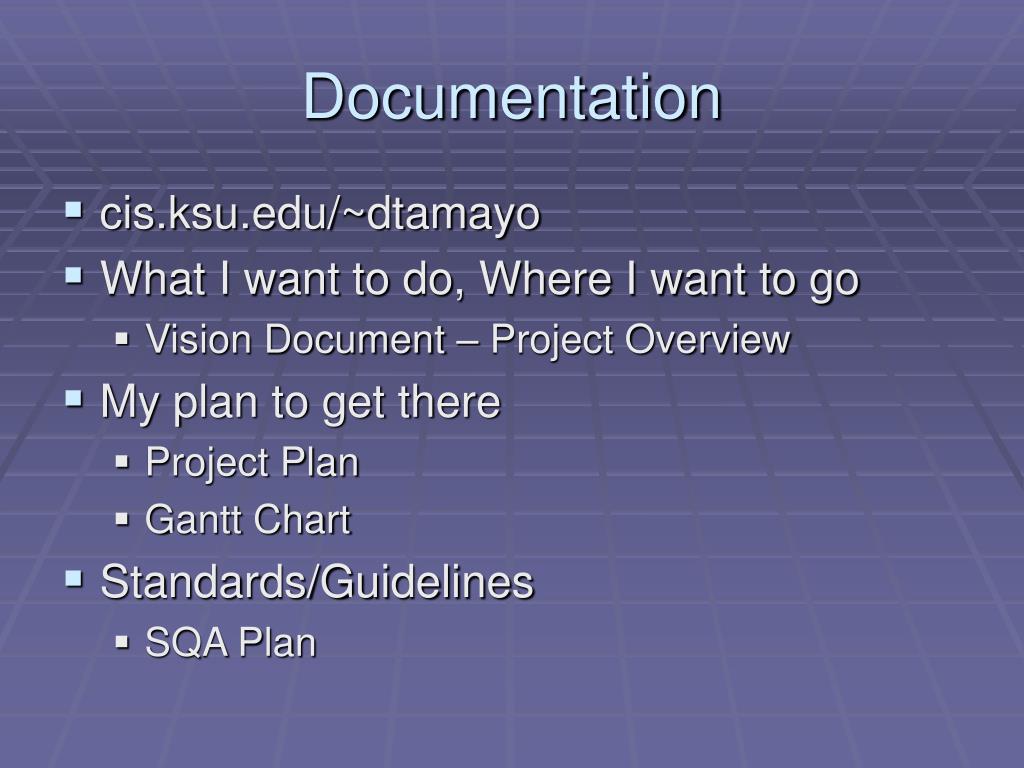

  2. Documentation • cis.ksu.edu/~dtamayo • What I want to do, Where I want to go • Vision Document – Project Overview • My plan to get there • Project Plan • Gantt Chart • Standards/Guidelines • SQA Plan

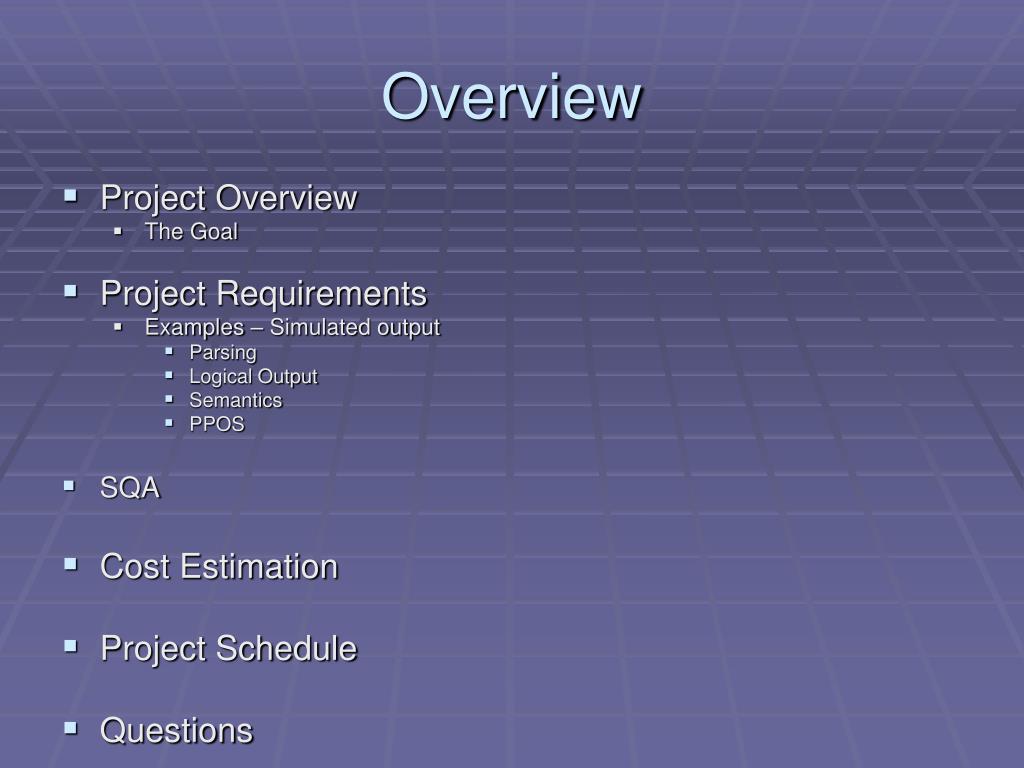

  3. Overview • Project Overview • The Goal • Project Requirements • Examples – Simulated output • Parsing • Logical Output • Semantics • PPOS • SQA • Cost Estimation • Project Schedule • Questions

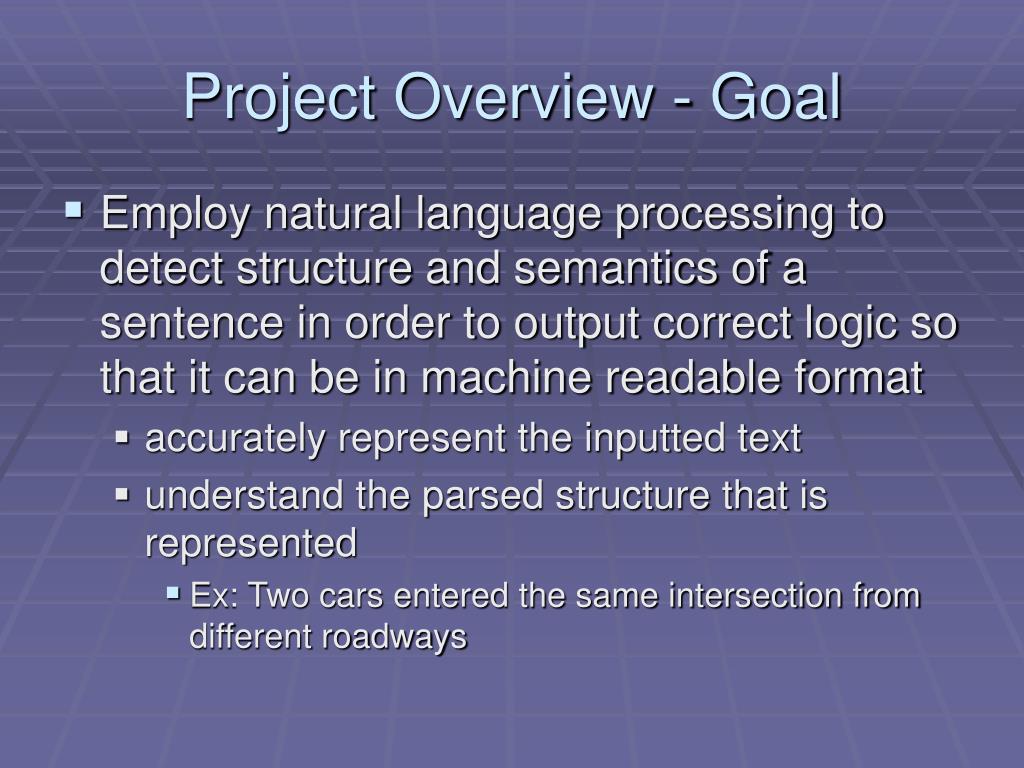

  4. Project Overview - Goal • Employ natural language processing to detect structure and semantics of a sentence in order to output correct logic so that it can be in machine readable format • accurately represent the inputted text • understand the parsed structure that is represented • Ex: Two cars entered the same intersection from different roadways

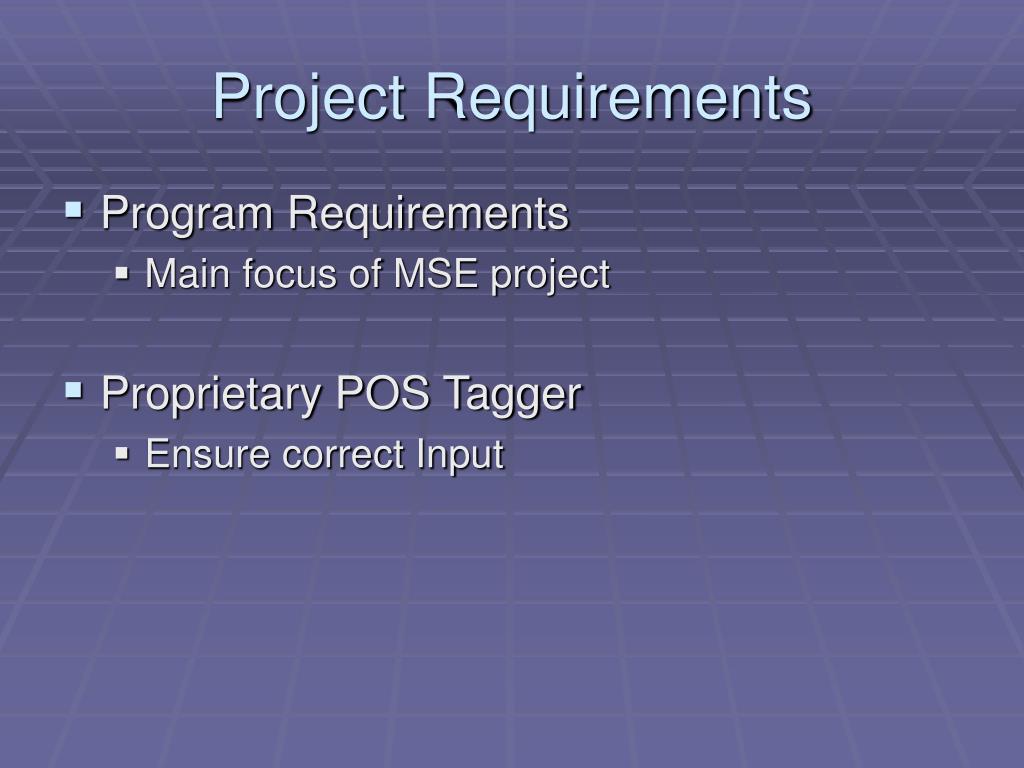

  5. Project Requirements • Program Requirements • Main focus of MSE project • Proprietary POS Tagger • Ensure correct Input

  6. Program Requirements • Req1 (Critical) GUI • A.)POS tagger output tab • B.(Critical) User input (ui) tab/process -> split sentences tab • C.) Split sentences tab -> hold process ui • D.(Critical) tab for internal representation • E.(Critical) ontology tab for showing logic • F.(Critical)PPOS tagger – ensure input

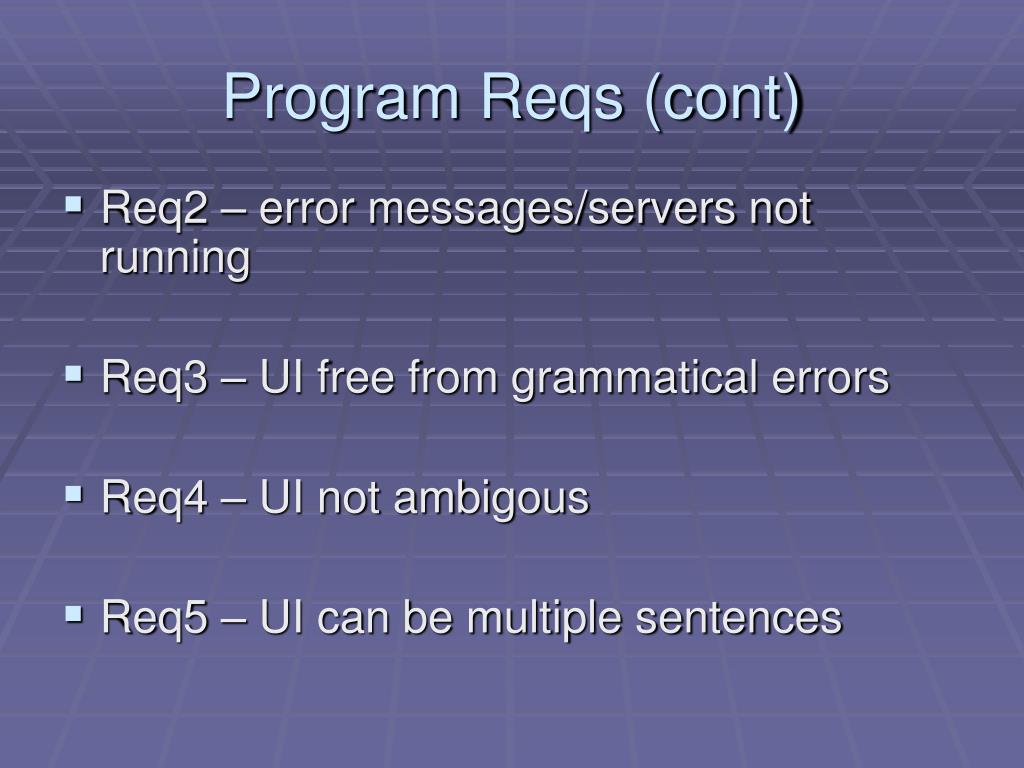

  7. Program Reqs (cont) • Req2 – error messages/servers not running • Req3 – UI free from grammatical errors • Req4 – UI not ambigous • Req5 – UI can be multiple sentences

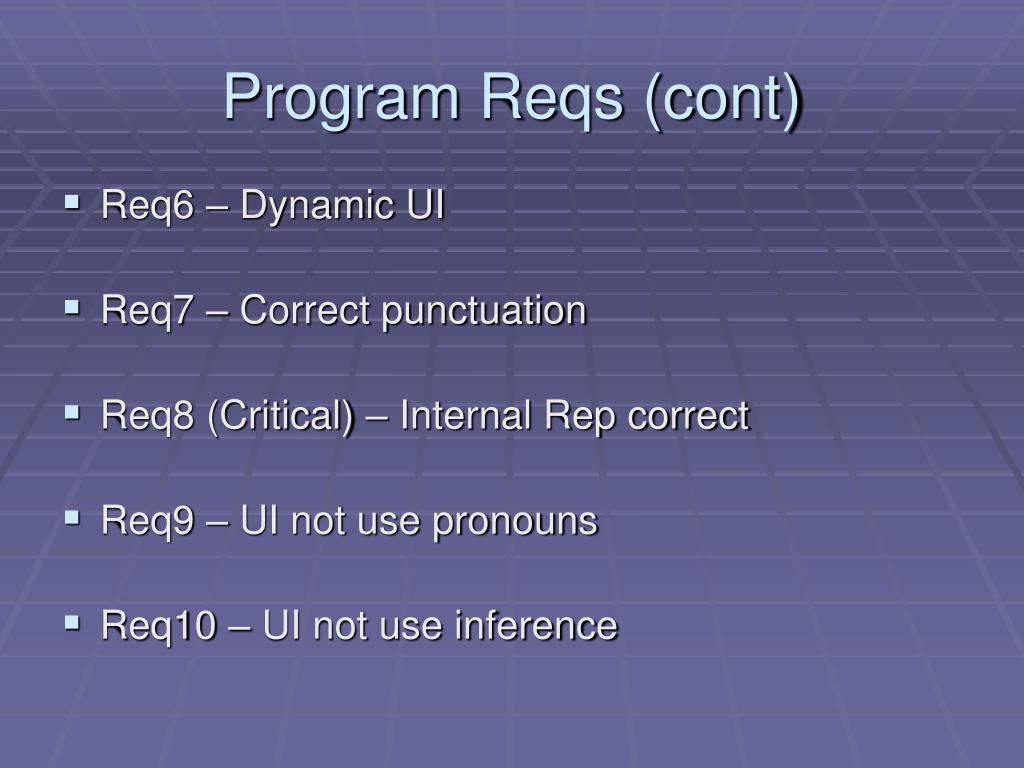

  8. Program Reqs (cont) • Req6 – Dynamic UI • Req7 – Correct punctuation • Req8 (Critical) – Internal Rep correct • Req9 – UI not use pronouns • Req10 – UI not use inference

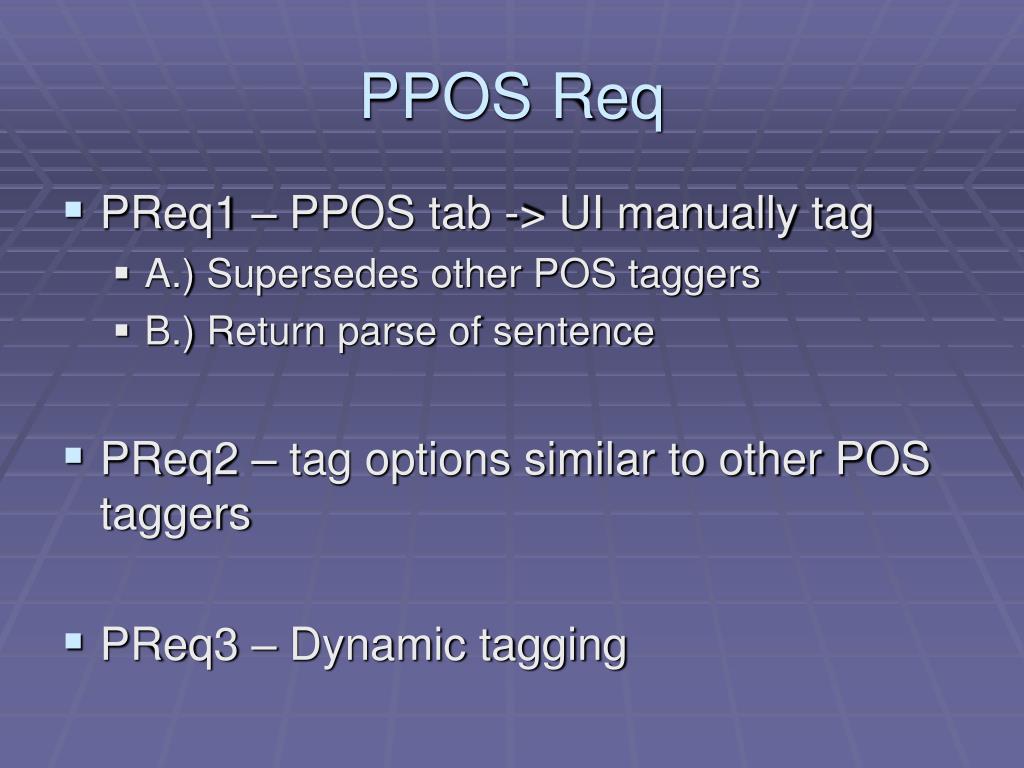

  9. PPOS Req • PReq1 – PPOS tab -> UI manually tag • A.) Supersedes other POS taggers • B.) Return parse of sentence • PReq2 – tag options similar to other POS taggers • PReq3 – Dynamic tagging

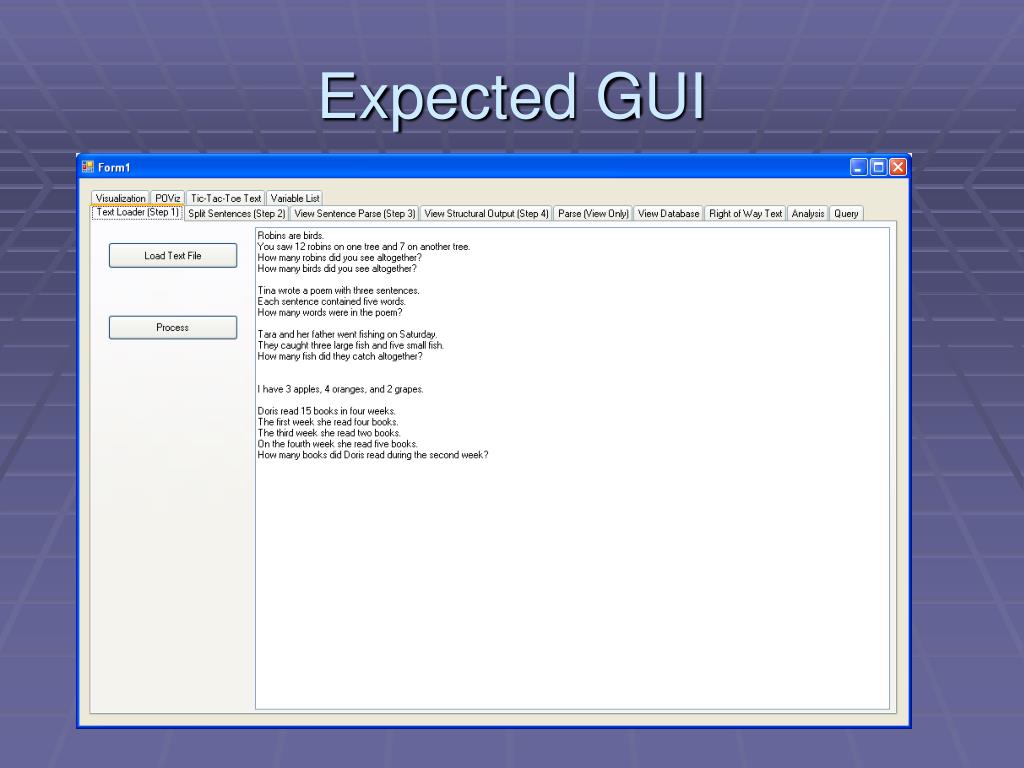

  10. Expected GUI

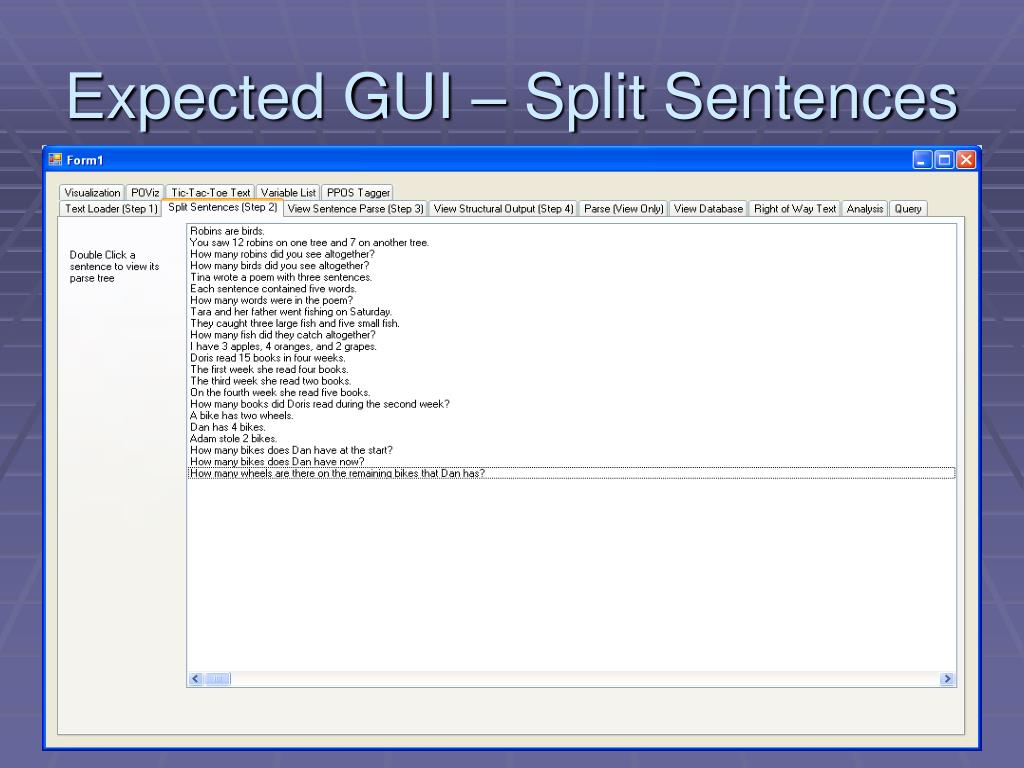

  11. Expected GUI – Split Sentences

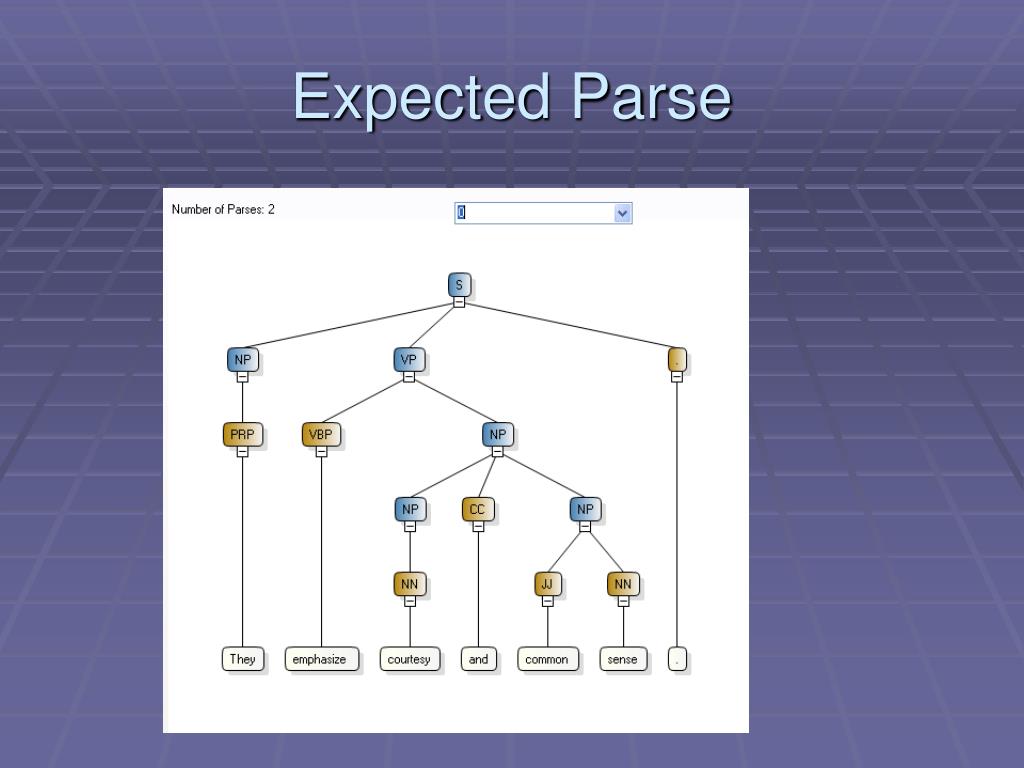

  12. Expected Parse

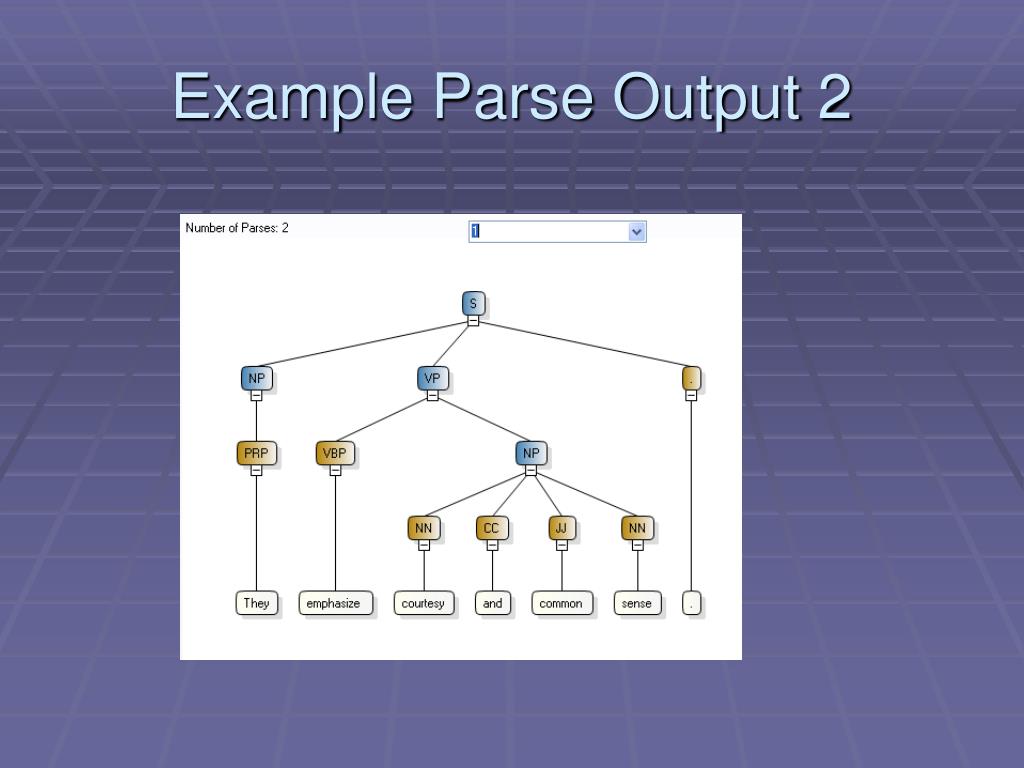

  13. Example Parse Output 2

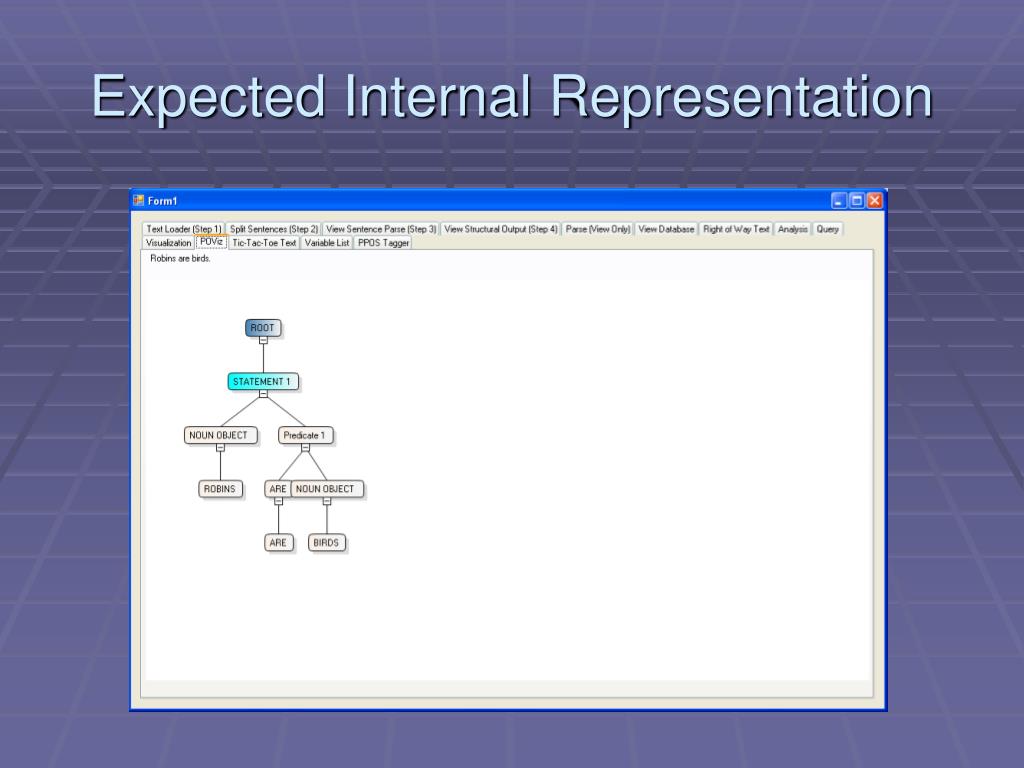

  14. Expected Internal Representation

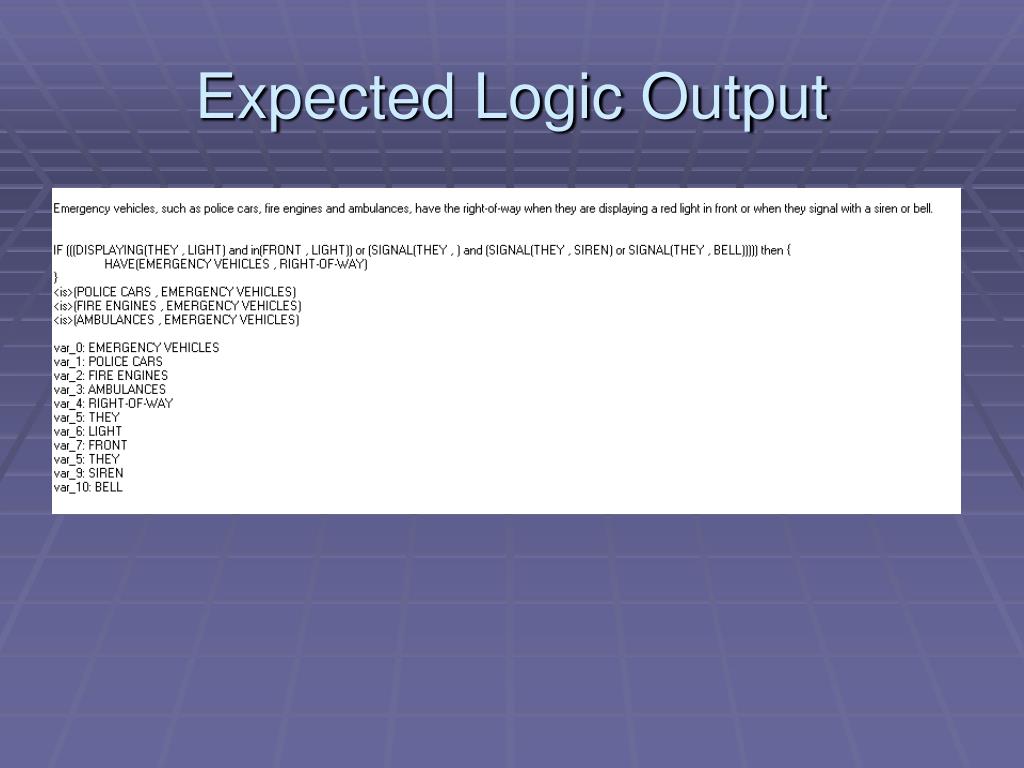

  15. Expected Logic Output

  16. Expected Logical Rep • If you are entering a through street or highway at which there are stop signs, you must stop completely and proceed when you can do so without interfering with other traffic.

  17. Expected PPOS

  18. Expected PPOS

  19. SQA • Supervisory Committee • Attend presentations • Provide feedback • Major Professor • Meet with developer/weekly basis • Developer • Produce product in given timeframe • Meet weekly w/ Major Professor

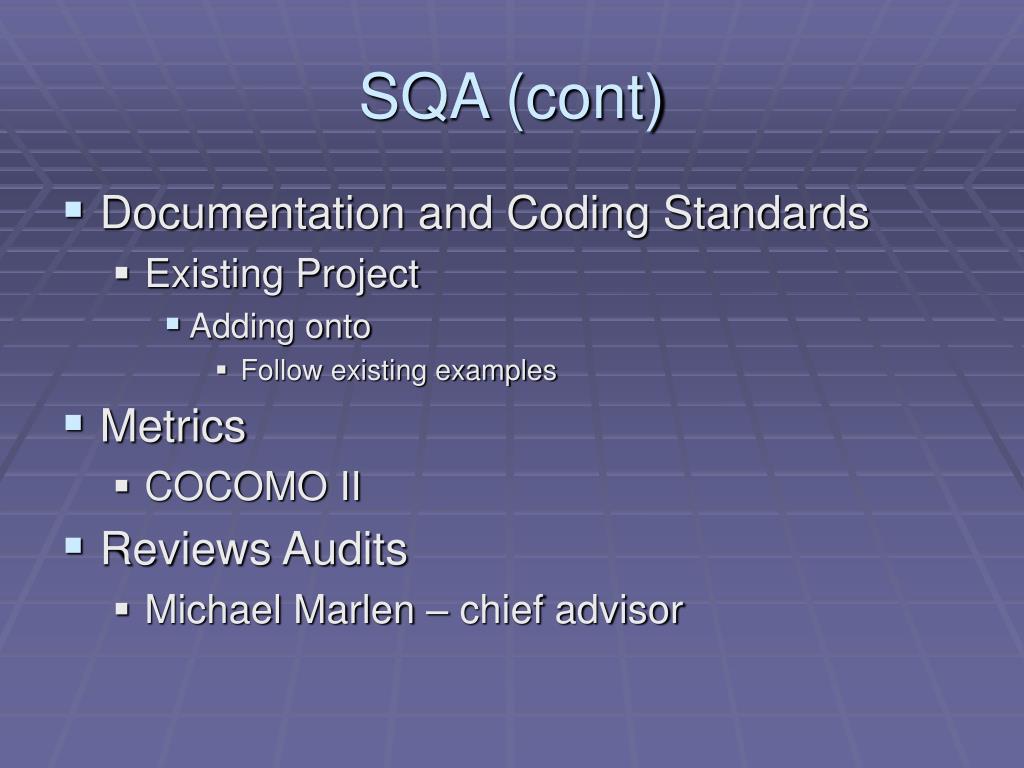

  20. SQA (cont) • Documentation and Coding Standards • Existing Project • Adding onto • Follow existing examples • Metrics • COCOMO II • Reviews Audits • Michael Marlen – chief advisor

  21. SQA (cont) • Testing • Dynamic Basis • As code is integrated • Tools • MS Visual Studio 2008 • TortoiseSVN • Source Control

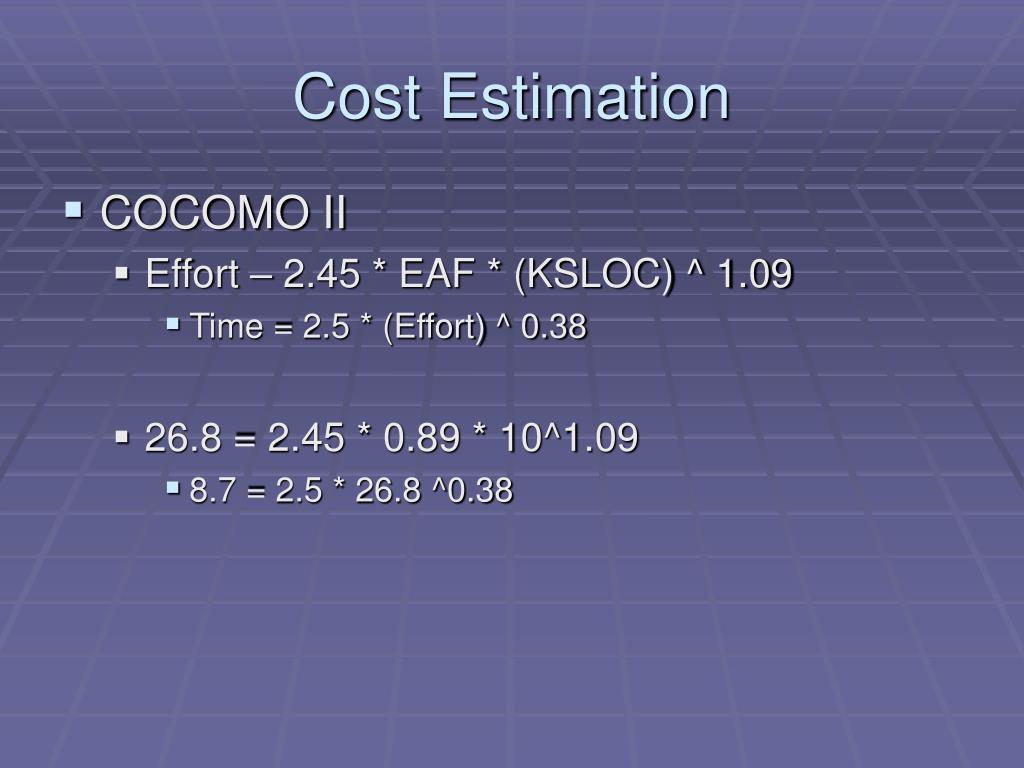

  22. Cost Estimation • COCOMO II • Effort – 2.45 * EAF * (KSLOC) ^ 1.09 • Time = 2.5 * (Effort) ^ 0.38 • 26.8 = 2.45 * 0.89 * 10^1.09 • 8.7 = 2.5 * 26.8 ^0.38

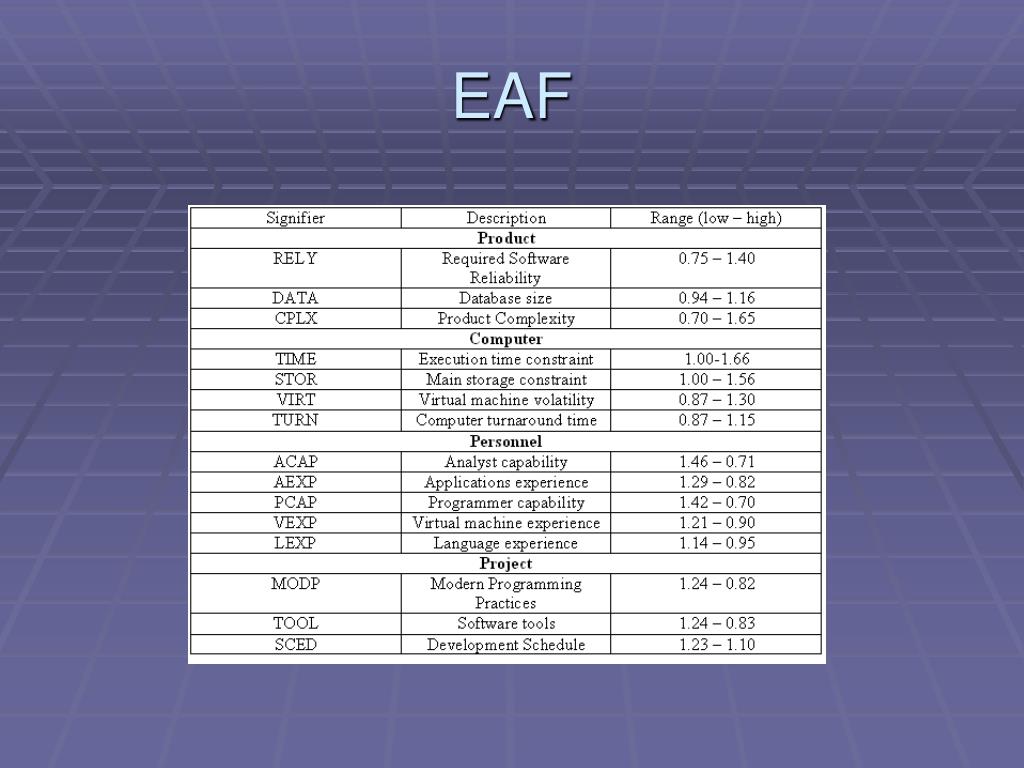

  23. EAF

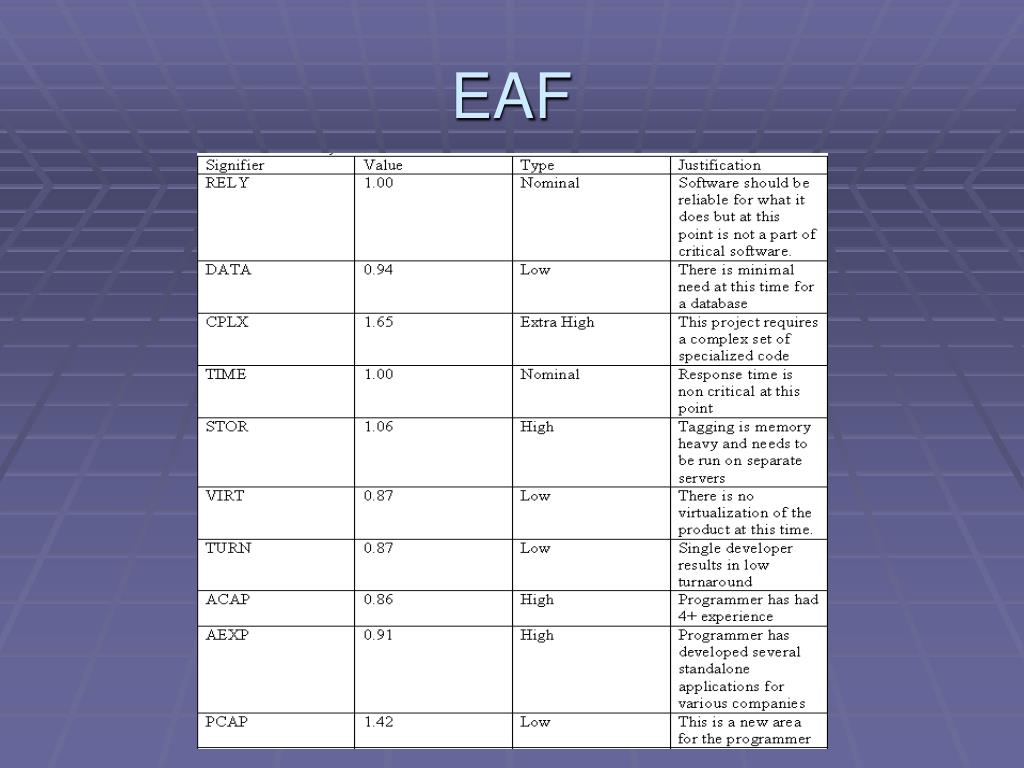

  24. EAF

  25. EAF

  26. Cost Estimation • COCOMO II • Effort – 2.45 * EAF * (KSLOC) ^ 1.09 • Time = 2.5 * (Effort) ^ 0.38 • 26.8 = 2.45 * 0.89 * 10^1.09 • 8.7 = 2.5 * 26.8 ^0.38

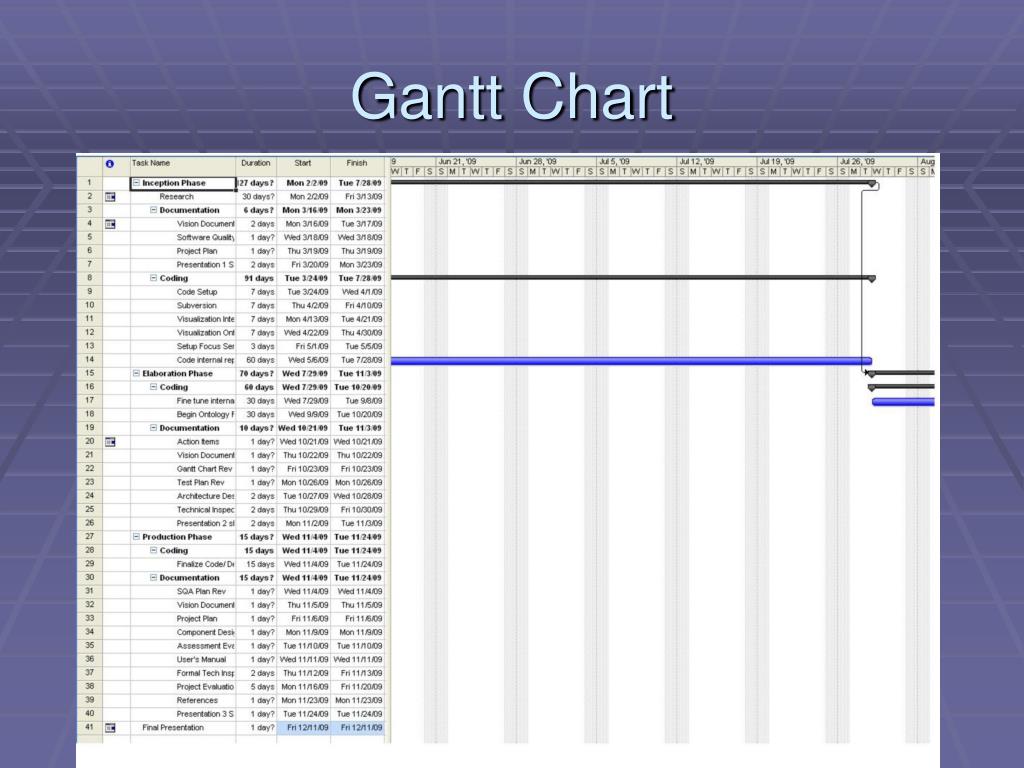

  27. Gantt Chart

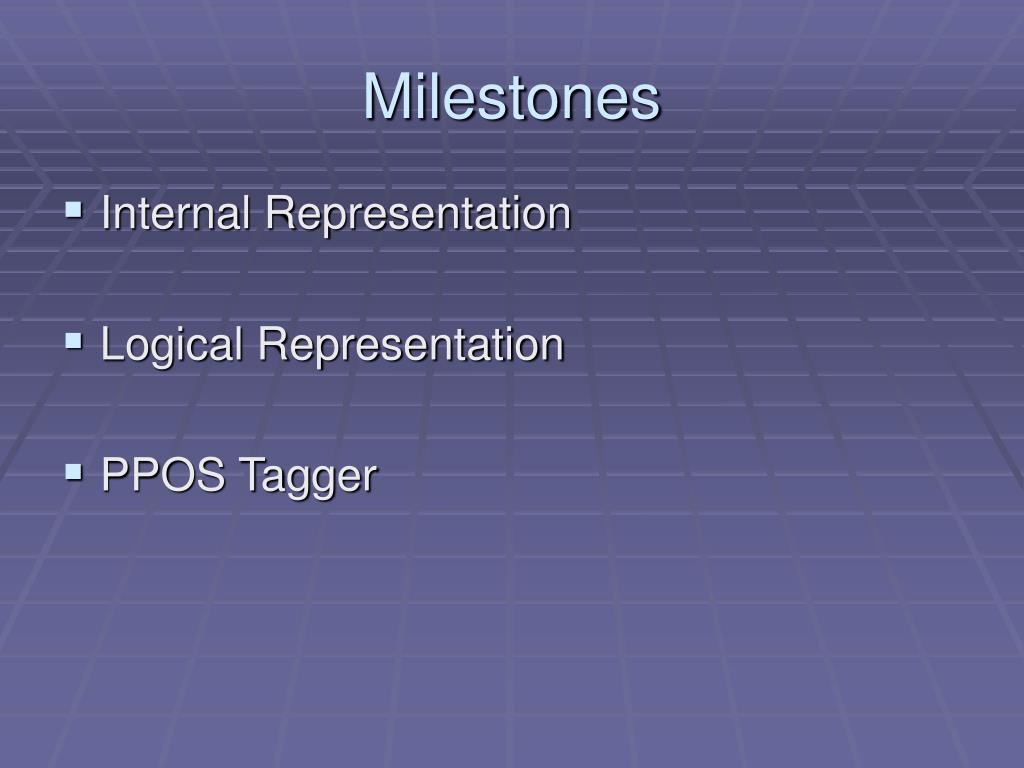

  28. Milestones • Internal Representation • Logical Representation • PPOS Tagger

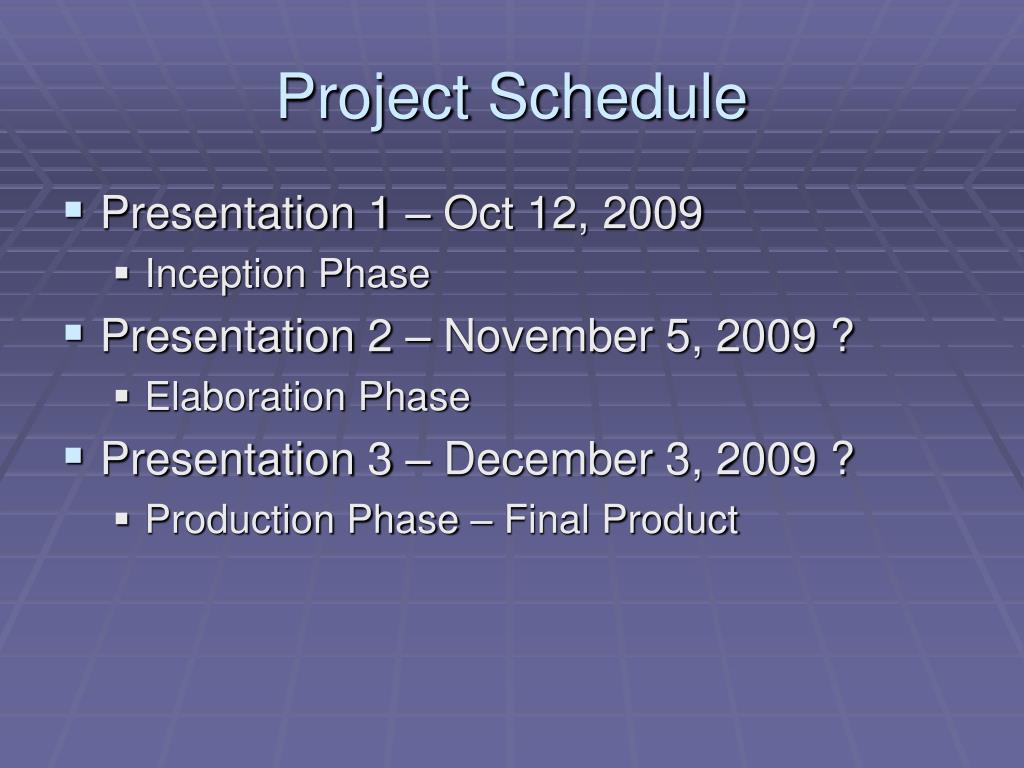

  29. Project Schedule • Presentation 1 – Oct 12, 2009 • Inception Phase • Presentation 2 – November 5, 2009 ? • Elaboration Phase • Presentation 3 – December 3, 2009 ? • Production Phase – Final Product

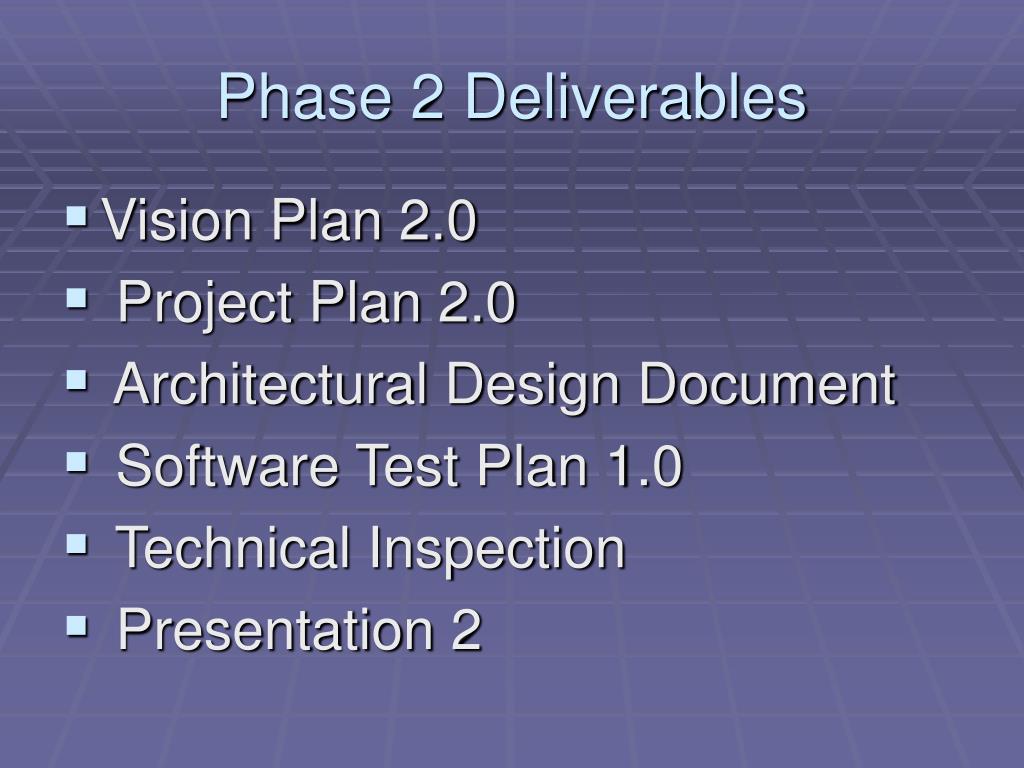

  30. Phase 2 Deliverables • Vision Plan 2.0 • Project Plan 2.0 • Architectural Design Document • Software Test Plan 1.0 • Technical Inspection • Presentation 2

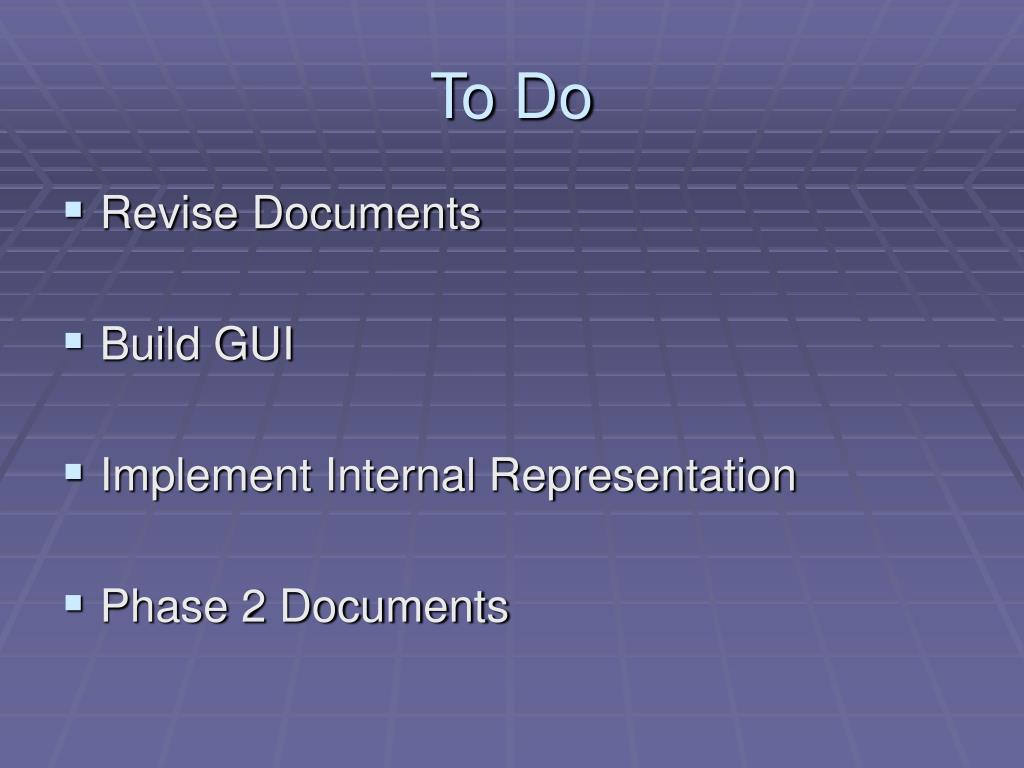

  31. To Do • Revise Documents • Build GUI • Implement Internal Representation • Phase 2 Documents

More Related
