Surveillance and Broadcast Services ADS-B Status Briefing: ASAS TN2 Vincent Capezzuto April 14, 2008

Agenda • Dual Track Strategy • Requirements • Acquisition Status • Activity Description • Rulemaking Status • NPRM • Air-to-Air Applications • Discussion Points
Deploy Ground Infrastructure Essential Services ISD Dual Track Strategy Ground Infrastructure 2/2006 – 11/2006 11/2006 – 8/2007 4/2008 – 3/2010 10/2009 – 4/2010 9/2010 2/2008 – 1/2009 Test Ground Infrastructure / Voluntary Avionics Equipage Initial Operating Capability Critical Services ISD Acquisition Planning Acquisition Execution 11/2008 2010 – 2013 Ground Infrastructure Deployment Pre-NPRM Separation Standards Modeling Separation Standards Approval Avionics Equipage 4/2010 1/2007 – 8/2007 Avionics Equipage 2010 – 2020 Avionics Equipage Begins RPR Phase I RPR Phase 3 RPR Phase 2 Final Rule NPRM 4/2010 5/2010 3/2008 – 2/2009 4/2006 – 9/2006 10/2007 = In Process = Completed RPR = Rulemaking Project Record; NPRM = Notice of Proposed Rulemaking; ISD = In-Service Decision
Acquisition Status: Ground Infrastructure - System Architecture Ashburn, VA

Acquisition Status: Implementation Activities Began process for transmit authorization for eleven SV 168 (Miami) Radio Stations Planned for April 30 through Special Temporary Authorization (STA) Permanent FTA processing underway in parallel Supported installation of SDP equipment rack at ZMA, ZJX, and MIA TRACON En Route Communications Gateway (ECG) connection for radar data for TIS-B is awaiting completion of ECG System Support Modification Coordinating with ITT for site surveys of SDPs 6 oil platforms surveyed for surveillance and AWOS (an estimated 17 total platforms will be surveyed before April 30) SDF, ZID, PHL, ZHU, ZNY, ZDC, & PCT targeted for summer 08 NCPs and installation plans are in planning stages

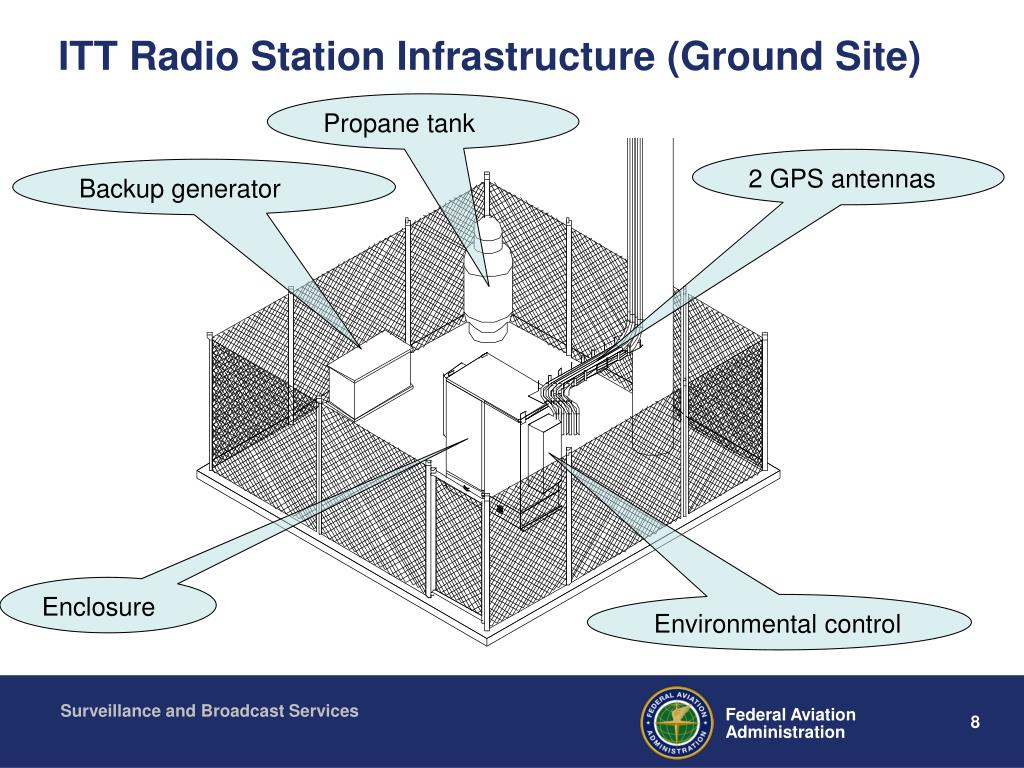

ITT Radio Station Infrastructure (Ground Site) Propane tank 2 GPS antennas Backup generator Enclosure Environmental control

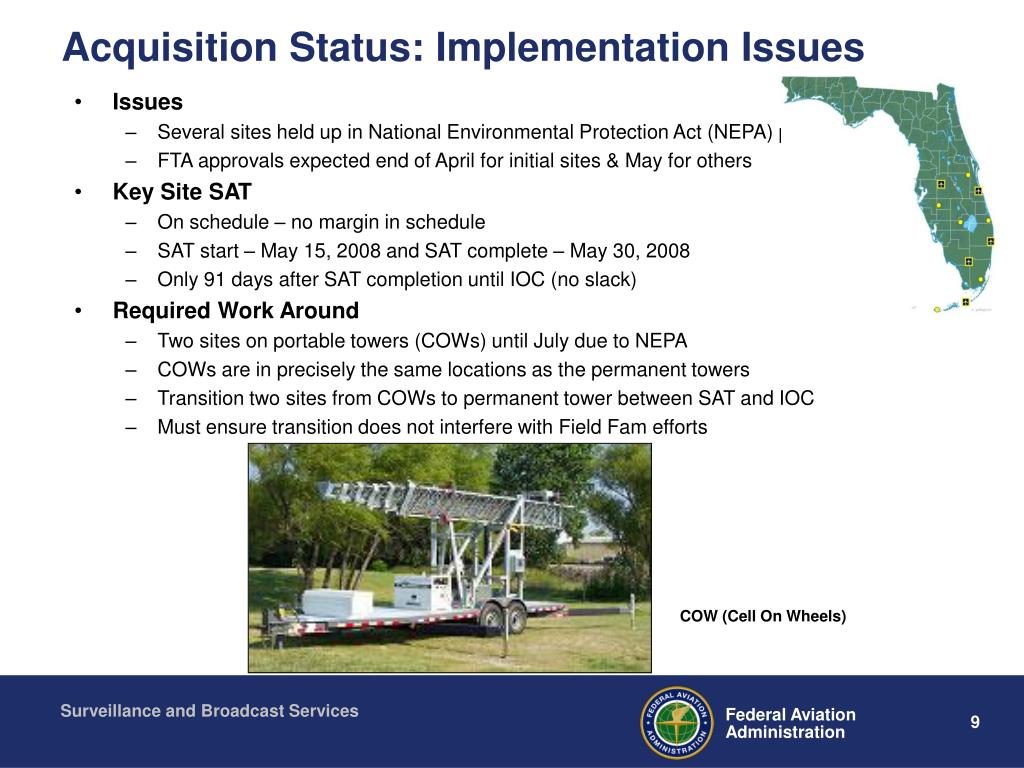

Acquisition Status: Implementation Issues • Issues • Several sites held up in National Environmental Protection Act (NEPA) process • FTA approvals expected end of April for initial sites & May for others • Key Site SAT • On schedule – no margin in schedule • SAT start – May 15, 2008 and SAT complete – May 30, 2008 • Only 91 days after SAT completion until IOC (no slack) • Required Work Around • Two sites on portable towers (COWs) until July due to NEPA • COWs are in precisely the same locations as the permanent towers • Transition two sites from COWs to permanent tower between SAT and IOC • Must ensure transition does not interfere with Field Fam efforts COW (Cell On Wheels)
Acquisition Status: Scheduled On-Air Dates ZJX Lakeland Linder Regional Airport Sebastian Municipal Airport Boca Raton Airport Dade-Collier Airport ZMA / MIA Florida Keys Marathon Airport

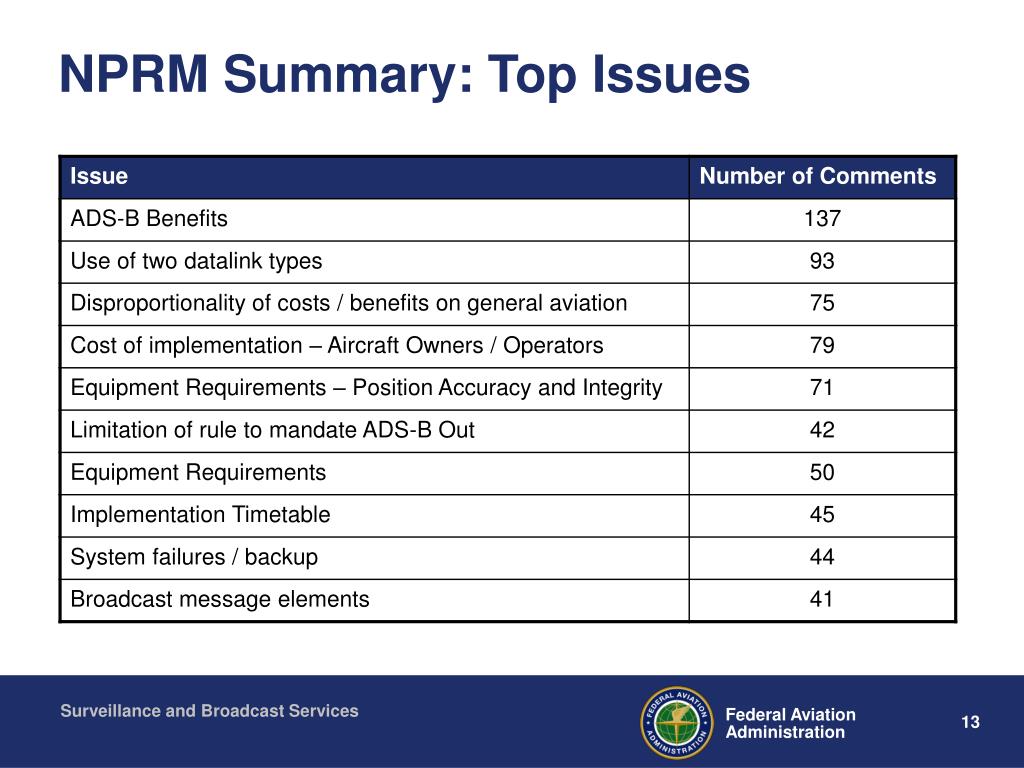

NPRM Status • The NPRM comment period closed on March 3, 2008 • The FAA has categorized the comments that were received • Number of Submittals (excluding FAA / DOT) = 172 • Excludes duplicates, Department of Transportation and requests for extension • Number of Comments = 1,372 (101 positive, 1,271 non-positive) • Number of Issues = 85

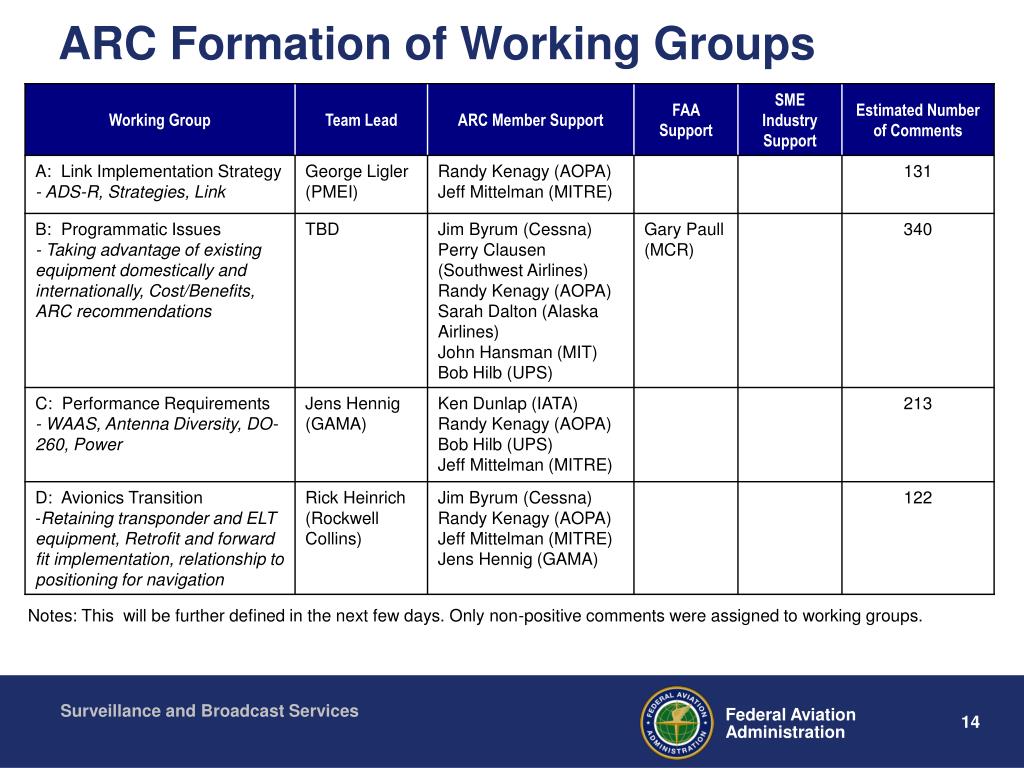

ARC Formation of Working Groups Notes: This will be further defined in the next few days. Only non-positive comments were assigned to working groups.

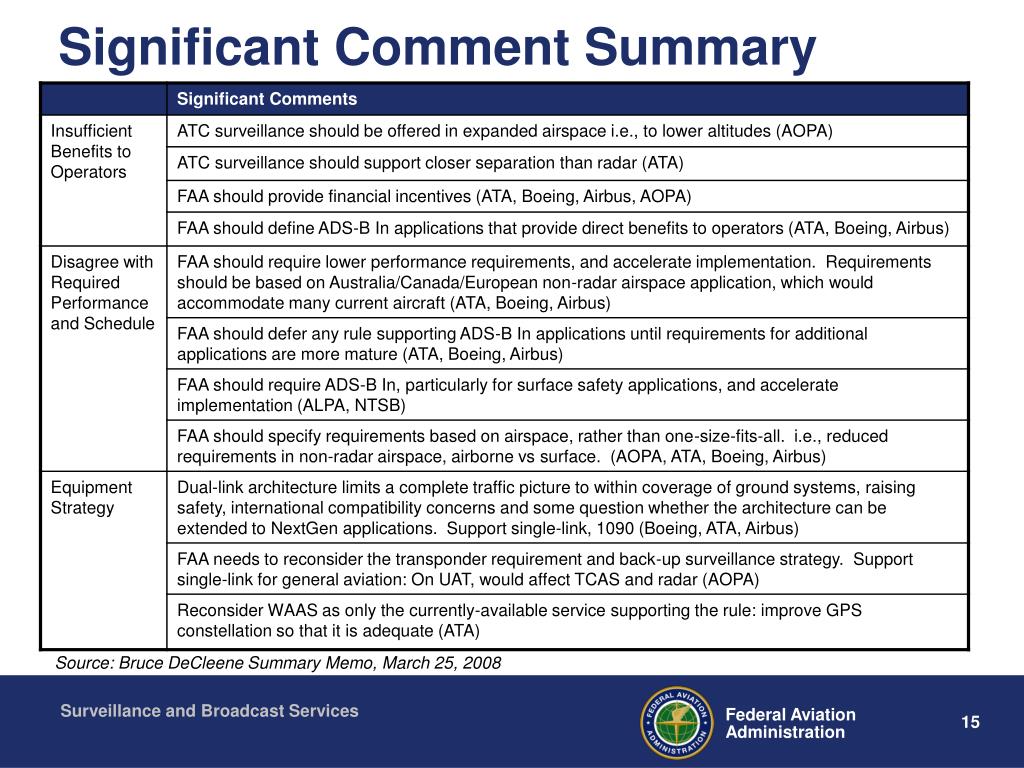

Significant Comment Summary Source: Bruce DeCleene Summary Memo, March 25, 2008

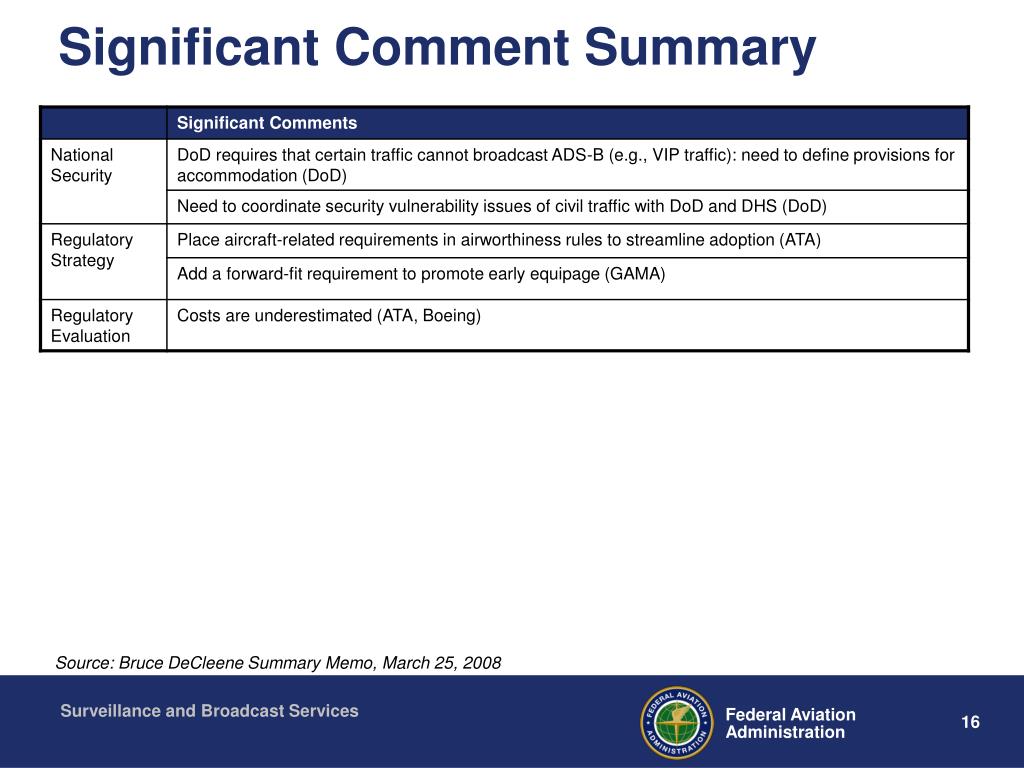

Significant Comment Summary Source: Bruce DeCleene Summary Memo, March 25, 2008

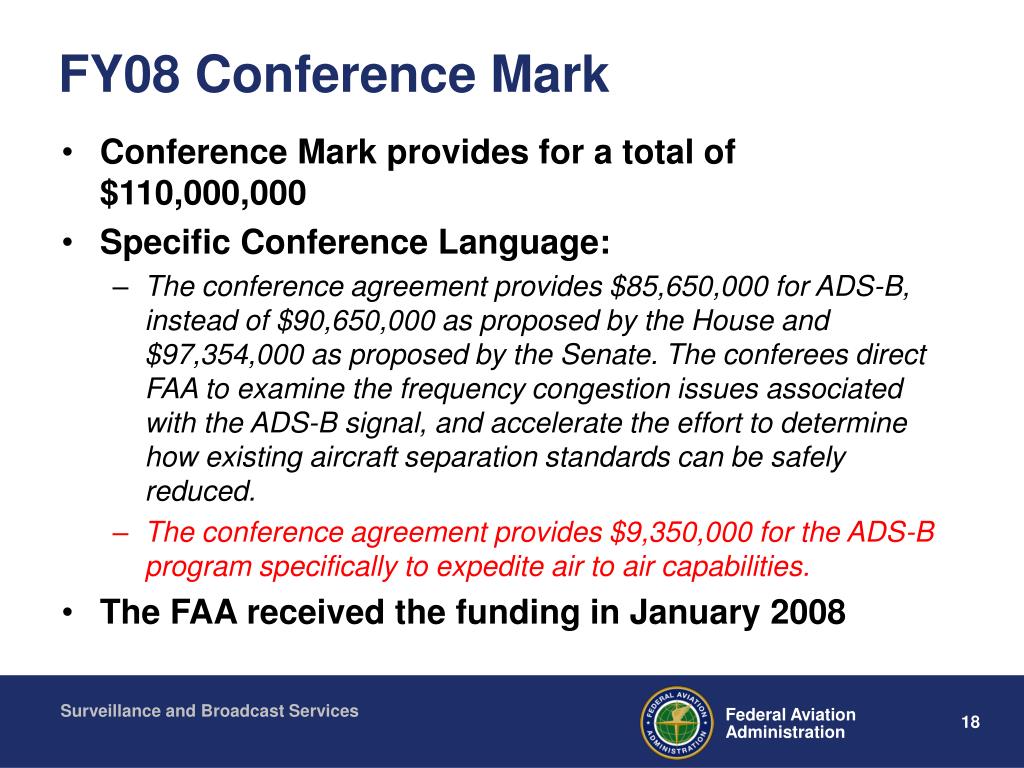

FY08 Conference Mark • Conference Mark provides for a total of $110,000,000 • Specific Conference Language: • The conference agreement provides $85,650,000 for ADS-B, instead of $90,650,000 as proposed by the House and $97,354,000 as proposed by the Senate. The conferees direct FAA to examine the frequency congestion issues associated with the ADS-B signal, and accelerate the effort to determine how existing aircraft separation standards can be safely reduced. • The conference agreement provides $9,350,000 for the ADS-B program specifically to expedite air to air capabilities. • The FAA received the funding in January 2008

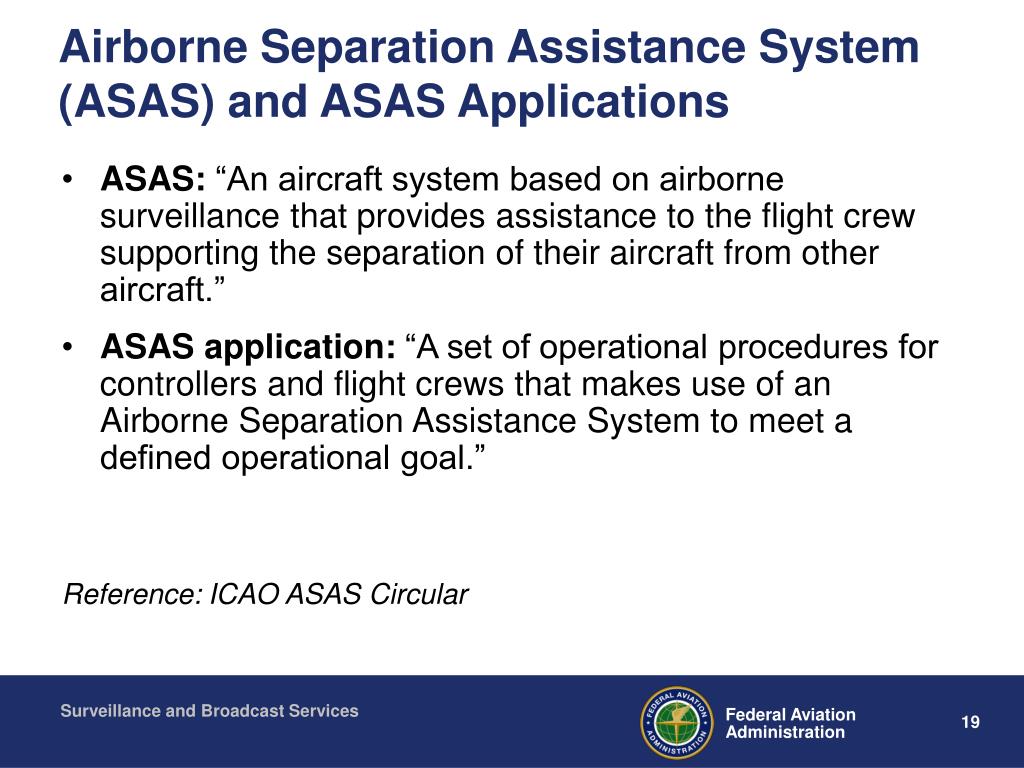

Airborne Separation Assistance System (ASAS) and ASAS Applications • ASAS: “An aircraft system based on airborne surveillance that provides assistance to the flight crew supporting the separation of their aircraft from other aircraft.” • ASAS application: “A set of operational procedures for controllers and flight crews that makes use of an Airborne Separation Assistance System to meet a defined operational goal.” Reference: ICAO ASAS Circular

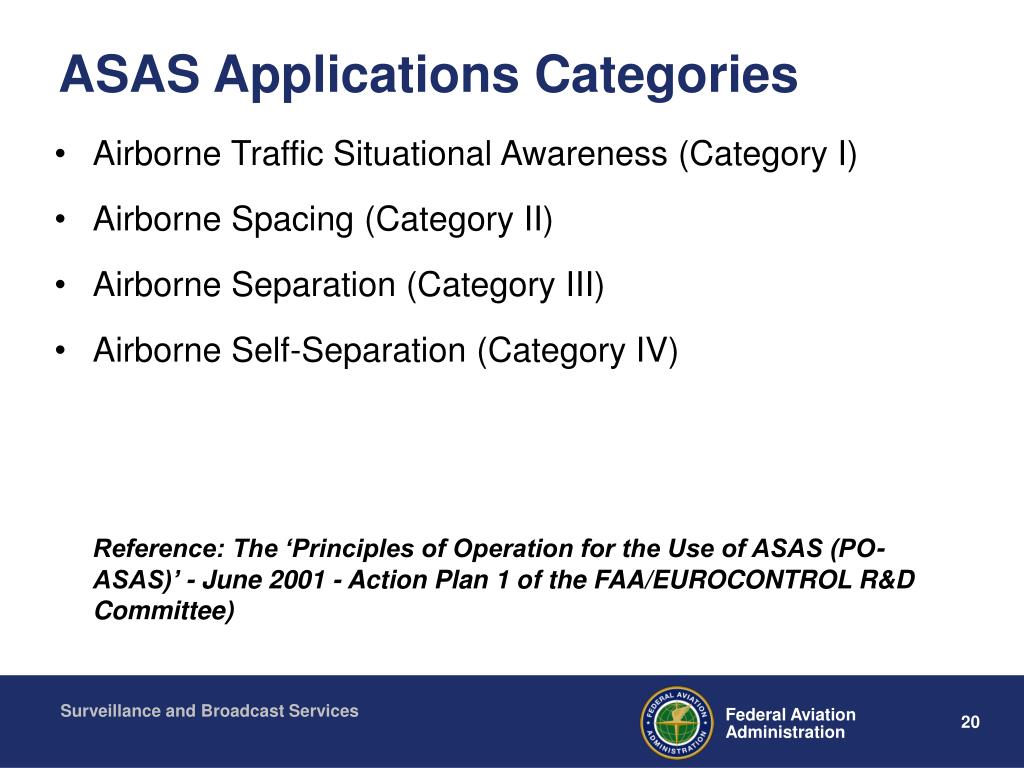

ASAS Applications Categories • Airborne Traffic Situational Awareness (Category I) • Airborne Spacing (Category II) • Airborne Separation (Category III) • Airborne Self-Separation (Category IV) Reference: The ‘Principles of Operation for the Use of ASAS (PO-ASAS)’ - June 2001 - Action Plan 1 of the FAA/EUROCONTROL R&D Committee)
Process for Selecting Applications Identify NAS needs (Problems) Portfolio of applications from existing sources Decompose into sub-problems PHASE 1 Application Characterization Is application a subset of / traceable to an existing AIWP application? Map sub-problems to required capabilities Refer to AIWP Yes Identify applications to support capabilities No Is application description sufficient to enable business case analysis? Develop/Refine application description No Yes Eliminate applications below minimum threshold Conduct business case analysis PHASE 2 Application Prioritization Rank application based on business case results Steering Committee requires mods to prioritized list? No Timeline of Applications Yes

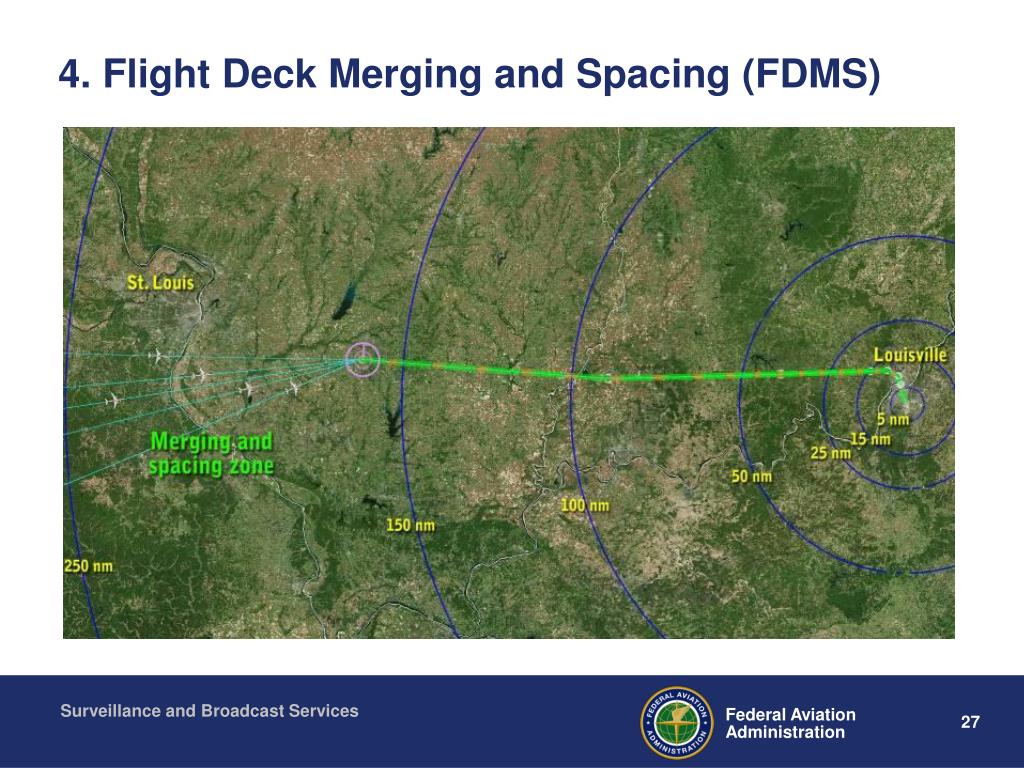

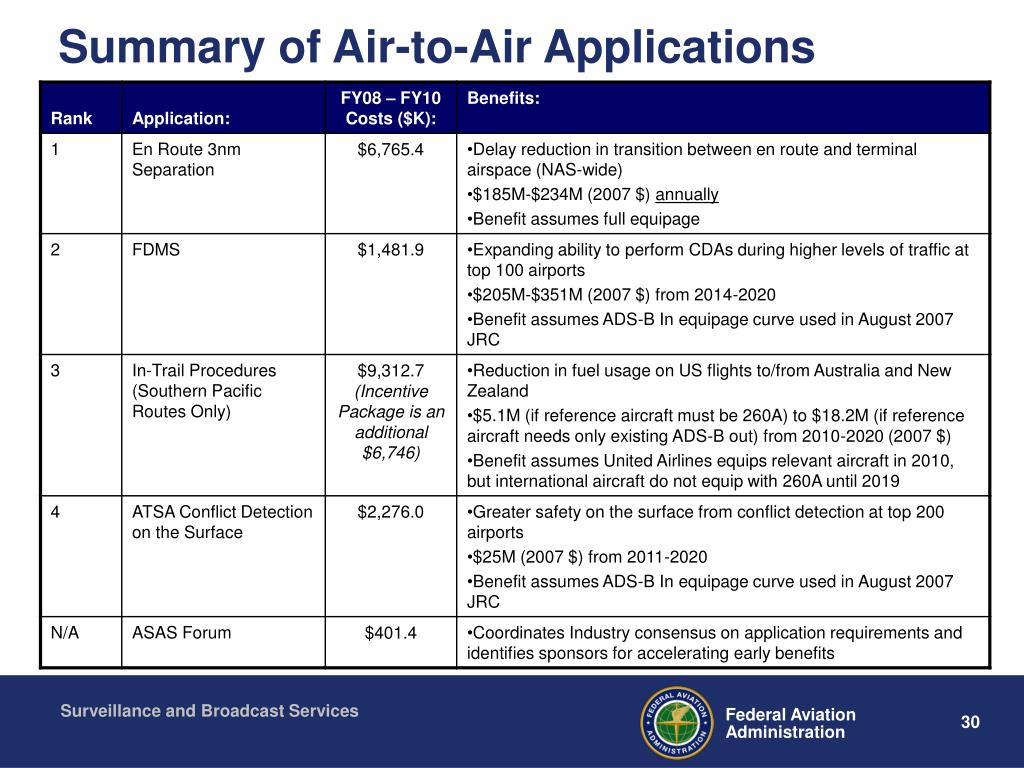

Acceleration of Future Air-to-Air Applications • En Route 3nm Separation • In-Trail Procedures • ATSA Conflict Detection on the Surface • Flight Deck Merging and Spacing • ASAS Forum

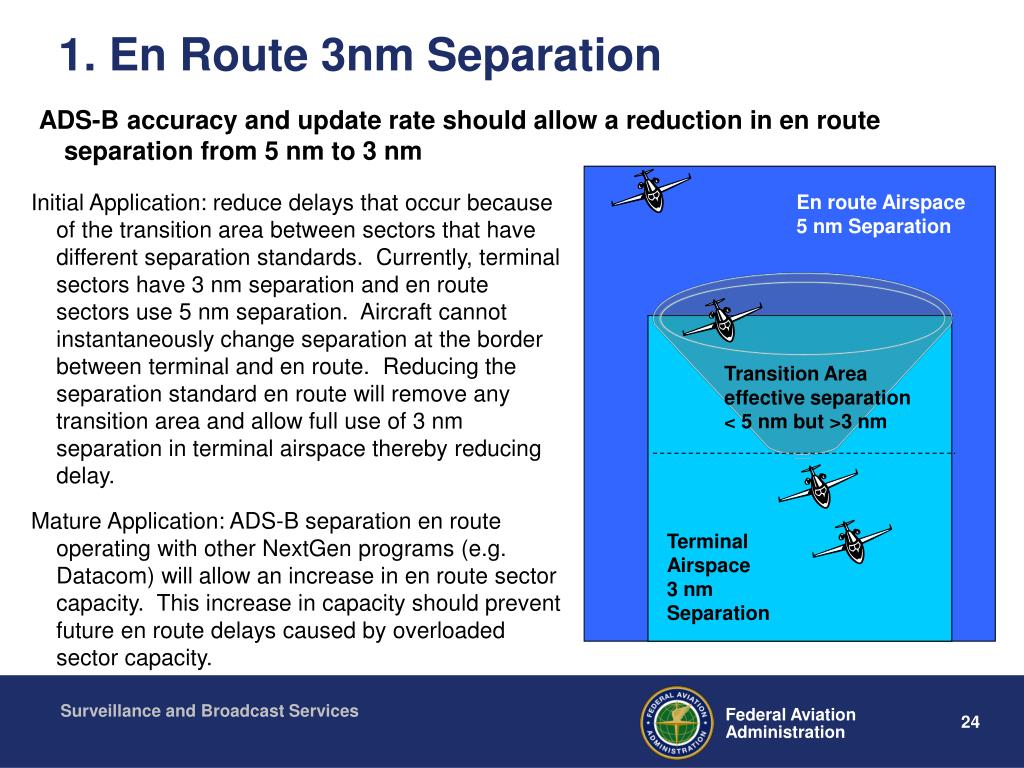

1. En Route 3nm Separation ADS-B accuracy and update rate should allow a reduction in en route separation from 5 nm to 3 nm Initial Application: reduce delays that occur because of the transition area between sectors that have different separation standards. Currently, terminal sectors have 3 nm separation and en route sectors use 5 nm separation. Aircraft cannot instantaneously change separation at the border between terminal and en route. Reducing the separation standard en route will remove any transition area and allow full use of 3 nm separation in terminal airspace thereby reducing delay. Mature Application: ADS-B separation en route operating with other NextGen programs (e.g. Datacom) will allow an increase in en route sector capacity. This increase in capacity should prevent future en route delays caused by overloaded sector capacity. En route Airspace 5 nm Separation Transition Area effective separation < 5 nm but >3 nm Terminal Airspace 3 nm Separation

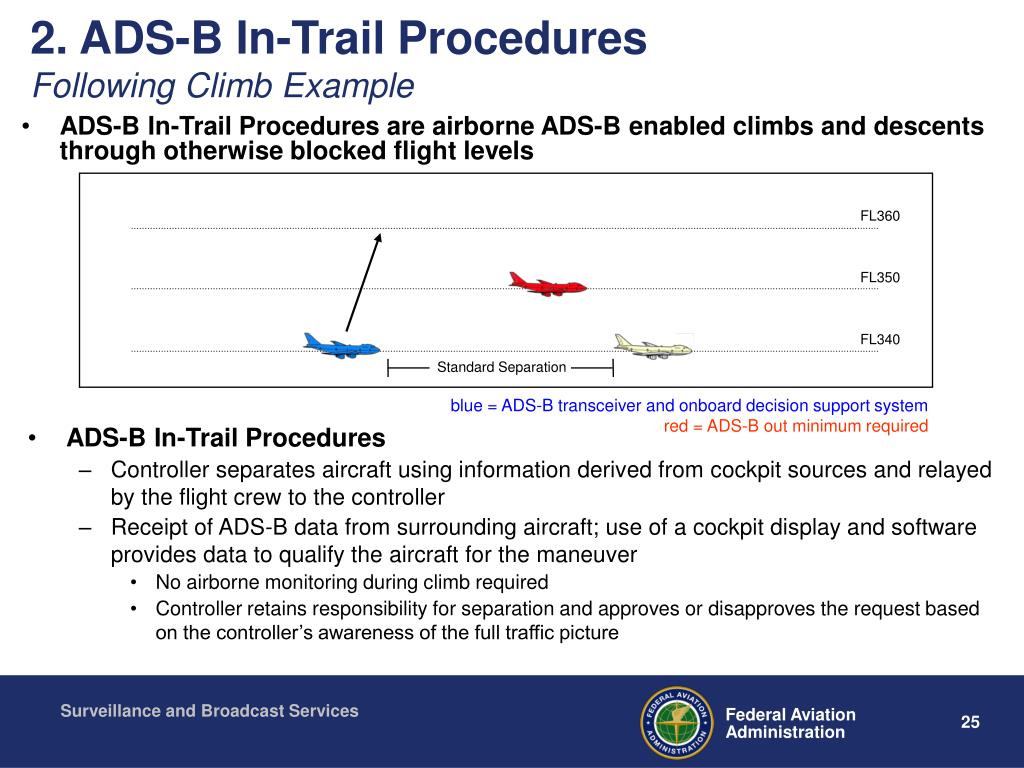

2. ADS-B In-Trail Procedures Following Climb Example • ADS-B In-Trail Procedures are airborne ADS-B enabled climbs and descents through otherwise blocked flight levels • ADS-B In-Trail Procedures • Controller separates aircraft using information derived from cockpit sources and relayed by the flight crew to the controller • Receipt of ADS-B data from surrounding aircraft; use of a cockpit display and software provides data to qualify the aircraft for the maneuver • No airborne monitoring during climb required • Controller retains responsibility for separation and approves or disapproves the request based on the controller’s awareness of the full traffic picture FL360 FL350 FL340 Standard Separation blue = ADS-B transceiver and onboard decision support system red = ADS-B out minimum required

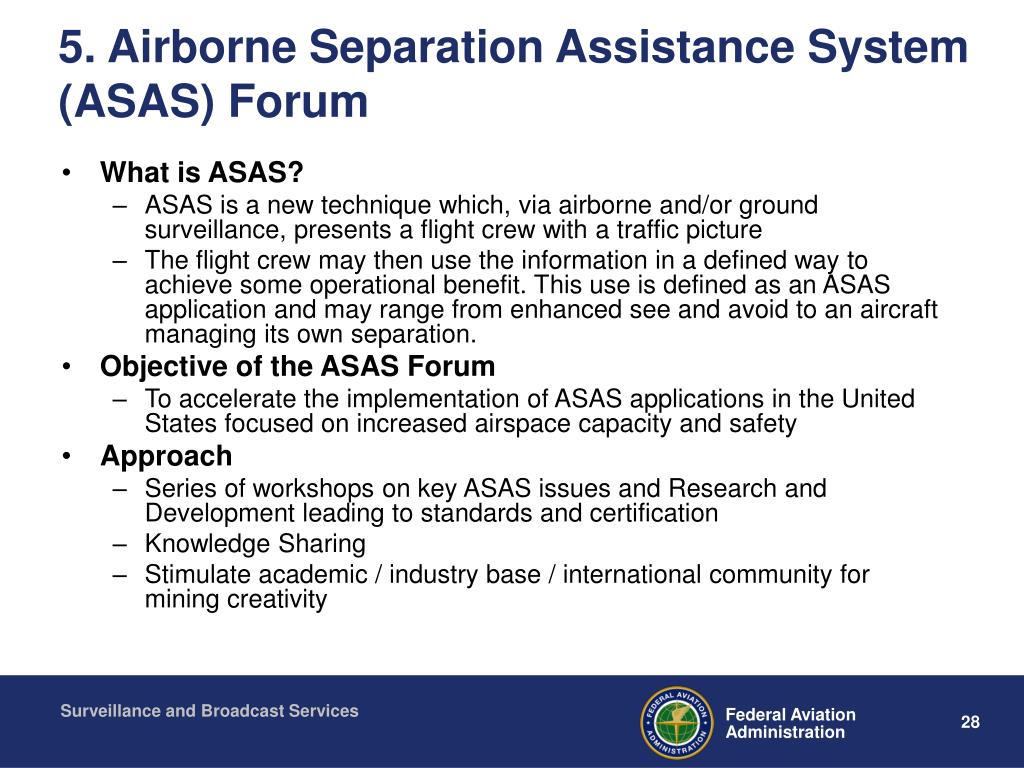

5. Airborne Separation Assistance System (ASAS) Forum • What is ASAS? • ASAS is a new technique which, via airborne and/or ground surveillance, presents a flight crew with a traffic picture • The flight crew may then use the information in a defined way to achieve some operational benefit. This use is defined as an ASAS application and may range from enhanced see and avoid to an aircraft managing its own separation. • Objective of the ASAS Forum • To accelerate the implementation of ASAS applications in the United States focused on increased airspace capacity and safety • Approach • Series of workshops on key ASAS issues and Research and Development leading to standards and certification • Knowledge Sharing • Stimulate academic / industry base / international community for mining creativity

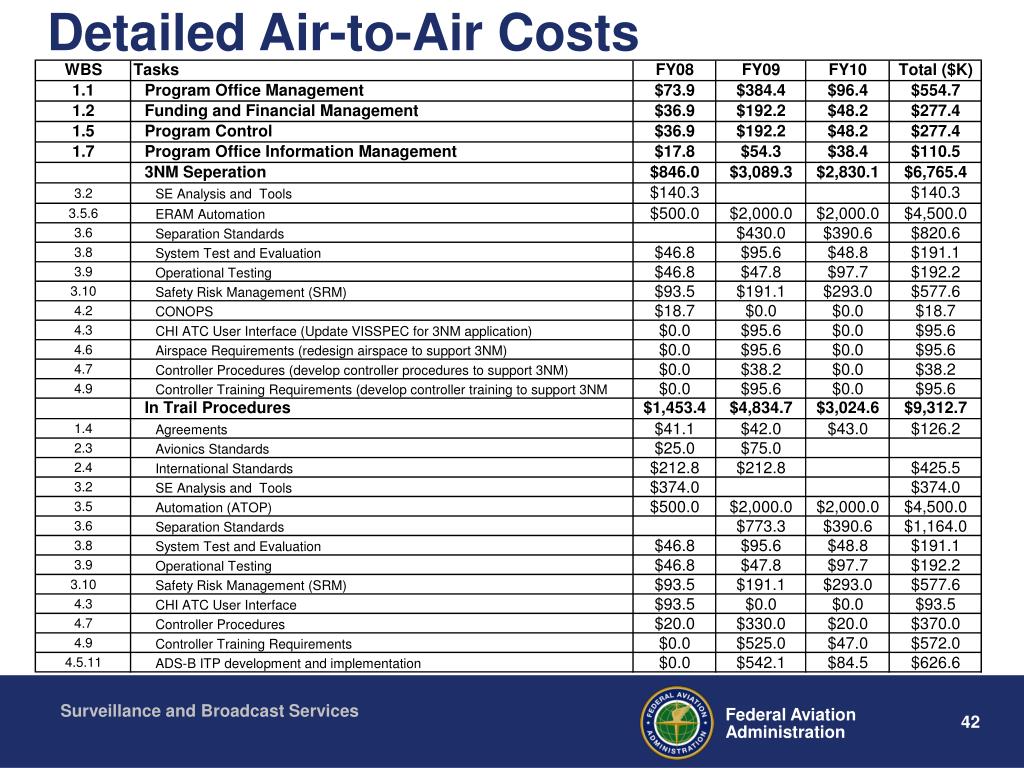

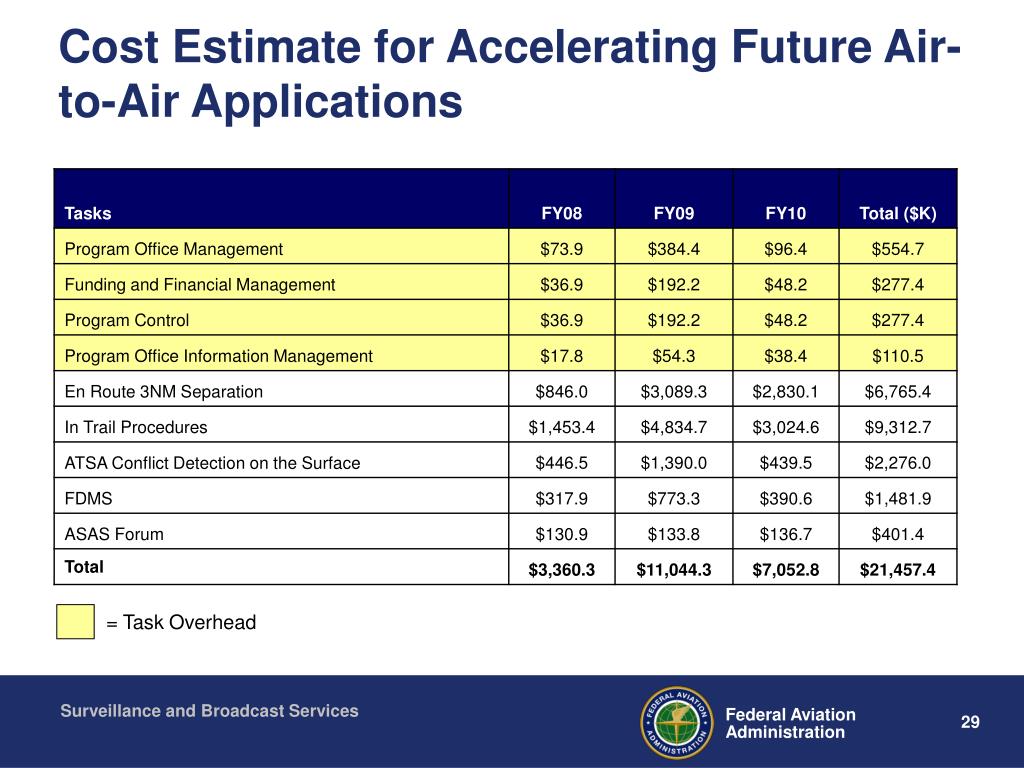

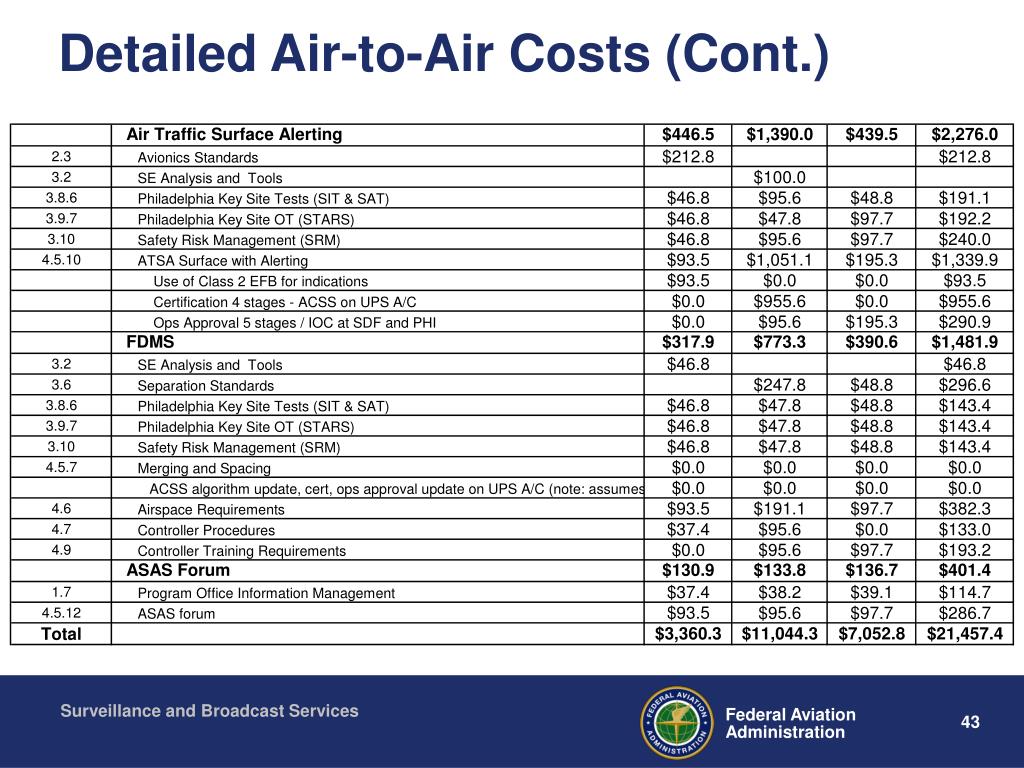

Cost Estimate for Accelerating Future Air-to-Air Applications = Task Overhead

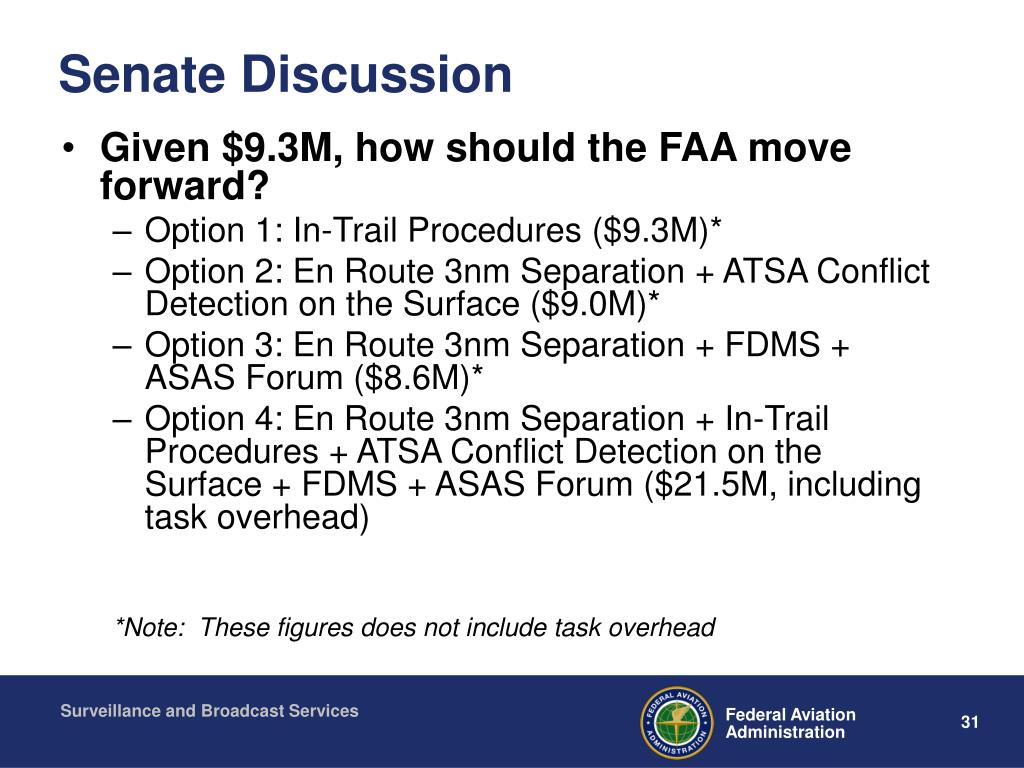

Senate Discussion • Given $9.3M, how should the FAA move forward? • Option 1: In-Trail Procedures ($9.3M)* • Option 2: En Route 3nm Separation + ATSA Conflict Detection on the Surface ($9.0M)* • Option 3: En Route 3nm Separation + FDMS + ASAS Forum ($8.6M)* • Option 4: En Route 3nm Separation + In-Trail Procedures + ATSA Conflict Detection on the Surface + FDMS + ASAS Forum ($21.5M, including task overhead) *Note: These figures does not include task overhead
Thank You Achieving results through coordinated international collaboration

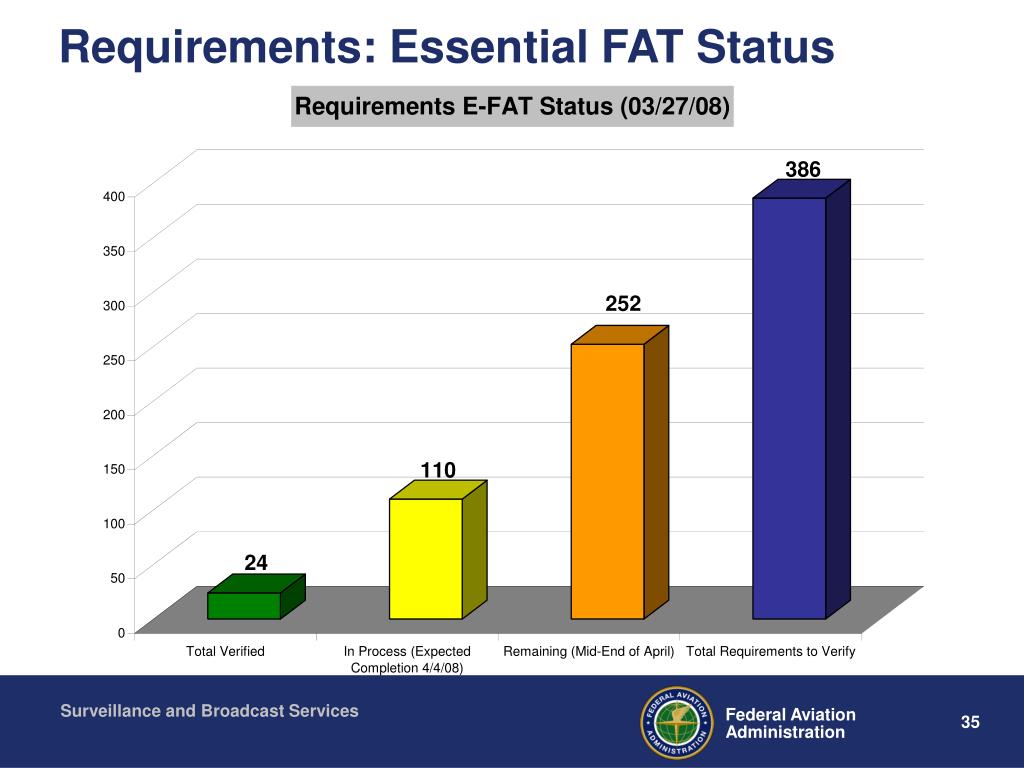

Acquisition Status: Essential Services Factory Acceptance Test (E-FAT) • Verifies compliance of Essential Services equipment with Essential Services Specification • Completion of development activities delayed start of E-FAT by one month • Test Readiness Review Completed on 3/13/08 • E-FAT formal test began on 3/19/08 • E-FAT activities scheduled for 4 weeks • Efforts to finalize procedures and complete development activities likely to extend E-FAT another 2 – 4 weeks

Work Breakdown Structure: 3NM Separation As of 2/15/08 Version 1
Work Breakdown Structure: In-Trail Procedures As of 2/15/08 Version 1
Work Breakdown Structure: Air Traffic Surface Alerting As of 2/15/08 Version 1

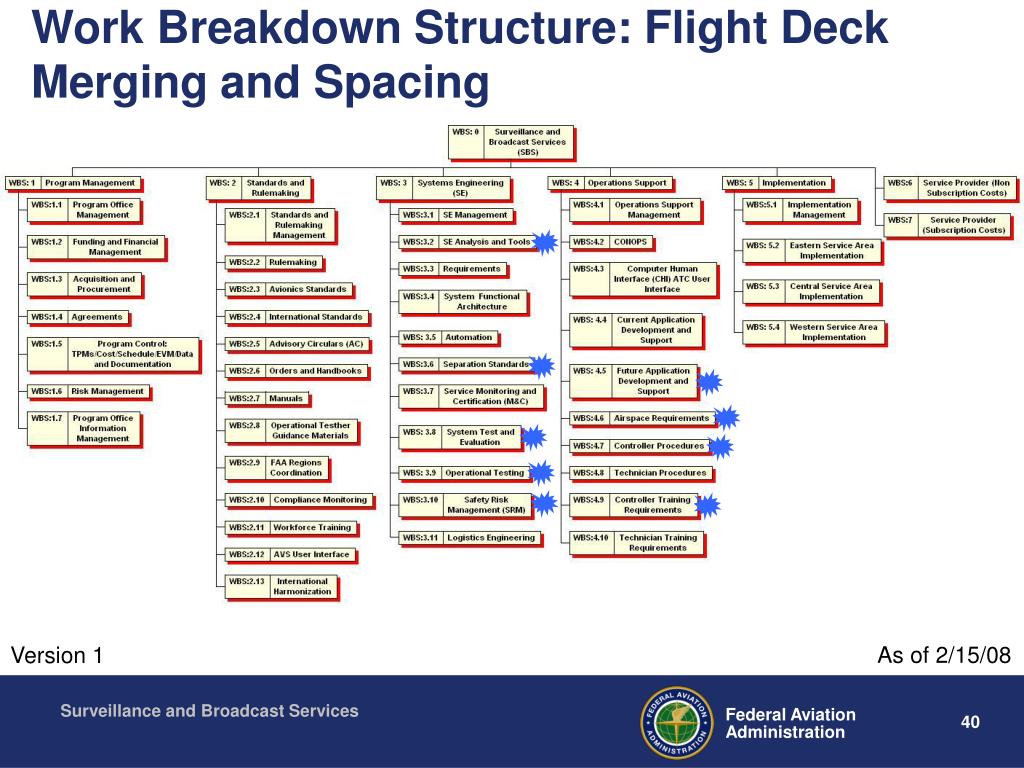

Work Breakdown Structure: Flight Deck Merging and Spacing As of 2/15/08 Version 1

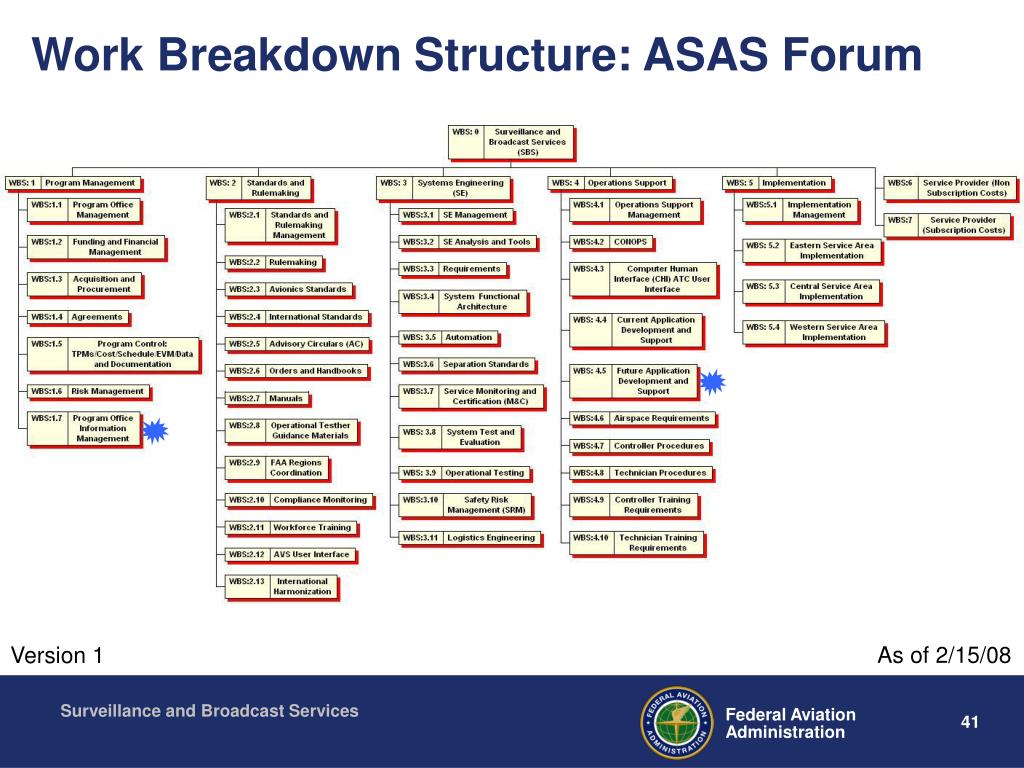

Work Breakdown Structure: ASAS Forum As of 2/15/08 Version 1

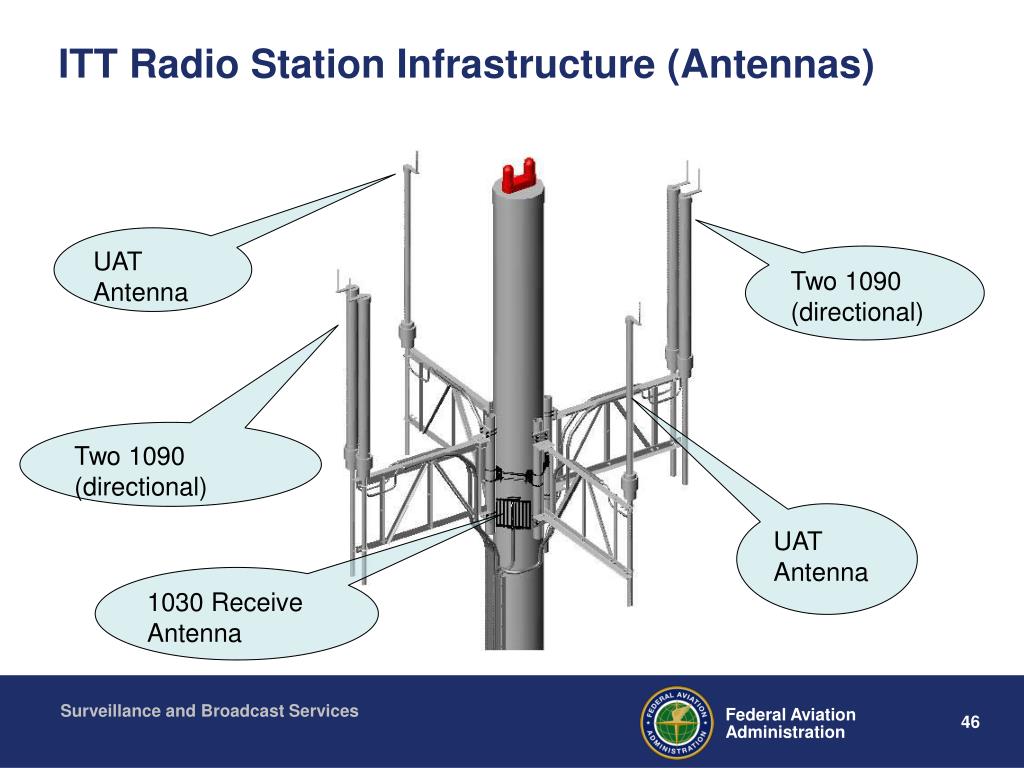

ITT Radio Station Infrastructure (Antennas) UAT Antenna Two 1090 (directional) Two 1090 (directional) UAT Antenna 1030 Receive Antenna

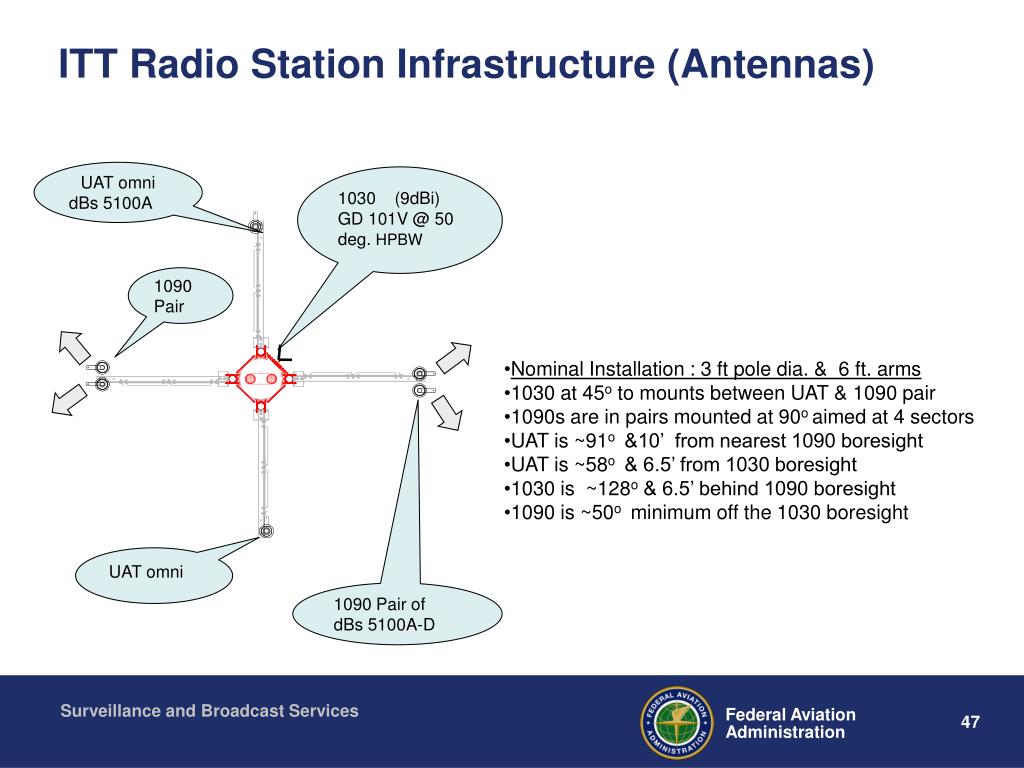

ITT Radio Station Infrastructure (Antennas) UAT omni dBs 5100A 1030 (9dBi) GD 101V @ 50 deg. HPBW 1090 Pair UAT omni 1090 Pair of dBs 5100A-D Nominal Installation : 3 ft pole dia. & 6 ft. arms 1030 at 45o to mounts between UAT & 1090 pair 1090s are in pairs mounted at 90o aimed at 4 sectors UAT is ~91o &10’ from nearest 1090 boresight UAT is ~58o & 6.5’ from 1030 boresight 1030 is ~128o & 6.5’ behind 1090 boresight 1090 is ~50o minimum off the 1030 boresight
