Miniature Centrifugal Compressor Development • Kevin Finney • Ray Zhou • Xiaoyi Li • Krishna Murty November 22, 2002

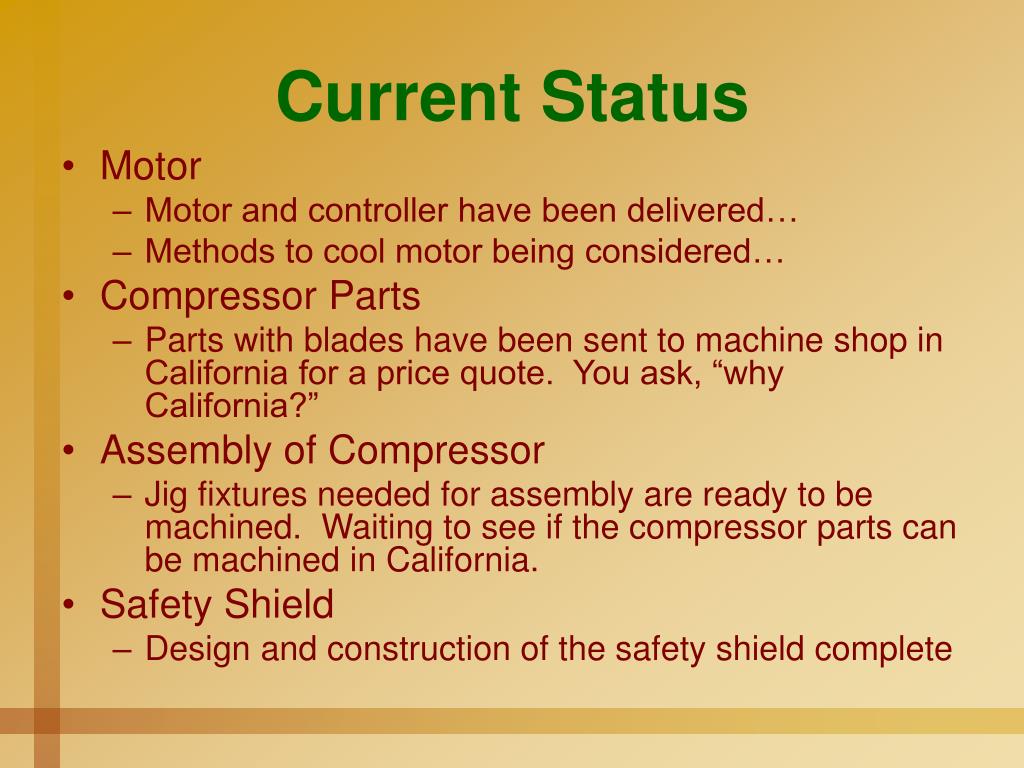

Current Status • Motor • Motor and controller have been delivered… • Methods to cool motor being considered… • Compressor Parts • Parts with blades have been sent to machine shop in California for a price quote. You ask, “why California?” • Assembly of Compressor • Jig fixtures needed for assembly are ready to be machined. Waiting to see if the compressor parts can be machined in California. • Safety Shield • Design and construction of the safety shield complete
Motor Update • Received the motor • Motor brackets can be designed and built now. Can include integrated cooling jacket. • Need to obtain an adjustable power supply and solder the wires to the wire leads. • Motor requirements given in following table… Therefore, to obtain the desirable speed and power…

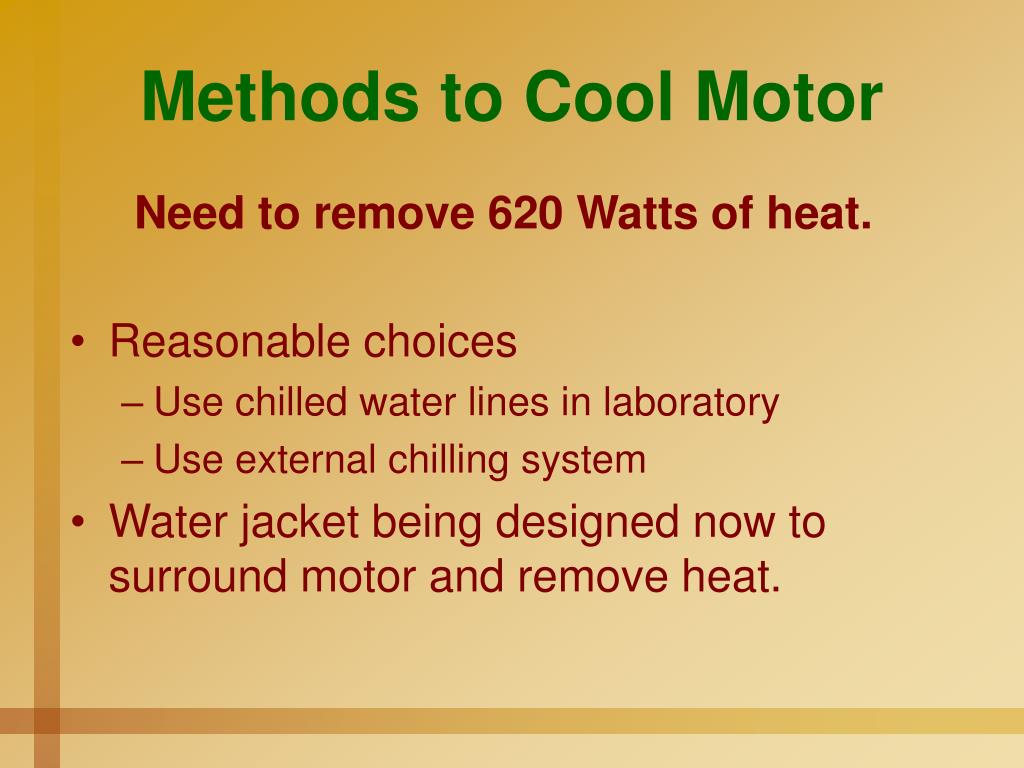

Methods to Cool Motor • Reasonable choices • Use chilled water lines in laboratory • Use external chilling system • Water jacket being designed now to surround motor and remove heat. Need to remove 620 Watts of heat.

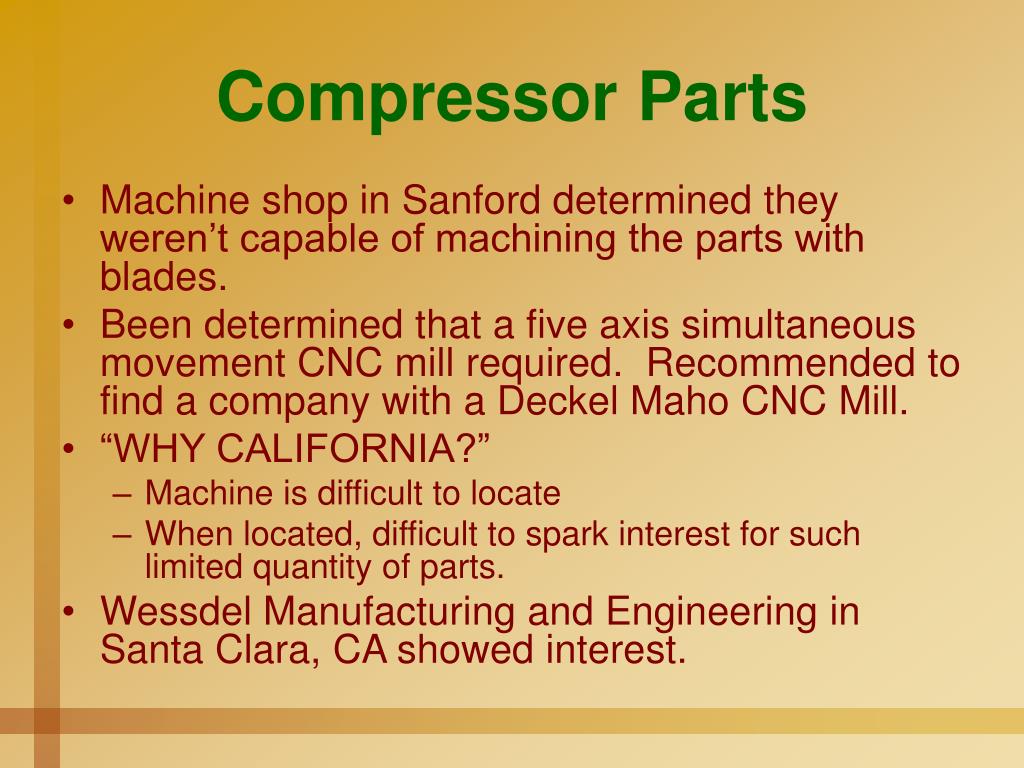

Compressor Parts • Machine shop in Sanford determined they weren’t capable of machining the parts with blades. • Been determined that a five axis simultaneous movement CNC mill required. Recommended to find a company with a Deckel Maho CNC Mill. • “WHY CALIFORNIA?” • Machine is difficult to locate • When located, difficult to spark interest for such limited quantity of parts. • Wessdel Manufacturing and Engineering in Santa Clara, CA showed interest.

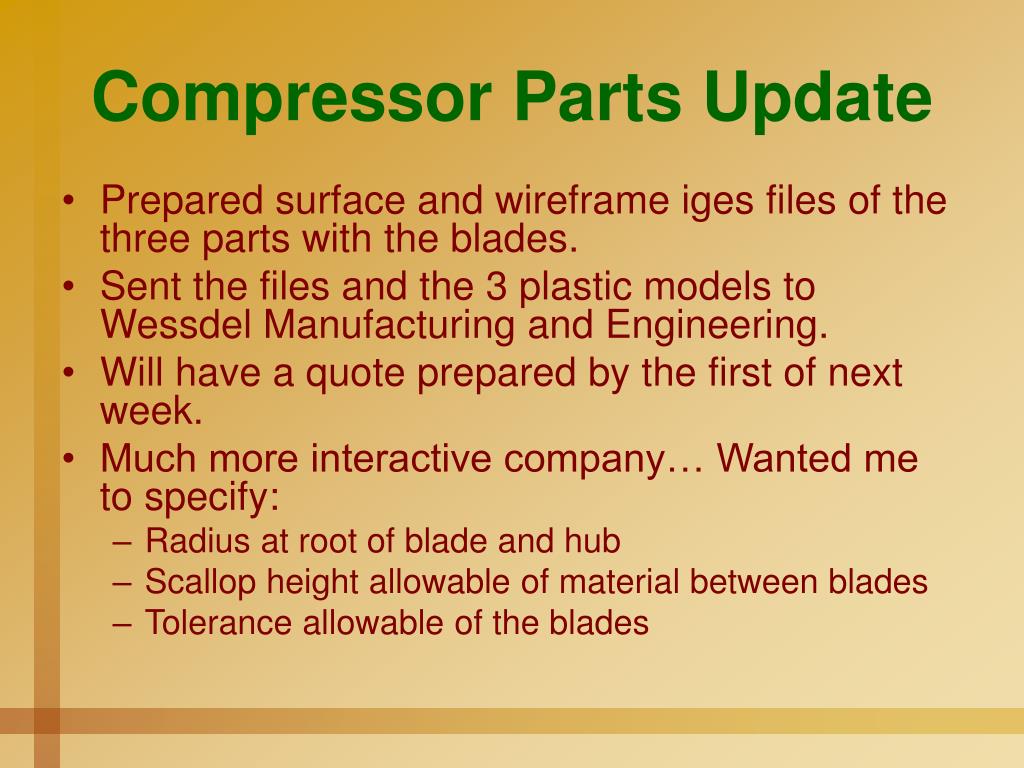

Compressor Parts Update • Prepared surface and wireframe iges files of the three parts with the blades. • Sent the files and the 3 plastic models to Wessdel Manufacturing and Engineering. • Will have a quote prepared by the first of next week. • Much more interactive company… Wanted me to specify: • Radius at root of blade and hub • Scallop height allowable of material between blades • Tolerance allowable of the blades
Status of Jig Fixtures for Assembly • Parts required for mounting of bearings and assembly of compressor will be machined once the Impeller, Diffuser, and Guide Vane are being machined. • The jig fixture parts aren’t needed until the compressor parts are acquired.

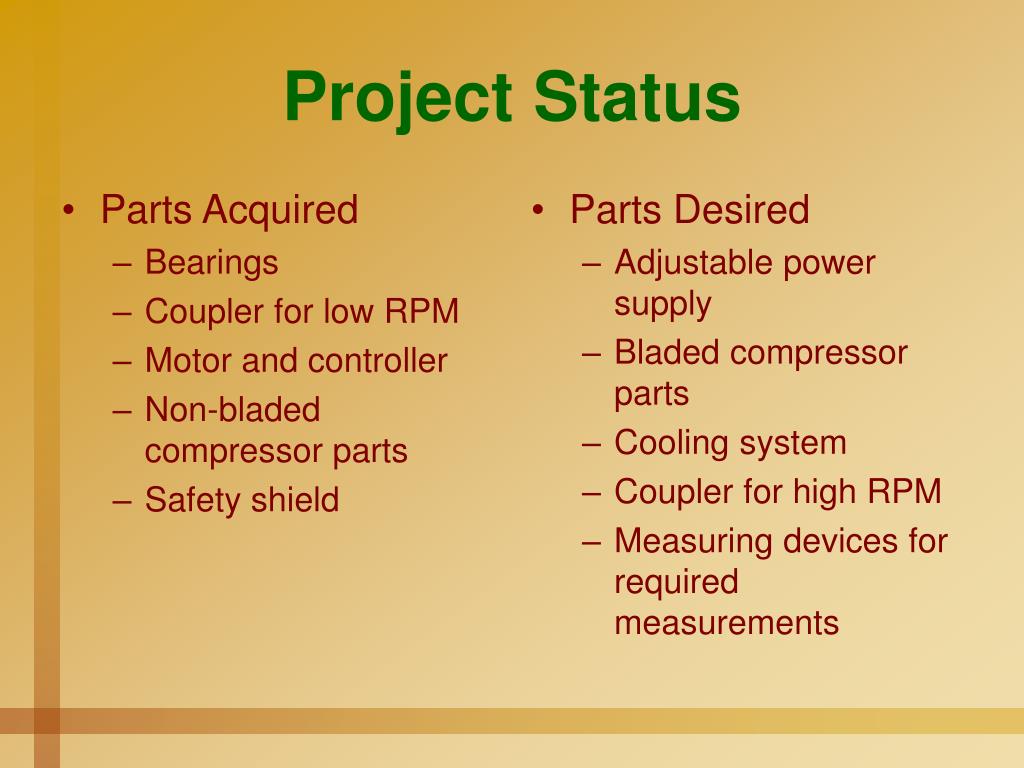

Parts Acquired Bearings Coupler for low RPM Motor and controller Non-bladed compressor parts Safety shield Parts Desired Adjustable power supply Bladed compressor parts Cooling system Coupler for high RPM Measuring devices for required measurements Project Status
