Series 2: Project Management Understanding and Using 6 Basic Tools

Series 2: Project Management Understanding and Using 6 Basic Tools. From the CIHS Video Series “Ten Minutes at a Time” . 9/2013. Module 2: Setting up the Project Schedule Overview.

shanta
Télécharger la présentation

Series 2: Project Management Understanding and Using 6 Basic Tools

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Series 2: Project ManagementUnderstanding and Using 6 Basic Tools From the CIHS Video Series “Ten Minutes at a Time” 9/2013

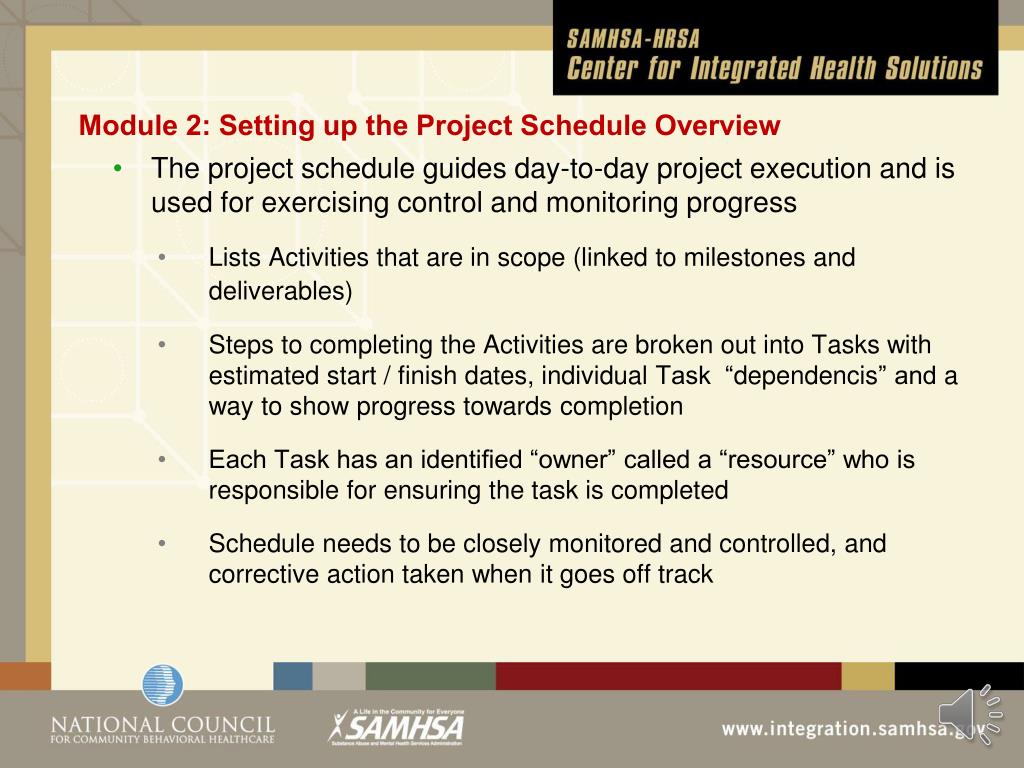

  2. Module 2: Setting up the Project Schedule Overview • The project schedule guides day-to-day project execution and is used for exercising control and monitoring progress • Lists Activities that are in scope (linked to milestones and deliverables) • Steps to completing the Activities are broken out into Tasks with estimated start / finish dates, individual Task “dependencis” and a way to show progress towards completion • Each Task has an identified “owner” called a “resource” who is responsible for ensuring the task is completed • Schedule needs to be closely monitored and controlled, and corrective action taken when it goes off track

  3. Specialized Software Commercially available Free Online Project Management Tools: http://www.pcmag.com/article2/0,2817,2380448,00.asp Project Schedule and Gannt Chart (Excel): Additional Excel tools: http://www.vertex42.com/ExcelTemplates/excel-gantt-chart.html http://chandoo.org/wp/project-management/

  4. Activities and Tasks

  5. Start/Finish Dates and Duration

  6. Predecessors

  7. Resources

  8. Activity / Task “Float”

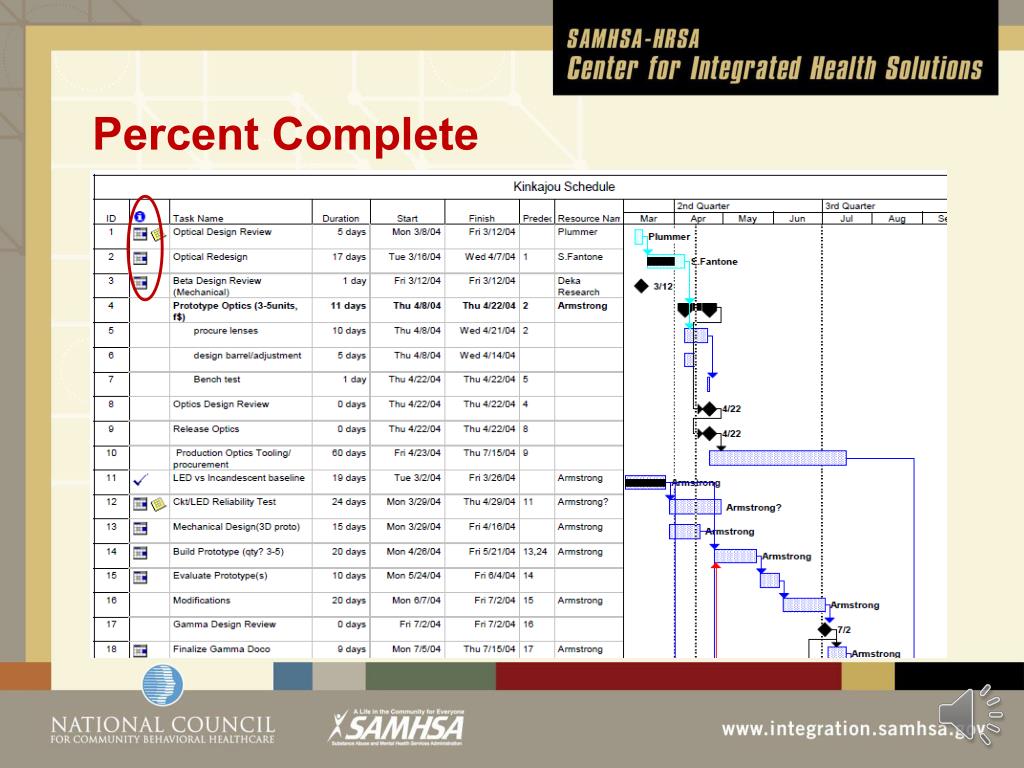

  9. Percent Complete

  10. Example of a Critical Path

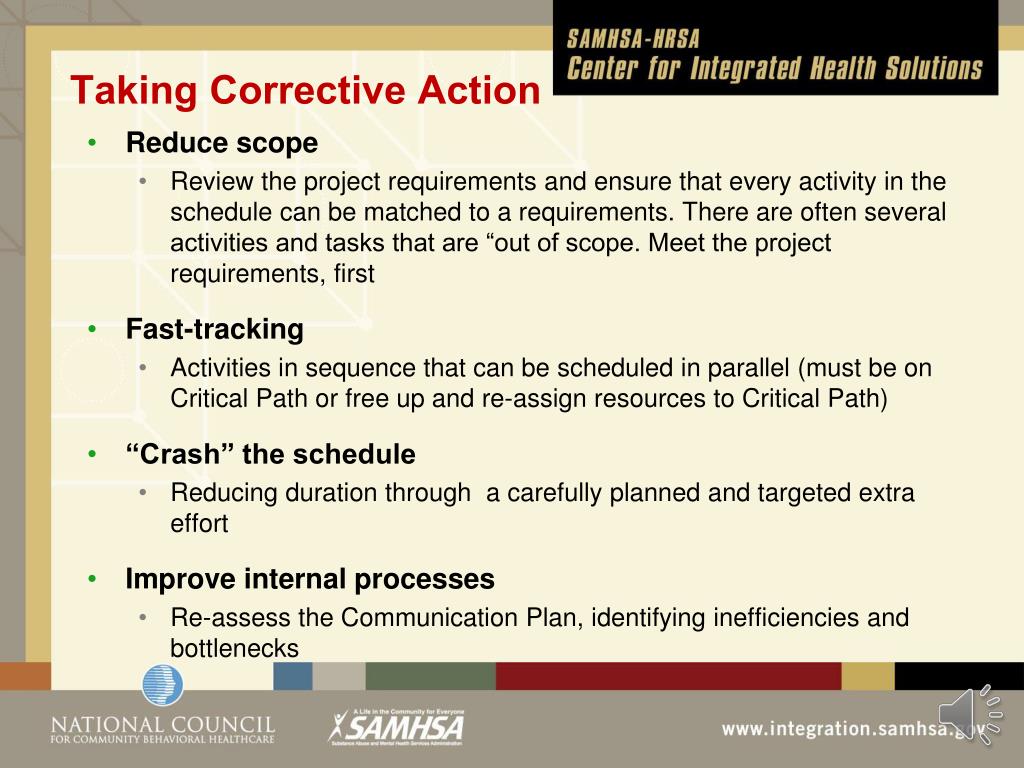

  11. Taking Corrective Action • Reduce scope • Review the project requirements and ensure that every activity in the schedule can be matched to a requirements. There are often several activities and tasks that are “out of scope. Meet the project requirements, first • Fast-tracking • Activities in sequence that can be scheduled in parallel (must be on Critical Path or free up and re-assign resources to Critical Path) • “Crash” the schedule • Reducing duration through a carefully planned and targeted extra effort • Improve internal processes • Re-assess the Communication Plan, identifying inefficiencies and bottlenecks

  12. Summary • The Project Schedule is the most active part of the Project Plan. Specialized software is nice but not necessary. • At a minimum it should identify project Activities and Tasks with Start and Finish Dates and Predecessors; a point person responsible for work completion; a way to indicate the progress towards completion; and the project Critical Path. • To bring a Project Schedule under control, use effective interventions applied to Critical Tasks – these include reducing project scope; fast-tracking; crashing and evaluating the impact project team activities are having on getting the work done

  13. We Have Solutions for Integrating Primary and Behavioral Healthcare Contact CIHS for all types of primary and behavioral health care integration technical assistance and training needs 1701 K Street NW, Ste 400 Washington DC 20006 Web: www.integration.samhsa.gov Email: integration@thenationalcouncil.org Phone: 202-684-7457 Prepared and presented by Colleen O’Donnell, MSW, PMP, CHTS-IM for the Center for Integrated Health Solutions
