GOES-R Ground Segment Project Update: AMS Annual Meeting Insights
The GOES-R Ground Segment Project Update presented at the American Meteorological Society Annual Meeting on January 20, 2010, outlines critical objectives for supporting mission operations, minimizing transition impacts, and integrating cost-effective solutions. The collaborative efforts with Harris Corporation and subcontractors aim to enhance system performance, maintain compatibility with NOAA systems, and ensure flexible design. This update also touches on recent technical reviews, contracts established, and ongoing development statuses set to support upcoming technical reviews and user-oriented events.
GOES-R Ground Segment Project Update: AMS Annual Meeting Insights
E N D
Presentation Transcript
GOES-R Ground Segment Project Update Vanessa Griffin Project Manager, GOES-R Ground Segment Project American Meteorological Society Annual Meeting Atlanta, Georgia January 20, 2010
GOES-R Ground Segment Objectives • Support the primary mission operations goals to launch and operate the spacecraft • Design, develop, integrate and test the Ground Segment minimizing the GOES-R overall program costs • Minimize the impact to existing users during the transition to GOES-R • Provide cost-effective sustainment and maintenance once transitioned to Government operations • Provide cost-effective and timely solutions to meet evolving Ground Segment requirements • Open standards • Modular, scalable, flexible system design • Industry standard system and software engineering practices • Maintain compatibility with existing and enhanced versions of NOAA institutional systems required to support the GOES-R spacecraft 6.2 GOES-R Ground Segment Project Update American Meteorological Society Annual Meeting
Notional Functional Overview TLM, Raw Data TLM, Raw Data CMD CMD GRB GRB GRB GRB RBU WCDAS NSOF Core Ground Segment Functions Core Ground Segment Functions Core Ground Segment Functions GAS (OSD) GOES-N/P (OSD) Product Users AWIPS (NWS) CLASS (OSD) 6.2 GOES-R Ground Segment Project Update American Meteorological Society Annual Meeting

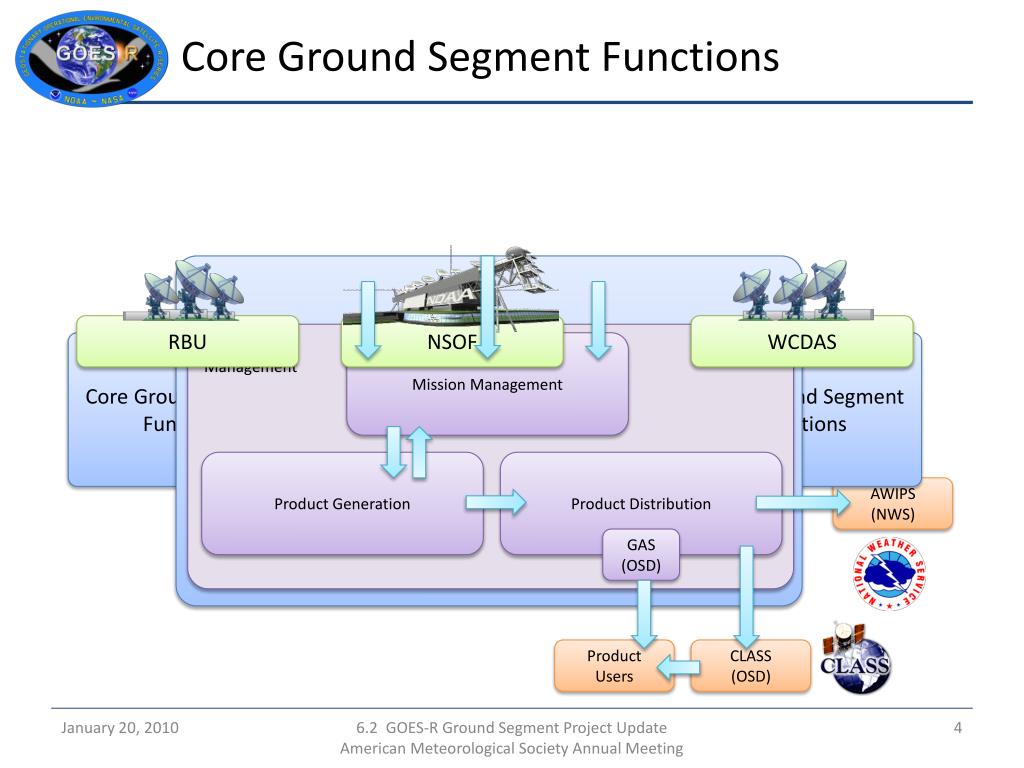

Core Ground Segment Functions Core Ground Segment Functions RBU WCDAS NSOF Enterprise Management Core Ground Segment Functions Core Ground Segment Functions Mission Management Core Ground Segment Functions Product Generation Product Distribution AWIPS (NWS) GAS (OSD) Product Users CLASS (OSD) 6.2 GOES-R Ground Segment Project Update American Meteorological Society Annual Meeting

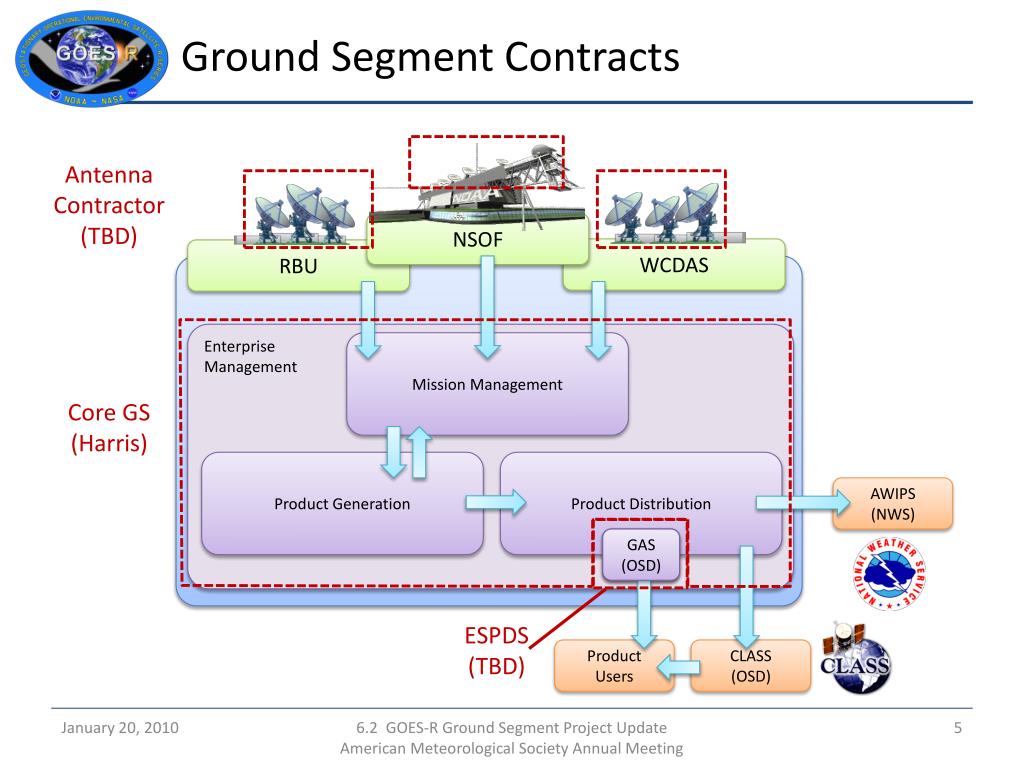

Ground Segment Contracts Antenna Contractor (TBD) Core Ground Segment Functions RBU WCDAS NSOF Enterprise Management Mission Management Core GS (Harris) Product Generation Product Distribution AWIPS (NWS) GAS (OSD) GAS (OSD) ESPDS (TBD) Product Users CLASS (OSD) 6.2 GOES-R Ground Segment Project Update American Meteorological Society Annual Meeting
Core GS Contractor: Harris Corporation • Government Communications Systems Division (GCSD), Melbourne, FL • Awarded May 27, 2009 • 10-year, $736M (with options) cost plus award fee contract • Does not include life-cycle operations and maintenance costs occurring after May, 2019 • Optional priced CLINs: Improved latency and refresh rates (Option 1) and additional Level 2+ Products (Option 2) • Subcontractors • Harris IT Services (HITS) • Boeing Mission Operations • Honeywell Technology Solutions Inc. Atmospheric and Environmental Research Inc. (AER) • Applied Research and • Engineering Sciences (ARES) • Carr Astronautics • Wyle Information • Systems LLC 6.2 GOES-R Ground Segment Project Update American Meteorological Society Annual Meeting

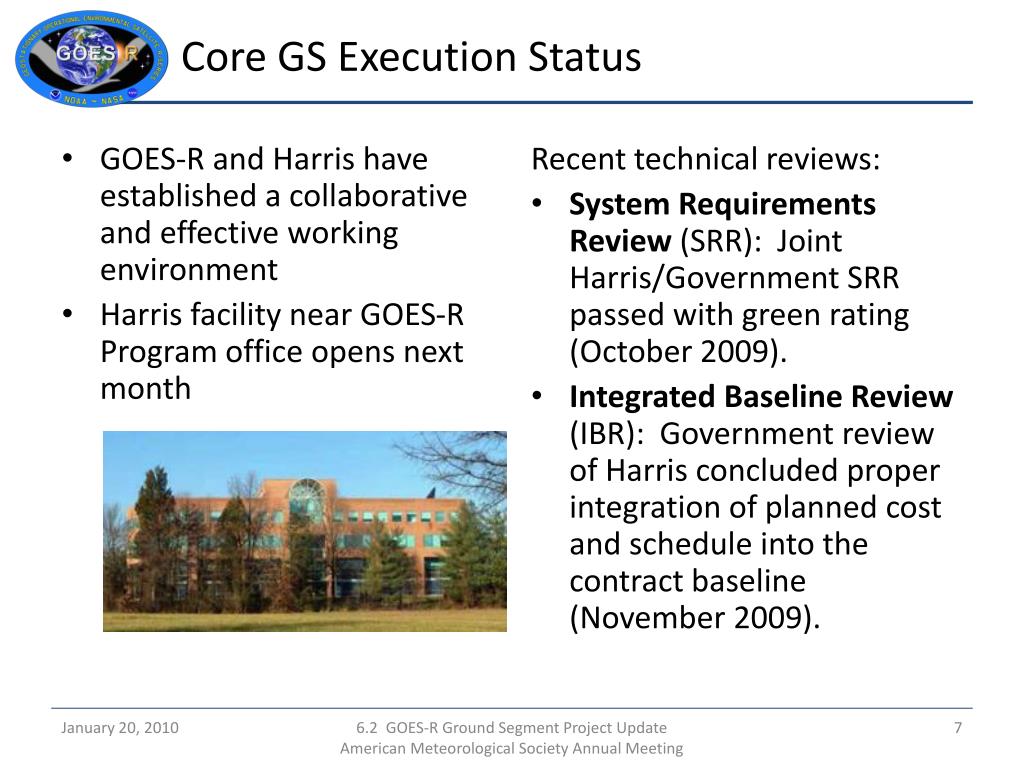

Core GS Execution Status • GOES-R and Harris have established a collaborative and effective working environment • Harris facility near GOES-R Program office opens next month Recent technical reviews: • System Requirements Review (SRR): Joint Harris/Government SRR passed with green rating (October 2009). • Integrated Baseline Review (IBR): Government review of Harris concluded proper integration of planned cost and schedule into the contract baseline (November 2009). 6.2 GOES-R Ground Segment Project Update American Meteorological Society Annual Meeting

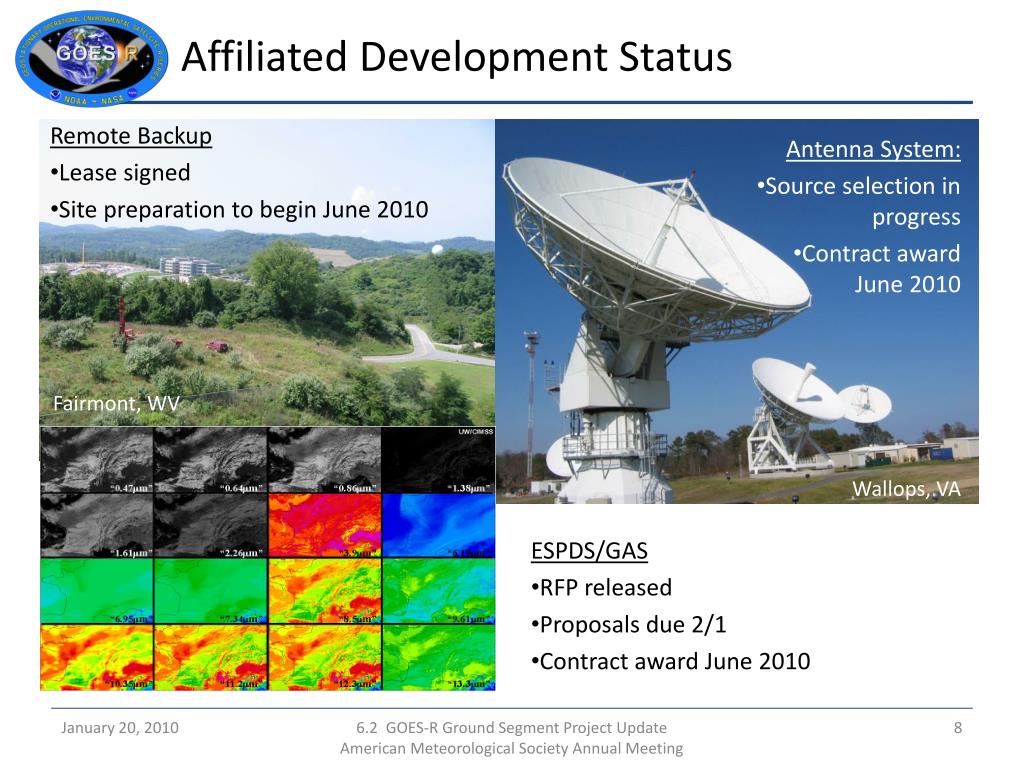

Affiliated Development Status • Remote Backup • Lease signed • Site preparation to begin June 2010 • Antenna System: • Source selection in progress • Contract award June 2010 Fairmont, WV Wallops, VA • ESPDS/GAS • RFP released • Proposals due 2/1 • Contract award June 2010 6.2 GOES-R Ground Segment Project Update American Meteorological Society Annual Meeting

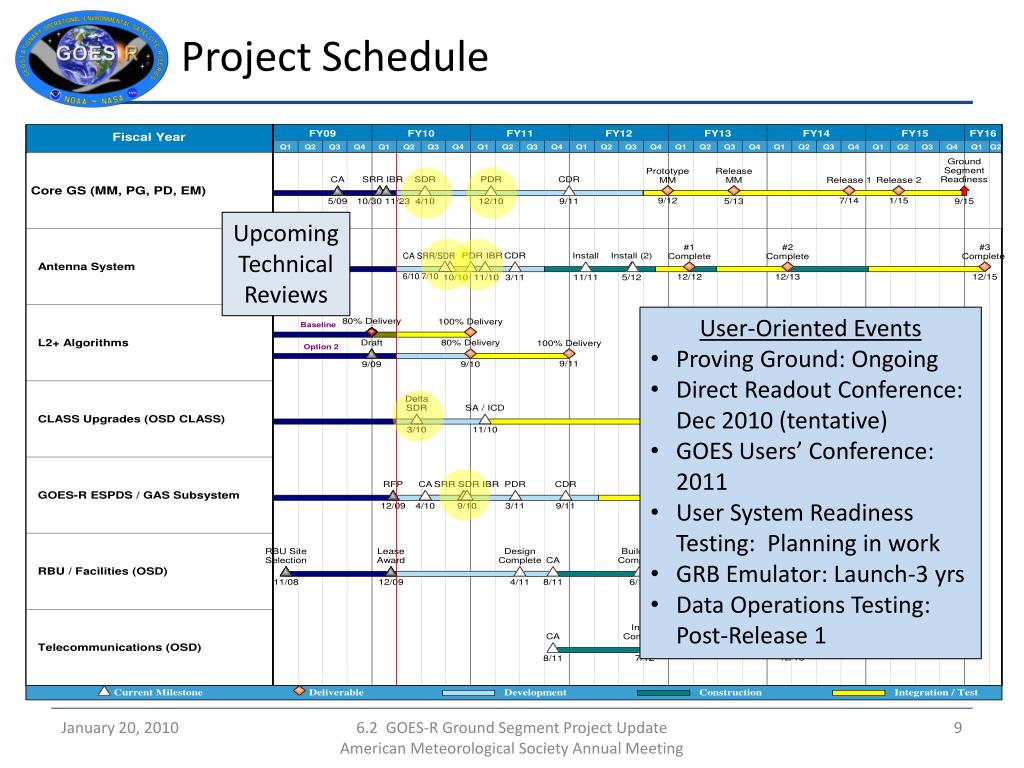

Project Schedule Upcoming Technical Reviews CA SRR/SDR 6/10 7/10 • User-Oriented Events • Proving Ground: Ongoing • Direct Readout Conference: Dec 2010 (tentative) • GOES Users’ Conference: 2011 • User System Readiness Testing: Planning in work • GRB Emulator: Launch-3 yrs • Data Operations Testing: Post-Release 1 6.2 GOES-R Ground Segment Project Update American Meteorological Society Annual Meeting
Questions? Answers to questions submitted at the GOES Users’ Conference will posted online soon at www.goes-r.gov
