130 likes | 306 Vues
Robin Pfister Deputy Project Manager, GOES-R Ground Segment. GOES Users’ Conference Madison, Wisconsin Tuesday, November 3, 2009. GOES-R Series Operations Concept. GOES-R Series Program Concept of Operations (CONOP) drove high-level requirements development
E N D
Robin PfisterDeputy Project Manager, GOES-R Ground Segment GOES Users’ Conference Madison, Wisconsin Tuesday, November 3, 2009

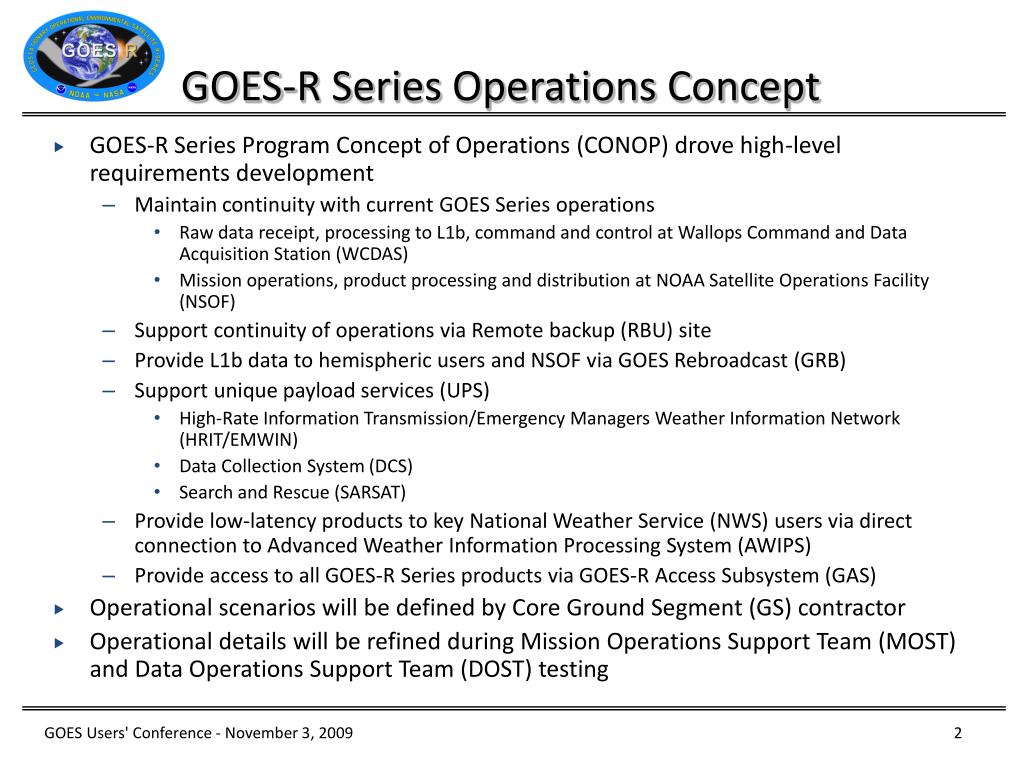

GOES-R Series Operations Concept • GOES-R Series Program Concept of Operations (CONOP) drove high-level requirements development • Maintain continuity with current GOES Series operations • Raw data receipt, processing to L1b, command and control at Wallops Command and Data Acquisition Station (WCDAS) • Mission operations, product processing and distribution at NOAA Satellite Operations Facility (NSOF) • Support continuity of operations via Remote backup (RBU) site • Provide L1b data to hemispheric users and NSOF via GOES Rebroadcast (GRB) • Support unique payload services (UPS) • High-Rate Information Transmission/Emergency Managers Weather Information Network (HRIT/EMWIN) • Data Collection System (DCS) • Search and Rescue (SARSAT) • Provide low-latency products to key National Weather Service (NWS) users via direct connection to Advanced Weather Information Processing System (AWIPS) • Provide access to all GOES-R Series products via GOES-R Access Subsystem (GAS) • Operational scenarios will be defined by Core Ground Segment (GS) contractor • Operational details will be refined during Mission Operations Support Team (MOST) and Data Operations Support Team (DOST) testing GOES Users' Conference - November 3, 2009
Notional Functional Overview TLM, Raw Data TLM, Raw Data CMD, GRB CMD, GRB GRB: Re-broadcast for users AWIPS: Direct feed to NWS GRB GRB GAS: Terrestrial distribution CLASS: Long-term archive RBU Core Ground Segment Functions NSOF Core Ground Segment Functions WCDAS Core Ground Segment Functions DCS: Bent-pipe service HRIT/EMWIN: Bent-pipe service GAS (OSD) GOES-N/P (OSD) Product Users AWIPS (NWS) CLASS (OSD) GOES Users' Conference - November 3, 2009

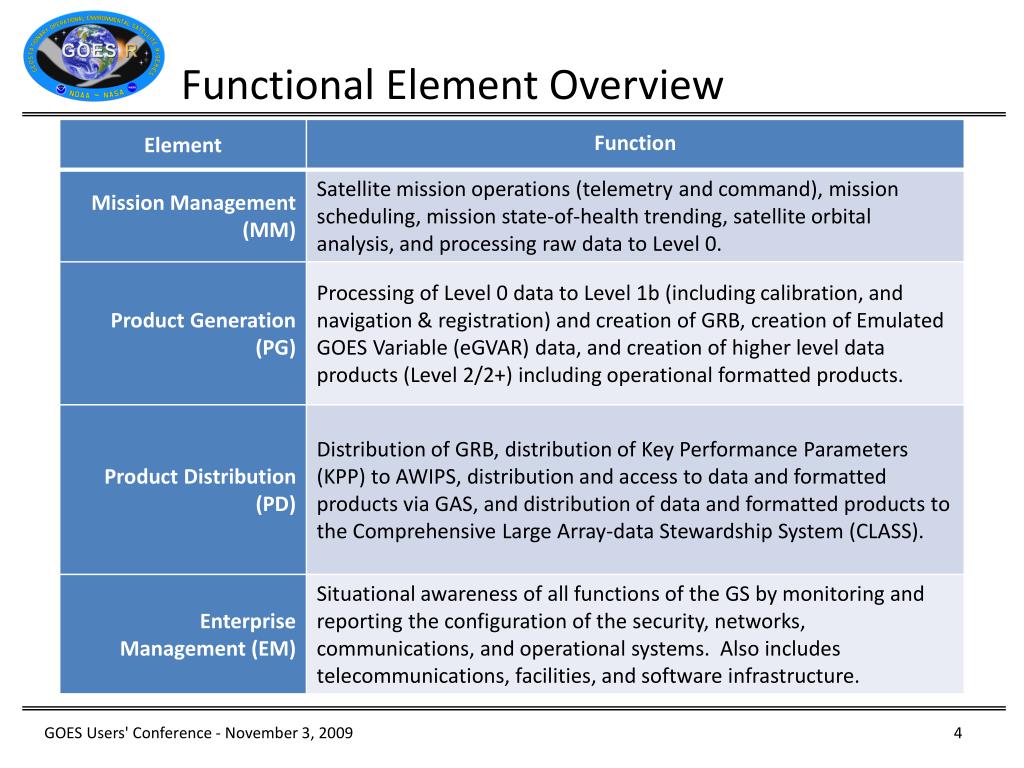

Functional Element Overview GOES Users' Conference - November 3, 2009
Government Roles and Responsibilities GOES Users' Conference - November 3, 2009
Contractor Roles and Responsibilities GOES Users' Conference - November 3, 2009

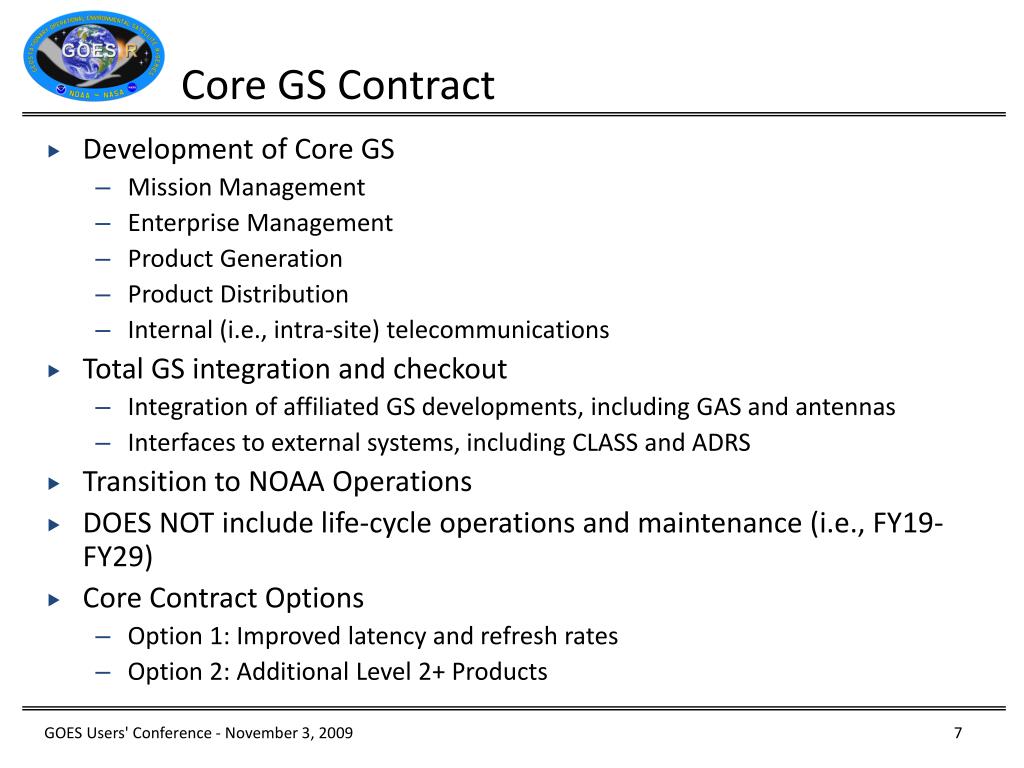

Core GS Contract • Development of Core GS • Mission Management • Enterprise Management • Product Generation • Product Distribution • Internal (i.e., intra-site) telecommunications • Total GS integration and checkout • Integration of affiliated GS developments, including GAS and antennas • Interfaces to external systems, including CLASS and ADRS • Transition to NOAA Operations • DOES NOT include life-cycle operations and maintenance (i.e., FY19-FY29) • Core Contract Options • Option 1: Improved latency and refresh rates • Option 2: Additional Level 2+ Products GOES Users' Conference - November 3, 2009
Core GS Contractor: Harris Corporation • Harris Corporation, Government Communications Systems Division (GCSD), Melbourne, FL was selected as the core (prime) GS contractor on May 27, 2009 • 10-year cost plus award fee contract • Subcontractors • Harris IT Services (HITS) • Boeing Mission Operations • Honeywell Technology Solutions Inc. • Atmospheric and Environmental Research Inc. • Carr Astronautics • Wyle Information Systems LLC • Applied Research and Engineering Sciences (ARES) GOES Users' Conference - November 3, 2009

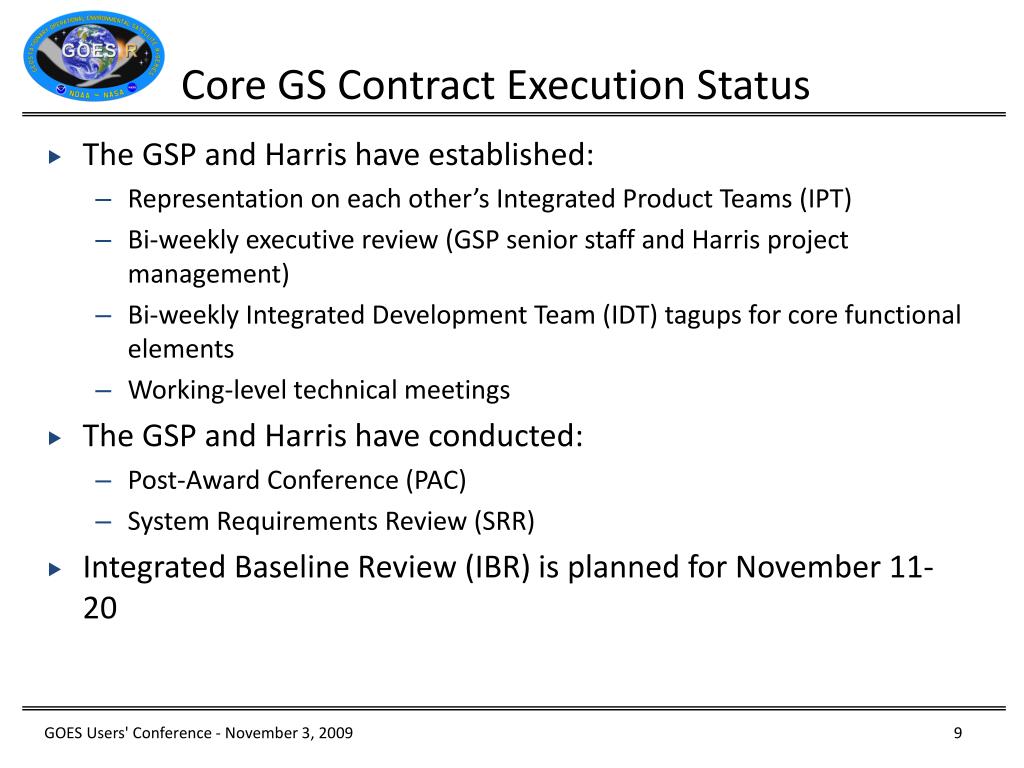

Core GS Contract Execution Status • The GSP and Harris have established: • Representation on each other’s Integrated Product Teams (IPT) • Bi-weekly executive review (GSP senior staff and Harris project management) • Bi-weekly Integrated Development Team (IDT) tagups for core functional elements • Working-level technical meetings • The GSP and Harris have conducted: • Post-Award Conference (PAC) • System Requirements Review (SRR) • Integrated Baseline Review (IBR) is planned for November 11-20 GOES Users' Conference - November 3, 2009

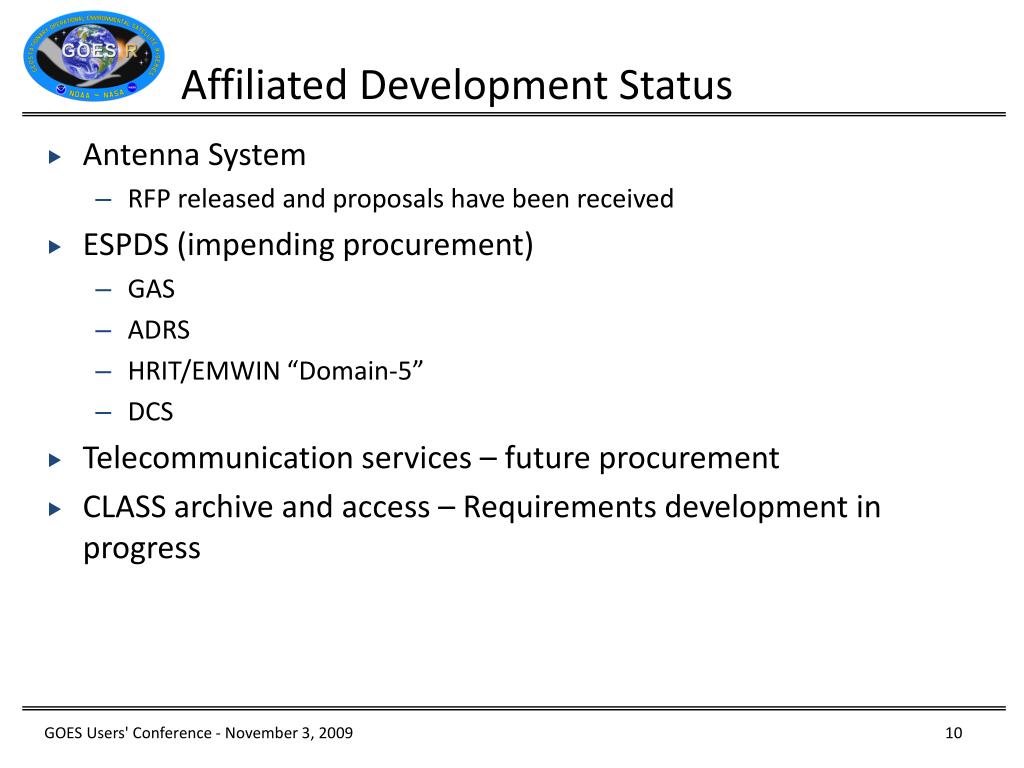

Affiliated Development Status • Antenna System • RFP released and proposals have been received • ESPDS (impending procurement) • GAS • ADRS • HRIT/EMWIN “Domain-5” • DCS • Telecommunication services – future procurement • CLASS archive and access – Requirements development in progress GOES Users' Conference - November 3, 2009

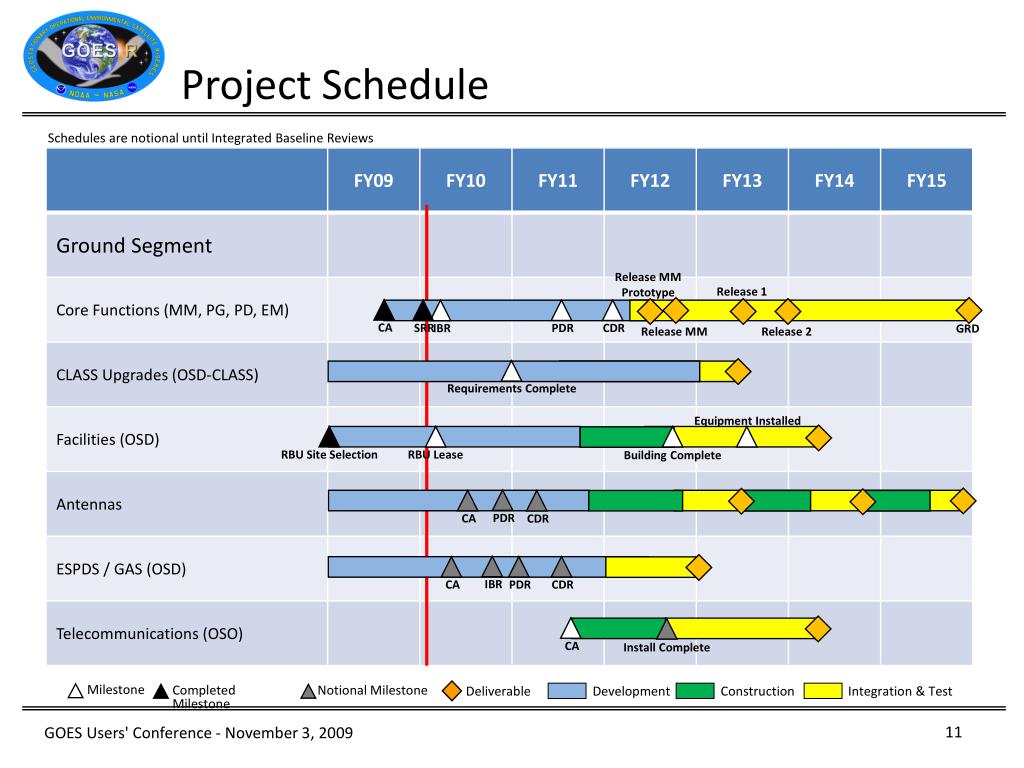

Project Schedule Schedules are notional until Integrated Baseline Reviews Release MM Prototype Release 1 Equipment Installed Requirements Complete RBU Site Selection RBU Lease PDR CDR IBR PDR IBR CA CDR CA CA PDR CDR SRR CA GRD Release MM Release 2 Install Complete Building Complete Deliverable Development Construction Integration & Test Milestone Completed Milestone Notional Milestone GOES Users' Conference - November 3, 2009
Project Major Milestones GOES Users' Conference - November 3, 2009
