GOBIERNO REGIONAL DE LIMA. PRESUPUESTO PARTICIPATIVO 2011. Rendición de Cuentas 2010. Huacho, 22 de junio del 2010. BALANCE DE LOS PROCESOS DEL PRESUPUESTO PARTICIPATIVO. ASPECTOS POSITIVOS.

tavi
Télécharger la présentation

GOBIERNO REGIONAL DE LIMA

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. GOBIERNO REGIONAL DE LIMA PRESUPUESTO PARTICIPATIVO 2011 Rendición de Cuentas 2010 Huacho, 22 de junio del 2010

  2. BALANCE DE LOS PROCESOS DEL PRESUPUESTO PARTICIPATIVO ASPECTOS POSITIVOS • Una mayor participación de la sociedad civil y de las autoridades locales en los Eventos de Capacitación y Talleres Regionales ha facilitado el acercamiento y dialogo entre las autoridades locales y sociedad civil de cada provincia para consensuar sus propuestas de acciones prioritarias en función de sus propias realidades. • Se va logrando progresivamente la sensibilización de las autoridades locales y de la población en la necesidad de utilizar la planificación local y regional como un instrumento para lograr el desarrollo sostenido e integrado de sus localidades. • La implementación del Programa Multianual de Inversiones como instrumento de programación, aunado a los consensos de la sociedad civil con las autoridades, permite garantizar la continuidad de los proyectos de inversiones priorizados en procesos participativos anteriores. • Un mayor entendimiento de la sociedad civil y de las autoridades locales sobre el tratamiento integral e integrado de los procesos participativos, ha permitido se vayan cumpliendo los roles que corresponde a cada instancia de Gobierno y/o aunar esfuerzos para lograr objetivos comunes

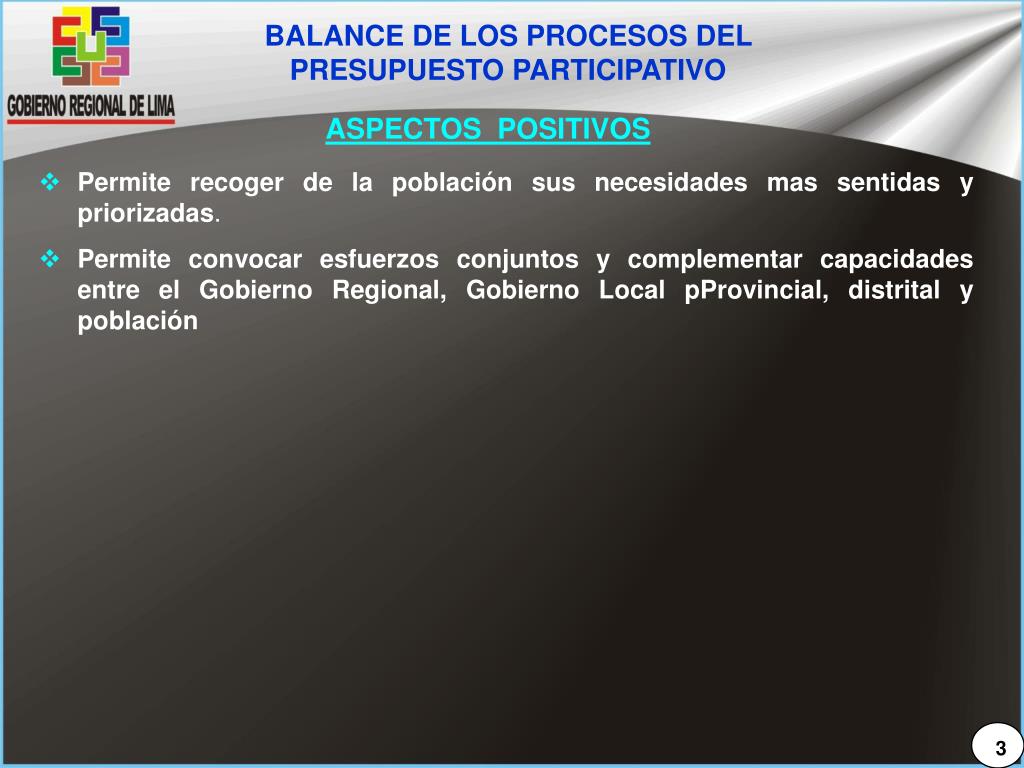

  3. BALANCE DE LOS PROCESOS DEL PRESUPUESTO PARTICIPATIVO ASPECTOS POSITIVOS • Permite recoger de la población sus necesidades mas sentidas y priorizadas. • Permite convocar esfuerzos conjuntos y complementar capacidades entre el Gobierno Regional, Gobierno Local pProvincial, distrital y población

  4. BALANCE DE LOS PROCESOS DEL PRESUPUESTO PARTICIPATIVO ASPECTOS NEGATIVOS • Aun se mantiene la precepción de que los procesos participativos son espacios de presentación de ideas proyectos de impacto y envergadura local con costos de inversión mal estimados. • La mayor cantidad de la demanda de proyectos se orientan a la dotación de infraestructura. • Escasa articulación de los cronogramas y procesos participativos de los niveles distritales y provinciales, con la regional que permita coordinar y aunar esfuerzos para el desarrollo de acciones comunes. • Escasa participación del Sector Empresarial (medianas y grandes empresas) no proponer estrategias de articulación y desarrollo regional entre el sector privado y el sector publico. • Limitado numero de organizaciones de la sociedad civil de nivel regional no permite generar propuestas de impacto regional que contribuyan al desarrollo regional. • Limitada participación de la universidad en los procesos participativos.

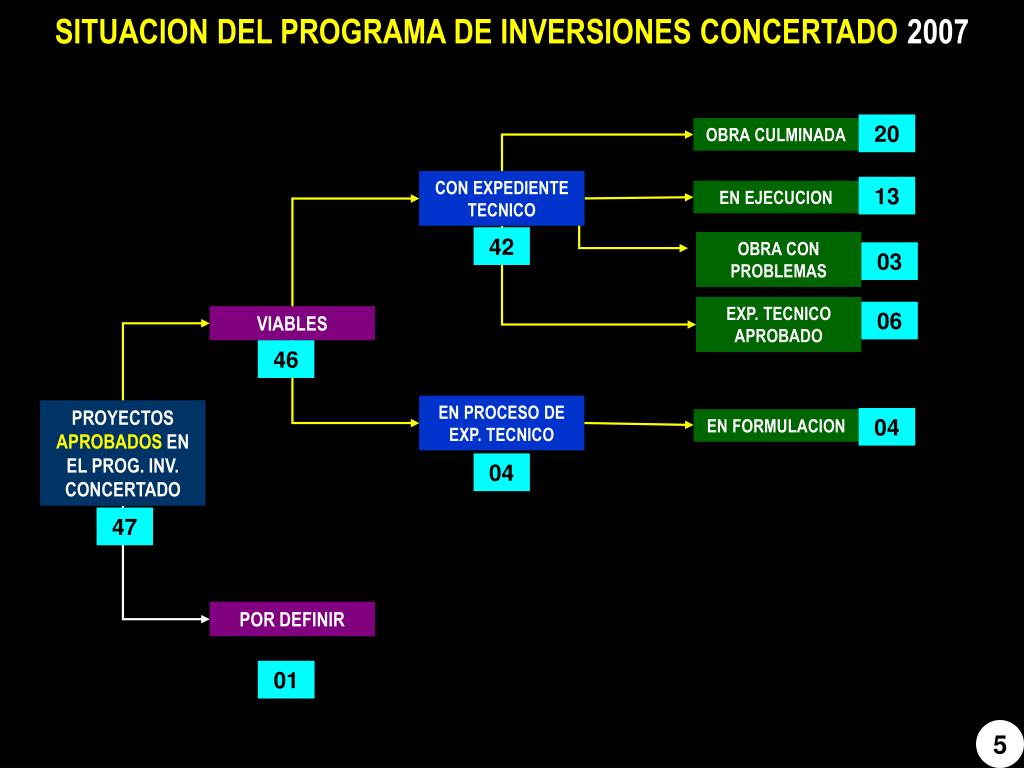

  5. SITUACION DEL PROGRAMA DE INVERSIONES CONCERTADO 2007 20 OBRA CULMINADA CON EXPEDIENTE TECNICO 13 EN EJECUCION 42 OBRA CON PROBLEMAS 03 EXP. TECNICO APROBADO 06 VIABLES 46 EN PROCESO DE EXP. TECNICO PROYECTOS APROBADOS EN EL PROG. INV. CONCERTADO 04 EN FORMULACION 04 47 POR DEFINIR 01 5

  6. SITUACION DEL PROGRAMA DE INVERSIONES CONCERTADO 2008 15 OBRA CULMINADA CON EXPEDIENTE TECNICO EN EJECUCION 30 59 VIABLES EXPEDIENTES APROBADOS 14 69 03 EN EVALUACION EXP. TECNICO EN PROCESO PROYECTOS APROBADOS EN EL PROG. INV. CONCERTADO 10 07 EN FORMULACION 77 EN FORMULACION 06 EN PROCESO DE VIABILIDAD 8 RECHAZADO 02 6

  7. SITUACION DEL PROGRAMA DE INVERSIONES CONCERTADO 2009 18 OBRA CULMINADA 32 EN EJECUCION CON EXPEDIENTE TECNICO OBRA CON PROBLEMAS 01 87 EXPEDIENTE APROBADO VIABLES 36 143 15 EN EVALUACION EXP. TECNICO EN PROCESO PROYECTOS APROBADOS EN EL PROG. INV. CONCERTADO 56 41 EN FORMULACION 193 EN EVALUACION 13 EN PROCESO DE VIABILIDAD 34 EN FORMULACION 50 RECHAZADO 03 7

  8. SITUACION DEL PROGRAMA DE INVERSIONES CONCERTADO 2010 04 OBRA CULMINADA 15 EN EJECUCION CON EXPEDIENTE TECNICO OBRA CON PROBLEMAS 01 42 EXPEDIENTE APROBADO VIABLES 22 72 07 EN EVALUACION EXP. TECNICO EN PROCESO PROYECTOS APROBADOS EN EL PROG. INV. CONCERTADO 30 23 EN FORMULACION 83 EN EVALUACION 03 EN PROCESO DE VIABILIDAD 07 EN FORMULACION 11 RECHAZADO 01 8

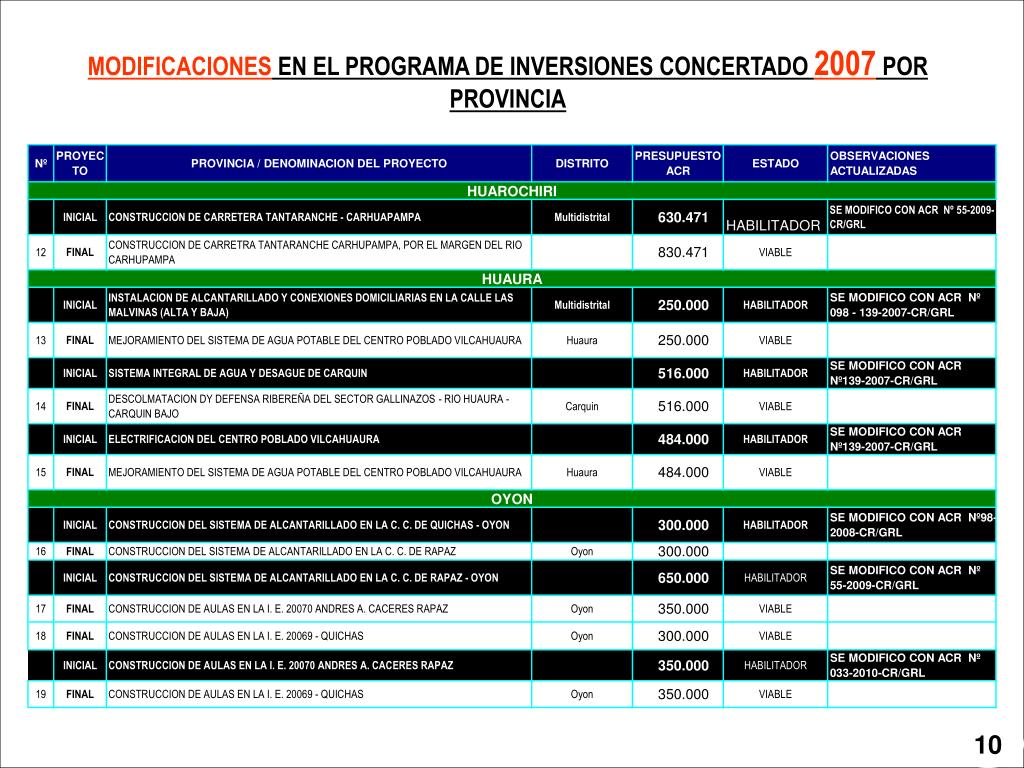

  9. MODIFICACIONESEN EL PROGRAMA DE INVERSIONES CONCERTADO2007POR PROVINCIA 9

  10. MODIFICACIONES EN EL PROGRAMA DE INVERSIONES CONCERTADO 2007 POR PROVINCIA 10

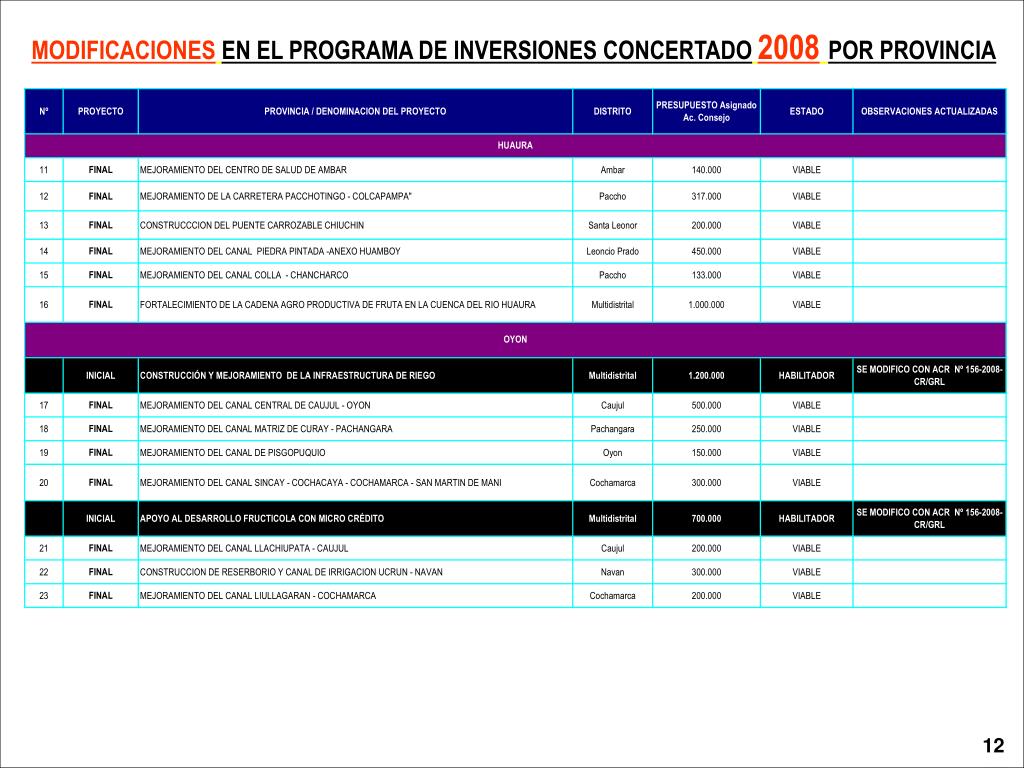

  11. MODIFICACIONESEN EL PROGRAMA DE INVERSIONES CONCERTADO2008POR PROVINCIA 11

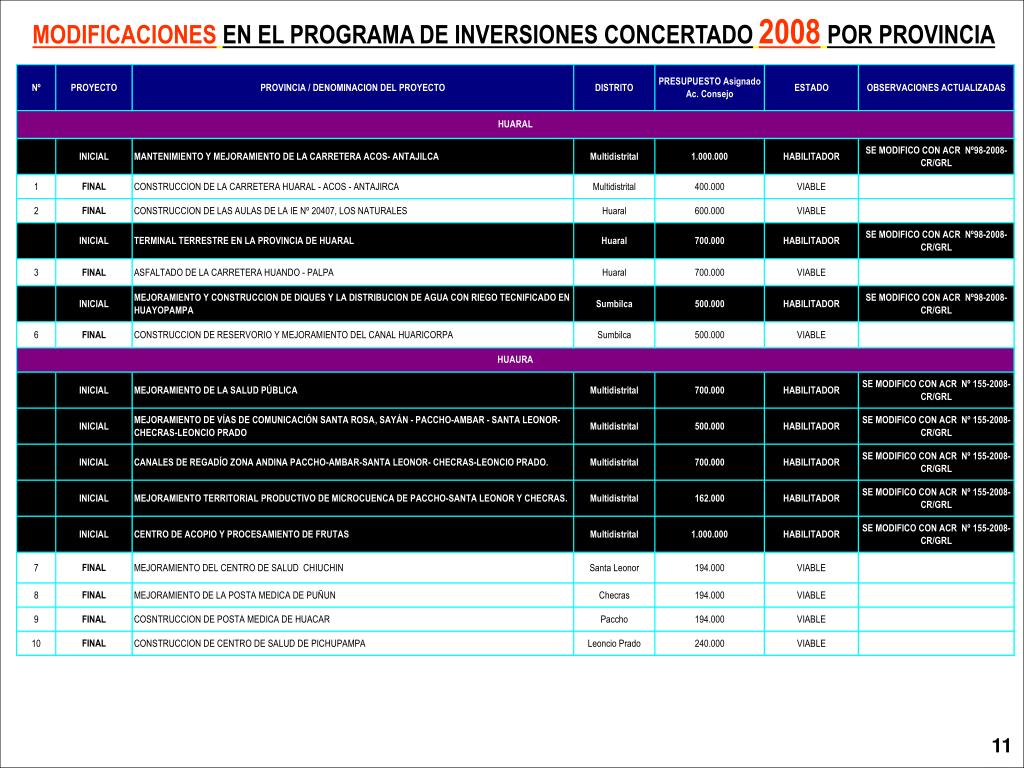

  12. MODIFICACIONESEN EL PROGRAMA DE INVERSIONES CONCERTADO2008POR PROVINCIA 12

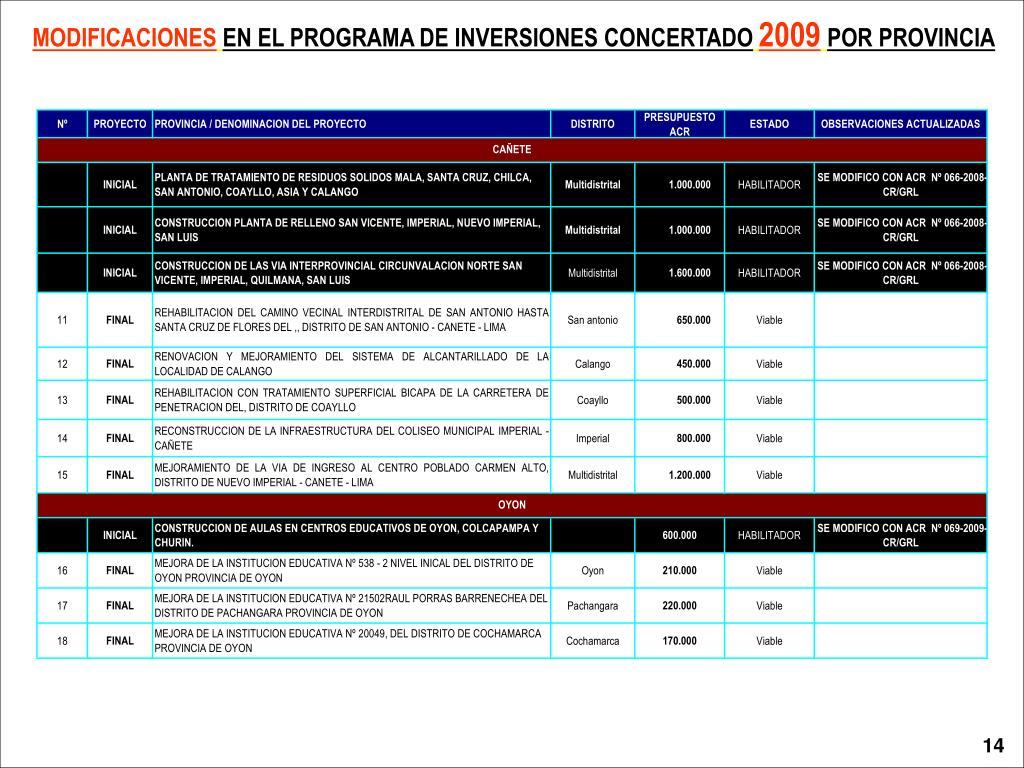

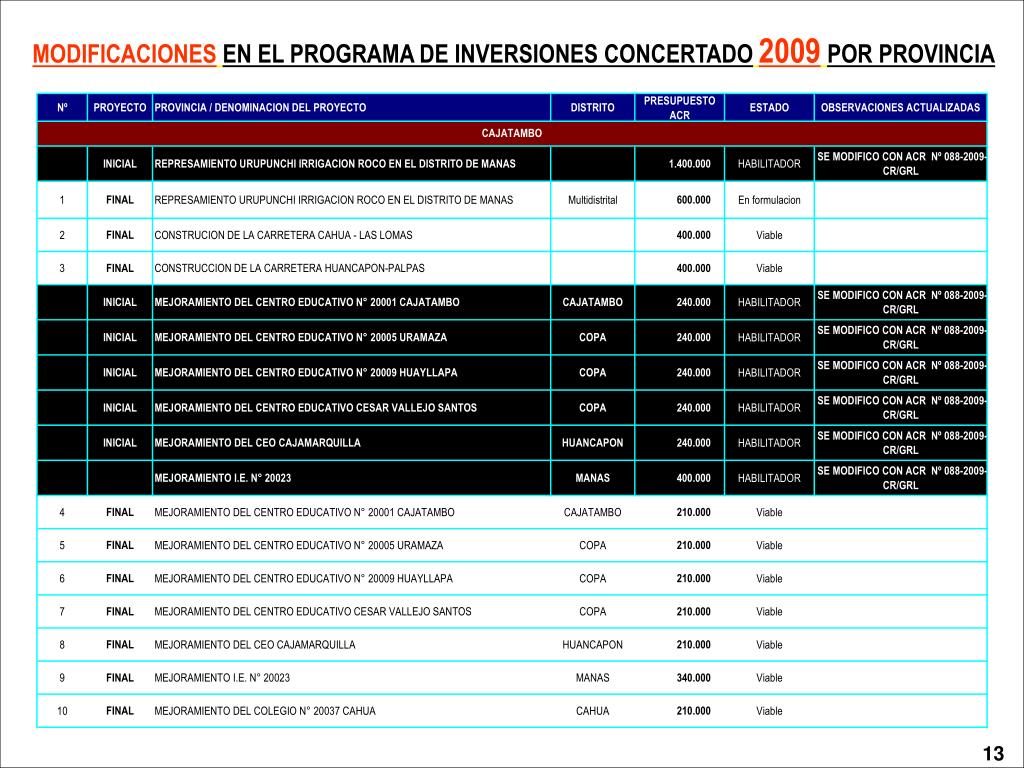

  13. MODIFICACIONESEN EL PROGRAMA DE INVERSIONES CONCERTADO2009POR PROVINCIA 13

  14. MODIFICACIONESEN EL PROGRAMA DE INVERSIONES CONCERTADO2009POR PROVINCIA 14

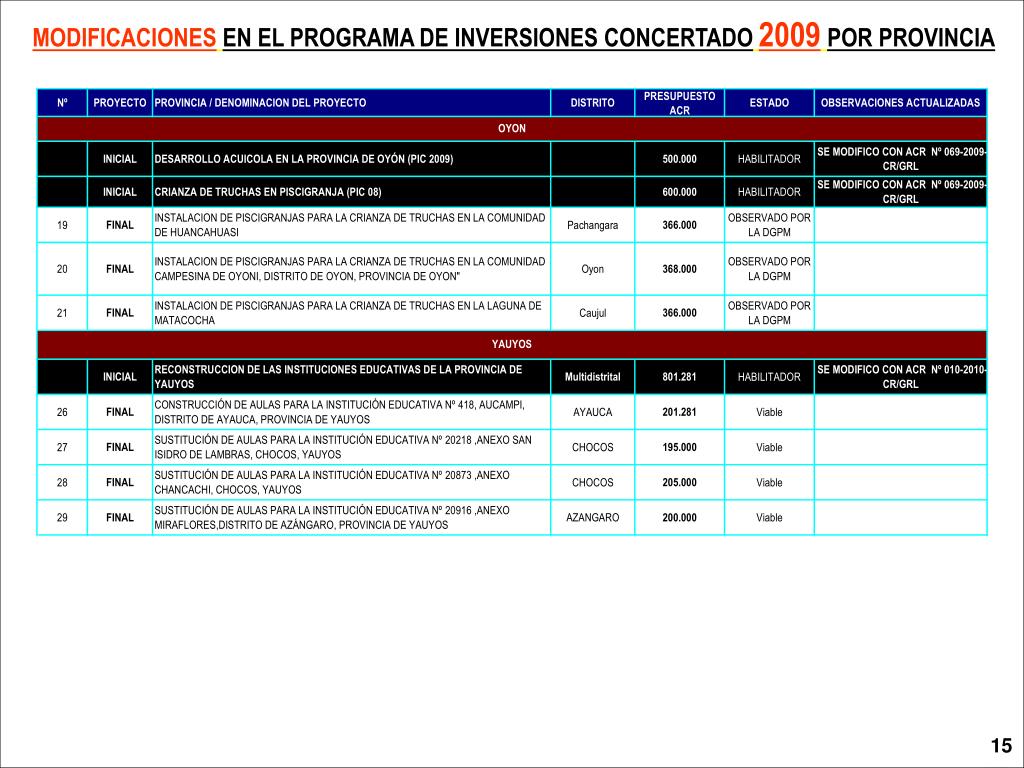

  15. MODIFICACIONESEN EL PROGRAMA DE INVERSIONES CONCERTADO2009POR PROVINCIA 15

  16. IDEA I ETAPA: PRE INVERSION II ETAPA: INVERSION PROYECTO APROBADO EN EL MARCO DEL PROCESO DEL PRESUPUESTO PARTICIPATIVO PERFIL EXP. TECNICO CONVOCATORIA CONVOCATORIA 20 20 ELABORACION ELABORACION VISITA DE CAMPO 45 60 15 EVALUACION APROBACION 10 20 ELABORACION DE TDR PRE FACTIBILIDAD EJECUCION + 20 DIAS SI EL PROYECTO PASA EL 10 % DEL COSTO ESTABLECIDO EN EL PERFIL 10 CONVOCATORIA CONVOCATORIA > 6 < 10 Mll S/. 20 20 ELABORACION OBRA 45 ? APROBACION 20 FACTIBILIDAD CONVOCATORIA 20 > 10 Mll S/. ELABORACION 45 APROBACION 20 1 Mes +? 1 Mes 4 Meses 4 Meses 4 Meses 5 Meses 16

  17. CONVENIOS CON GOBIERNOS LOCALES 2007

  18. CONVENIOS CON GOBIERNOS LOCALES 2008

  19. CONVENIOS CON GOBIERNOS LOCALES 2009

  20. PRESUPUESTO DE INVERSIONES Vs PRESUPUESTO PARA ESTUDIOS DE PRE INVERSION Nº PYs MLL S/. 250 250 200 200 150 150 100 100 50 50 2.7 2.3 0.5 0.4 0 0 AÑO 2010 2009 2007 2008

  21. PRESUPUESTO DE INVERSIONES Vs PRESUPUESTO PARA ESTUDIOS DE PRE INVERSION MILES S/. 75 62.4 58.4 60.0 52.4 60 45 30 29.2 15 15.0 8.7 8.8 0 AÑO 2010 2009 2007 2008

  22. ASPECTOS GENERALES DE LA EJECUCIÓN PRESUPUESTAL REGIONAL 2010

  23. EJECUCIÓN PRESUPUESTAL POR GENÉRICA DE GASTOS PERÍODO 2007 - 2010 TODA FUENTE DE FINANCIAMIENTO MILLONES DE SOLES

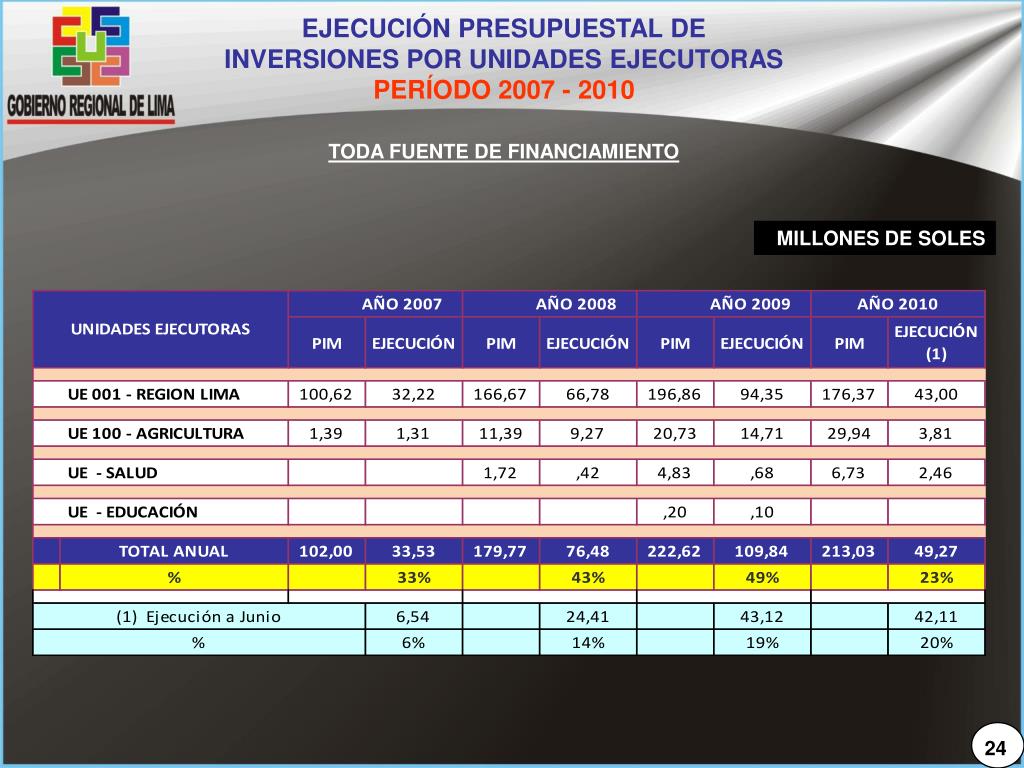

  24. EJECUCIÓN PRESUPUESTAL DE INVERSIONES POR UNIDADES EJECUTORAS PERÍODO 2007 - 2010 TODA FUENTE DE FINANCIAMIENTO MILLONES DE SOLES

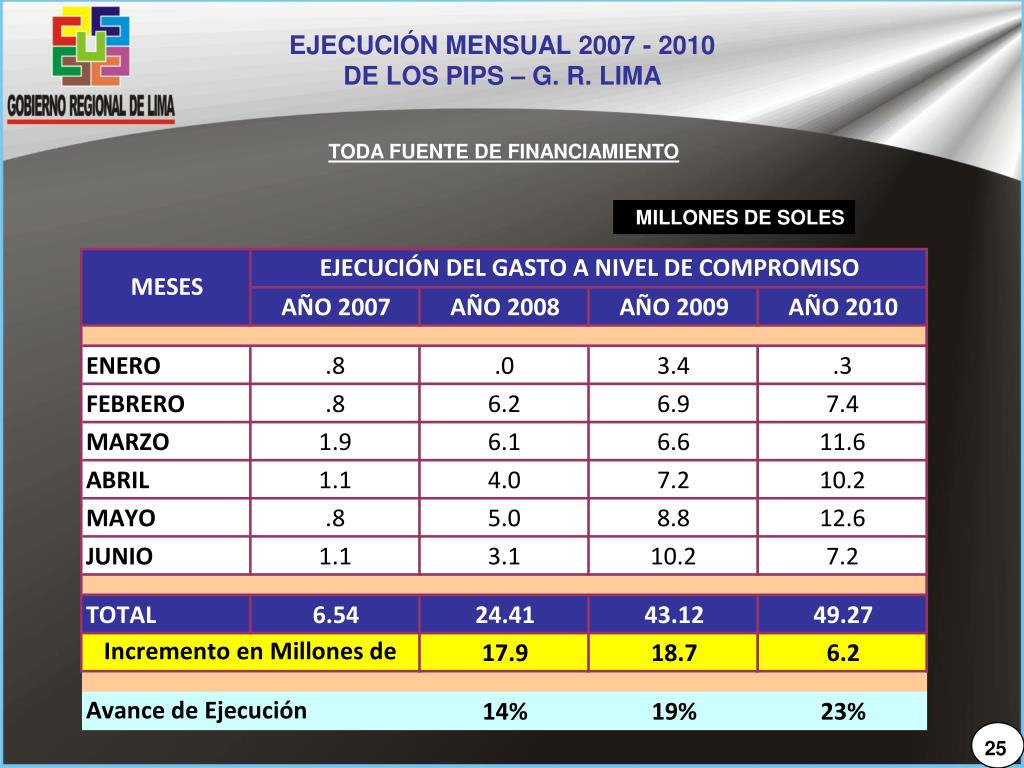

  25. EJECUCIÓN MENSUAL 2007 - 2010 DE LOS PIPS – G. R. LIMA TODA FUENTE DE FINANCIAMIENTO MILLONES DE SOLES

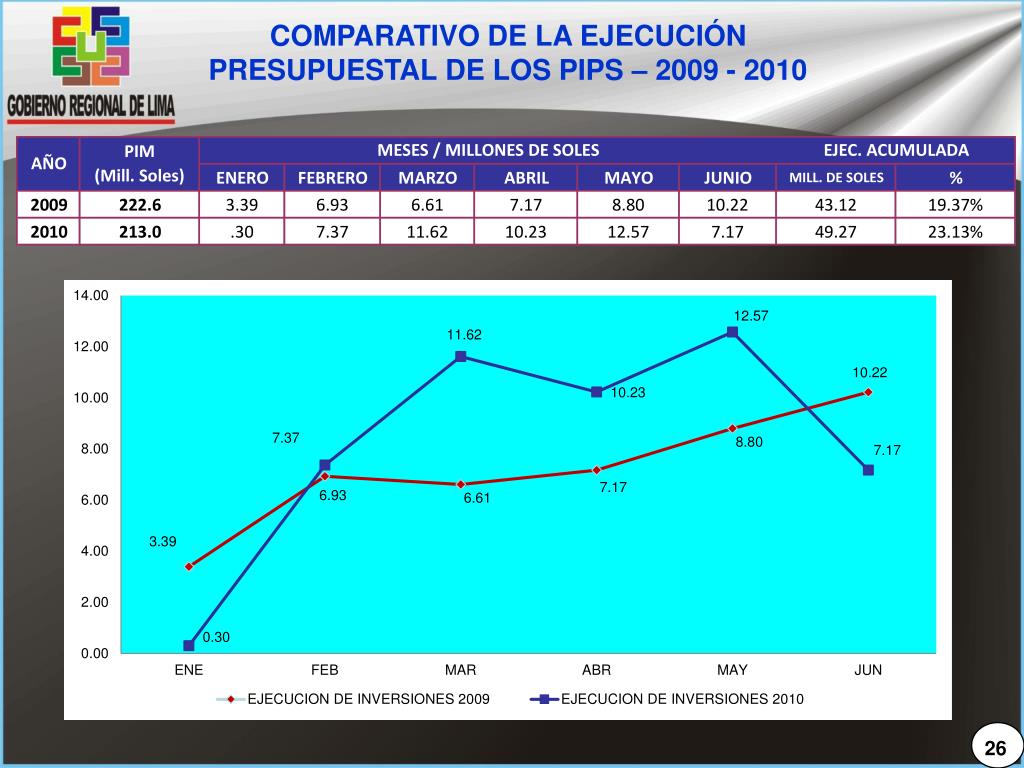

  26. COMPARATIVO DE LA EJECUCIÓN PRESUPUESTAL DE LOS PIPS – 2009 - 2010

  27. PROYECCIÓN 2010 DE LA EJECUCIÓN PRESUPUESTAL DE LOS PIPS

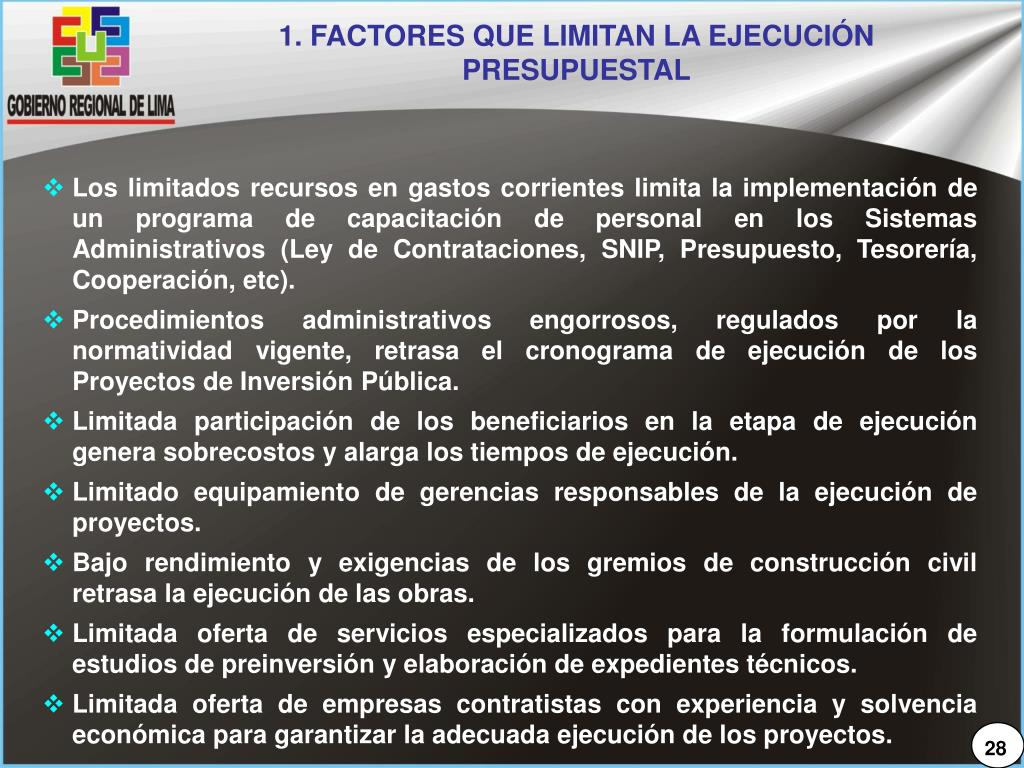

  28. 1. FACTORES QUE LIMITAN LA EJECUCIÓN PRESUPUESTAL • Los limitados recursos en gastos corrientes limita la implementación de un programa de capacitación de personal en los Sistemas Administrativos (Ley de Contrataciones, SNIP, Presupuesto, Tesorería, Cooperación, etc). • Procedimientos administrativos engorrosos, regulados por la normatividad vigente, retrasa el cronograma de ejecución de los Proyectos de Inversión Pública. • Limitada participación de los beneficiarios en la etapa de ejecución genera sobrecostos y alarga los tiempos de ejecución. • Limitado equipamiento de gerencias responsables de la ejecución de proyectos. • Bajo rendimiento y exigencias de los gremios de construcción civil retrasa la ejecución de las obras. • Limitada oferta de servicios especializados para la formulación de estudios de preinversión y elaboración de expedientes técnicos. • Limitada oferta de empresas contratistas con experiencia y solvencia económica para garantizar la adecuada ejecución de los proyectos.

  29. DECISIONES TOMADAS PARA FACILITAR LA EJECUCIÓN PRESUPUESTAL • Se viene implementando mecanismos de capacitación en temas en las diferentes áreas usuarias (Ley de Contrataciones, SNIP, Presupuesto y Cooperación Técnica). • Se ha elaborado procedimientos para: • La aprobación de la elaboración de Expedientes Técnicos e inicio de obras • Acelerar la modificación en el Plan Anual de Contrataciones • Se ha establecido Formatos Standares para la aprobación de Expedientes Técnicos • Se ha delegado facultades para acelerar la aprobación que se requiere en los Procesos de Contratación, principalmente en Procesos de Menor Cuantía y Adjudicaciones Directas. • Se ha delegado la facultad de aprobar Expedientes Técnicos • Se ha implementado el SISGEDO (Sistema de Gestión Documentario en la Unidad Ejecutora Central y se tiene previsto culminar su implementación en las 21 Unidades Ejecutoras en el presente año.

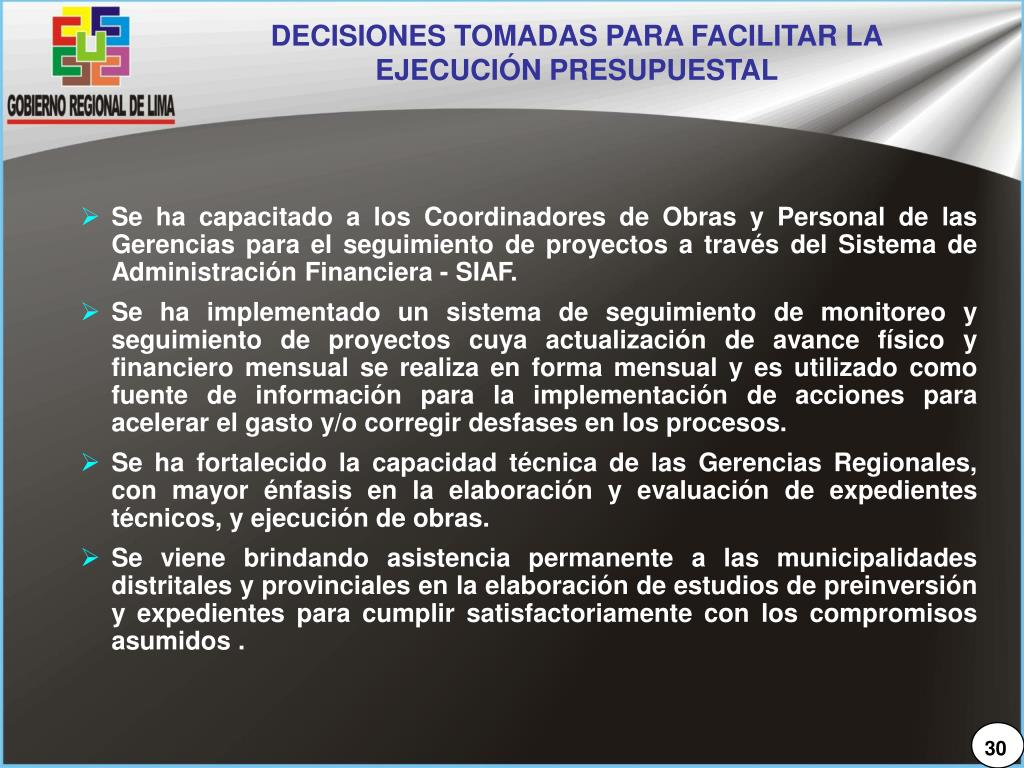

  30. DECISIONES TOMADAS PARA FACILITAR LA EJECUCIÓN PRESUPUESTAL • Se ha capacitado a los Coordinadores de Obras y Personal de las Gerencias para el seguimiento de proyectos a través del Sistema de Administración Financiera - SIAF. • Se ha implementado un sistema de seguimiento de monitoreo y seguimiento de proyectos cuya actualización de avance físico y financiero mensual se realiza en forma mensual y es utilizado como fuente de información para la implementación de acciones para acelerar el gasto y/o corregir desfases en los procesos. • Se ha fortalecido la capacidad técnica de las Gerencias Regionales, con mayor énfasis en la elaboración y evaluación de expedientes técnicos, y ejecución de obras. • Se viene brindando asistencia permanente a las municipalidades distritales y provinciales en la elaboración de estudios de preinversión y expedientes para cumplir satisfactoriamente con los compromisos asumidos .

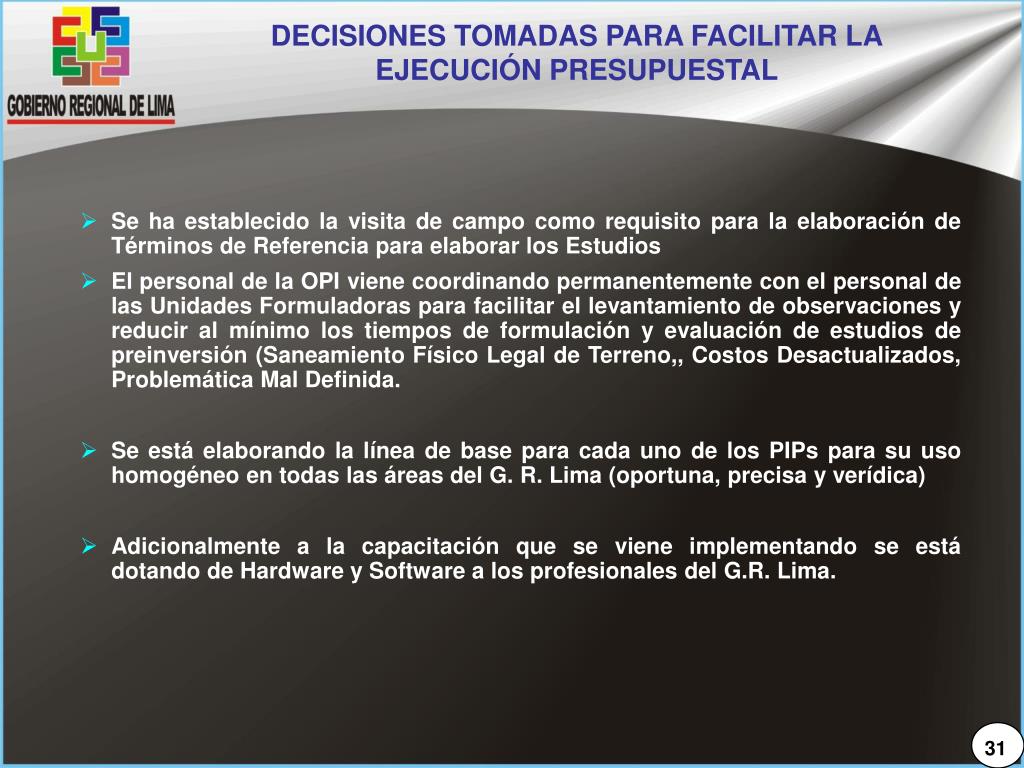

  31. DECISIONES TOMADAS PARA FACILITAR LA EJECUCIÓN PRESUPUESTAL • Se ha establecido la visita de campo como requisito para la elaboración de Términos de Referencia para elaborar los Estudios • El personal de la OPI viene coordinando permanentemente con el personal de las Unidades Formuladoras para facilitar el levantamiento de observaciones y reducir al mínimo los tiempos de formulación y evaluación de estudios de preinversión (Saneamiento Físico Legal de Terreno,, Costos Desactualizados, Problemática Mal Definida. • Se está elaborando la línea de base para cada uno de los PIPs para su uso homogéneo en todas las áreas del G. R. Lima (oportuna, precisa y verídica) • Adicionalmente a la capacitación que se viene implementando se está dotando de Hardware y Software a los profesionales del G.R. Lima.

  32. GOBIERNO REGIONAL DE LIMA GRACIAS ...trabajando en equipo !!!
