1 / 12

Preparations for a Lehman Review

Preparations for a Lehman Review. Elton Smith Hall D Collaboration Meeting Dec 11-13, 2003. Project acquisition process and CDs. DOE Order 413.3 (Initiated by the Office of the Chief Financial Officer). Project phases and federal budget.

tilly
Télécharger la présentation

Preparations for a Lehman Review

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Preparations for a Lehman Review Elton Smith Hall D Collaboration Meeting Dec 11-13, 2003

  2. Project acquisition process and CDs DOE Order 413.3 (Initiated by the Office of the Chief Financial Officer)

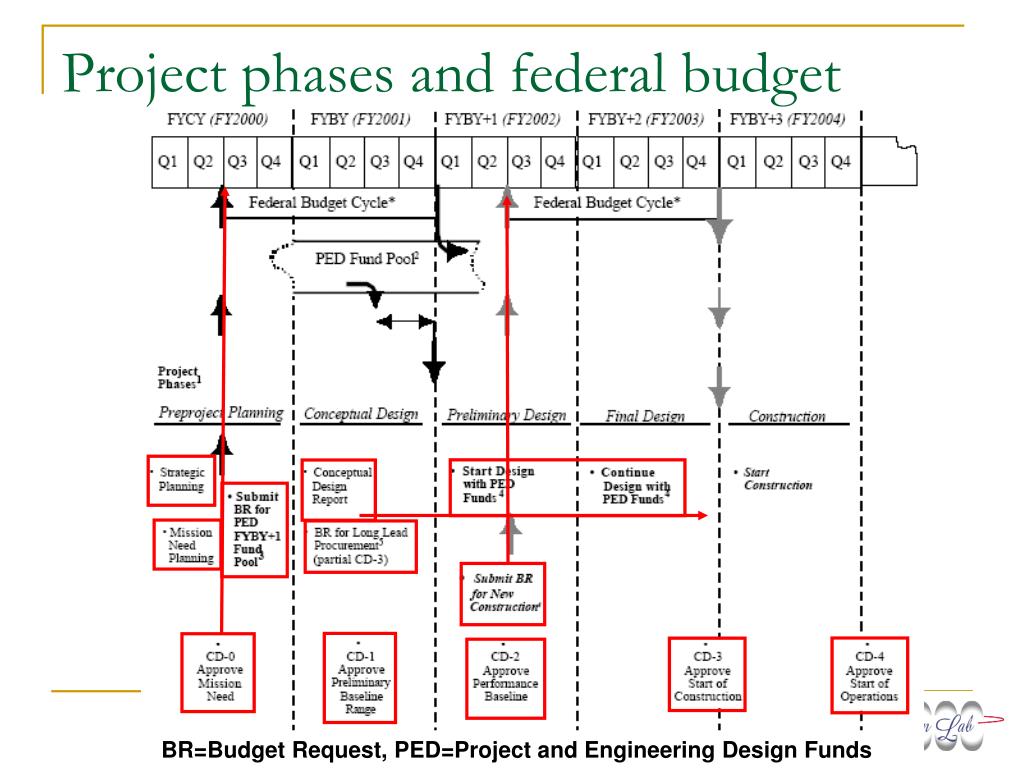

  3. Project phases and federal budget BR=Budget Request, PED=Project and Engineering Design Funds

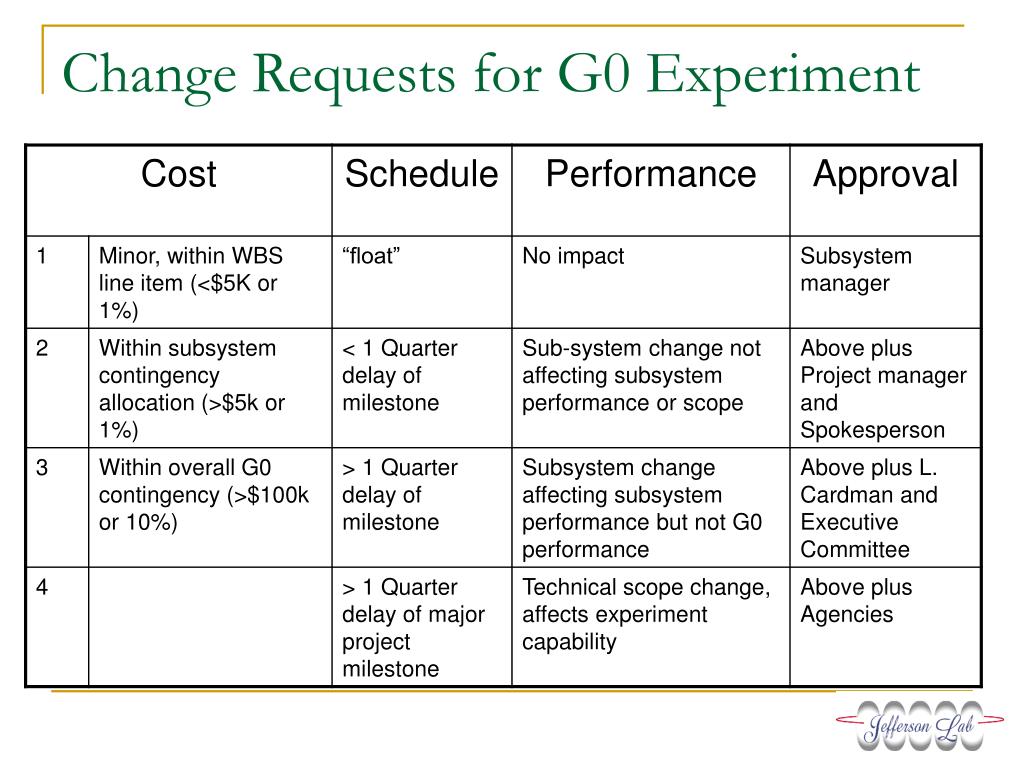

  4. Change Requests for G0 Experiment

  5. “Lehman” review gives CD-1 approval • Review of entire 12-GeV project • Cost • Schedule • Technical scope • Prerequisites • Acquisition plan • CDR • Preliminary project execution plan and baseline range • Project data sheet for design • Verification of mission need • Preliminary hazard analysis report

  6. Practically, CD-1 is an approval of • CDR • pCDR • + section on accelerator • + cost and schedule book • Best preparation are the subsystem reviews that we are undertaking • Cost and schedule will have to be covered (perhaps at a later stage)

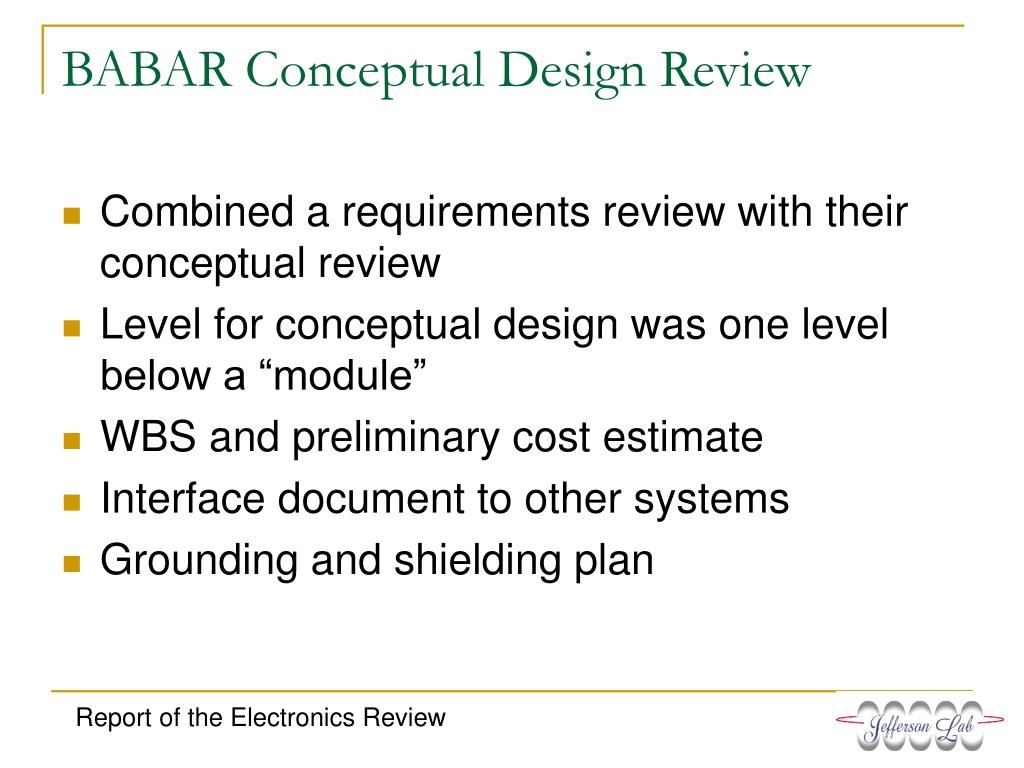

  7. BABAR Conceptual Design Review • Combined a requirements review with their conceptual review • Level for conceptual design was one level below a “module” • WBS and preliminary cost estimate • Interface document to other systems • Grounding and shielding plan Report of the Electronics Review

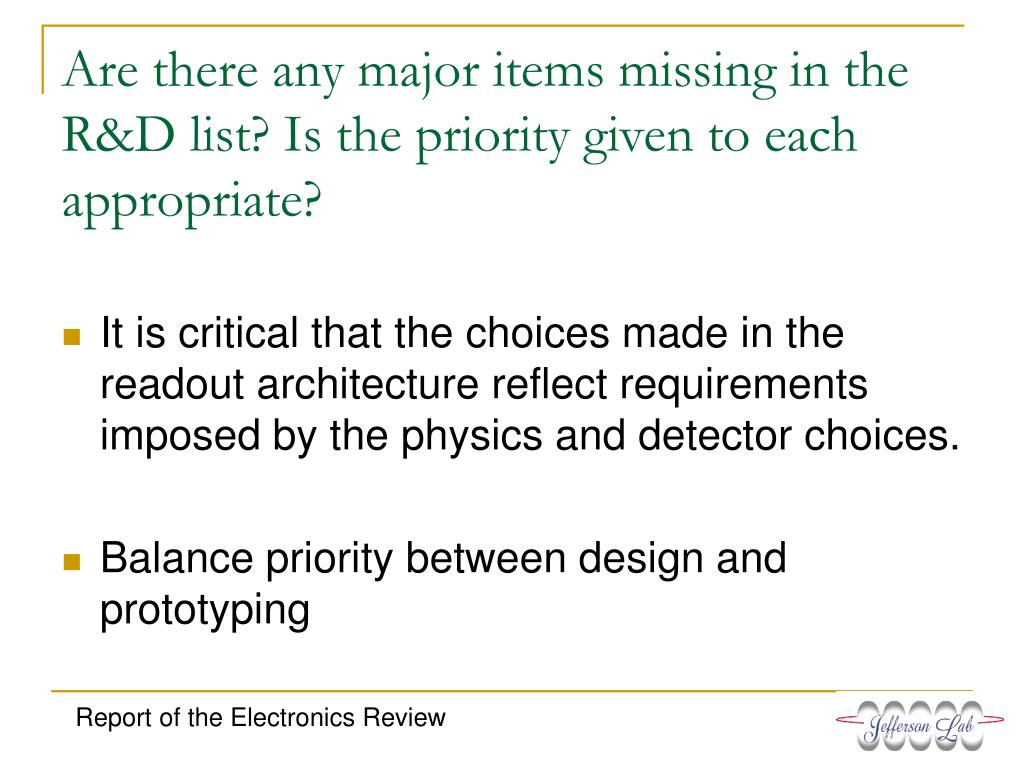

  8. Are there any major items missing in the R&D list? Is the priority given to each appropriate? • It is critical that the choices made in the readout architecture reflect requirements imposed by the physics and detector choices. • Balance priority between design and prototyping Report of the Electronics Review

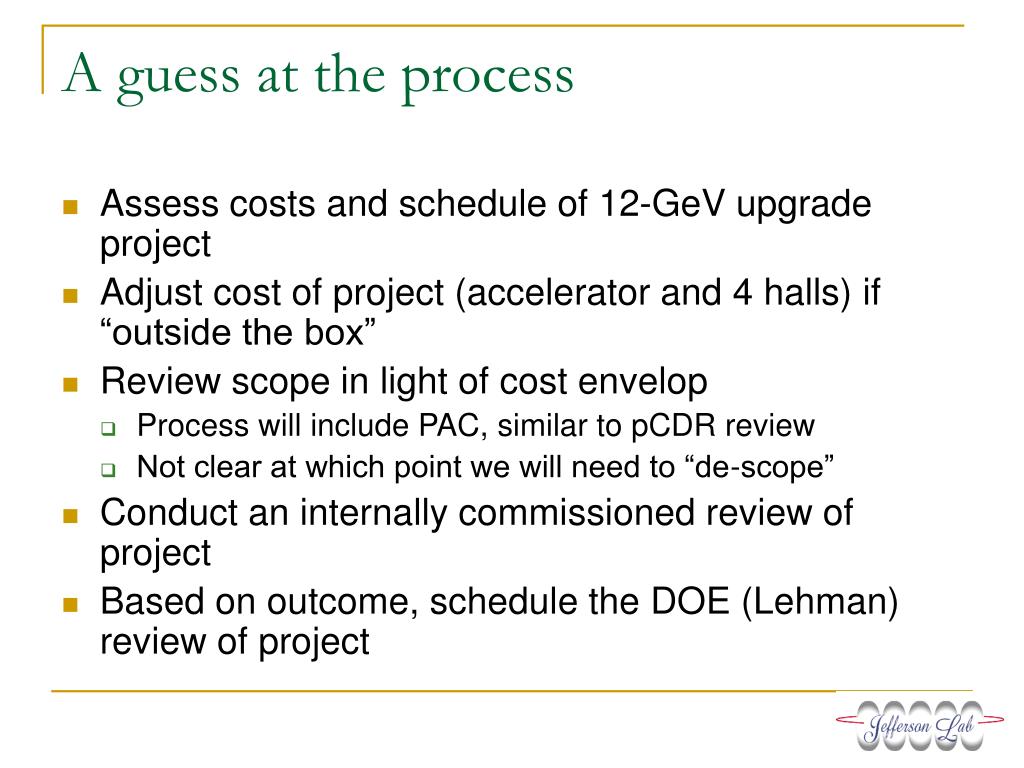

  9. A guess at the process • Assess costs and schedule of 12-GeV upgrade project • Adjust cost of project (accelerator and 4 halls) if “outside the box” • Review scope in light of cost envelop • Process will include PAC, similar to pCDR review • Not clear at which point we will need to “de-scope” • Conduct an internally commissioned review of project • Based on outcome, schedule the DOE (Lehman) review of project

  10. Fiscal years CD-1 CD-2 CD-3 CD-4 CD-0 02 03 04 05 06 07 08 09 10 01 Constant-effort budget in FY02* & O413.3 Constant-effort budget continues thru FY03* Orig. schedule *Assumes increases beyond constant-effort in subsequent years. Impact of budget profile on schedule

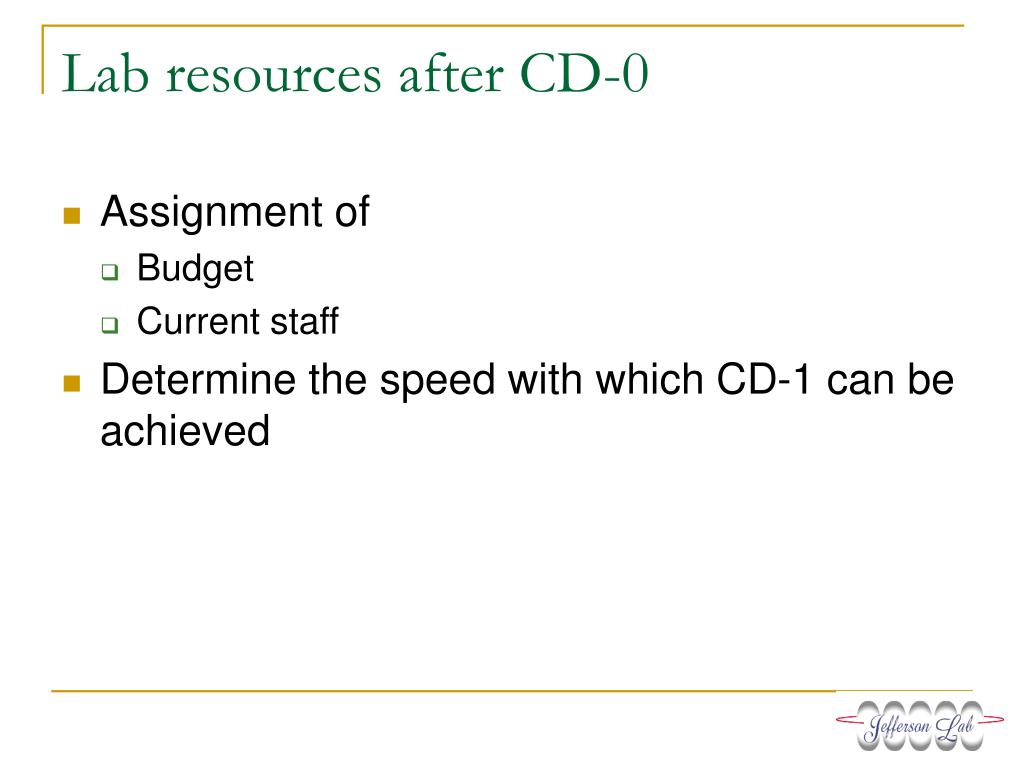

  11. Lab resources after CD-0 • Assignment of • Budget • Current staff • Determine the speed with which CD-1 can be achieved

  12. Manpower (JLab)

More Related
