Public Information Meeting Intersection Safety Improvements Silver Star Road (SR 438) at Ocoee Hills RoadFrom 2ndSt. to Silver Crest Blvd.Financial Project ID 430569-1-52-01February 29, 2012 Presented By: Bruno Fiori, AECOM
Civil Rights Statement This meeting is being held to afford all citizens the right to understand the project and comment on concerns to the Florida Department of Transportation (FDOT). The meeting is being held to comply with Titles VI and VIII of the Civil Rights Act and American with Disabilities Act (ADA). Public participation is solicited without regard to race, color, national origin, age, sex, religion, disability or family status. Persons wishing to express their concerns relative to FDOT compliance with Title VI and/or Title VIII may do so by contacting the FDOT, District Five, Title VI and VIII Coordinator at 719 South Woodland Boulevard, Deland, Florida 32720 or the Florida Equal Opportunity Office, 605 Suwannee Street, Room 260, Mail Station 65, Tallahassee, FL 32399-0450. All inquiries or complaints will be handled according to FDOT procedure and in an expeditious manner.

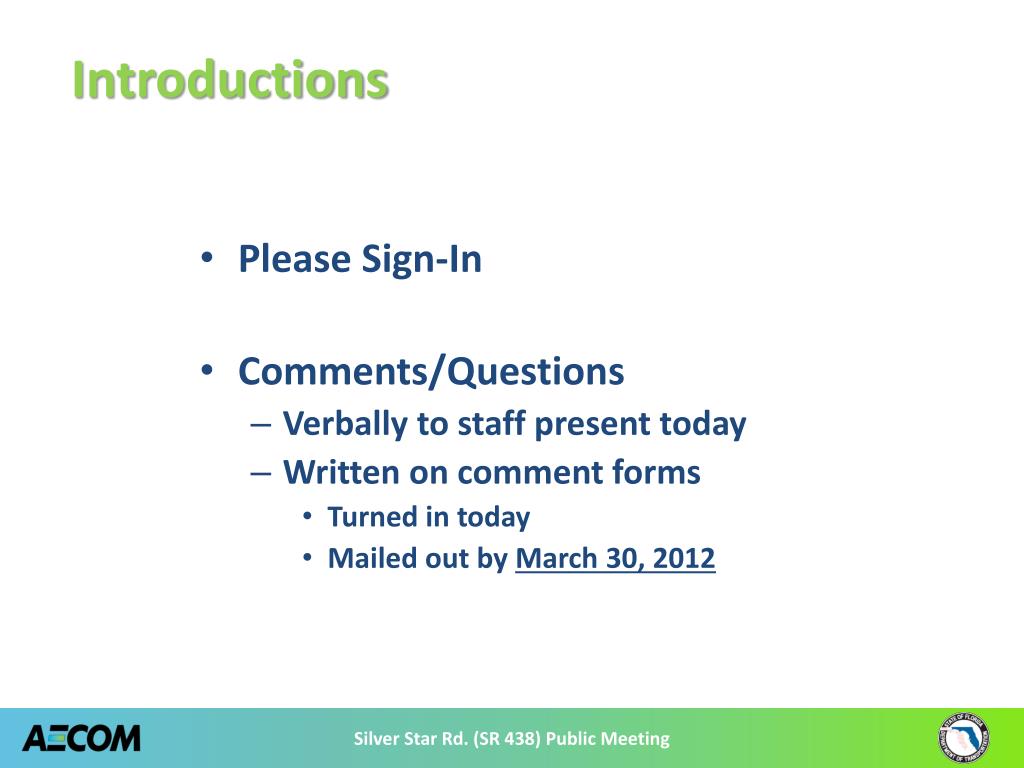

Introductions • Please Sign-In • Comments/Questions • Verbally to staff present today • Written on comment forms • Turned in today • Mailed out by March 30, 2012
Project Location Map End Project Begin Project
Project Objectives • Improve vehicular, pedestrian, and bicyclist safety: • Provide dedicated westbound right turn lane along SR 438

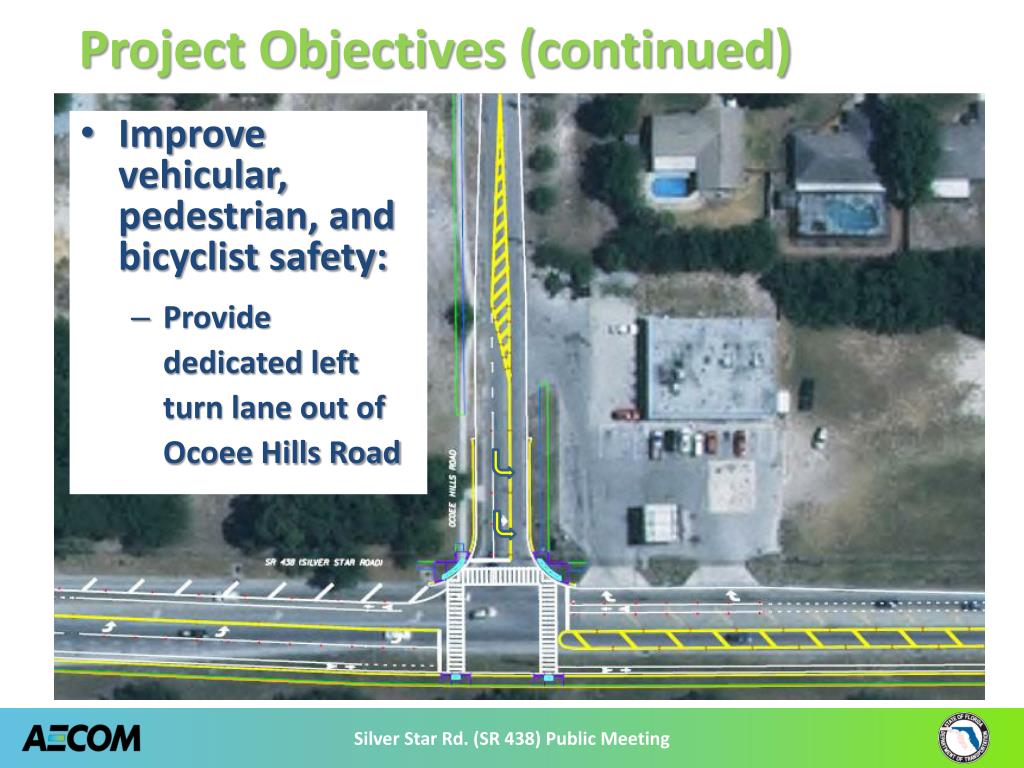

Project Objectives (continued) • Improve vehicular, pedestrian, and bicyclist safety: • Provide dedicated left turn lane out of Ocoee Hills Road
Project Objectives (continued) • Improve vehicular, pedestrian, and bicyclist safety: • Add signals at intersection • Provide sidewalk and sidewalk connectivity

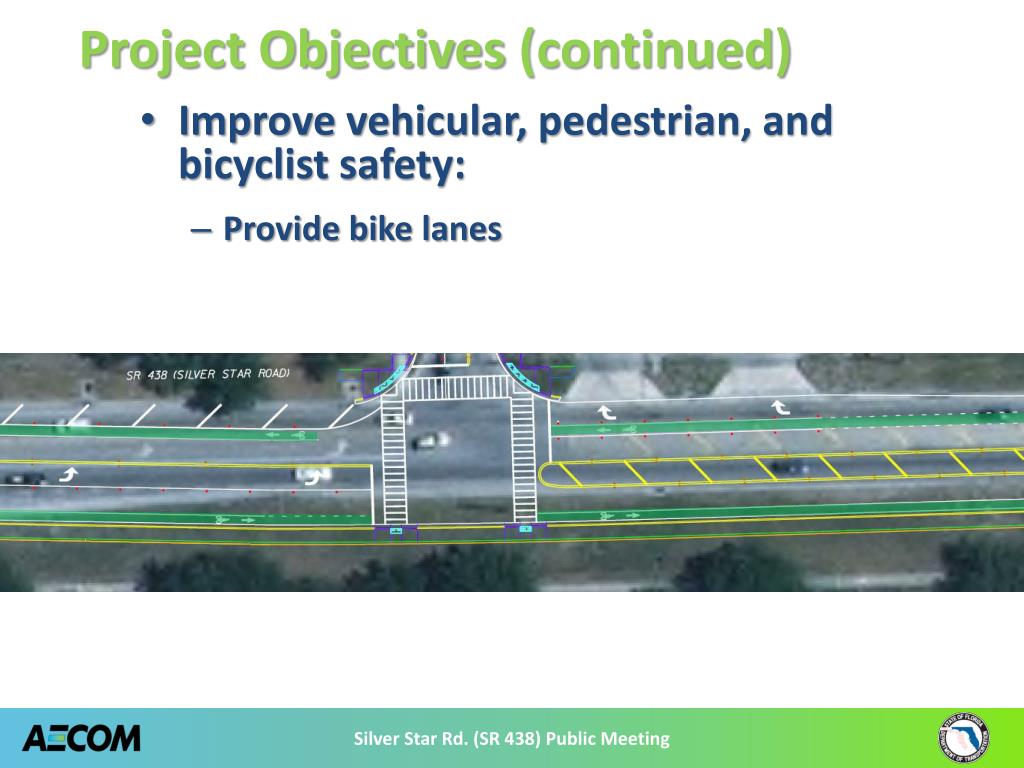

Project Objectives (continued) • Improve vehicular, pedestrian, and bicyclist safety: • Provide bike lanes

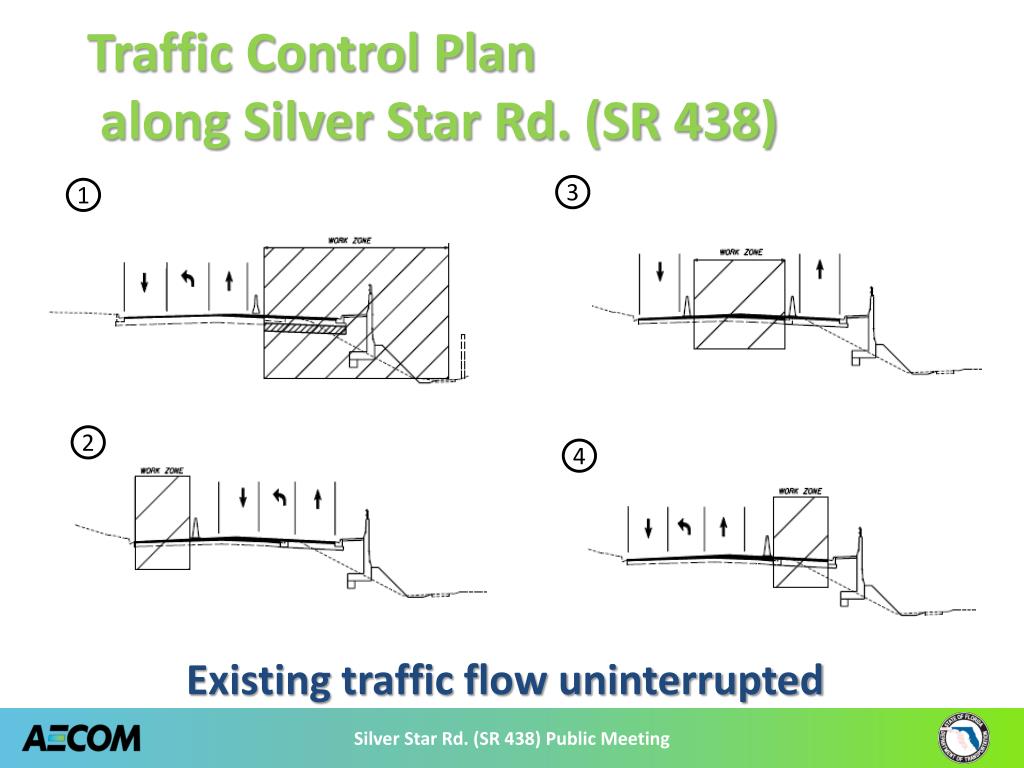

Traffic Control Plan along Silver Star Rd. (SR 438) 3 1 Existing traffic flow uninterrupted 2 4

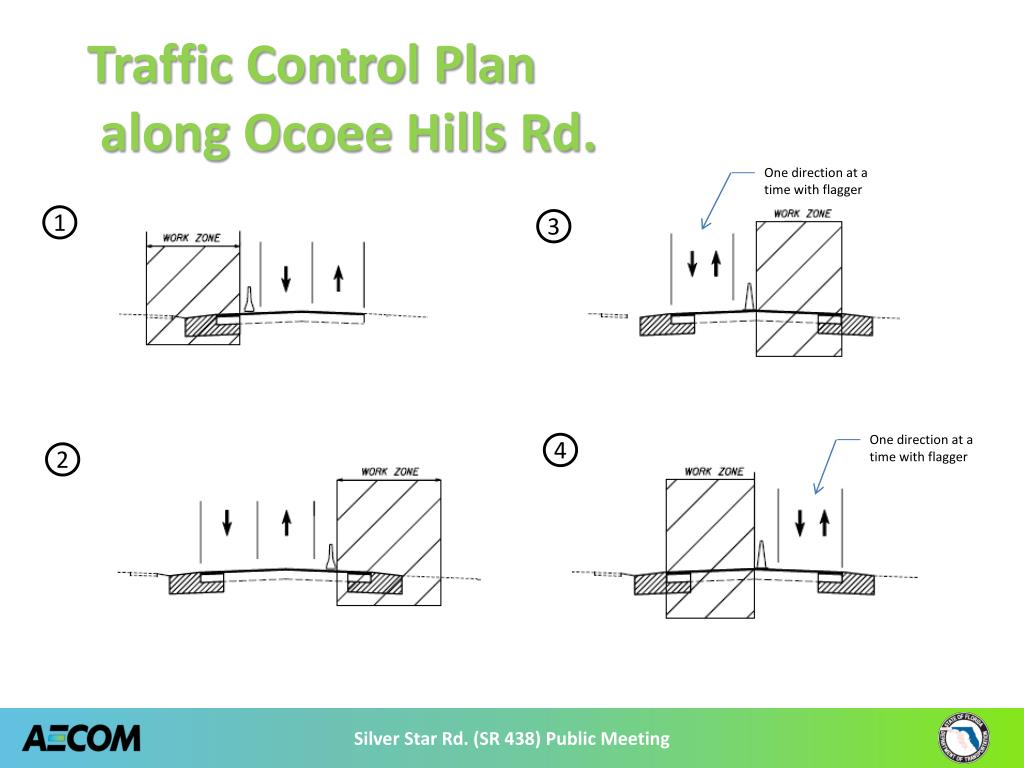

Traffic Control Plan along Ocoee Hills Rd. One direction at a time with flagger 1 3 One direction at a time with flagger 4 2

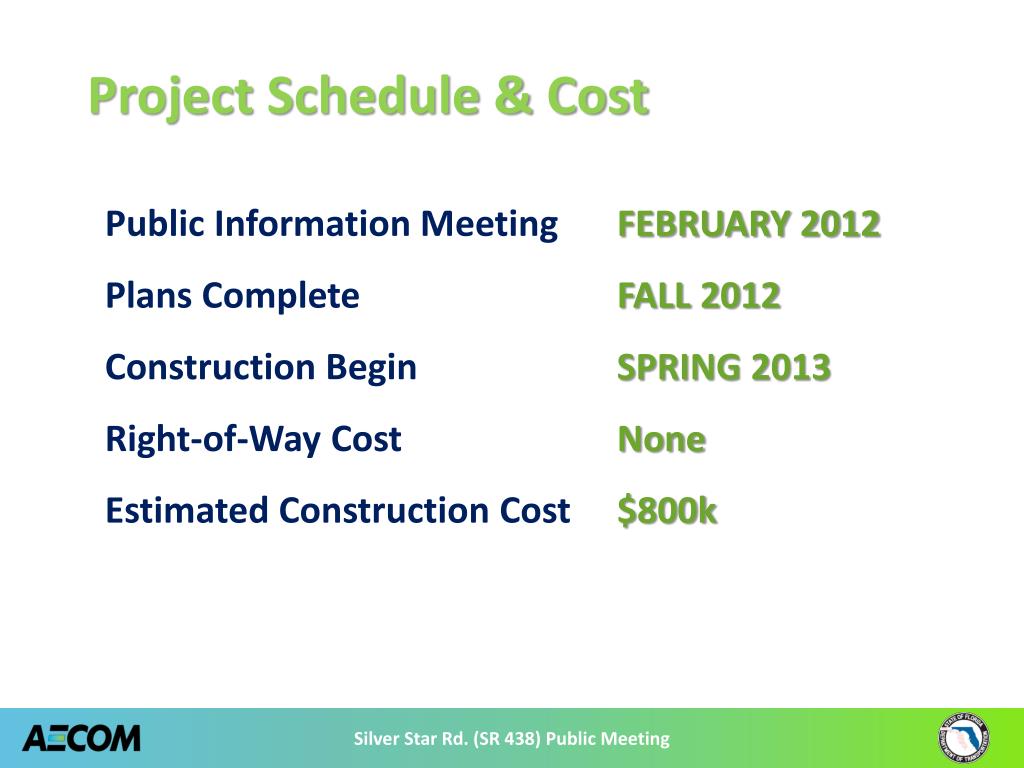

Project Schedule & Cost Public Information Meeting FEBRUARY 2012 Plans Complete FALL 2012 Construction Begin SPRING 2013 Right-of-Way Cost None Estimated Construction Cost $800k

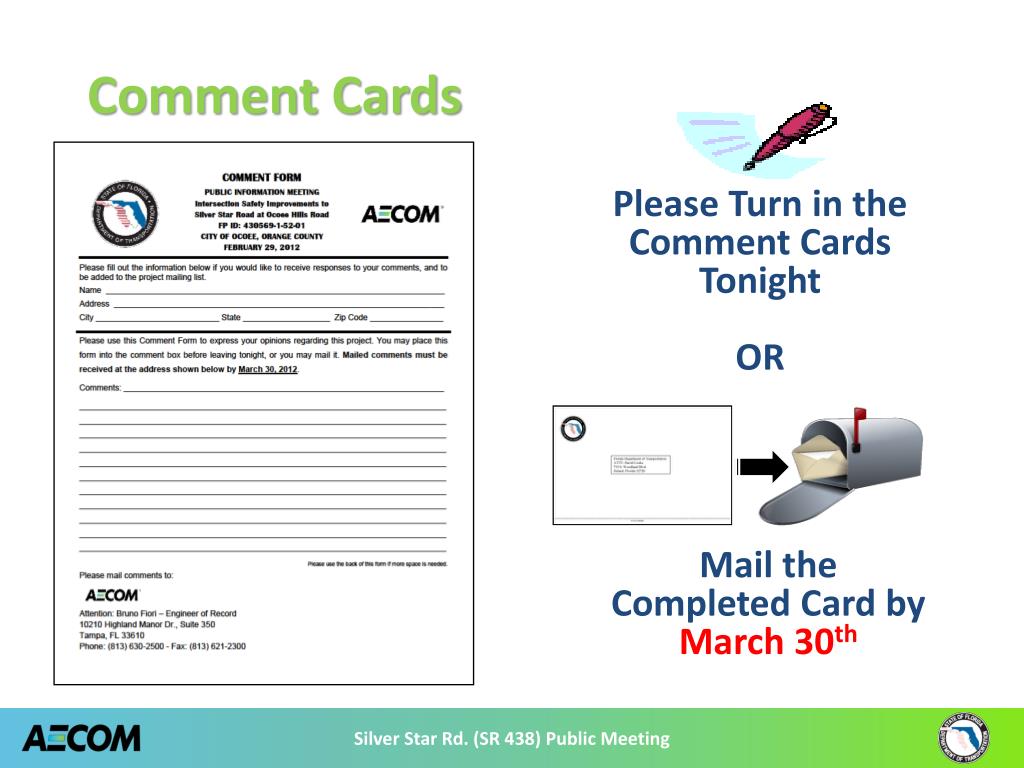

Comment Cards Please Turn in the Comment Cards Tonight OR Mail the Completed Card by March 30th
Contact Representatives: Thank You for Attending • Ashraf Elmaghraby, P.E. • FDOT – District 5 • (386) 943-5645 • Ashraf.Elmaghraby@dot.state.fl.us • Bruno Fiori, P.E. • AECOM Technical Services, Inc. • (813) 630-2500 • Bruno.Fiori@aecom.com The Website For The Project Can Be Located Under The “Future Projects” Tab http://www.cflroads.com
