1 / 64

Scrum

The agile management. Scrum. Project management framework Not a methodology. Scrum is. Team as unit Self-organized teams Business sets the priorities Decide if targets are accomplished Anyone can see real working software. Scrum Framework Roles Ceremonies Artifacts.

tudor
Télécharger la présentation

Scrum

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. The agile management Scrum

  2. Project management framework Not a methodology Scrum is

  3. Team as unit Self-organized teams Business sets the priorities Decide if targets areaccomplished Anyone can seereal working software

  4. Scrum Framework Roles Ceremonies Artifacts

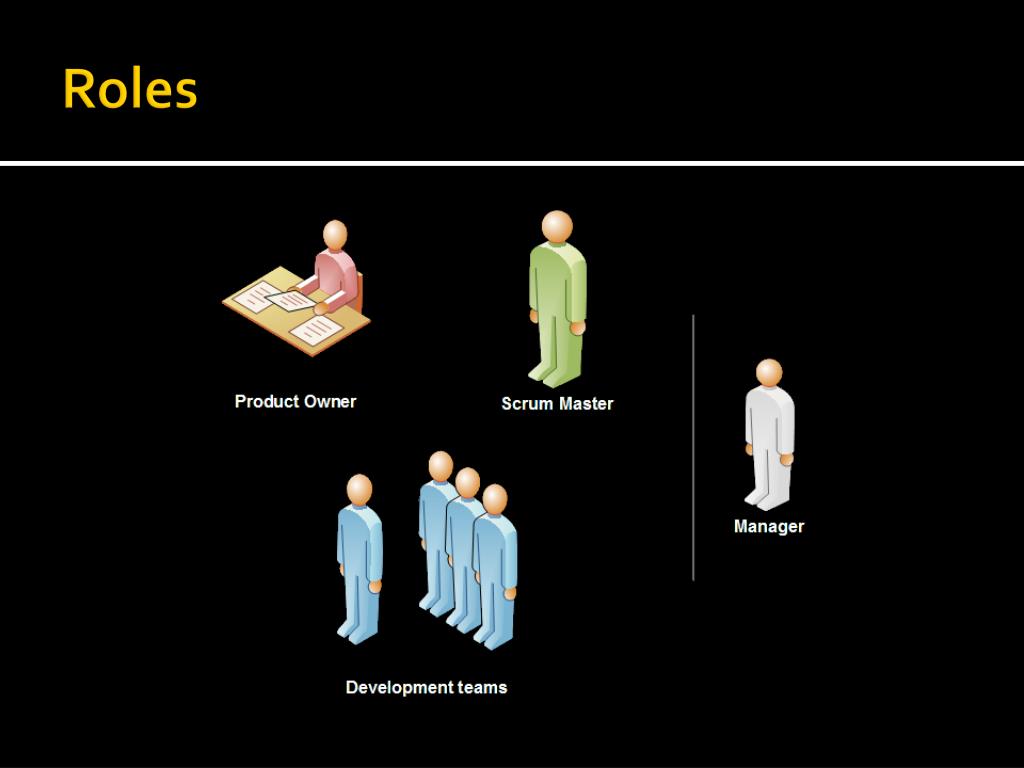

  5. Roles

  6. Ceremonies Planning Daily meeting Review (demo) Retrospective

  7. Artifacts Product backlog Sprint backlog Charts

  8. Story

  9. Story(example)

  10. Sample: House paiting (vision)

  11. Sample: Our House Living Room Bedroom Kitchen

  12. Stories I asMr. Doe want to prepare for painting As a painter I will paint thekitchen Dou you have any ideas? As a painter I will paint theliving room As a painter I will paint thebedroom

  13. Team Product Owner Scrum Master “Developers”

  14. ProductBacklog

  15. Prioritization

  16. Sample:Prioritized Backlog Highest priority Lowest priority Living Room Bedroom What are your priorities? Kitchen As a painter I will paint living room We asMr. Doe I want to prepare for painting As a painter I will paint bedroom As a painter I will paint kitchen

  17. Estimate the size Estimate by game

  18. Planning poker

  19. Poker principles Reference Compare sizes Agreement

  20. EstimatedStory

  21. EstimatedStory

  22. EstimatedStory

  23. EstimatedStory 13 story points

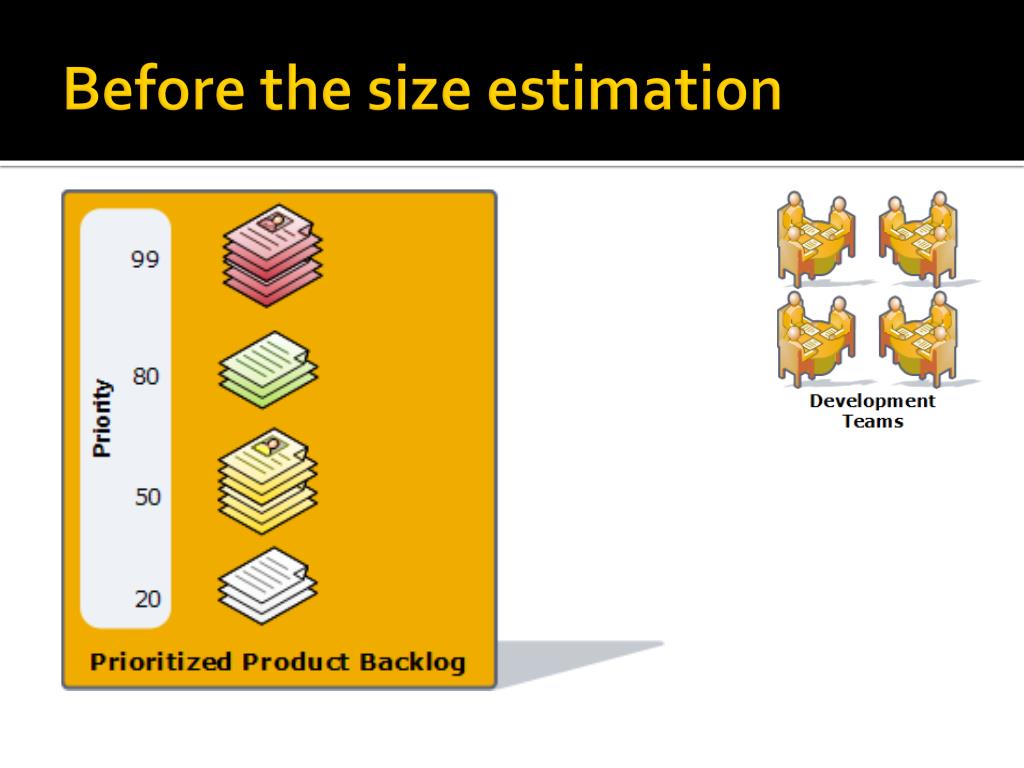

  24. Before the size estimation

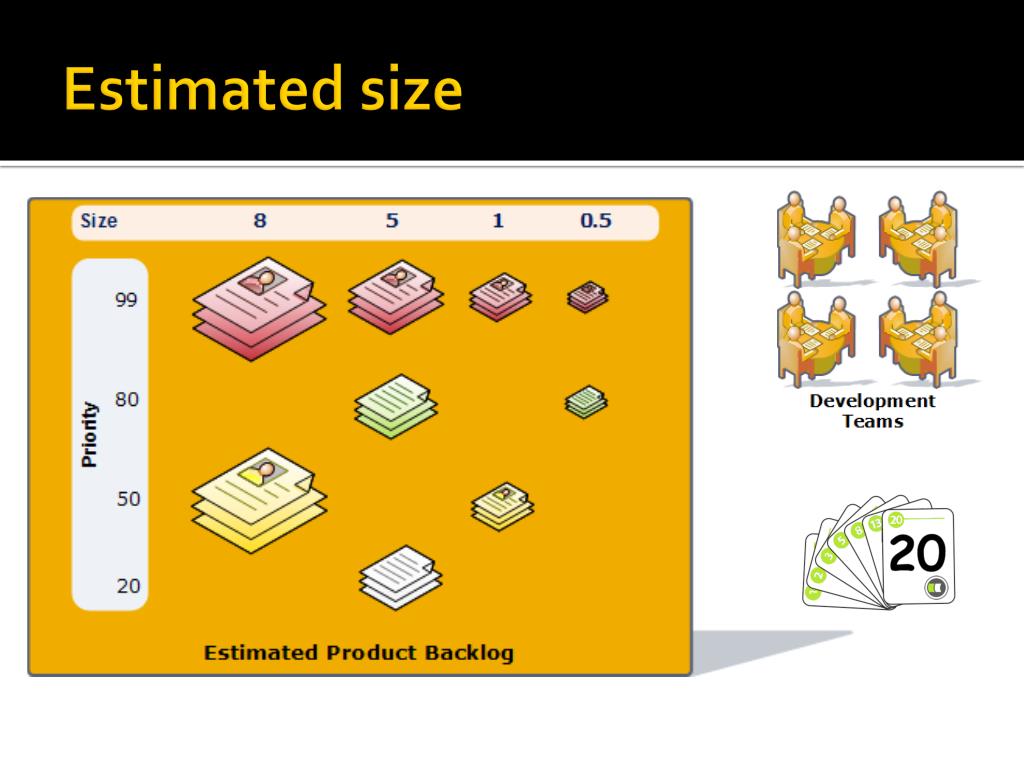

  25. Estimated size

  26. Sample:Estimated Backlog Highest priority Lowest priority Living Room Bedroom We asMr. and Mrs. we want to prepare for painting As a painter I will paint kitchen As a painter I will paint bedroom As a painter I will paint living room 2 5 1 2 Kitchen A reference story?

  27. ProductTimeline

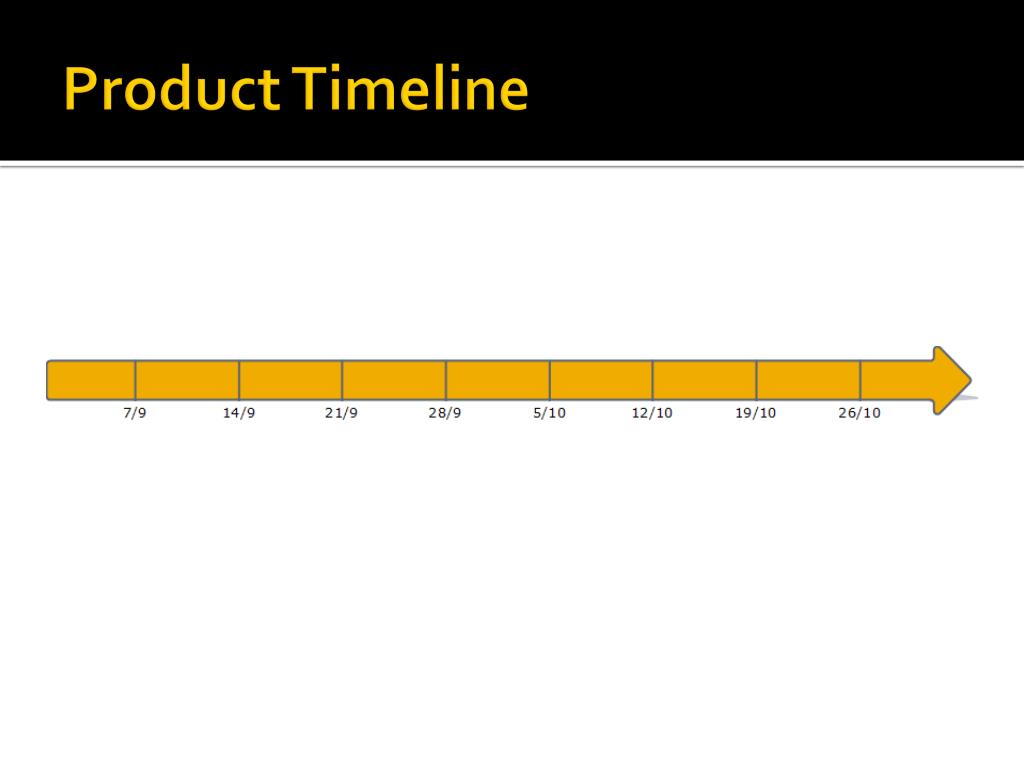

  28. ProductTimeline

  29. ProductTimeline

  30. Break Next: Let’s sprint

  31. Sprint

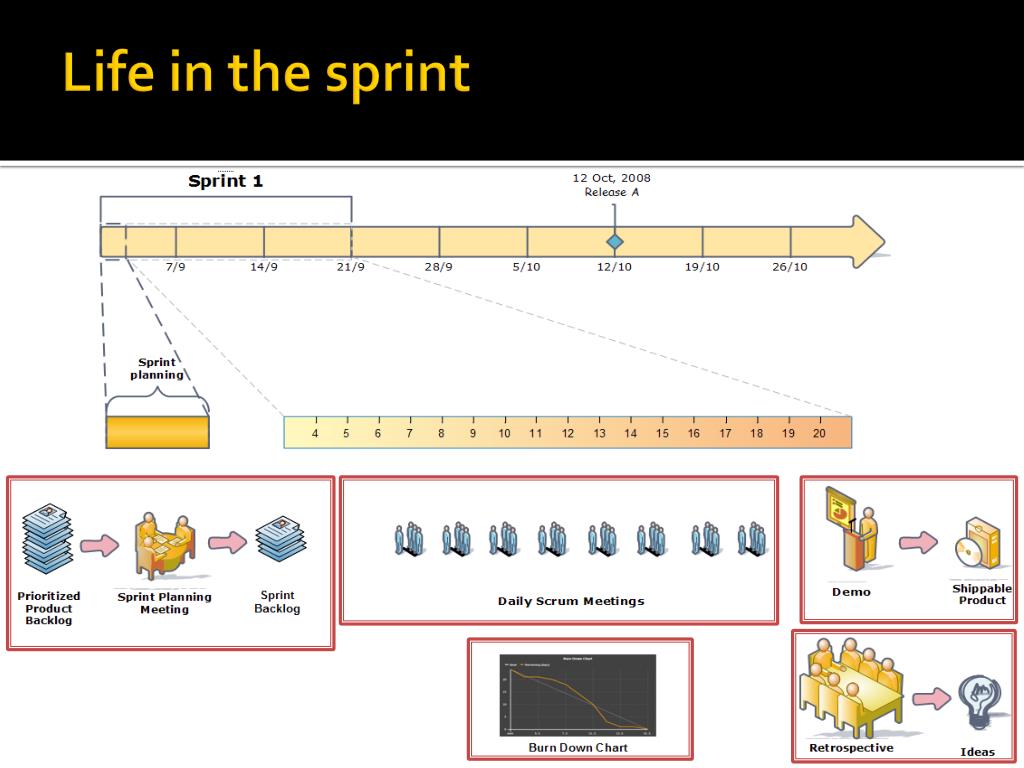

  32. Life in the sprint

  33. Sprint planning

  34. Sprintplanning Product backlog size: 11 Highest priority Lowest priority We asMr. and Mrs. we want to prepare for painting As a painter I will paint kitchen As a painter I will paint bedroom As a painter I will paint living room 3 3 5 1 2 5 1 2 Occupation 10 Capacity: 9 5 Sprint length: 5 days 8 Sprint backlog size:

  35. We know what. We know the size! But how long it will take? We need to know tasks and theirs duration!

  36. Sample: Tasks and duration We asMr. and Mrs. we want to prepare for painting As a painter I will paint kitchen Living Room Bedroom Choose colors 1 day Repair cracks 2 hour Buy colors 1 hour Paint the ceiling 2 hour Kitchen Try to define tasks and duration Prepare furniture 2 days Paint walls 4 hours Call painters 1 day Duration: 4 days 1 hour Duration: 6 hours

  37. We know what! We know the size! We know the time! Let’s act!

  38. Daily Scrum

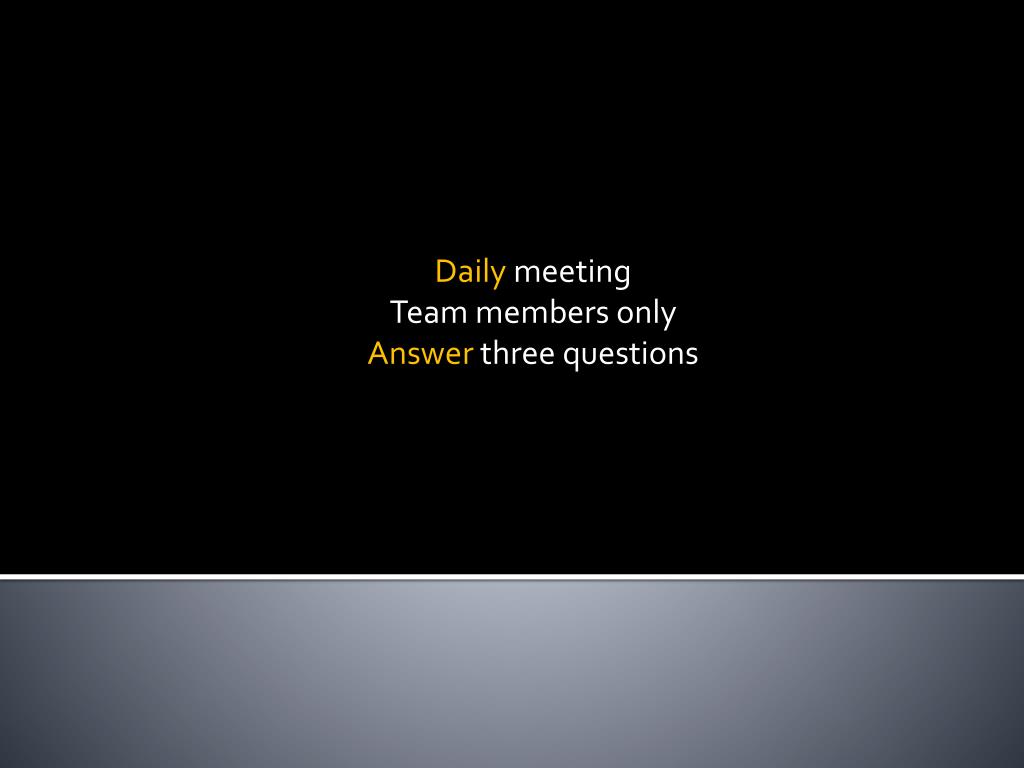

  39. Daily meeting Team members only Answer three questions

  40. Day 1 To do Processed Completed We asMr. and Mrs. we want to prepare for painting Choose colors 1 day Buy colors 1 hour Cover furniture 2 days Call painters 1 day Mr. Doe and Mrs. Doe “We are going to choose colors .

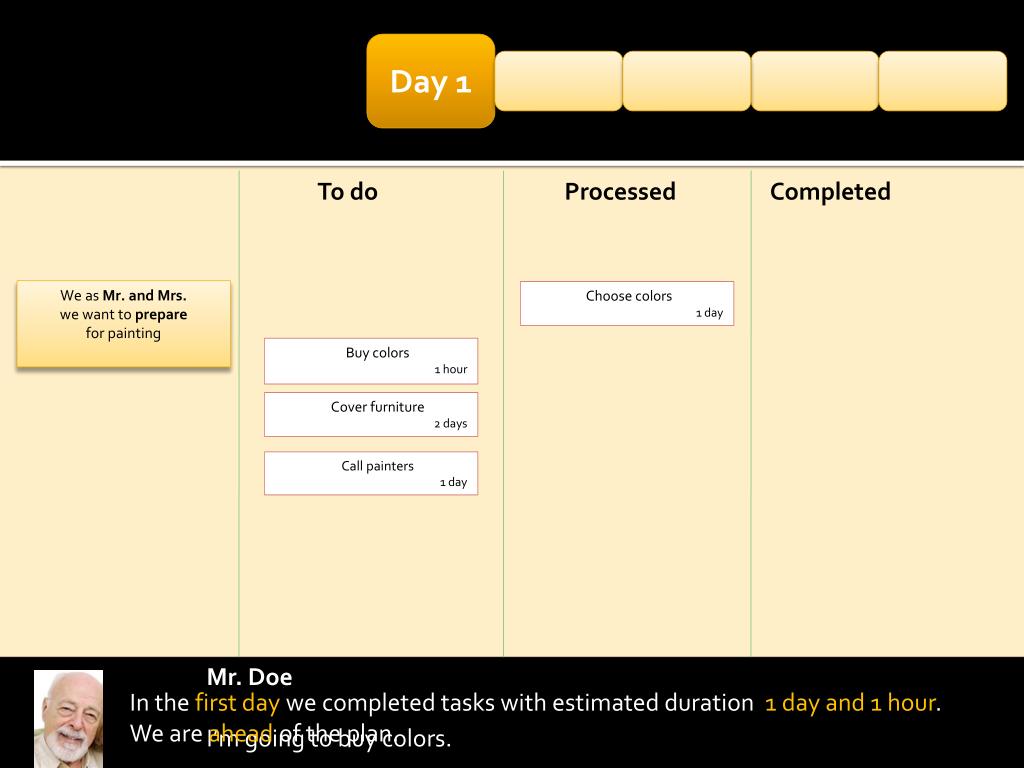

  41. Day 1 To do Processed Completed We asMr. and Mrs. we want to prepare for painting Choose colors 1 day Buy colors 1 hour Cover furniture 2 days Call painters 1 day Mr. Doe I’m going to buy colors. In the first day we completed tasks with estimated duration 1 day and 1 hour. We are ahead of the plan.

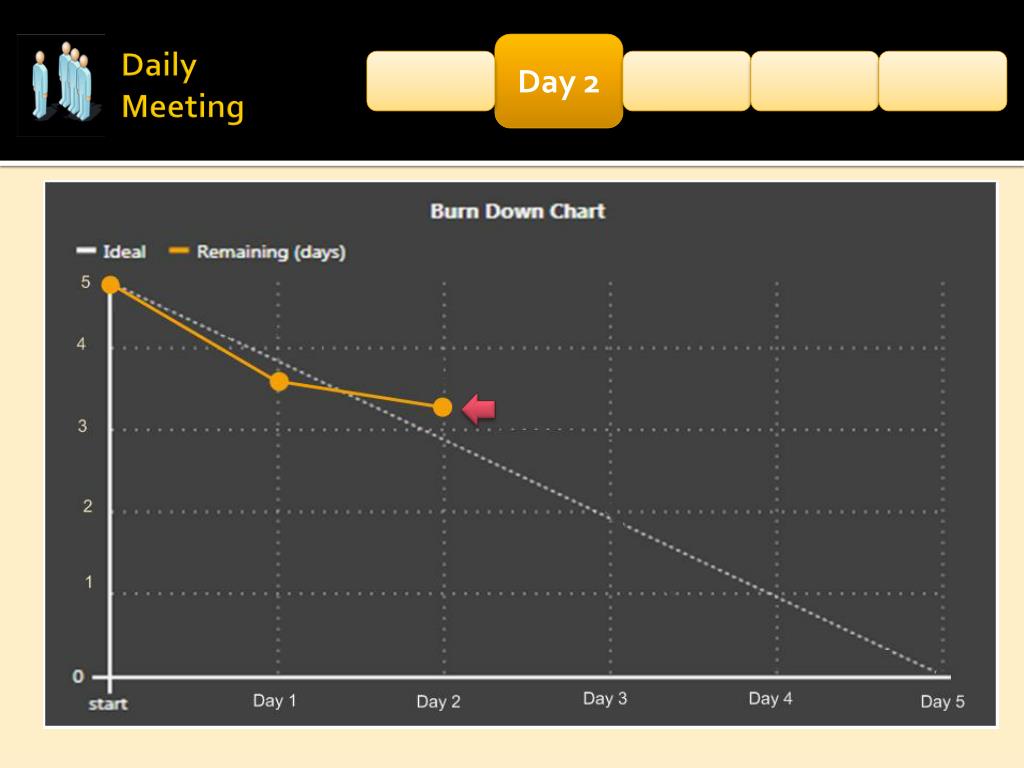

  42. DailyMeeting Day 2 5days At the beginning: 1day 1hour Completed: < 4 days Remaining:

  43. Daily Meeting Day 2 Mr. We chosen colors and I bought them yesterday. I called painters too. I’m going to prepare furniture today. I have no obstacles. Painter I haven’t been here yesterday. I’m going to repair corners today. I have no obstacles.

  44. Daily Meeting Day 2

  45. Day 2 To do Processed Completed Impediment We have a problem. Not enough color! We have to stop for 3 hours! As a painter I will paint kitchen Repair cracks 2 hour Paint the ceiling 2 hour Paint walls 4 hours

  46. Daily Meeting Day 2

  47. Daily scrum Day 2 Day 3 Day 4 Day 5

  48. Sprint review

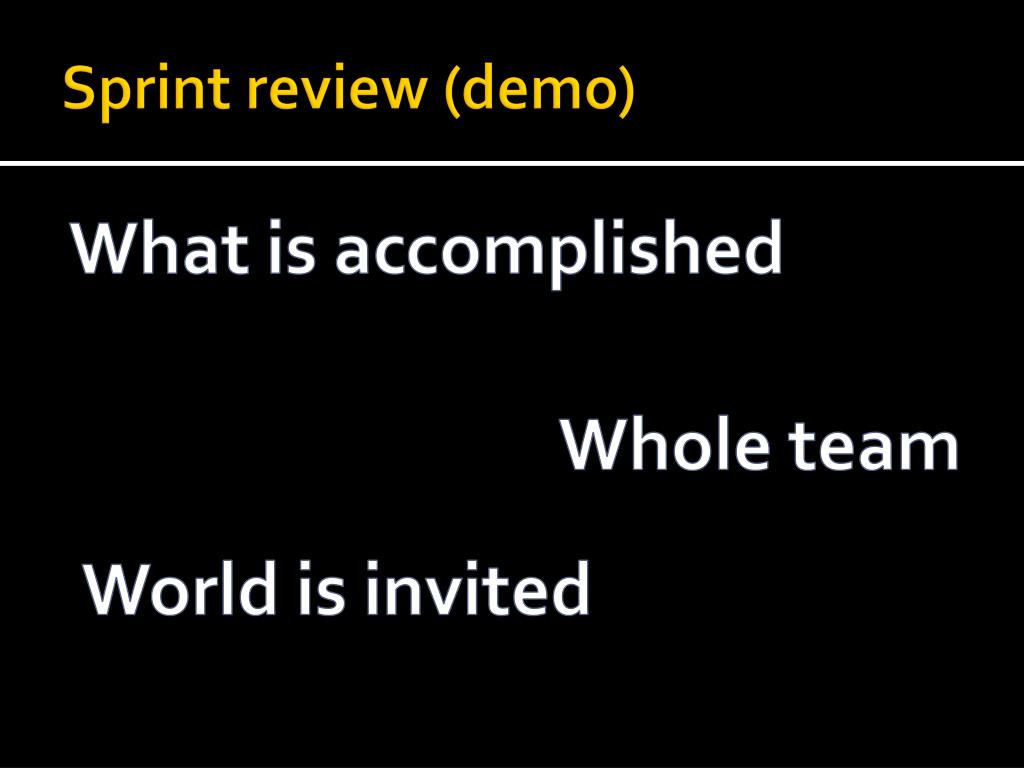

  49. Sprint review (demo) What is accomplished Whole team World is invited

  50. Sprint review (demo) Mr. We chosen colors and I bought them as you wanted. I called painters too. Painter I painted rooms as you wanted. I repaired cracks before painting. Product Owner You (not) accomplished all I want. We can move further.

More Related
