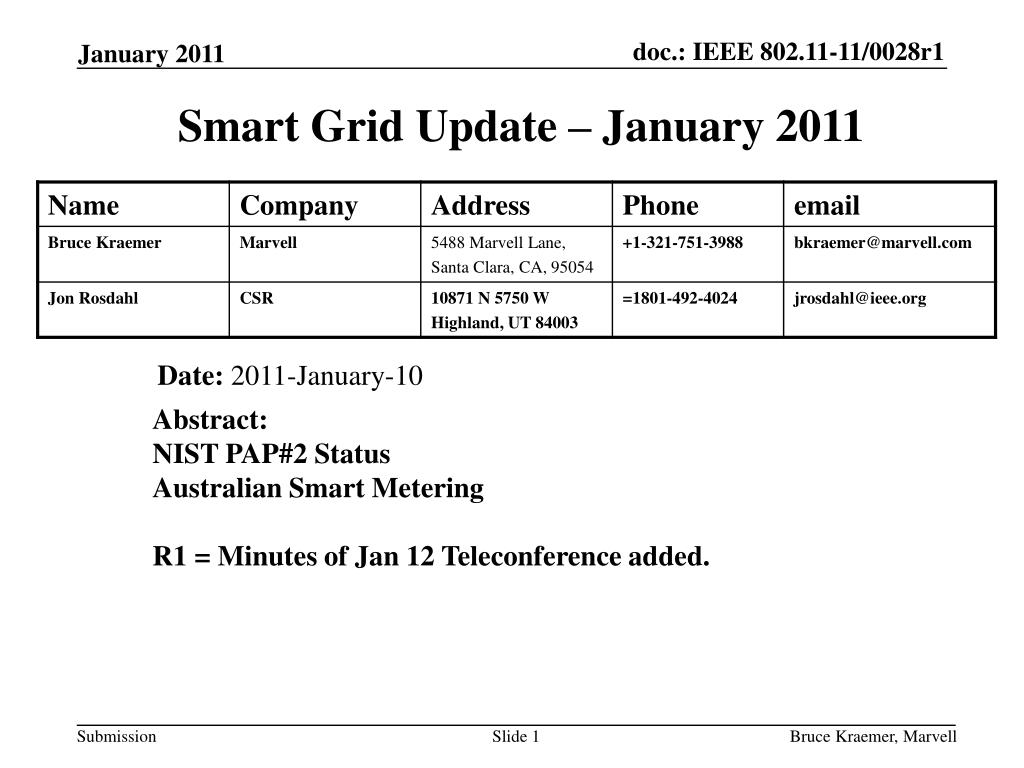

Smart Grid Update – January 2011

DESCRIPTION

Smart Grid Update – January 2011. Date: 2011-January-10. Abstract: NIST PAP#2 Status Australian Smart Metering R1 = Minutes of Jan 12 Teleconference added. Call Topics. Agenda Topics for this call PAP2 Report Status New Australian Smart Metering RFI Additional topics for LA SGIP news

1 / 14

Télécharger la présentation

Smart Grid Update – January 2011

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Smart Grid Update – January 2011 Date: 2011-January-10 Abstract: NIST PAP#2 Status Australian Smart Metering R1 = Minutes of Jan 12 Teleconference added. Bruce Kraemer, Marvell

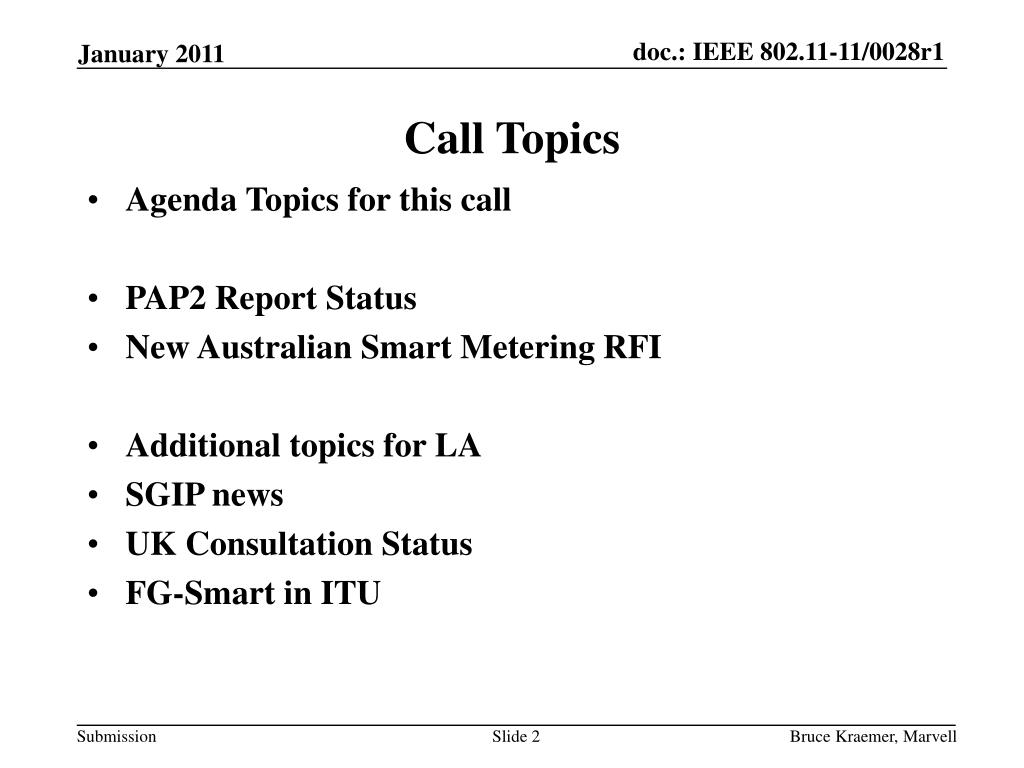

  2. Call Topics • Agenda Topics for this call • PAP2 Report Status • New Australian Smart Metering RFI • Additional topics for LA • SGIP news • UK Consultation Status • FG-Smart in ITU Bruce Kraemer, Marvell

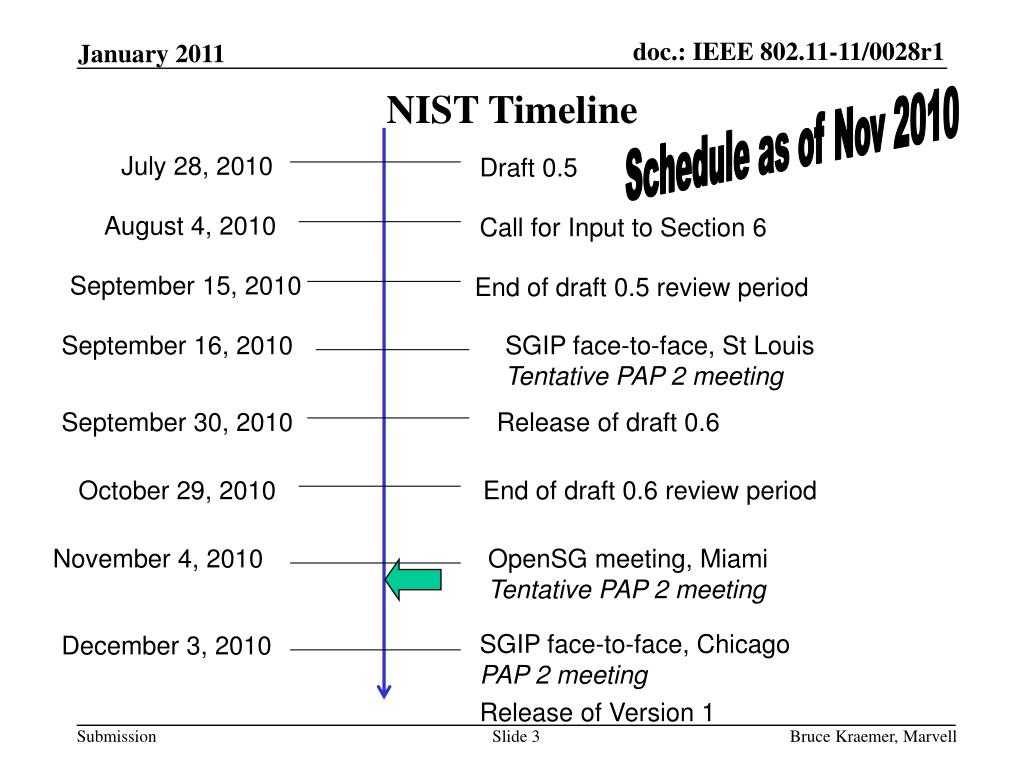

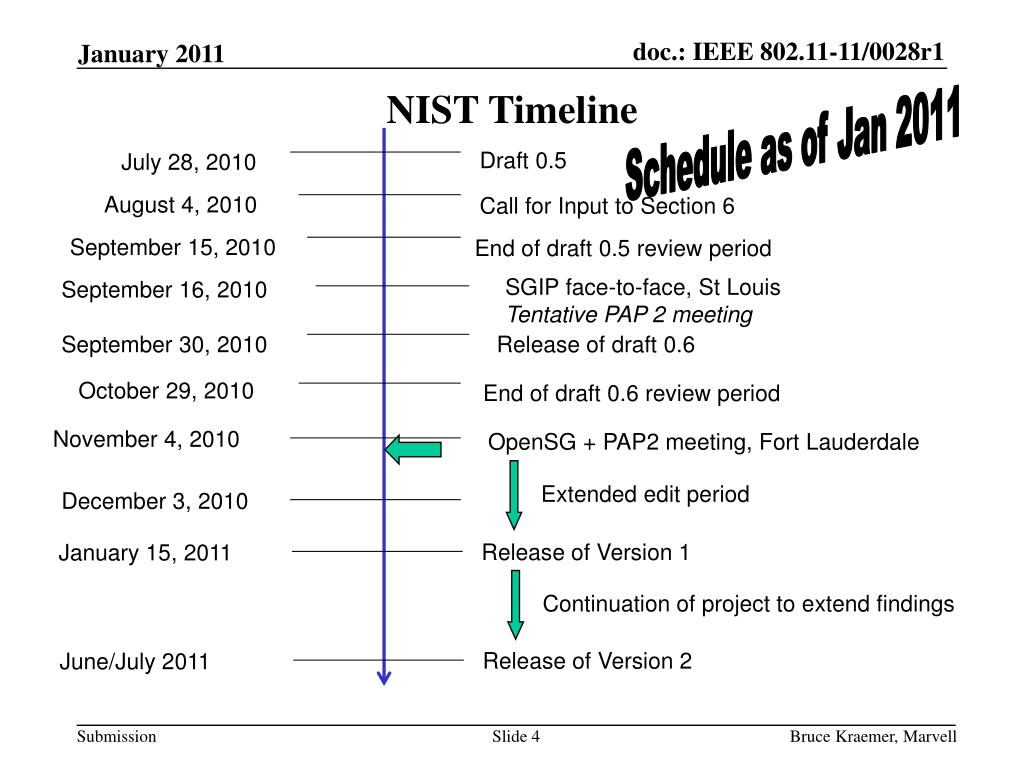

  3. July 28, 2010 Draft 0.5 August 4, 2010 Call for Input to Section 6 September 15, 2010 End of draft 0.5 review period September 16, 2010 SGIP face-to-face, St Louis Tentative PAP 2 meeting NIST Timeline Schedule as of Nov 2010 September 30, 2010 Release of draft 0.6 October 29, 2010 End of draft 0.6 review period November 4, 2010 OpenSG meeting, Miami Tentative PAP 2 meeting SGIP face-to-face, Chicago PAP 2 meeting December 3, 2010 Release of Version 1 Bruce Kraemer, Marvell

  4. Draft 0.5 July 28, 2010 August 4, 2010 Call for Input to Section 6 September 15, 2010 End of draft 0.5 review period SGIP face-to-face, St Louis Tentative PAP 2 meeting September 16, 2010 NIST Timeline Schedule as of Jan 2011 September 30, 2010 Release of draft 0.6 October 29, 2010 End of draft 0.6 review period November 4, 2010 OpenSG + PAP2 meeting, Fort Lauderdale Extended edit period December 3, 2010 Release of Version 1 January 15, 2011 Continuation of project to extend findings Release of Version 2 June/July 2011 Bruce Kraemer, Marvell

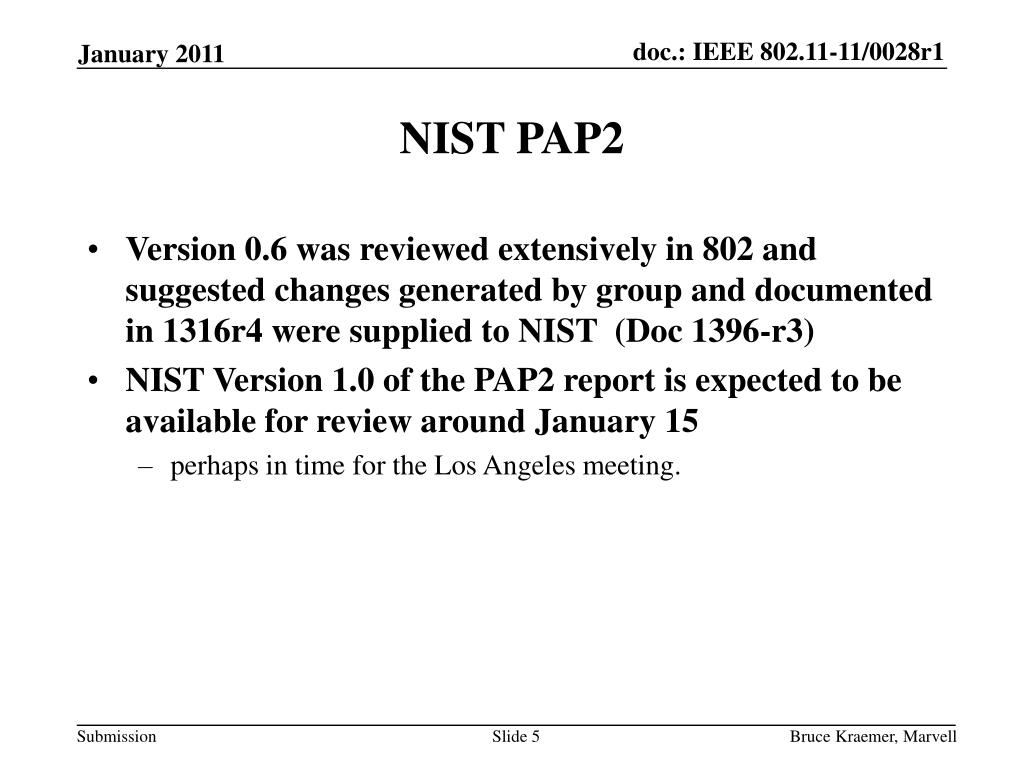

  5. NIST PAP2 • Version 0.6 was reviewed extensively in 802 and suggested changes generated by group and documented in 1316r4 were supplied to NIST (Doc 1396-r3) • NIST Version 1.0 of the PAP2 report is expected to be available for review around January 15 • perhaps in time for the Los Angeles meeting. Bruce Kraemer, Marvell

  6. Australia • Australia has issued a call for candidates for their Smart Metering HAN • Responses from 802 should be provided • Probably best from individual WG, e.g 802.11, 802.15 but some coordinated discussion required • Because of the tight association of technology to metering application functionality, responses to many of the questions will be very difficult • http://share.aemo.com.au/smartmetering/default.aspx Bruce Kraemer, Marvell

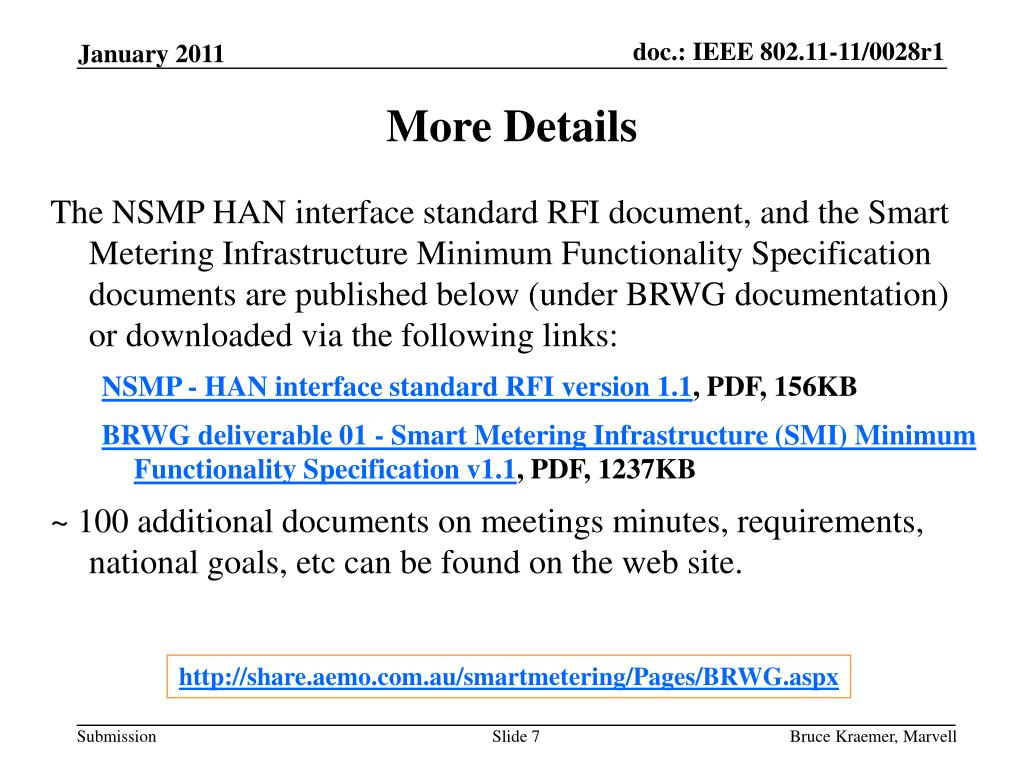

  7. More Details The NSMP HAN interface standard RFI document, and the Smart Metering Infrastructure Minimum Functionality Specification documents are published below (under BRWG documentation) or downloaded via the following links: NSMP - HAN interface standard RFI version 1.1, PDF, 156KB BRWG deliverable 01 - Smart Metering Infrastructure (SMI) Minimum Functionality Specification v1.1, PDF, 1237KB ~ 100 additional documents on meetings minutes, requirements, national goals, etc can be found on the web site. http://share.aemo.com.au/smartmetering/Pages/BRWG.aspx Bruce Kraemer, Marvell

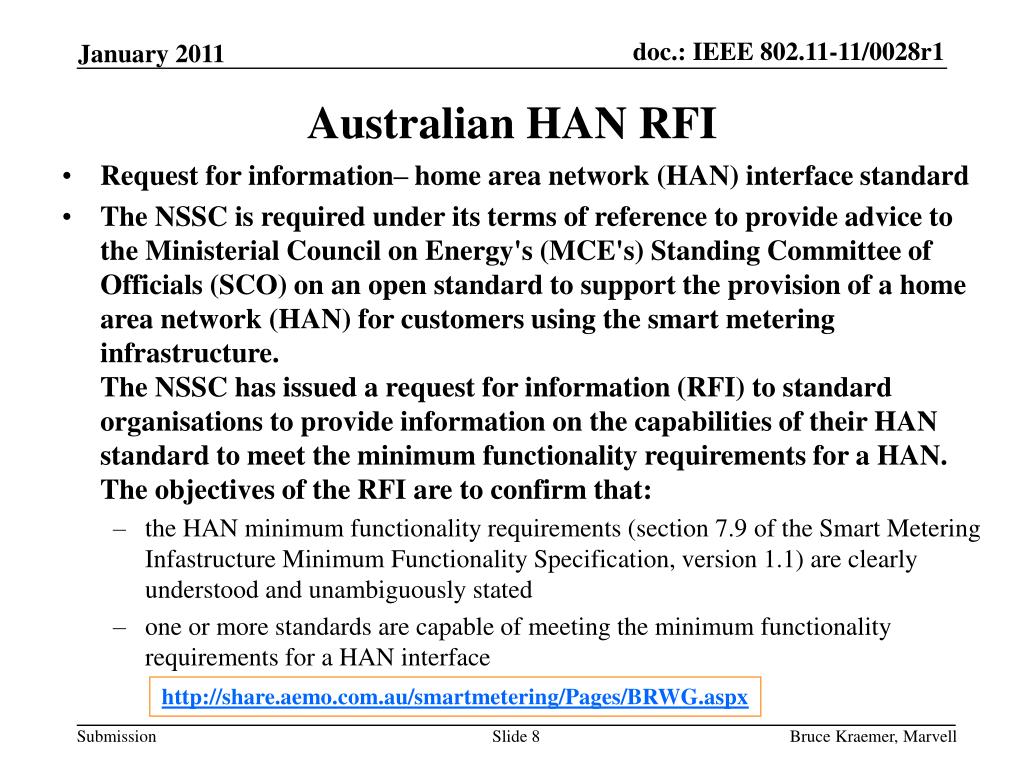

  8. Australian HAN RFI • Request for information– home area network (HAN) interface standard • The NSSC is required under its terms of reference to provide advice to the Ministerial Council on Energy's (MCE's) Standing Committee of Officials (SCO) on an open standard to support the provision of a home area network (HAN) for customers using the smart metering infrastructure.The NSSC has issued a request for information (RFI) to standard organisations to provide information on the capabilities of their HAN standard to meet the minimum functionality requirements for a HAN.The objectives of the RFI are to confirm that: • the HAN minimum functionality requirements (section 7.9 of the Smart Metering Infastructure Minimum Functionality Specification, version 1.1) are clearly understood and unambiguously stated • one or more standards are capable of meeting the minimum functionality requirements for a HAN interface http://share.aemo.com.au/smartmetering/Pages/BRWG.aspx Bruce Kraemer, Marvell

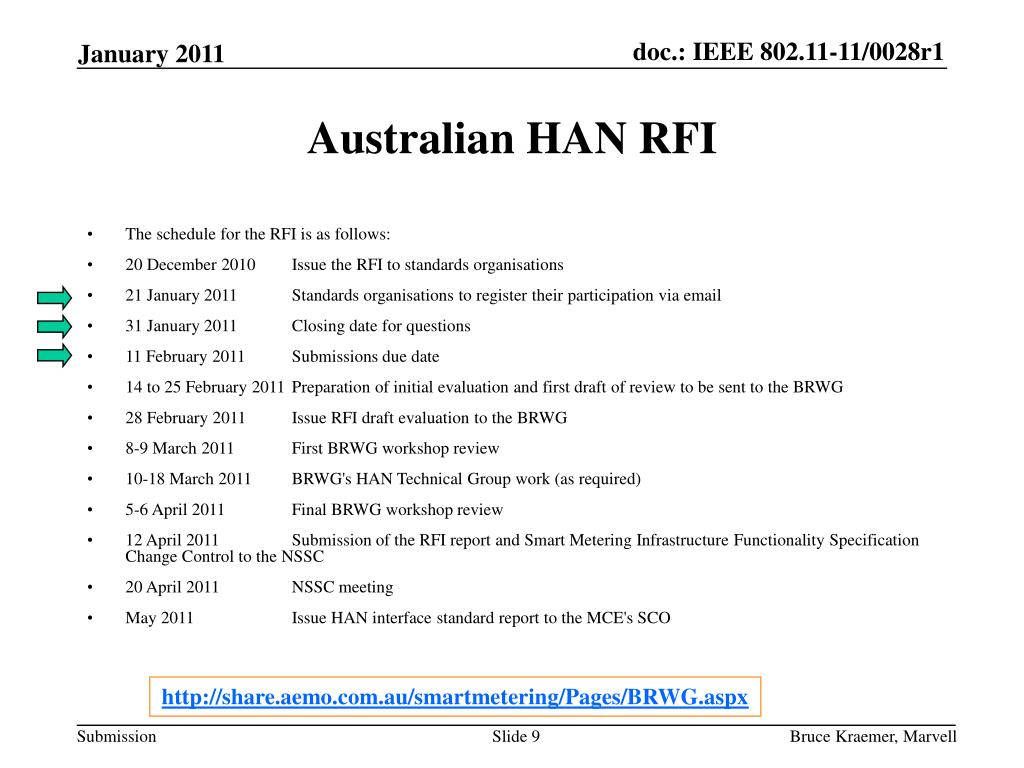

  9. Australian HAN RFI • The schedule for the RFI is as follows: • 20 December 2010 Issue the RFI to standards organisations • 21 January 2011 Standards organisations to register their participation via email • 31 January 2011 Closing date for questions • 11 February 2011 Submissions due date • 14 to 25 February 2011 Preparation of initial evaluation and first draft of review to be sent to the BRWG • 28 February 2011 Issue RFI draft evaluation to the BRWG • 8-9 March 2011 First BRWG workshop review • 10-18 March 2011 BRWG's HAN Technical Group work (as required) • 5-6 April 2011 Final BRWG workshop review • 12 April 2011 Submission of the RFI report and Smart Metering Infrastructure Functionality Specification Change Control to the NSSC • 20 April 2011 NSSC meeting • May 2011 Issue HAN interface standard report to the MCE's SCO http://share.aemo.com.au/smartmetering/Pages/BRWG.aspx Bruce Kraemer, Marvell

  10. RFI Sample Bruce Kraemer, Marvell

  11. RFI Sample Bruce Kraemer, Marvell

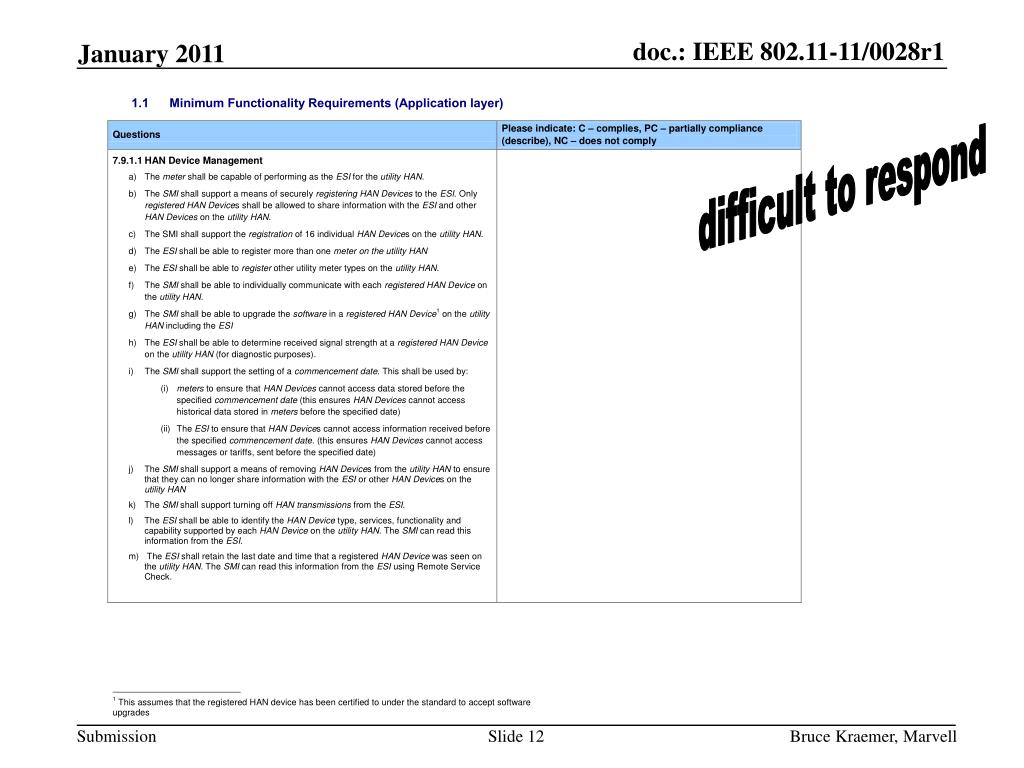

  12. difficult to respond Bruce Kraemer, Marvell

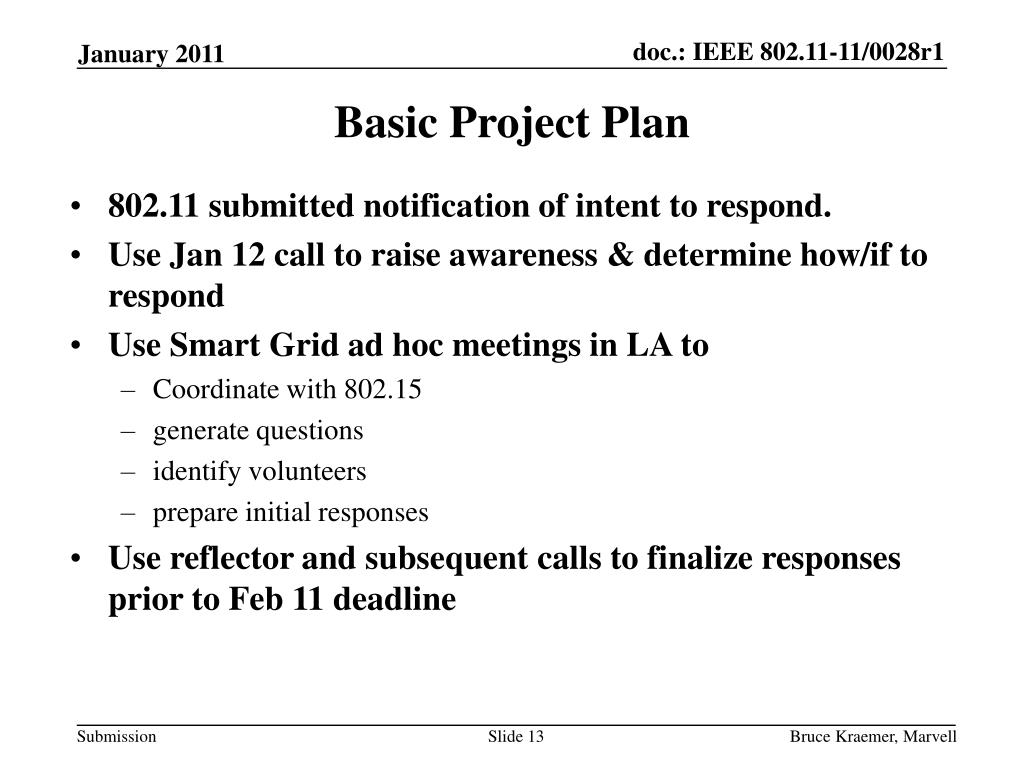

  13. Basic Project Plan • 802.11 submitted notification of intent to respond. • Use Jan 12 call to raise awareness & determine how/if to respond • Use Smart Grid ad hoc meetings in LA to • Coordinate with 802.15 • generate questions • identify volunteers • prepare initial responses • Use reflector and subsequent calls to finalize responses prior to Feb 11 deadline Bruce Kraemer, Marvell

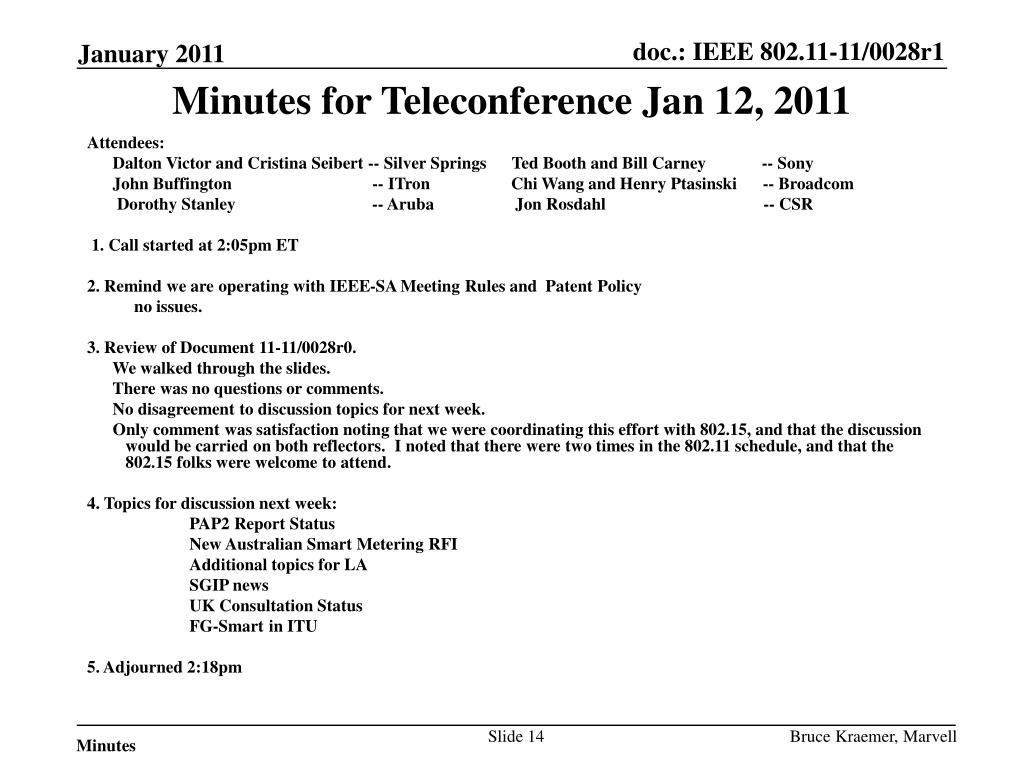

  14. Minutes for Teleconference Jan 12, 2011 Attendees:       Dalton Victor and Cristina Seibert -- Silver Springs      Ted Booth and Bill Carney             -- Sony       John Buffington                                 -- ITron        Chi Wang and Henry Ptasinski      -- Broadcom        Dorothy Stanley                                -- Aruba Jon Rosdahl -- CSR  1. Call started at 2:05pm ET 2. Remind we are operating with IEEE-SA Meeting Rules and  Patent Policy   no issues. 3. Review of Document 11-11/0028r0.       We walked through the slides.       There was no questions or comments.       No disagreement to discussion topics for next week.       Only comment was satisfaction noting that we were coordinating this effort with 802.15, and that the discussion would be carried on both reflectors.  I noted that there were two times in the 802.11 schedule, and that the 802.15 folks were welcome to attend. 4. Topics for discussion next week: PAP2 Report Status New Australian Smart Metering RFI Additional topics for LA SGIP news UK Consultation Status FG-Smart in ITU 5. Adjourned 2:18pm Bruce Kraemer, Marvell Minutes
