Project Management

Project Management. Planning Techniques Project manager responsible for developing project implementation plan. Duties includes: Defining tasks Making estimates (cost and timing) Preparing schedules Preparing budgets. Project Management. Recall the house construction example:

yair
Télécharger la présentation

Project Management

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

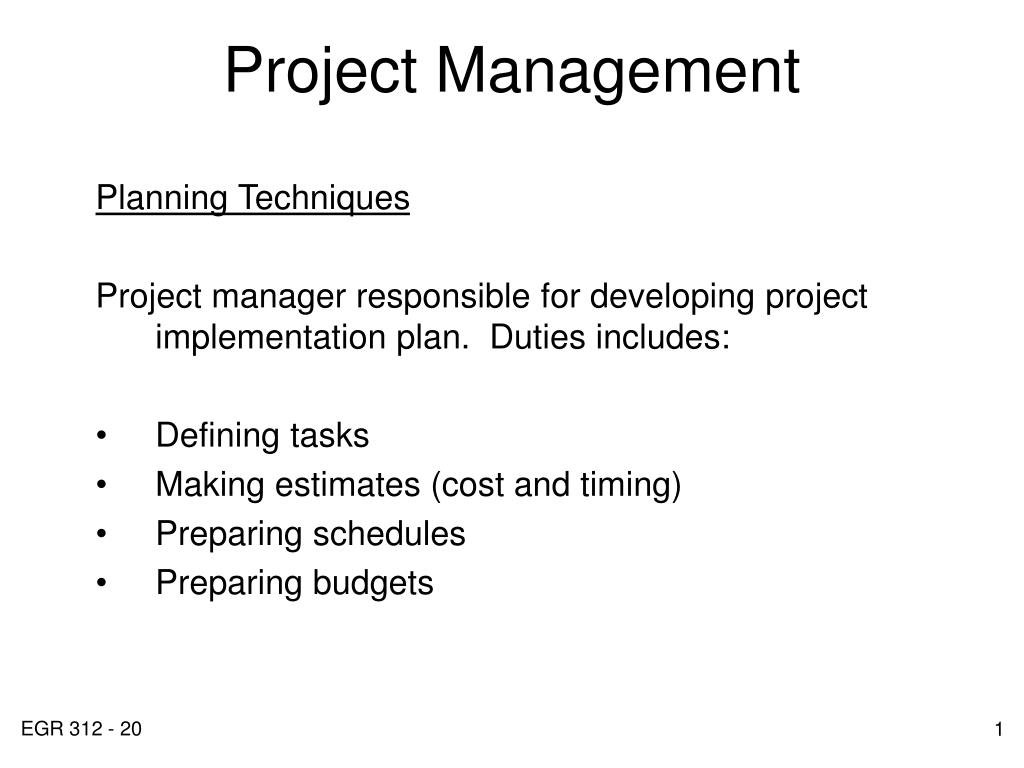

  1. Project Management Planning Techniques Project manager responsible for developing project implementation plan. Duties includes: • Defining tasks • Making estimates (cost and timing) • Preparing schedules • Preparing budgets

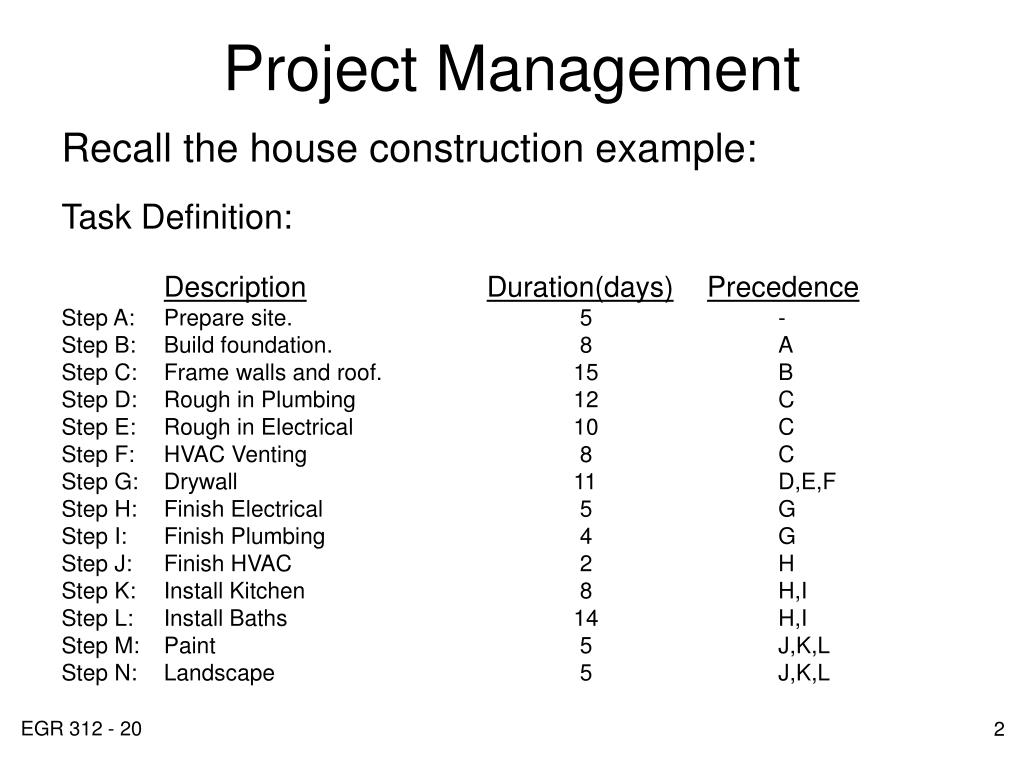

  2. Project Management Recall the house construction example: Task Definition: DescriptionDuration(days)Precedence Step A: Prepare site. 5 - Step B: Build foundation. 8 A Step C: Frame walls and roof. 15 B Step D: Rough in Plumbing 12 C Step E: Rough in Electrical 10 C Step F: HVAC Venting 8 C Step G: Drywall 11 D,E,F Step H: Finish Electrical 5 G Step I: Finish Plumbing 4 G Step J: Finish HVAC 2 H Step K: Install Kitchen 8 H,I Step L: Install Baths 14 H,I Step M: Paint 5 J,K,L Step N: Landscape 5 J,K,L

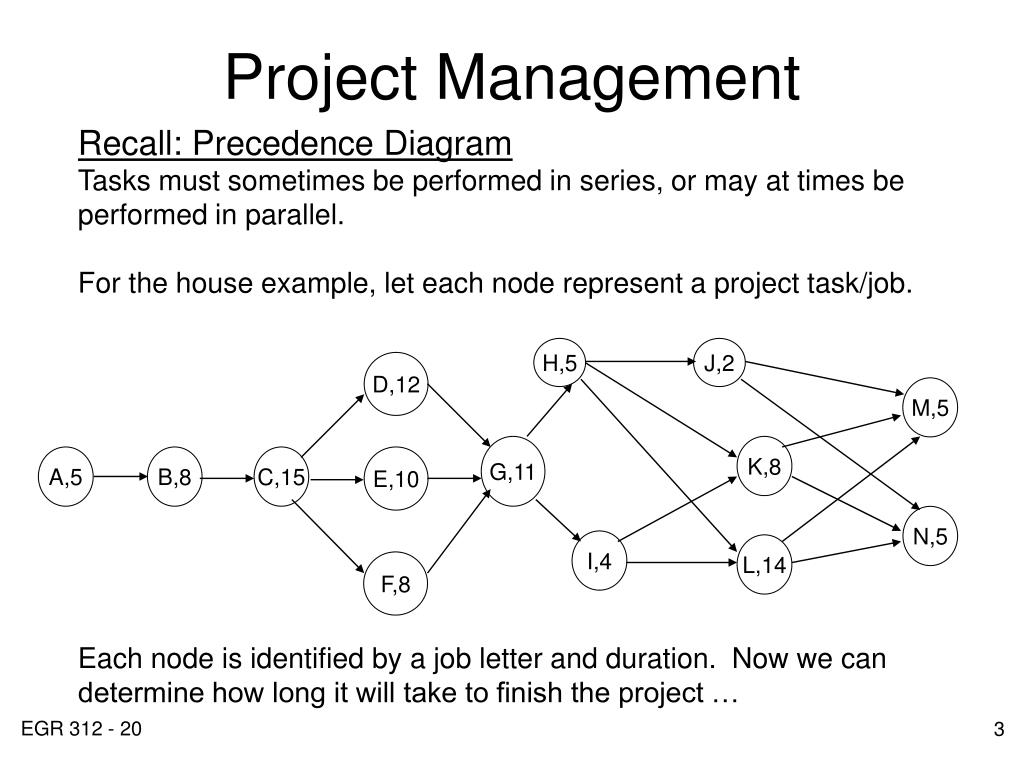

  3. H,5 J,2 D,12 M,5 G,11 K,8 A,5 B,8 C,15 E,10 N,5 I,4 L,14 F,8 Project Management Recall: Precedence Diagram Tasks must sometimes be performed in series, or may at times be performed in parallel. For the house example, let each node represent a project task/job. Each node is identified by a job letter and duration. Now we can determine how long it will take to finish the project …

  4. H,5 J,2 D,12 M,5 G,11 K,8 A,5 B,8 C,15 E,10 N,5 I,4 L,14 F,8 Project Management Critical Path

  5. Project Management • Timing – Gantt Chart • Tasks and task durations are often represented as Gantt Charts. • Task precedence knowledge is shown graphically on the time line.

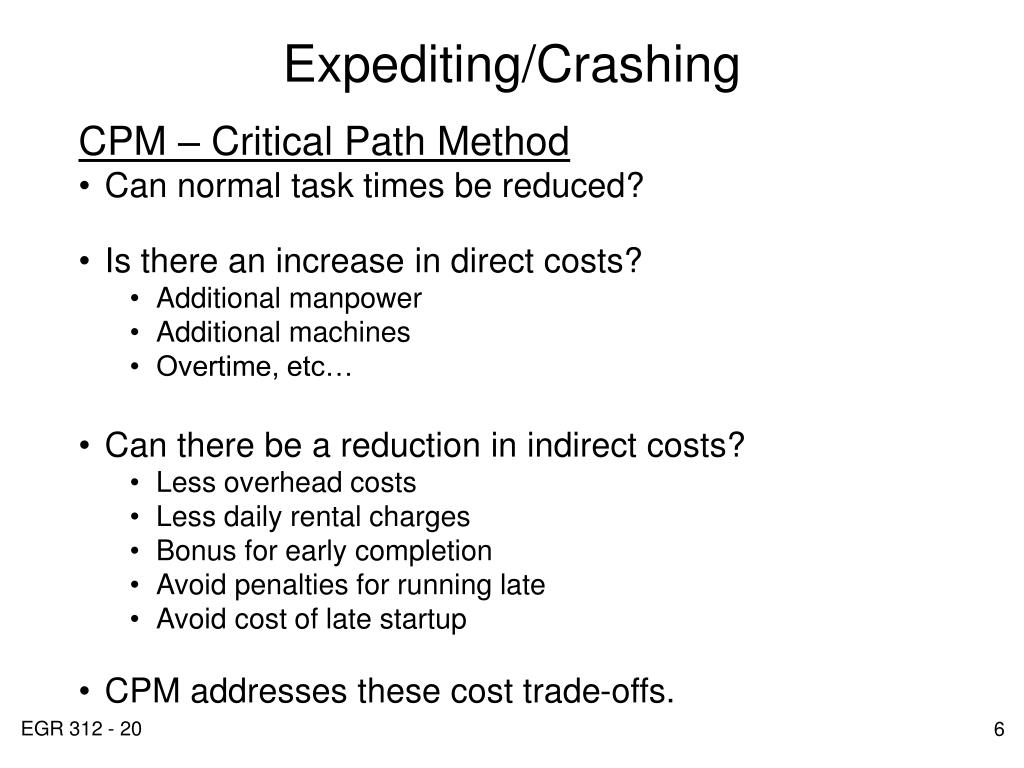

  6. Expediting/Crashing • CPM – Critical Path Method • Can normal task times be reduced? • Is there an increase in direct costs? • Additional manpower • Additional machines • Overtime, etc… • Can there be a reduction in indirect costs? • Less overhead costs • Less daily rental charges • Bonus for early completion • Avoid penalties for running late • Avoid cost of late startup • CPM addresses these cost trade-offs.

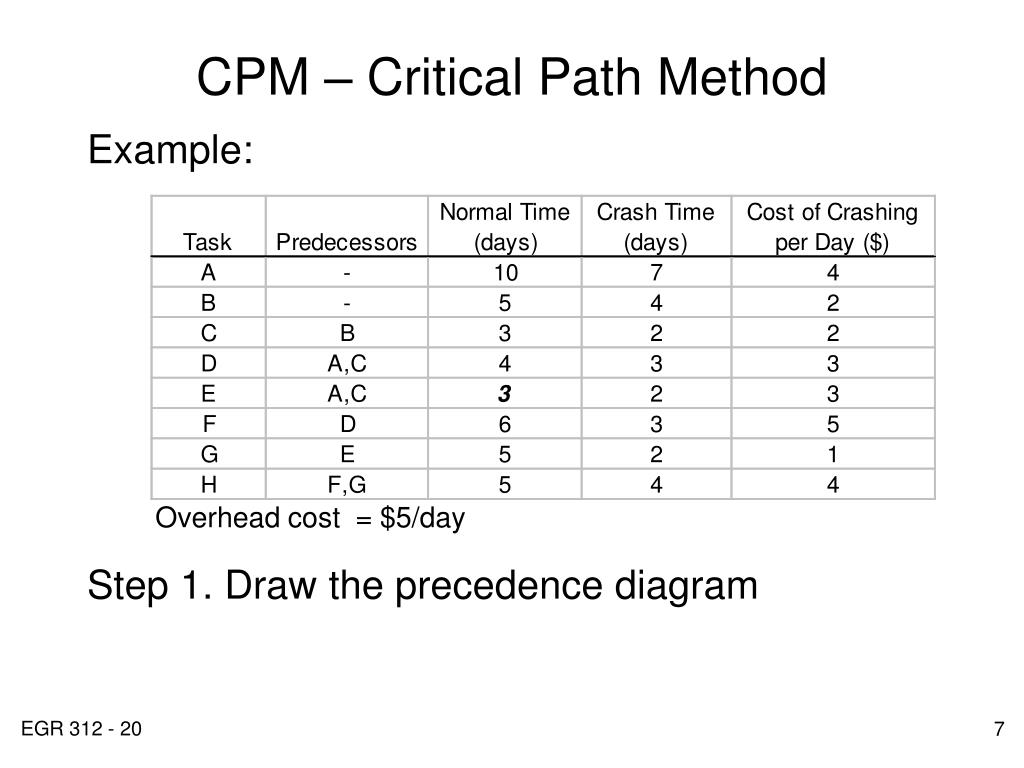

  7. CPM – Critical Path Method Example: Overhead cost = $5/day Step 1. Draw the precedence diagram

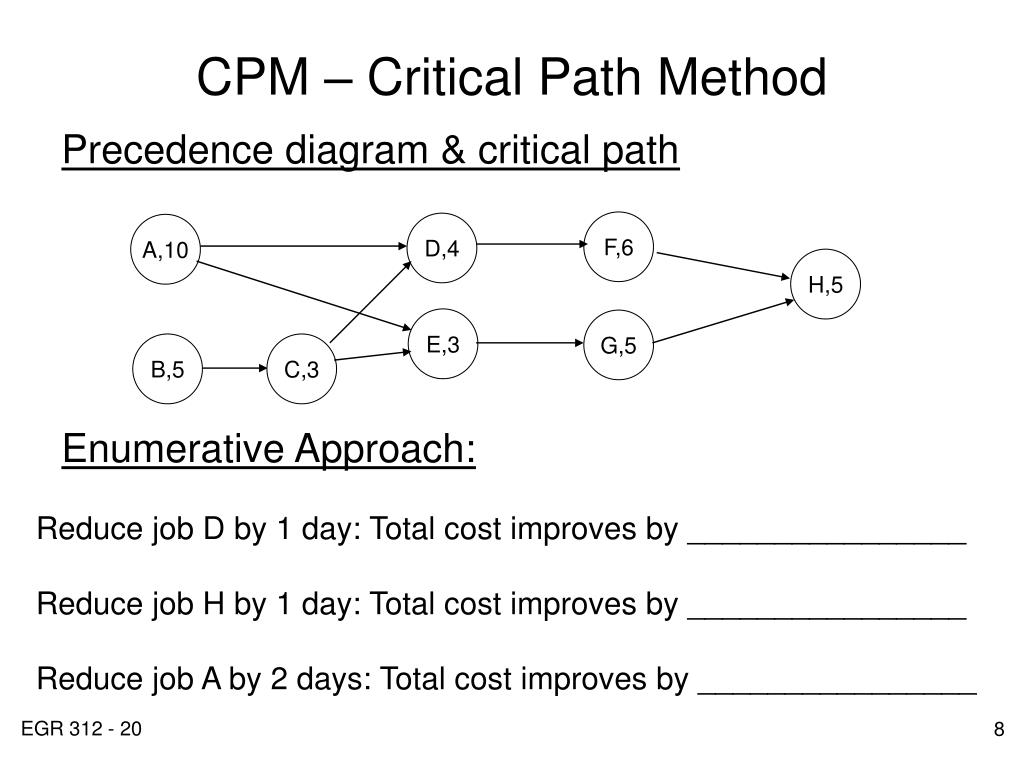

  8. F,6 D,4 A,10 H,5 E,3 G,5 B,5 C,3 CPM – Critical Path Method Precedence diagram & critical path Enumerative Approach: Reduce job D by 1 day: Total cost improves by ________________ Reduce job H by 1 day: Total cost improves by ________________ Reduce job A by 2 days: Total cost improves by ________________

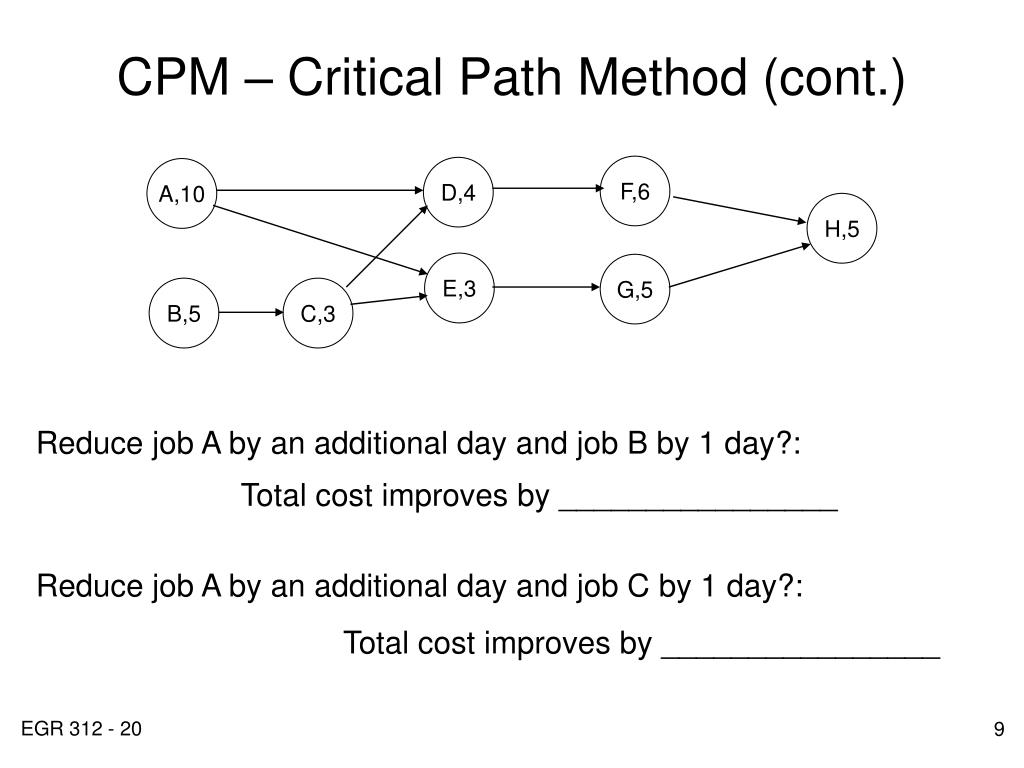

  9. F,6 D,4 A,10 H,5 E,3 G,5 B,5 C,3 CPM – Critical Path Method (cont.) Reduce job A by an additional day and job B by 1 day?: Total cost improves by ________________ Reduce job A by an additional day and job C by 1 day?: Total cost improves by ________________

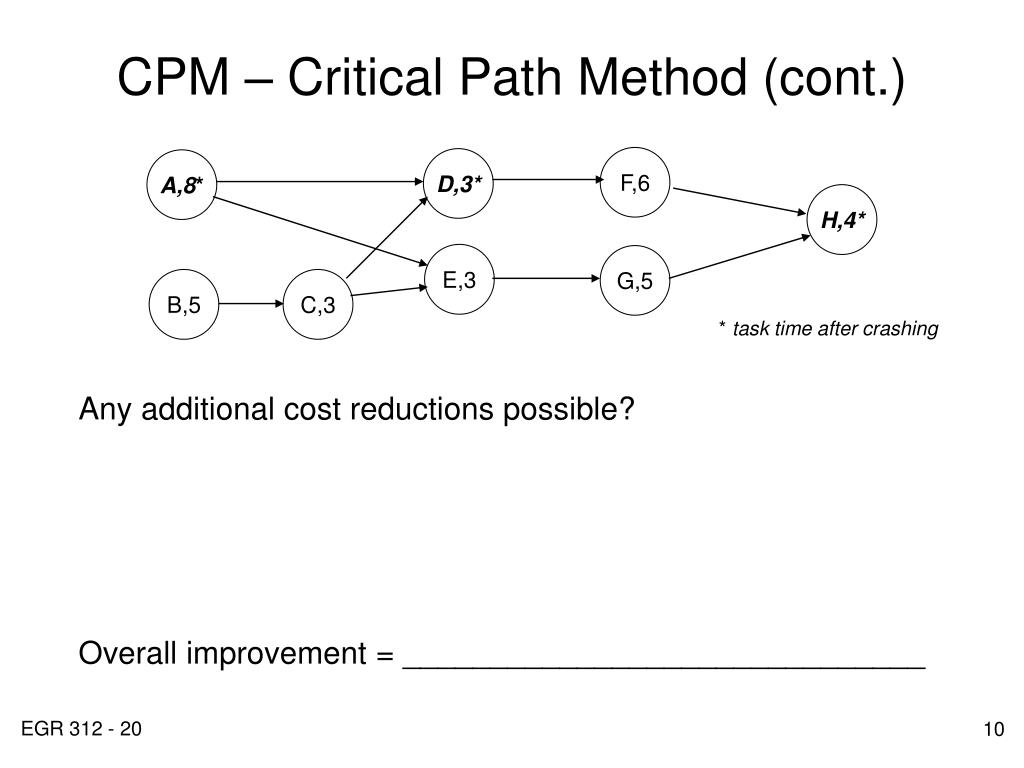

  10. F,6 D,3* A,8* H,4* E,3 G,5 B,5 C,3 CPM – Critical Path Method (cont.) * task time after crashing Any additional cost reductions possible? Overall improvement = ______________________________
