  1. Raw and Finished Water System ImprovementsApril 22, 2014

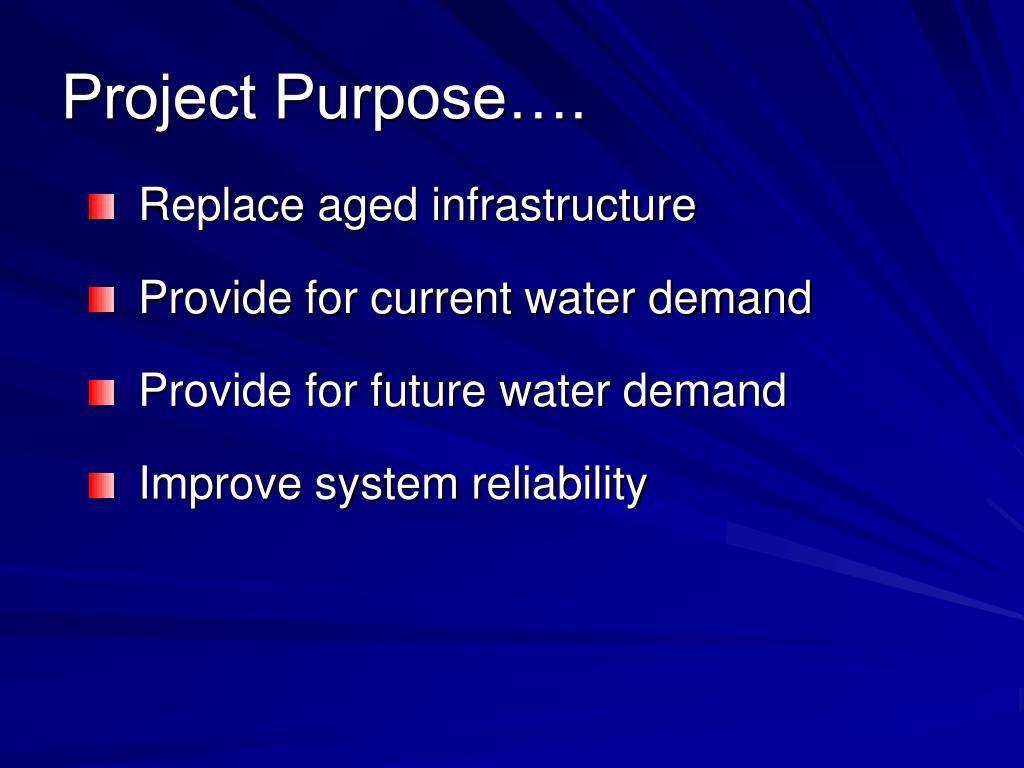

  2. Project Purpose…. • Replace aged infrastructure • Provide for current water demand • Provide for future water demand • Improve system reliability

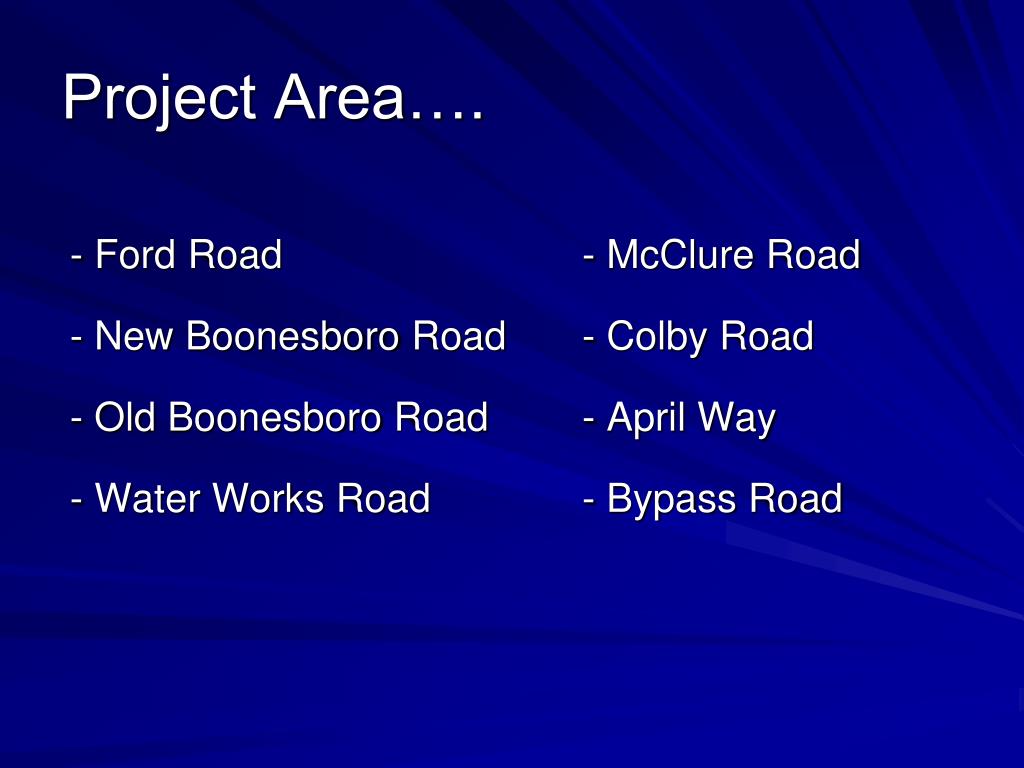

  3. Project Area…. - Ford Road - McClure Road - New Boonesboro Road - Colby Road - Old Boonesboro Road - April Way - Water Works Road - Bypass Road

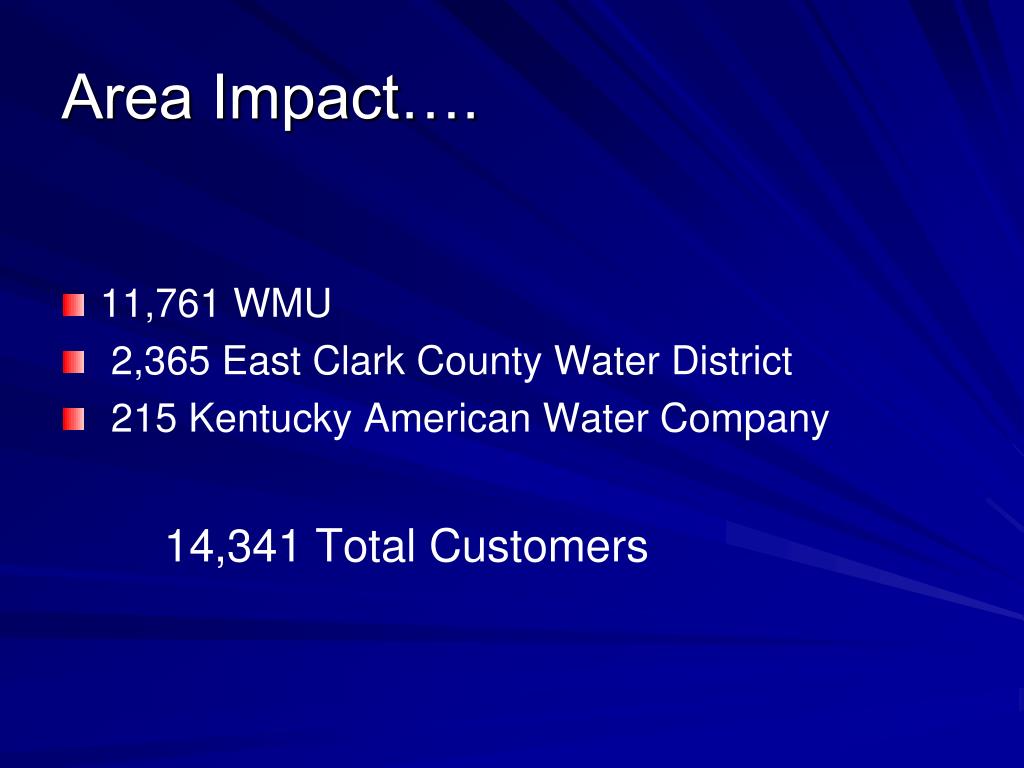

  4. Area Impact…. • 11,761 WMU • 2,365 East Clark County Water District • 215 Kentucky American Water Company 14,341 Total Customers

  5. Scope of Work…. • 12,000’ of 24” Ductile Iron Raw Water Line • 36,000’ of 24” Ductile Iron Finished Water Line • KY Raw Water Intake and Pump Station Improvements • In total 9 miles of large diameter raw and finished water transmission lines

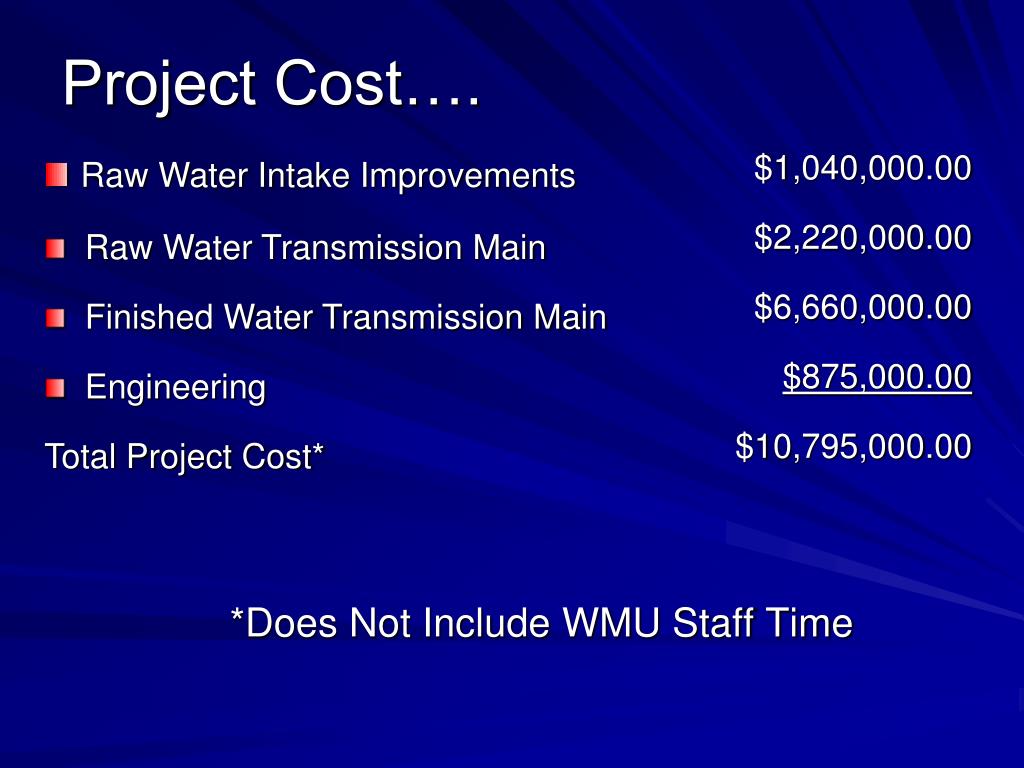

  6. Project Cost…. *Does Not Include WMU Staff Time

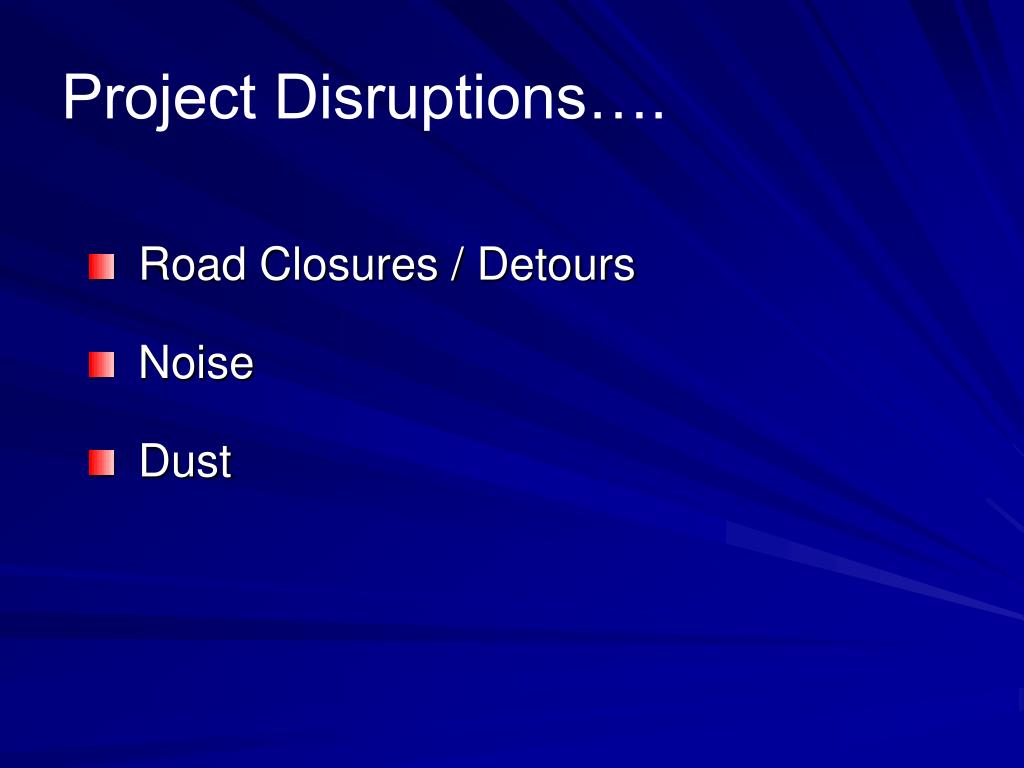

  7. Project Disruptions…. • Road Closures / Detours • Noise • Dust

  8. Easements…. • Temporary and Permanent Easements Required New easement – Not in flood plain – $4.00/ft. New easement – In the flood plain – $3.00/ft. Existing easement (Increase width) – $2.00/ft. Temporary (all) – $1.00/ft. *Any variance from this payment schedule will require authorization from the WMU Commission.

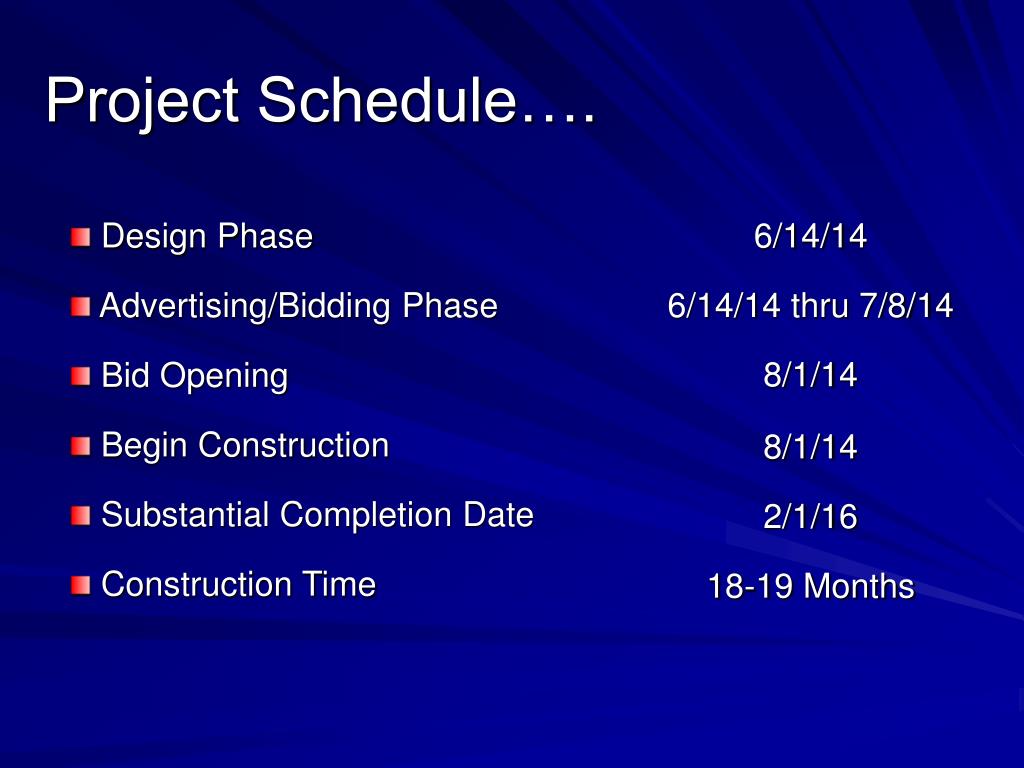

  9. Project Schedule….

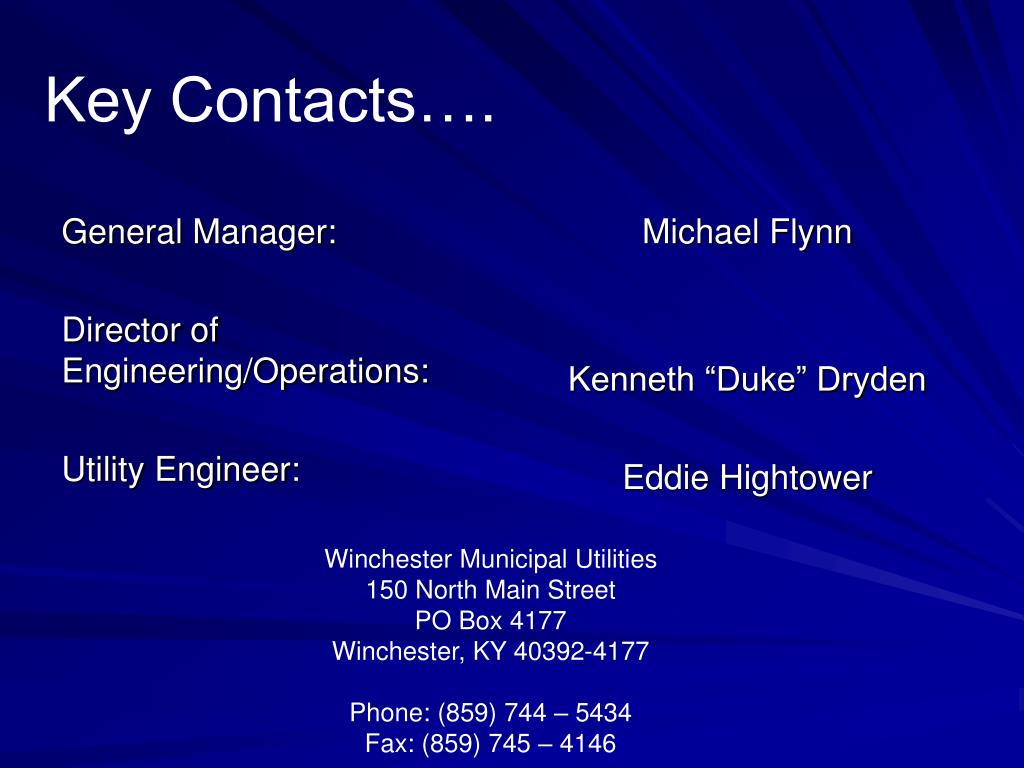

  10. Key Contacts…. Winchester Municipal Utilities 150 North Main Street PO Box 4177 Winchester, KY 40392-4177 Phone: (859) 744 – 5434 Fax: (859) 745 – 4146
