The existing HVRT guidelines for Wind Generation Resources (WGRs) in ERCOT specify a limit of 1.1 pu, which has raised compliance issues as developers assess their capabilities against these standards. Ongoing studies indicate that voltage swings may exceed this limit under specific contingencies. A new NERC HVRT standard (PRC-024) is pending approval from FERC, proposing a phased implementation over five years. Clear criteria for compliance evaluation and an understanding of voltage issues in the ERCOT Panhandle are crucial as industry adapts to new standards.
E N D

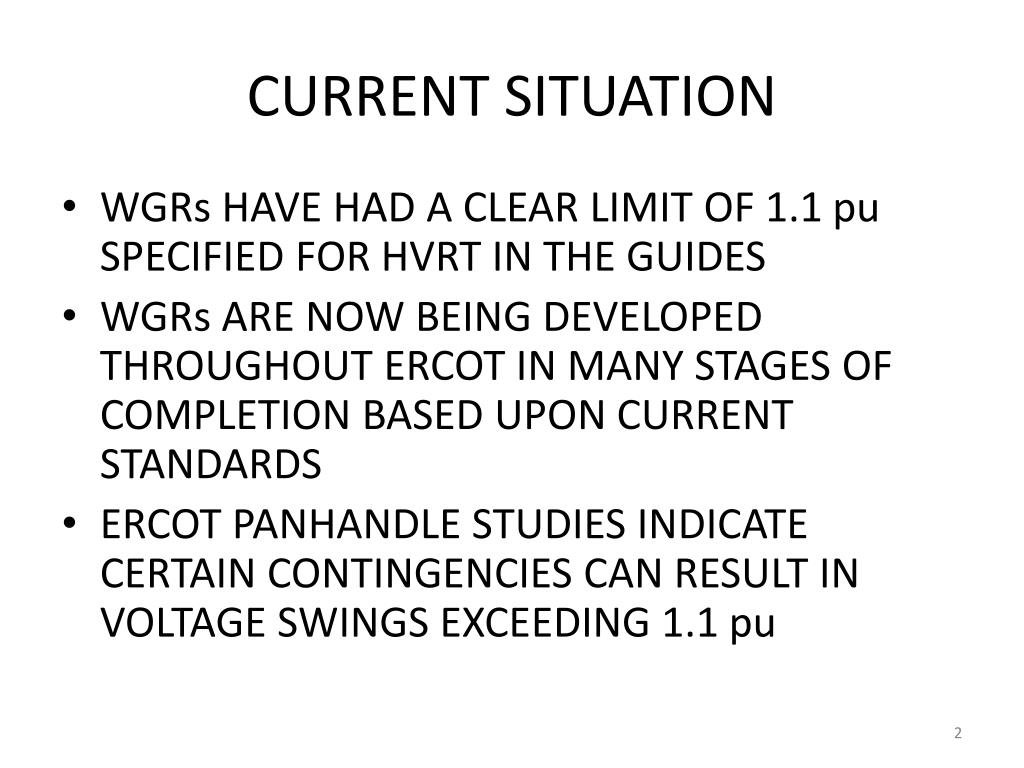

CURRENT SITUATION • WGRs HAVE HAD A CLEAR LIMIT OF 1.1 pu SPECIFIED FOR HVRT IN THE GUIDES • WGRs ARE NOW BEING DEVELOPED THROUGHOUT ERCOT IN MANY STAGES OF COMPLETION BASED UPON CURRENT STANDARDS • ERCOT PANHANDLE STUDIES INDICATE CERTAIN CONTINGENCIES CAN RESULT IN VOLTAGE SWINGS EXCEEDING 1.1 pu

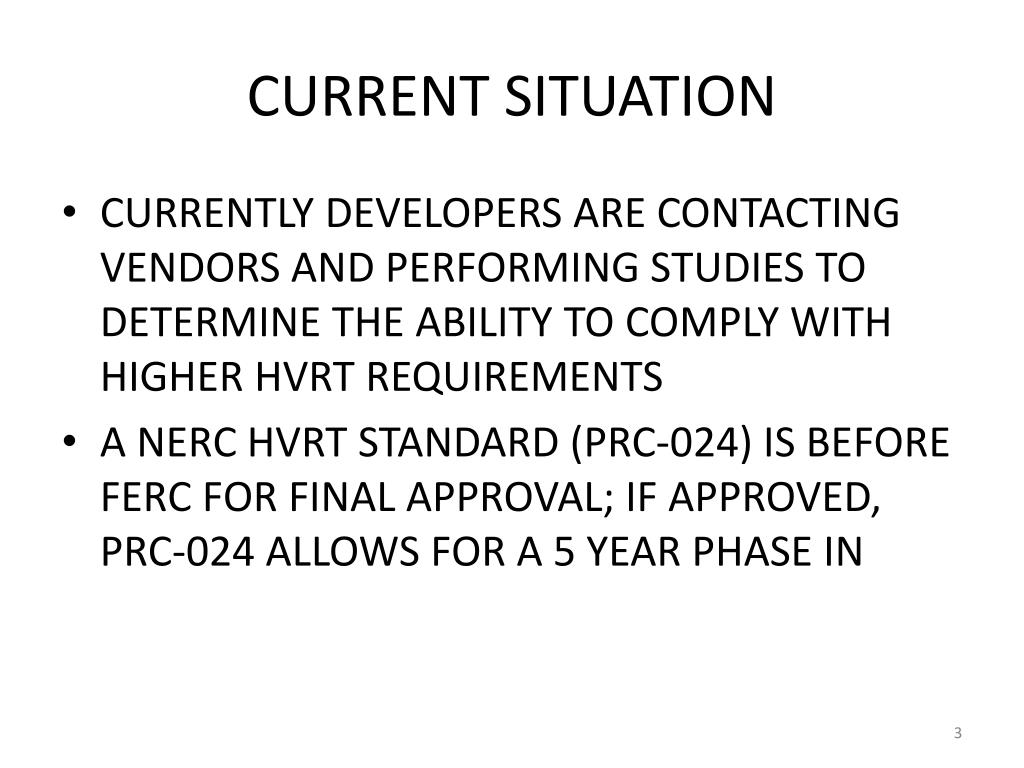

CURRENT SITUATION • CURRENTLY DEVELOPERS ARE CONTACTING VENDORS AND PERFORMING STUDIES TO DETERMINE THE ABILITY TO COMPLY WITH HIGHER HVRT REQUIREMENTS • A NERC HVRT STANDARD (PRC-024) IS BEFORE FERC FOR FINAL APPROVAL; IF APPROVED, PRC-024 ALLOWS FOR A 5 YEAR PHASE IN
KEY ISSUES/QUESTIONS • IT IS NOT CLEAR WHY THE CURRENT HVRT STANDARDS ARE NOT WORKABLE • DEVELOPERS MAKE SIGNIFICANT COMMITMENTS WELL BEFORE THEY SIGN THE SGIA MAKING UNTIMELY CHANGES COSTLY • THE COMPLETED TSP FISs IN THE PANHANDLE DO NOT INDICATE ANY VOLTAGE SWING PROBLEMS

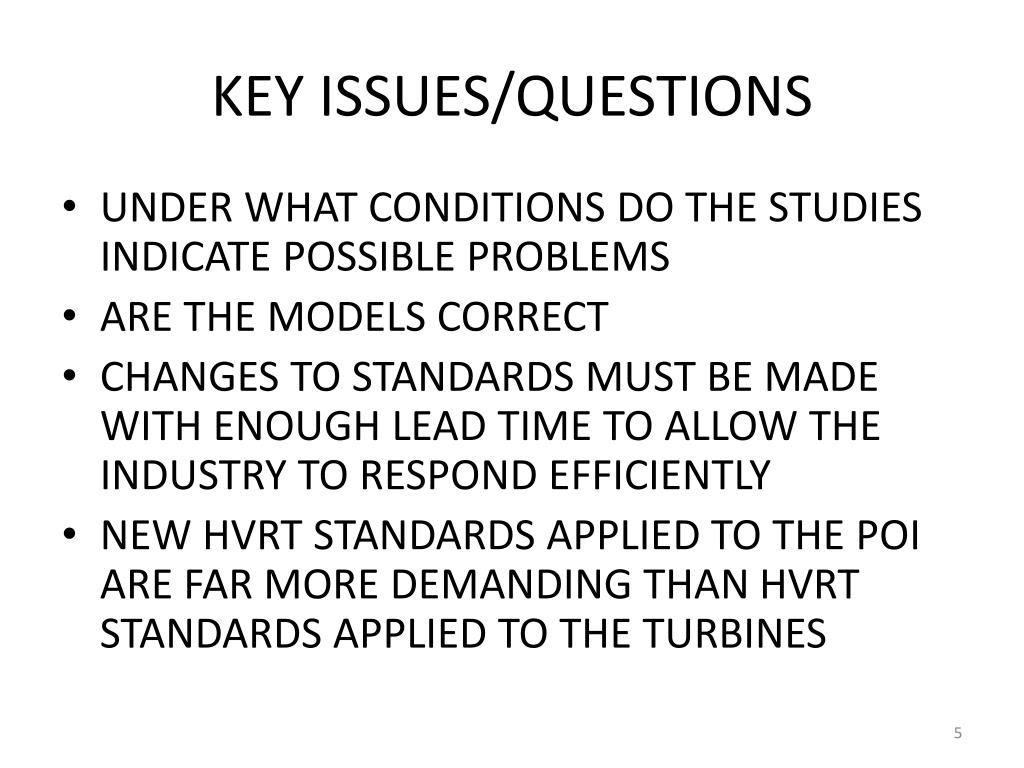

KEY ISSUES/QUESTIONS • UNDER WHAT CONDITIONS DO THE STUDIES INDICATE POSSIBLE PROBLEMS • ARE THE MODELS CORRECT • CHANGES TO STANDARDS MUST BE MADE WITH ENOUGH LEAD TIME TO ALLOW THE INDUSTRY TO RESPOND EFFICIENTLY • NEW HVRT STANDARDS APPLIED TO THE POI ARE FAR MORE DEMANDING THAN HVRT STANDARDS APPLIED TO THE TURBINES

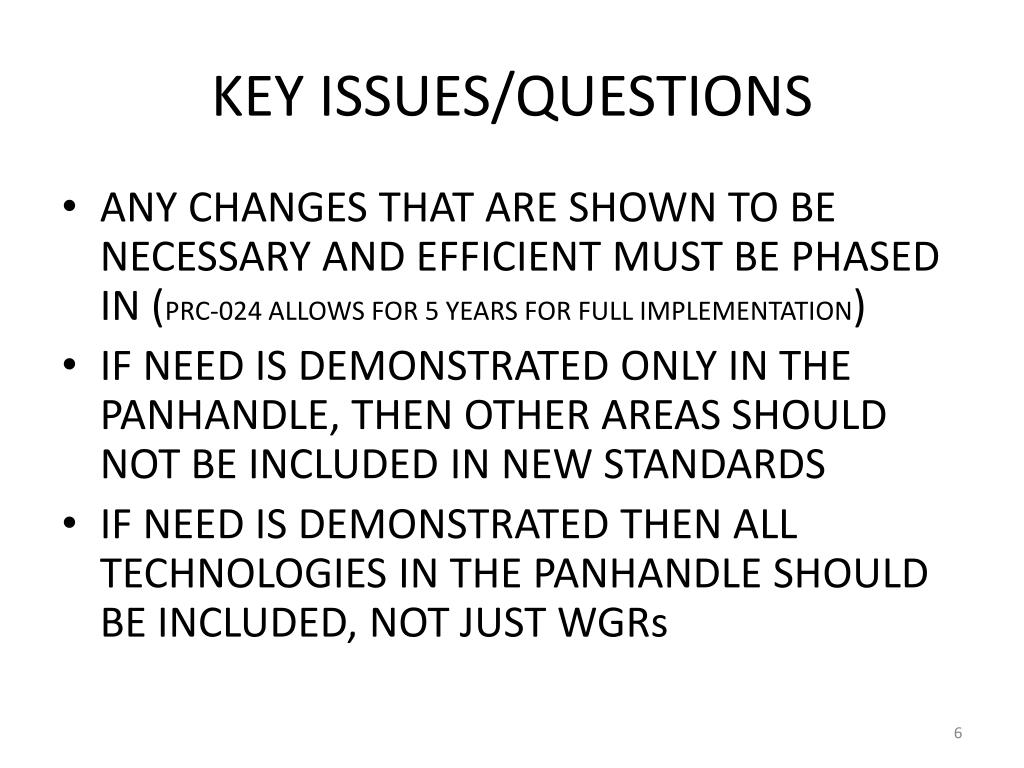

KEY ISSUES/QUESTIONS • ANY CHANGES THAT ARE SHOWN TO BE NECESSARY AND EFFICIENT MUST BE PHASED IN (PRC-024 ALLOWS FOR 5 YEARS FOR FULL IMPLEMENTATION) • IF NEED IS DEMONSTRATED ONLY IN THE PANHANDLE, THEN OTHER AREAS SHOULD NOT BE INCLUDED IN NEW STANDARDS • IF NEED IS DEMONSTRATED THEN ALL TECHNOLOGIES IN THE PANHANDLE SHOULD BE INCLUDED, NOT JUST WGRs

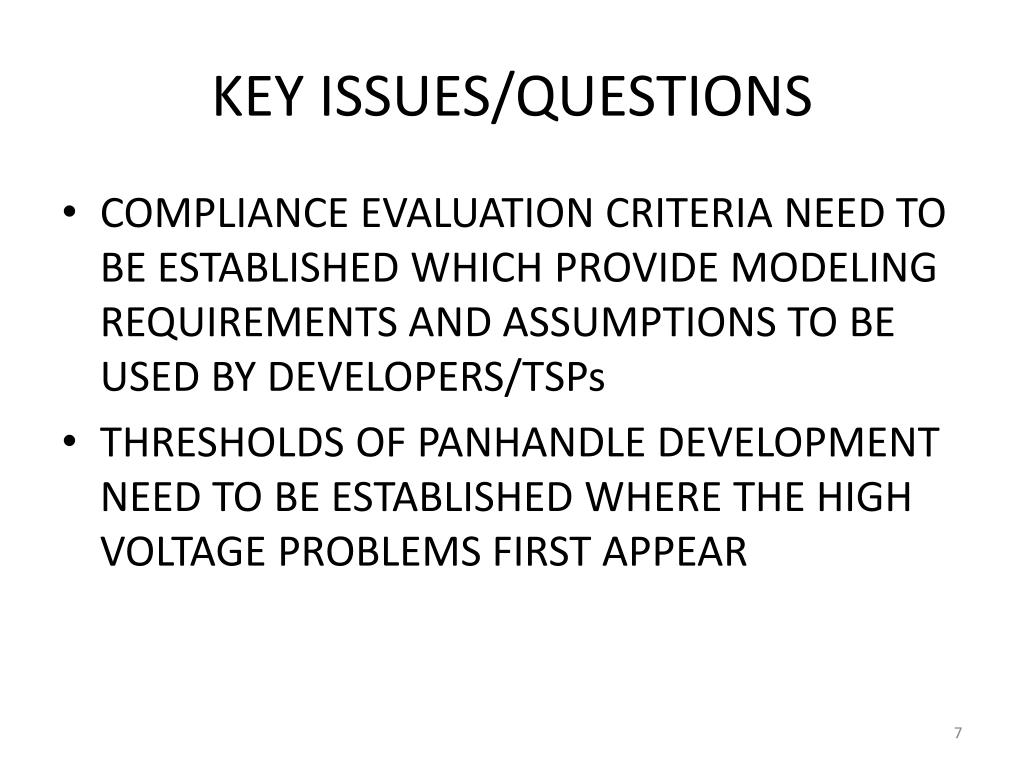

KEY ISSUES/QUESTIONS • COMPLIANCE EVALUATION CRITERIA NEED TO BE ESTABLISHED WHICH PROVIDE MODELING REQUIREMENTS AND ASSUMPTIONS TO BE USED BY DEVELOPERS/TSPs • THRESHOLDS OF PANHANDLE DEVELOPMENT NEED TO BE ESTABLISHED WHERE THE HIGH VOLTAGE PROBLEMS FIRST APPEAR

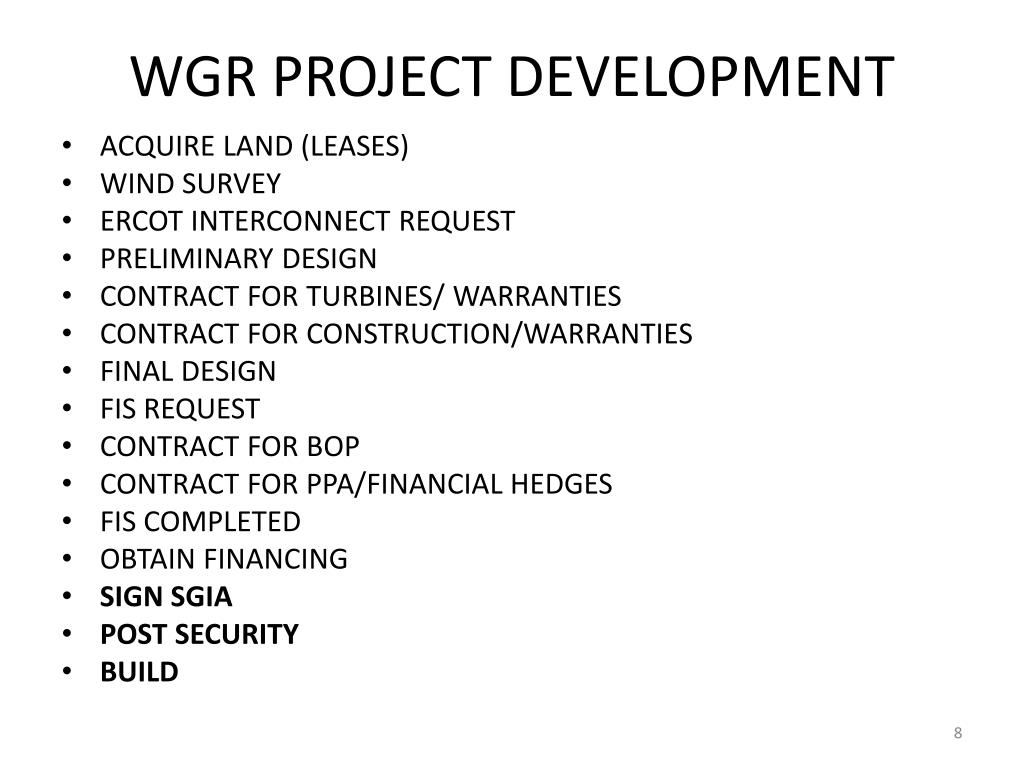

WGR PROJECT DEVELOPMENT • ACQUIRE LAND (LEASES) • WIND SURVEY • ERCOT INTERCONNECT REQUEST • PRELIMINARY DESIGN • CONTRACT FOR TURBINES/ WARRANTIES • CONTRACT FOR CONSTRUCTION/WARRANTIES • FINAL DESIGN • FIS REQUEST • CONTRACT FOR BOP • CONTRACT FOR PPA/FINANCIAL HEDGES • FIS COMPLETED • OBTAIN FINANCING • SIGN SGIA • POST SECURITY • BUILD
