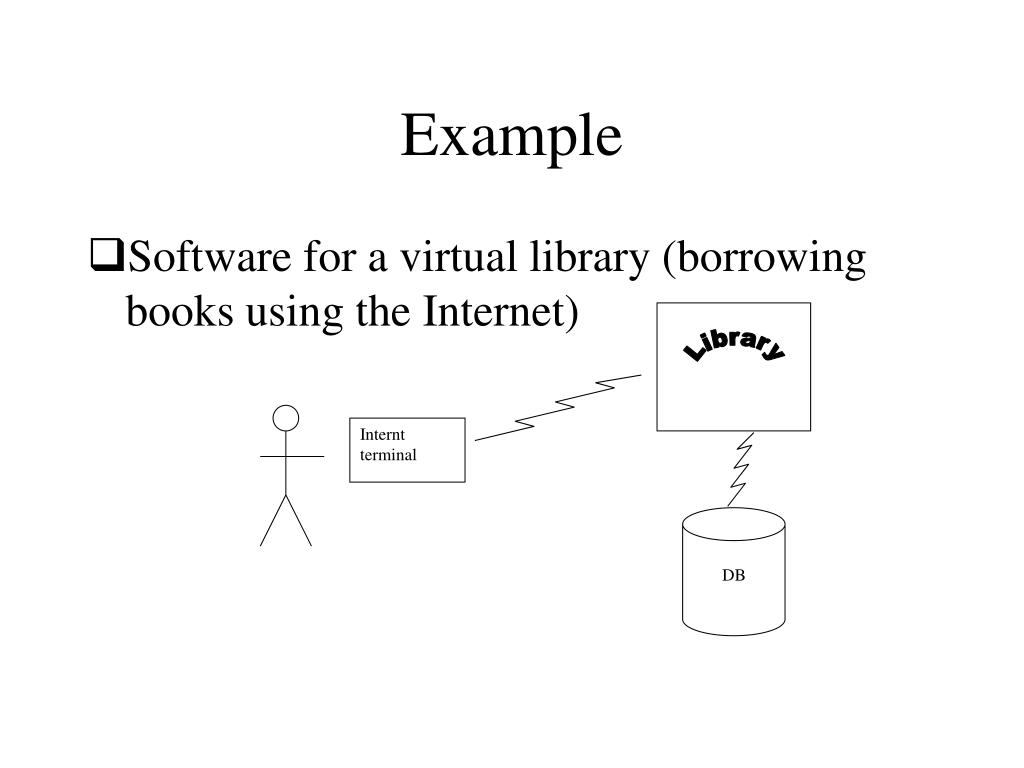

  1. Library Internt terminal DB Example • Software for a virtual library (borrowing books using the Internet)

  2. Preferences • You have a team of 2 people • First deliverance after 3 months • Develop software for: • User Interface • User – library communication • Database • Administration • Use iterative implementation • Final release after 8 months

  3. Main activities • Requirement analysis and definition • System design • User interface • Design • Implementation • User – library communication • Design • Implementation • Database • Design • Implementation • Administration • Design • Implementation • System integration • Testing • Deliverance

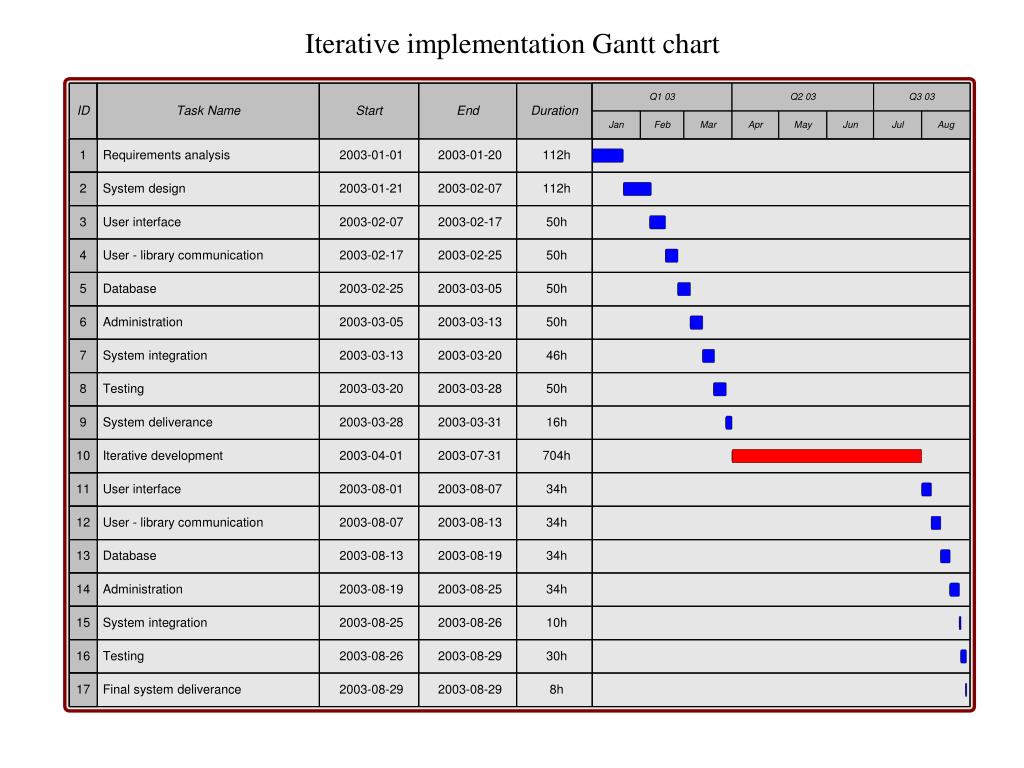

  4. Iterative implementation Gantt chart
