1 / 20

Accelerating the project

Accelerating the project. Edina Nagy Lajos Kiss Szabolcs Hornyák. Overview. Introduction Project acceleration terminology Normal Time, normal cost Crash Time, crash cost Direct Costs Indirect Costs Total Project Cost Optimum Project Duration Project acceleration principles

cade
Télécharger la présentation

Accelerating the project

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Acceleratingthe project Edina NagyLajos KissSzabolcs Hornyák

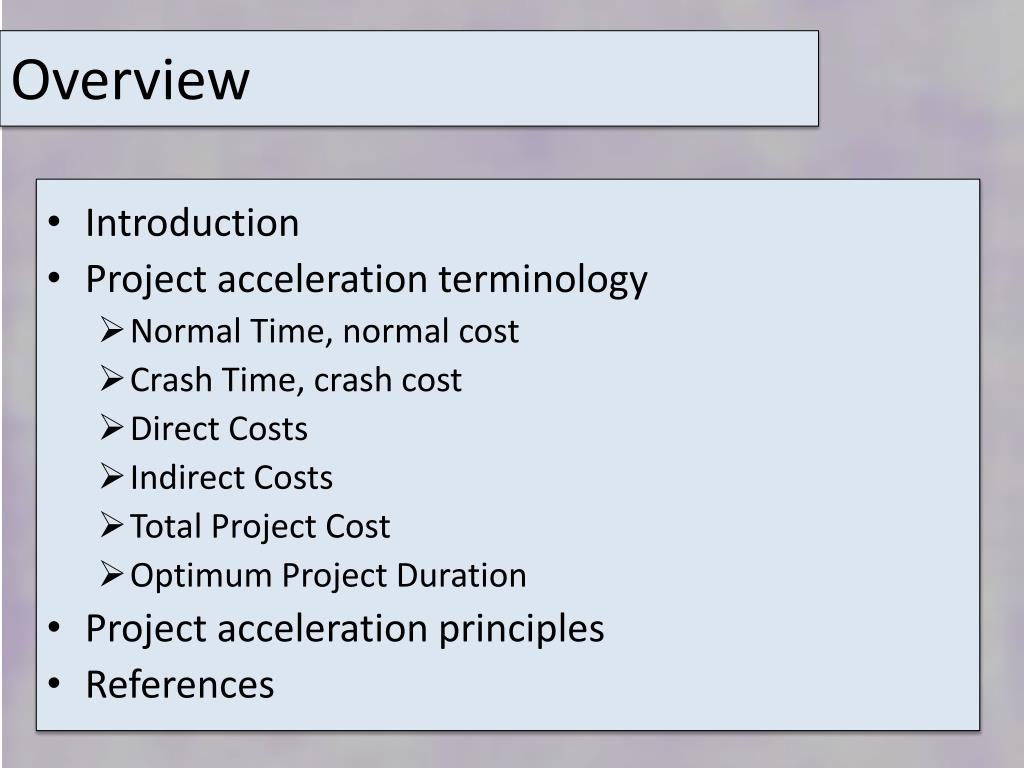

  2. Overview • Introduction • Project accelerationterminology • Normal Time, normalcost • Crash Time, crashcost • DirectCosts • IndirectCosts • Total Project Cost • Optimum Project Duration • Project accelerationprinciples • References

  3. Introduction „When I knowallinformation, only canmake aright decisions.” Paulo Coelho

  4. Introduction • Steps of right decision: • Definiate: Time and costs • Analysedthepossibilities • Comparetheopportunities • Choosethebestway

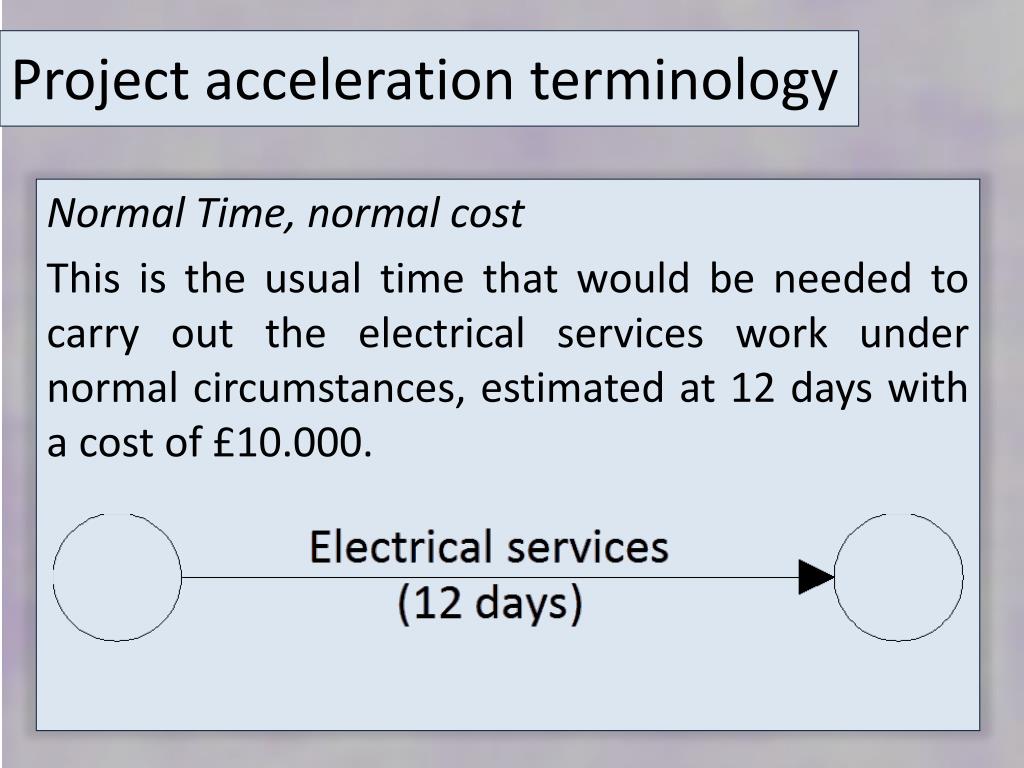

  5. Project accelerationterminology Normal Time, normalcost Thisis theusualtimethatwould be neededtocarry out theelectricalservicesworkundernormalcircumstances, estimatedat 12 dayswith a cost of £10.000.

  6. Project accelerationterminology Crash Time, crash cost The crash time is the maximum time the operation can be compressed by increasing the resources. Crash time: 8 days Crash cost: £18.000

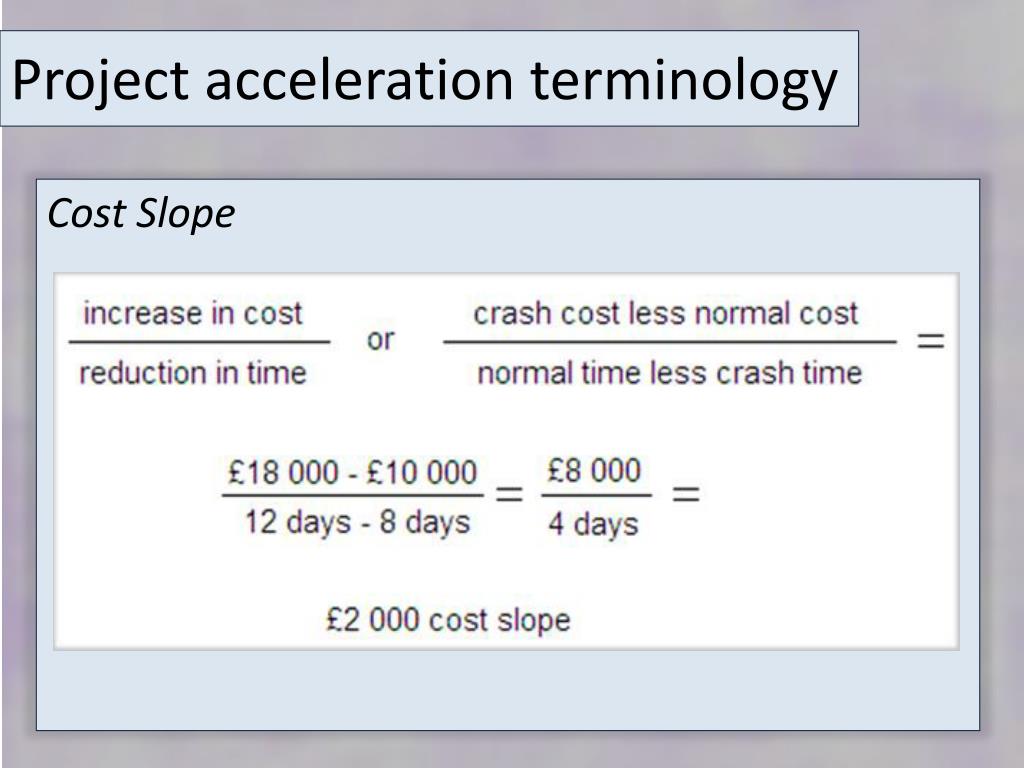

  7. Project accelerationterminology CostSlope

  8. Project accelerationterminology Activityranking • Analysedtheprecedencerelationship • Identifiedthecriticalactivities • Rankingbythecost • Reducetheduration • Definethecriticalpath

  9. Project accelerationterminology Directcosts: • Labour • Plants • Materials • Subcontractors • Overheads and profit

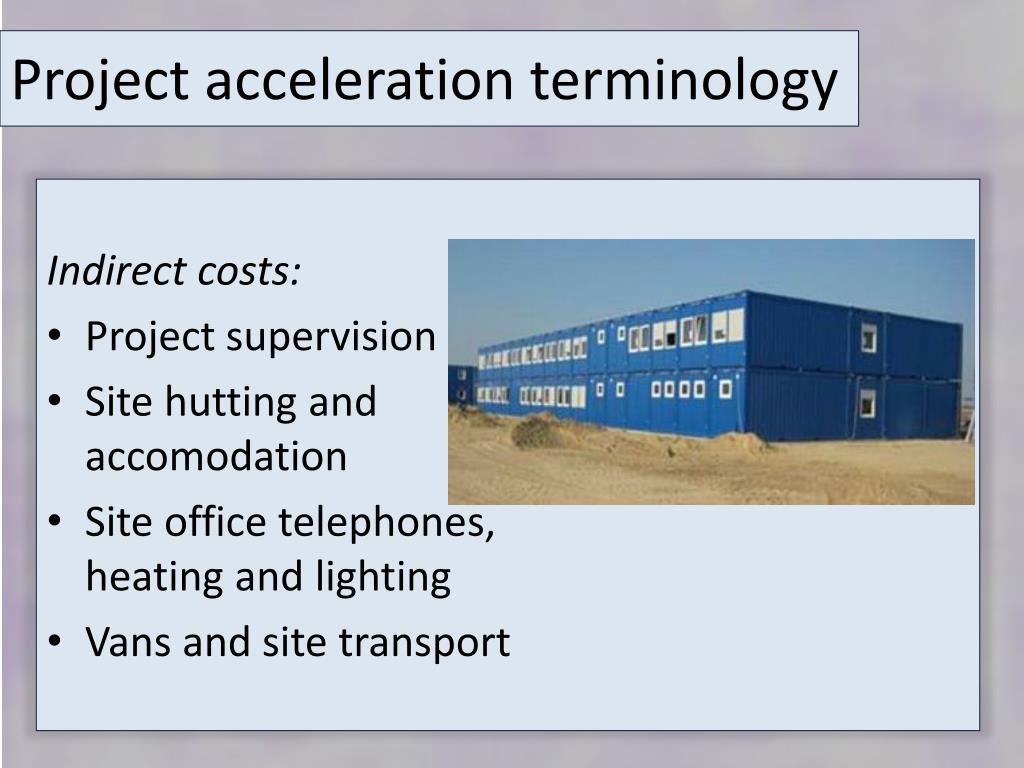

  10. Project accelerationterminology Indirectcosts: • Project supervision • Site hutting and accomodation • Site officetelephones,heating and lighting • Vans and site transport

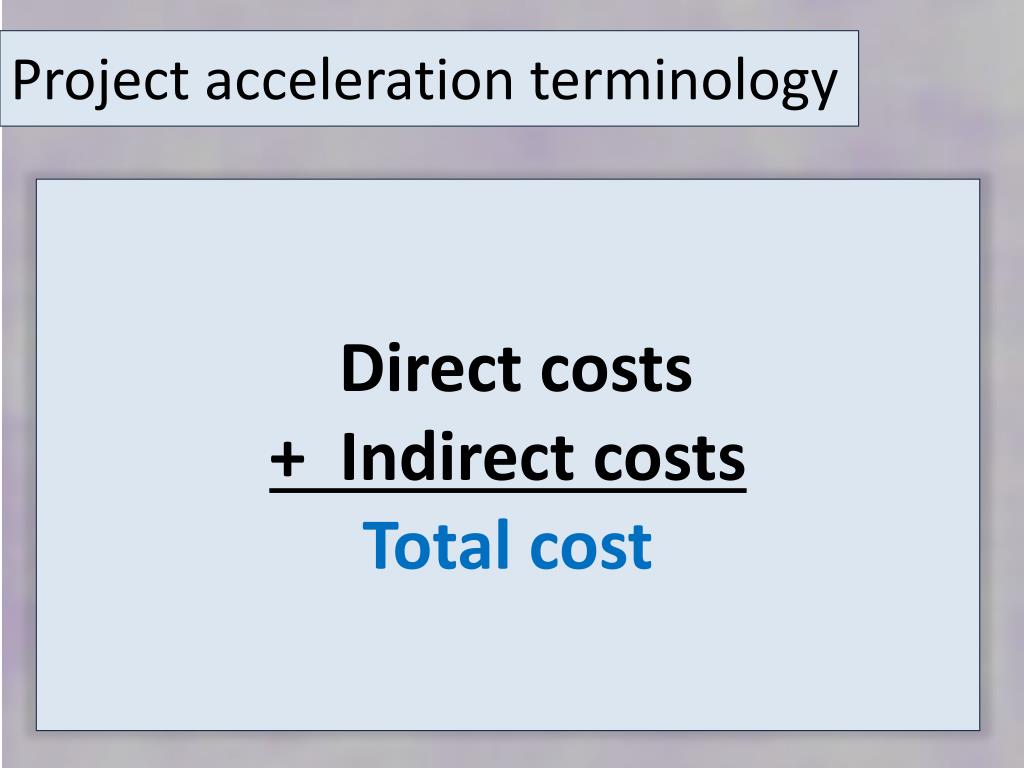

  11. Project accelerationterminology Directcosts + Indirectcosts Total cost

  12. Optimum project duration

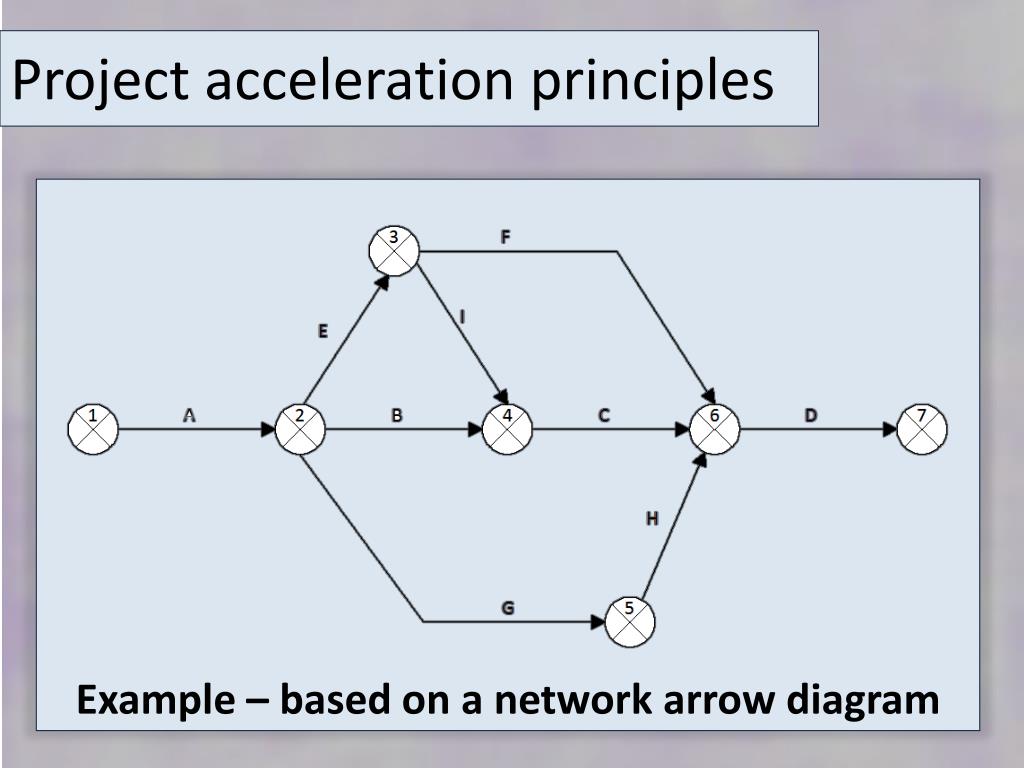

  13. Project accelerationprinciples Example – basedon a networkarrow diagram

  14. Project accelerationprinciples Project datas

  15. Project accelerationprinciples Normaltime / NormalCostanalysis

  16. Project accelerationprinciples Normaltime / NormalCostanalysis

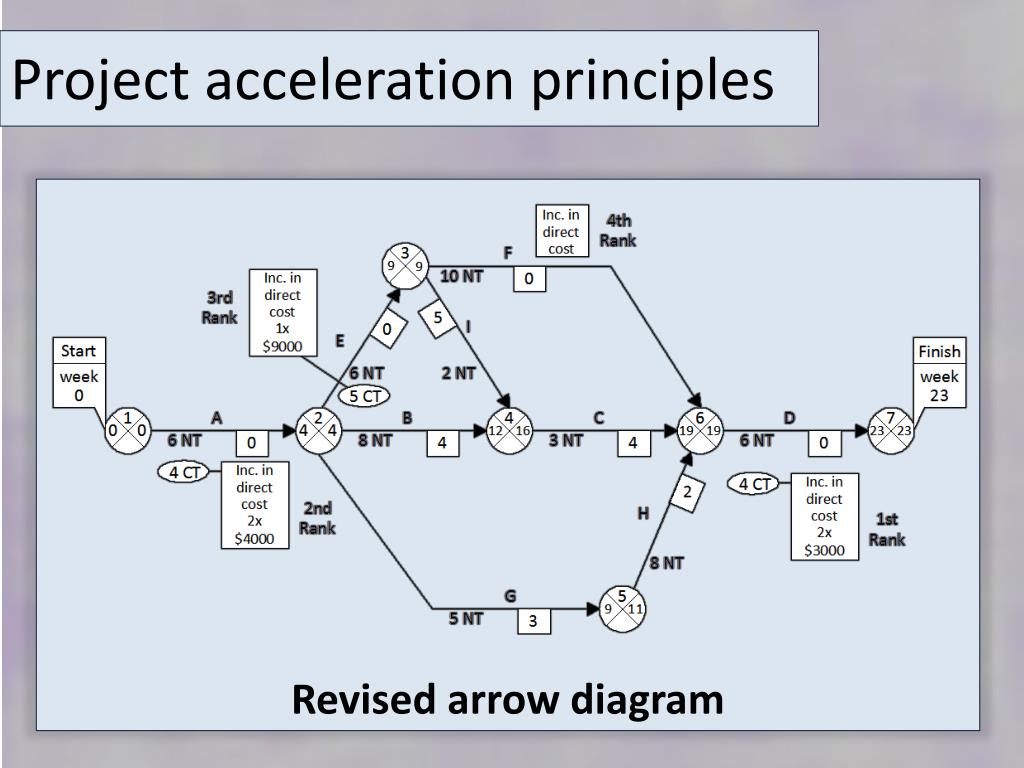

  17. Project accelerationprinciples Revisedarrow diagram

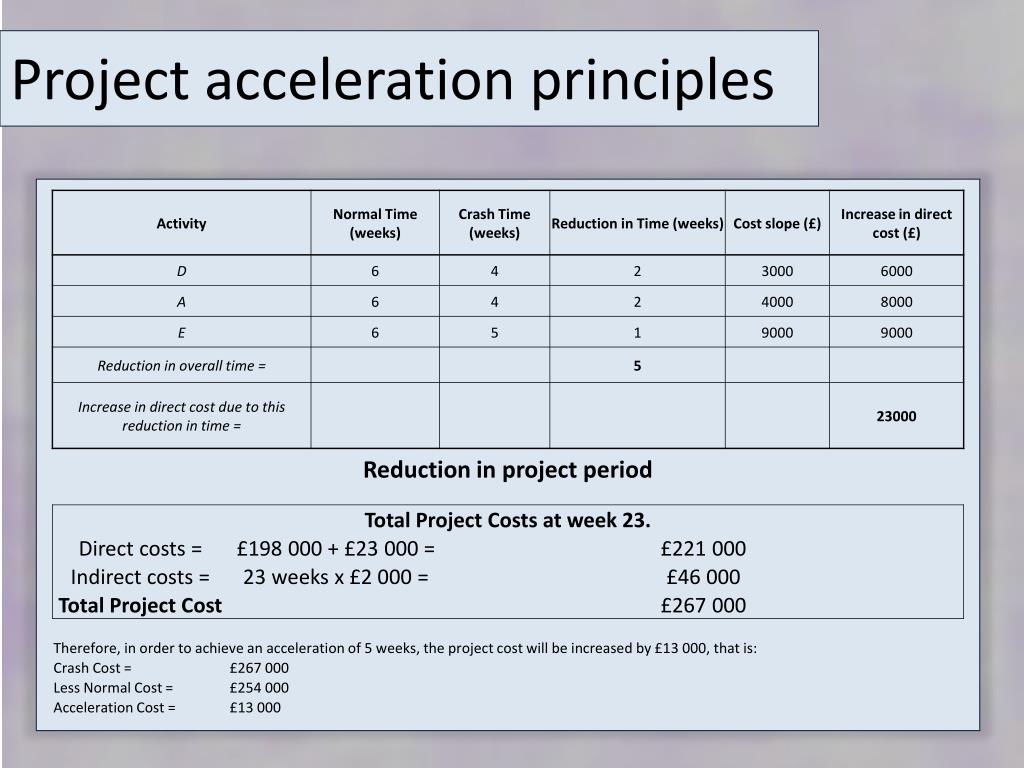

  18. Project accelerationprinciples Reduction in project period

  19. References - pp. 186-196Paragraph 9.9Acceleratingthe project

  20. Thanks…

More Related
