1 / 38

Session #7: Example Problem - Economics

HSM Roadway Safety Management Process. Session #7: Example Problem - Economics. HSM Exercise II & III – Economical Appraisal Process & Prioritizing Projects. Learning Outcomes:. Apply the Economic Appraisal Process to a Safety Countermeasure

cortez
Télécharger la présentation

Session #7: Example Problem - Economics

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. HSM Roadway Safety Management Process Session #7: Example Problem - Economics

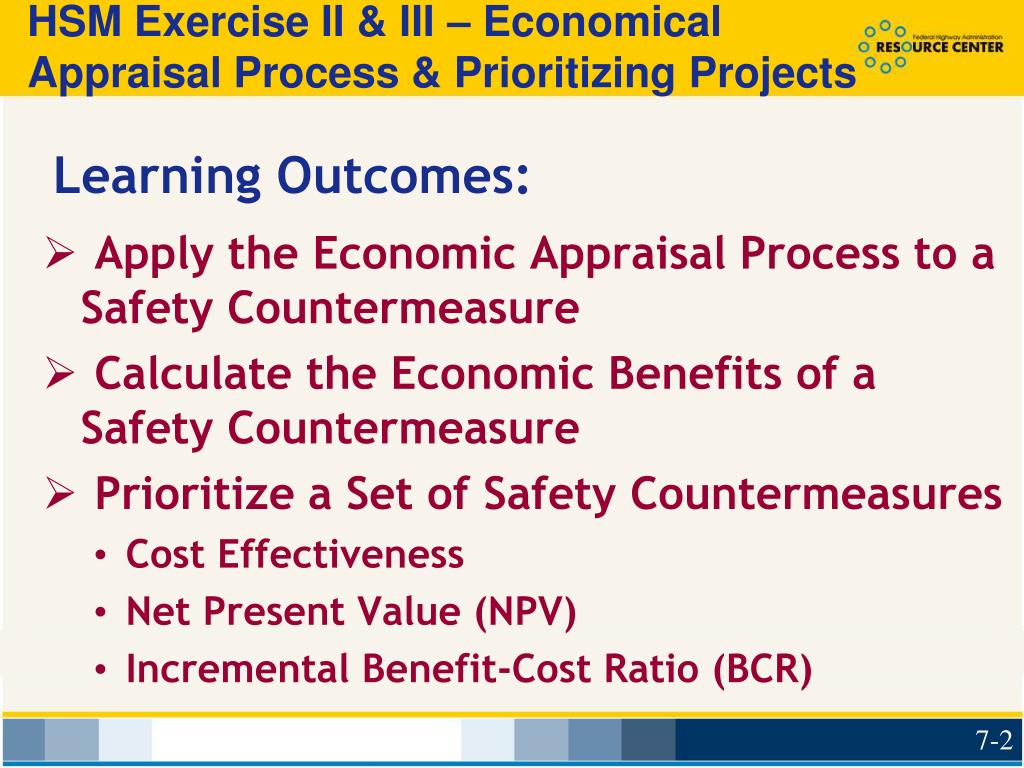

  2. HSM Exercise II & III – Economical Appraisal Process & Prioritizing Projects Learning Outcomes: • Apply the Economic Appraisal Process to a Safety Countermeasure • Calculate the Economic Benefits of a Safety Countermeasure • Prioritize a Set of Safety Countermeasures • Cost Effectiveness • Net Present Value (NPV) • Incremental Benefit-Cost Ratio (BCR)

  3. HSM Exercise II – Economical Appraisal Process Identified Safety Countermeasures for a Roadway Network to be Evaluated Table 8-3. Summary of Countermeasures

  4. HSM Exercise II – Economical Appraisal Process HSM Sample Problem 7.9Convert Two-Way Stop to Roundabout Intersection #2

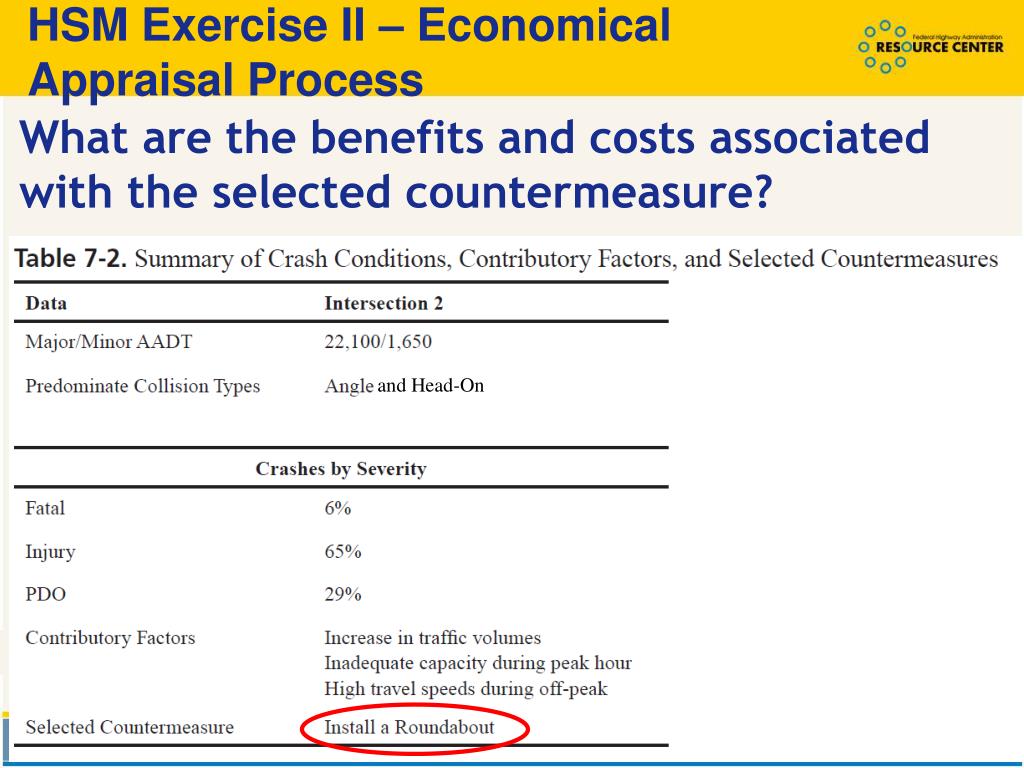

  5. HSM Exercise II – Economical Appraisal Process What are the benefits and costs associated with the selected countermeasure? and Head-On

  6. HSM Exercise II – Economical Appraisal Process FACTS - CMF for installing a single-lane roundabout in place of a two-way stop-controlled intersection: From HSM Chapter 14 • CMF Total Crashes = 0.56 • CMF Fatal & Injury Crashes = 0.18

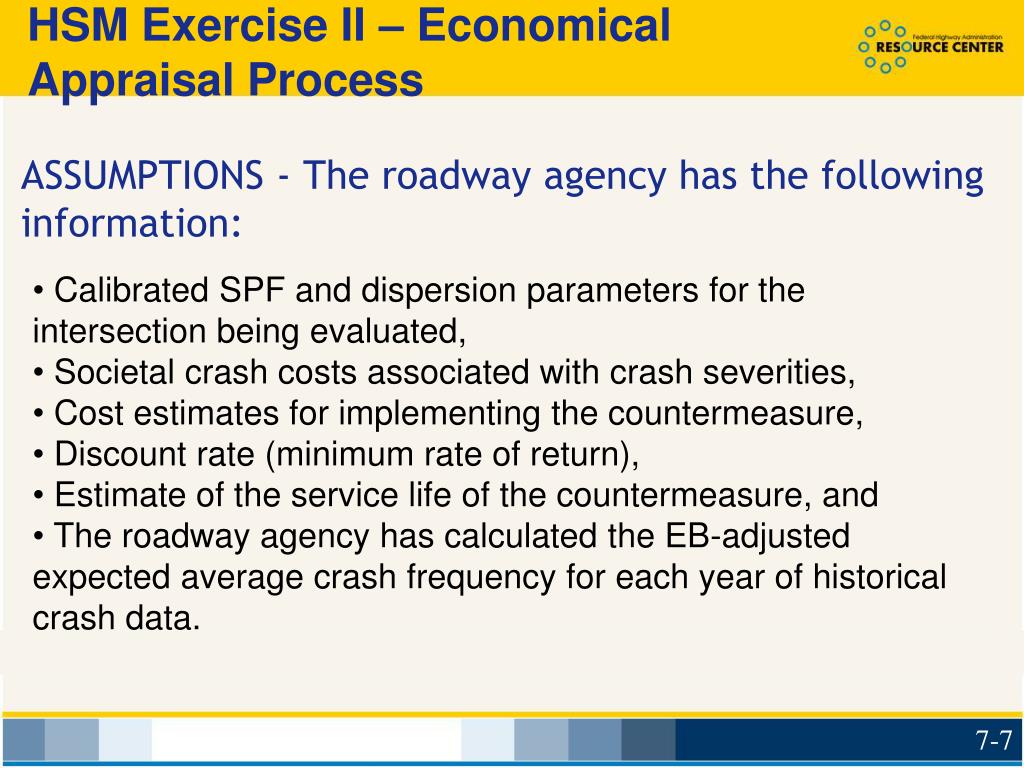

  7. HSM Exercise II – Economical Appraisal Process ASSUMPTIONS - The roadway agency has the following information: • Calibrated SPF and dispersion parameters for the intersection being evaluated, • Societal crash costs associated with crash severities, • Cost estimates for implementing the countermeasure, • Discount rate (minimum rate of return), • Estimate of the service life of the countermeasure, and • The roadway agency has calculated the EB-adjusted expected average crash frequency for each year of historical crash data.

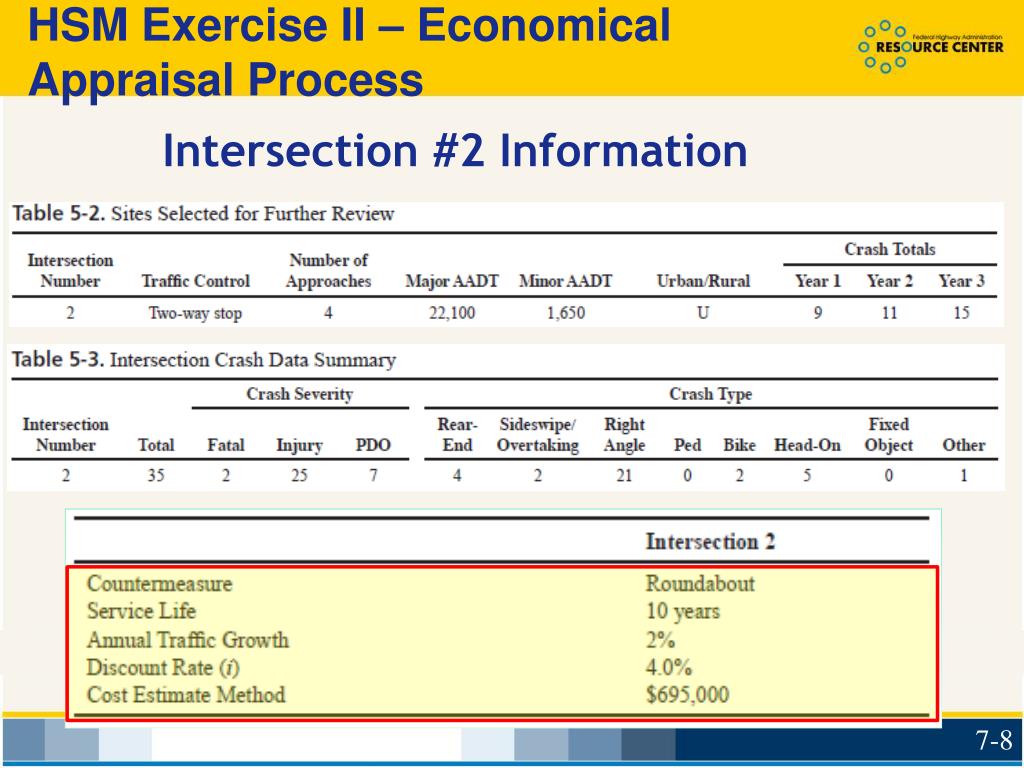

  8. HSM Exercise II – Economical Appraisal Process Intersection #2 Information

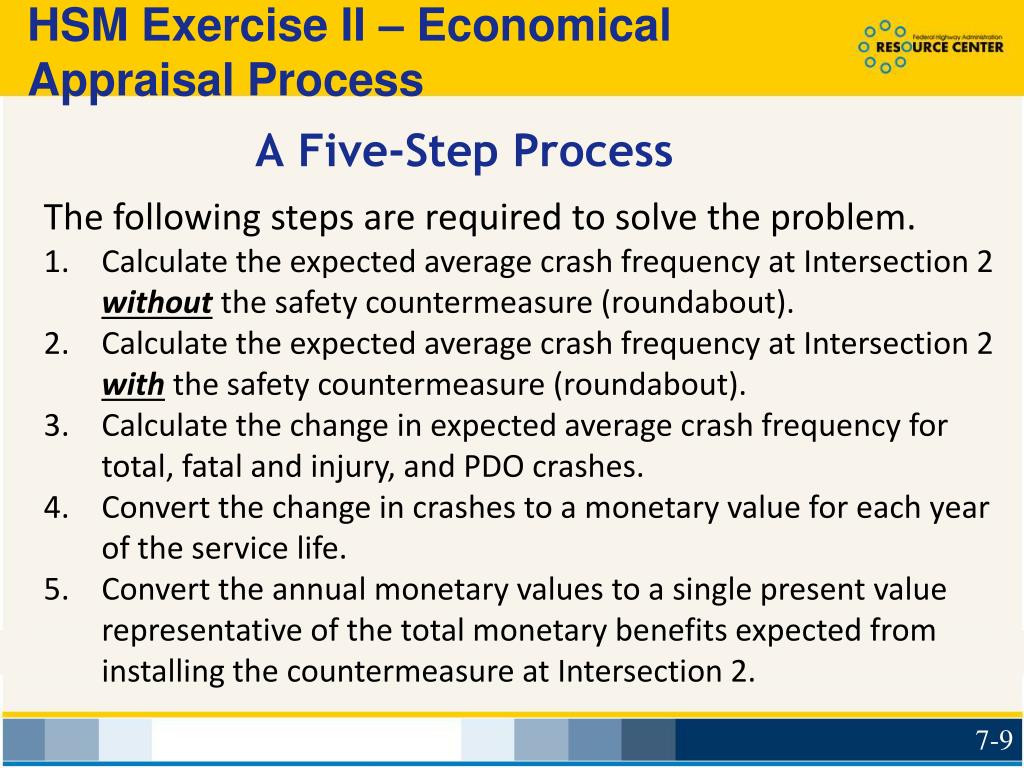

  9. HSM Exercise II – Economical Appraisal Process A Five-Step Process The following steps are required to solve the problem. Calculate the expected average crash frequency at Intersection 2 without the safety countermeasure (roundabout). Calculate the expected average crash frequency at Intersection 2 with the safety countermeasure (roundabout). Calculate the change in expected average crash frequency for total, fatal and injury, and PDO crashes. Convert the change in crashes to a monetary value for each year of the service life. Convert the annual monetary values to a single present value representative of the total monetary benefits expected from installing the countermeasure at Intersection 2.

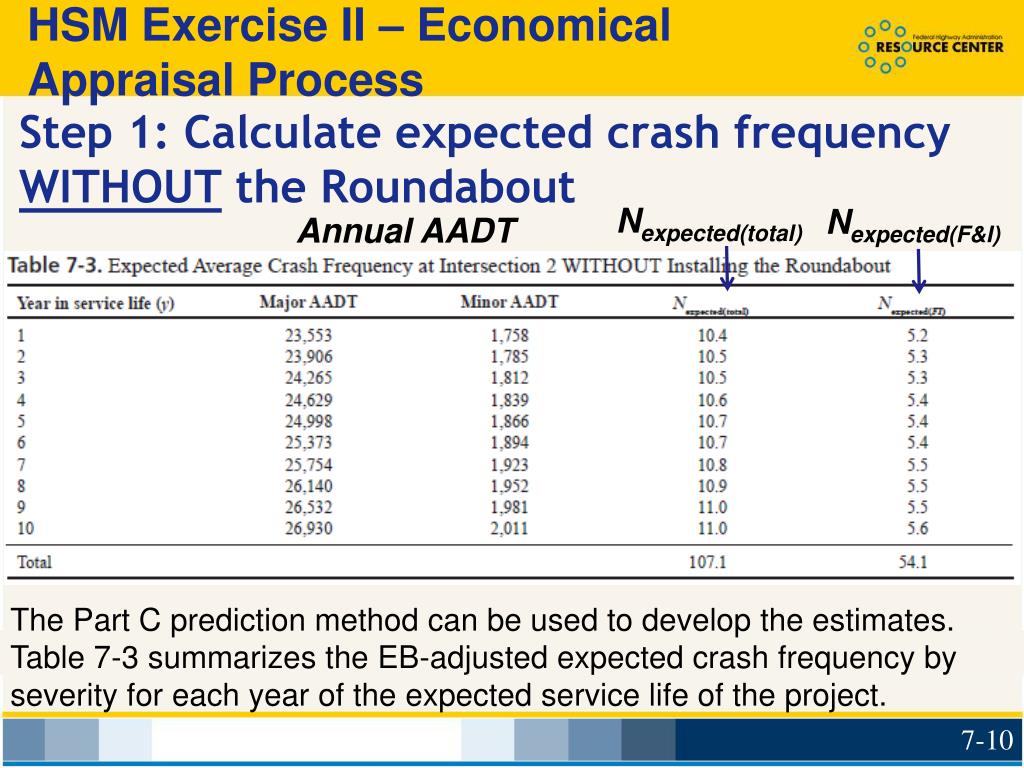

  10. HSM Exercise II – Economical Appraisal Process Step 1: Calculate expected crash frequency WITHOUT the Roundabout Nexpected(total) Nexpected(F&I) Annual AADT The Part C prediction method can be used to develop the estimates. Table 7-3 summarizes the EB-adjusted expected crash frequency by severity for each year of the expected service life of the project.

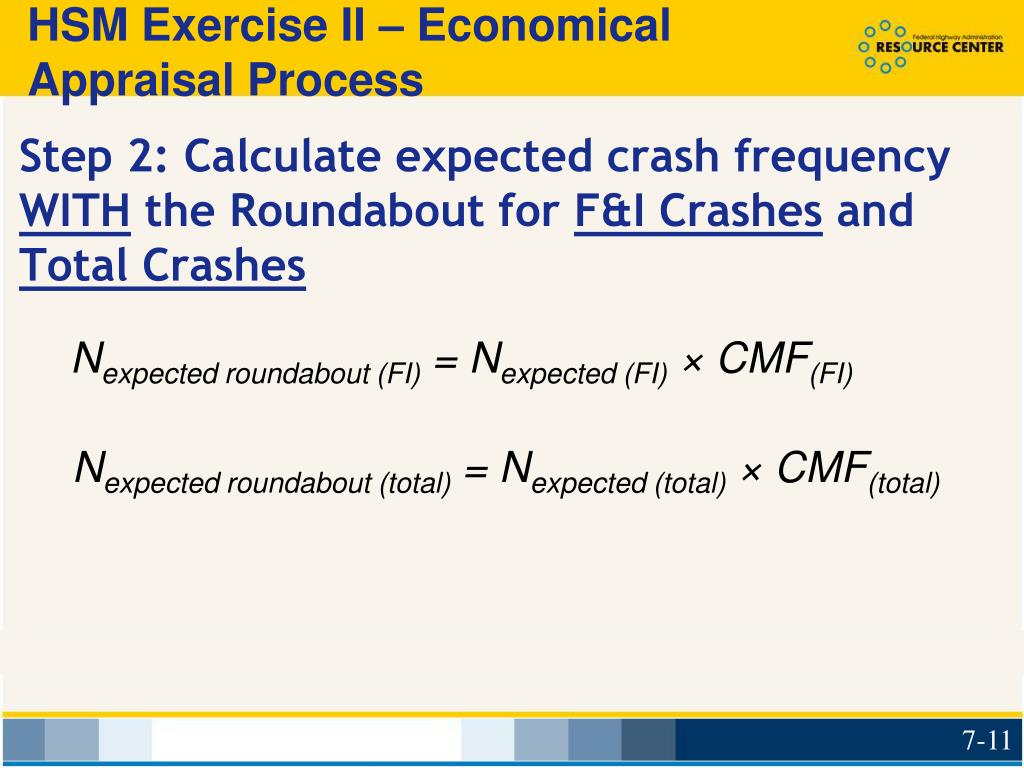

  11. HSM Exercise II – Economical Appraisal Process Step 2: Calculate expected crash frequency WITH the Roundabout for F&I Crashes and Total Crashes Nexpected roundabout (FI) = Nexpected (FI) × CMF(FI) Nexpected roundabout (total) = Nexpected (total) × CMF(total)

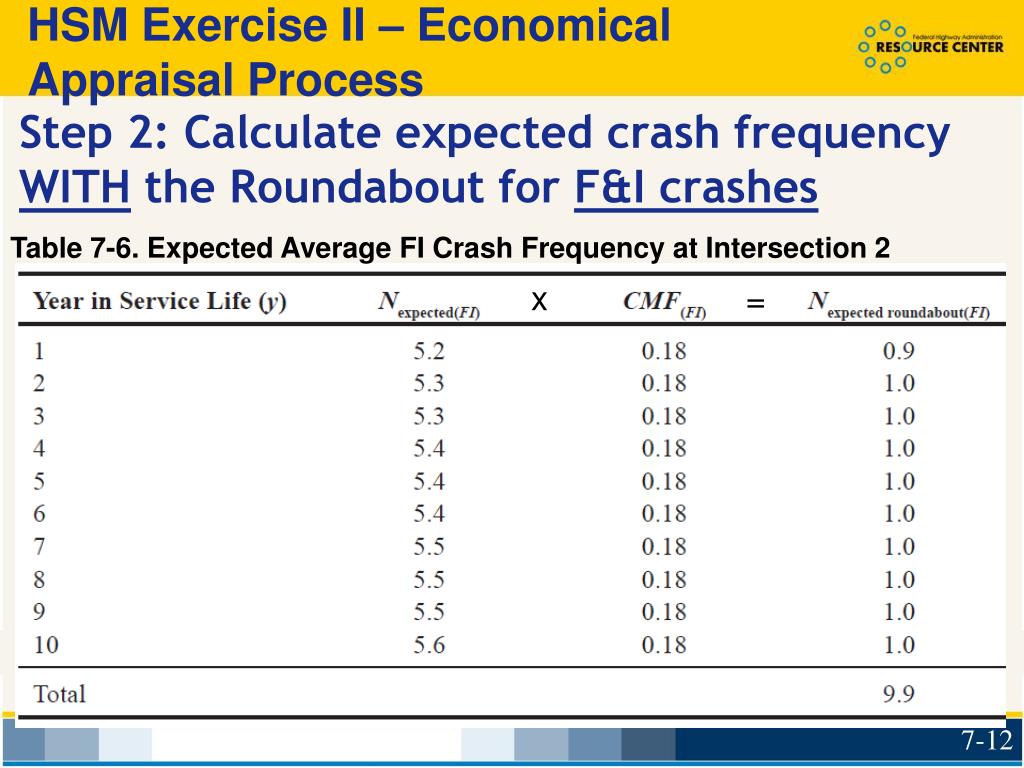

  12. HSM Exercise II – Economical Appraisal Process Step 2: Calculate expected crash frequency WITH the Roundabout for F&I crashes Table 7-6. Expected Average FI Crash Frequency at Intersection 2 x =

  13. HSM Exercise II – Economical Appraisal Process Step 2: Calculate expected crash frequency WITH the Roundabout for Total crashes Table 7-7. Expected Average Total Crash Frequency at Intersection 2 x =

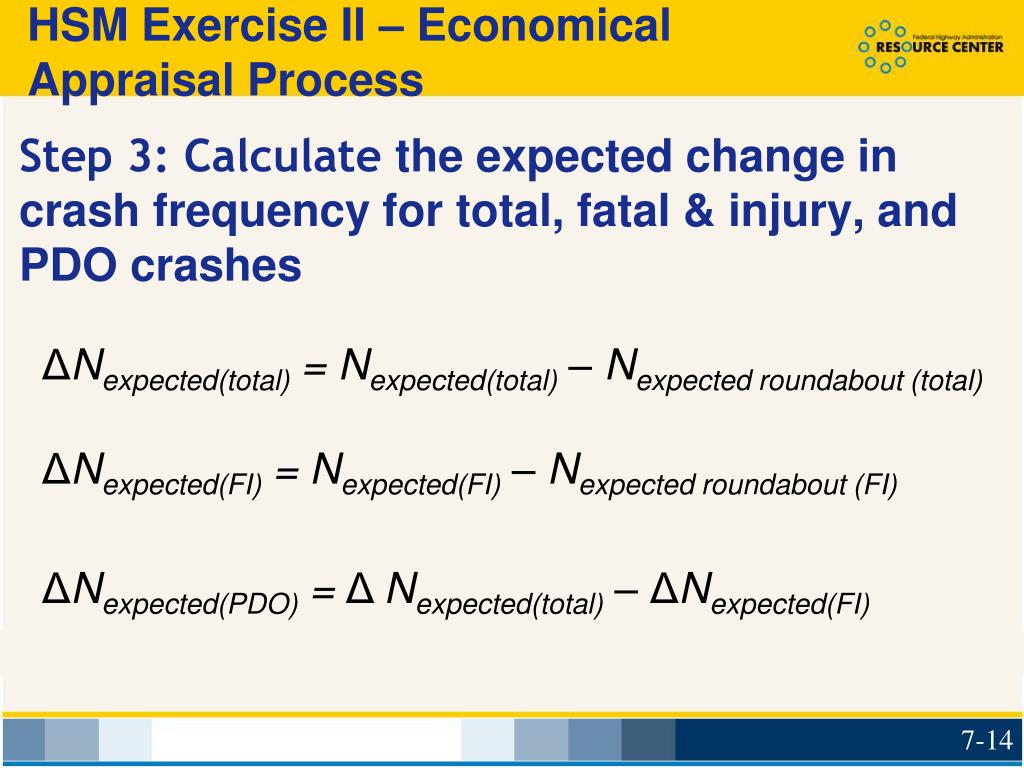

  14. HSM Exercise II – Economical Appraisal Process Step 3: Calculate the expected change in crash frequency for total, fatal & injury, and PDO crashes ΔNexpected(total) = Nexpected(total) – Nexpected roundabout (total) ΔNexpected(FI) = Nexpected(FI) – Nexpected roundabout (FI) ΔNexpected(PDO) = Δ Nexpected(total) – ΔNexpected(FI)

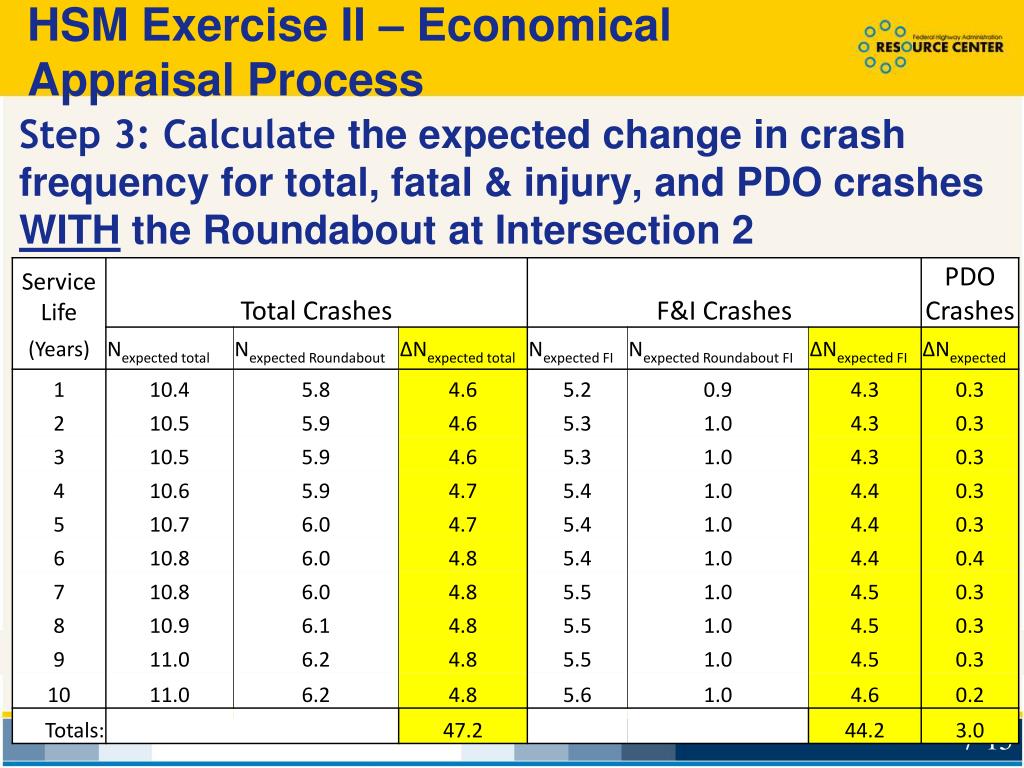

  15. HSM Exercise II – Economical Appraisal Process Step 3: Calculate the expected change in crash frequency for total, fatal & injury, and PDO crashes WITH the Roundabout at Intersection 2

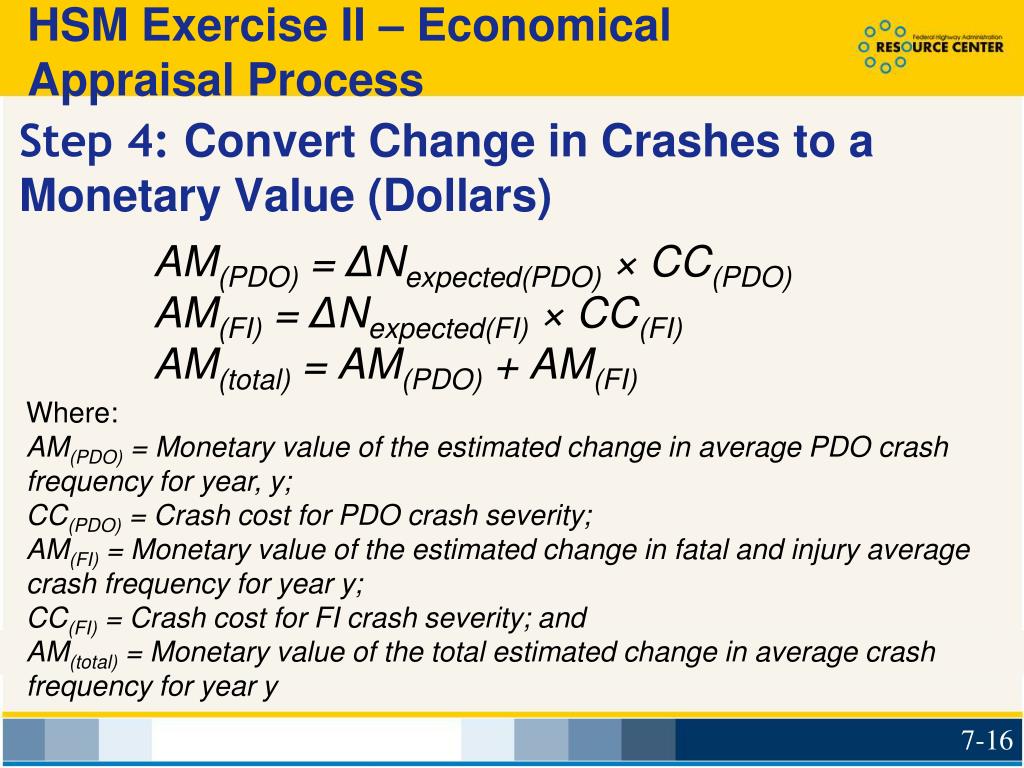

  16. HSM Exercise II – Economical Appraisal Process Step 4: Convert Change in Crashes to a Monetary Value (Dollars) AM(PDO) = ΔNexpected(PDO) × CC(PDO) AM(FI) = ΔNexpected(FI) × CC(FI) AM(total) = AM(PDO) + AM(FI) Where: AM(PDO) = Monetary value of the estimated change in average PDO crash frequency for year, y; CC(PDO) = Crash cost for PDO crash severity; AM(FI) = Monetary value of the estimated change in fatal and injury average crash frequency for year y; CC(FI) = Crash cost for FI crash severity; and AM(total) = Monetary value of the total estimated change in average crash frequency for year y

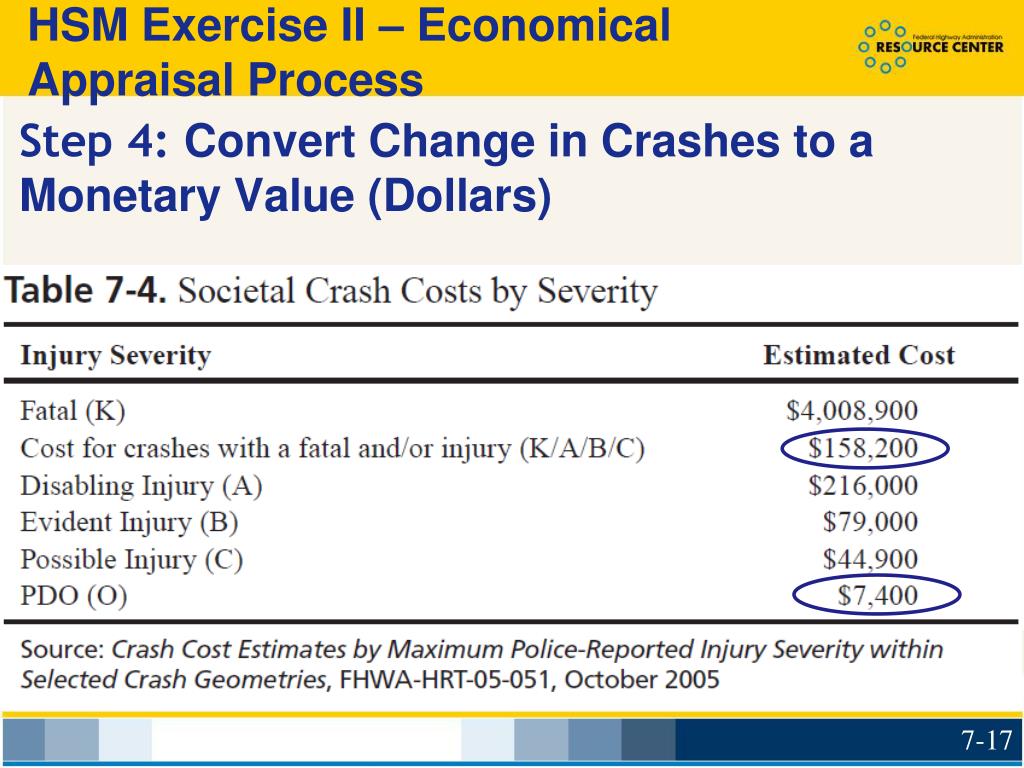

  17. HSM Exercise II – Economical Appraisal Process Step 4: Convert Change in Crashes to a Monetary Value (Dollars)

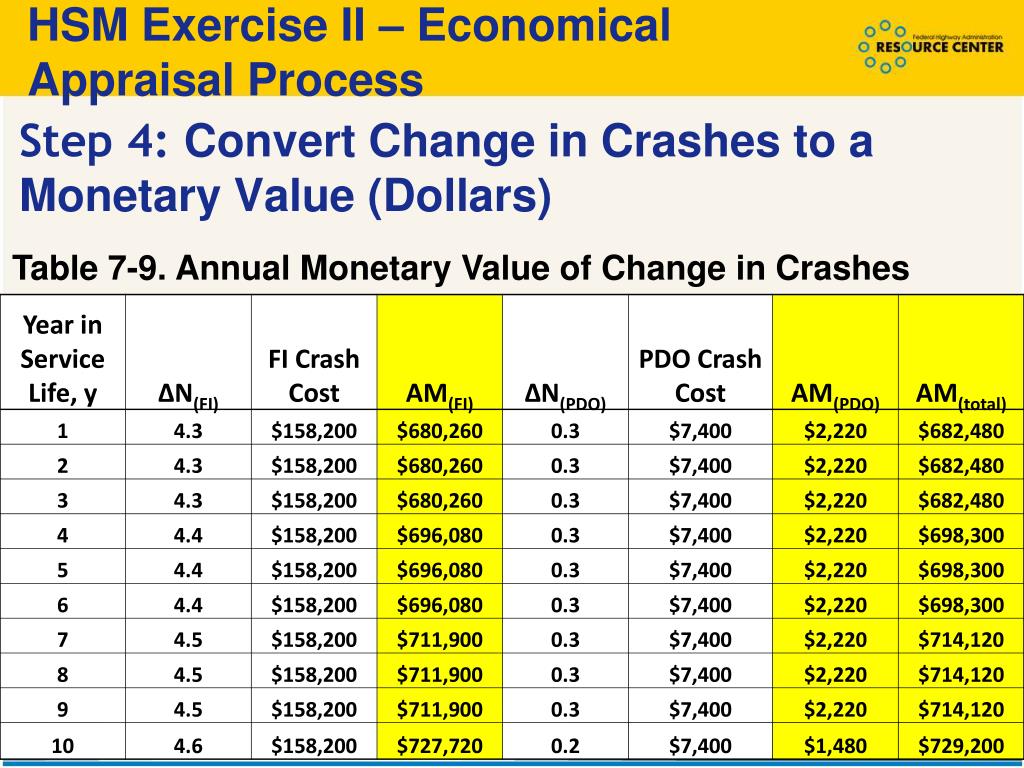

  18. HSM Exercise II – Economical Appraisal Process Step 4: Convert Change in Crashes to a Monetary Value (Dollars) Table 7-9. Annual Monetary Value of Change in Crashes

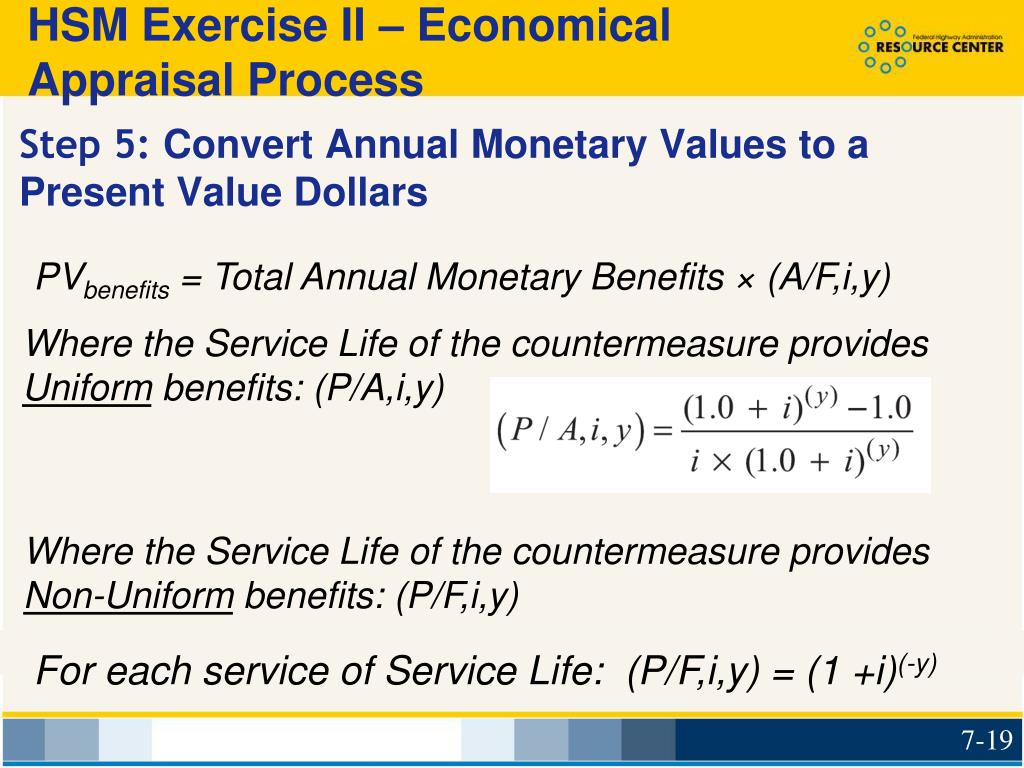

  19. HSM Exercise II – Economical Appraisal Process Step 5: Convert Annual Monetary Values to a Present Value Dollars PVbenefits = Total Annual Monetary Benefits × (A/F,i,y) Where the Service Life of the countermeasure provides Uniform benefits: (P/A,i,y) Where the Service Life of the countermeasure provides Non-Uniform benefits: (P/F,i,y) For each service of Service Life: (P/F,i,y) = (1 +i)(-y)

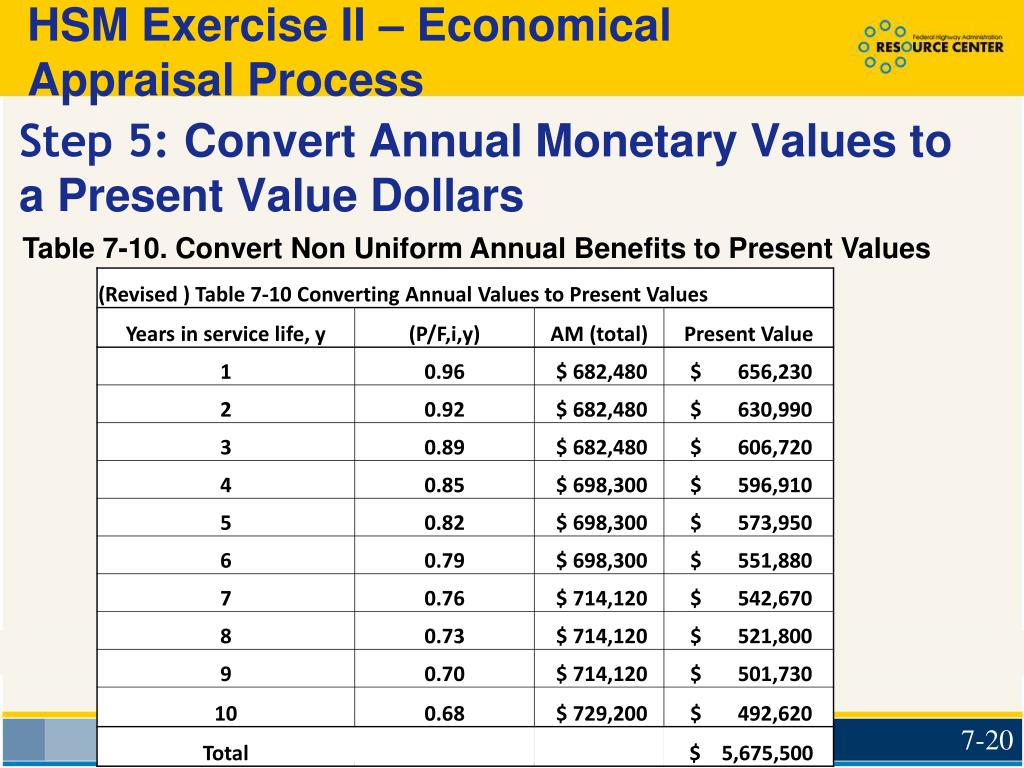

  20. HSM Exercise II – Economical Appraisal Process Step 5: Convert Annual Monetary Values to a Present Value Dollars Table 7-10. Convert Non Uniform Annual Benefits to Present Values

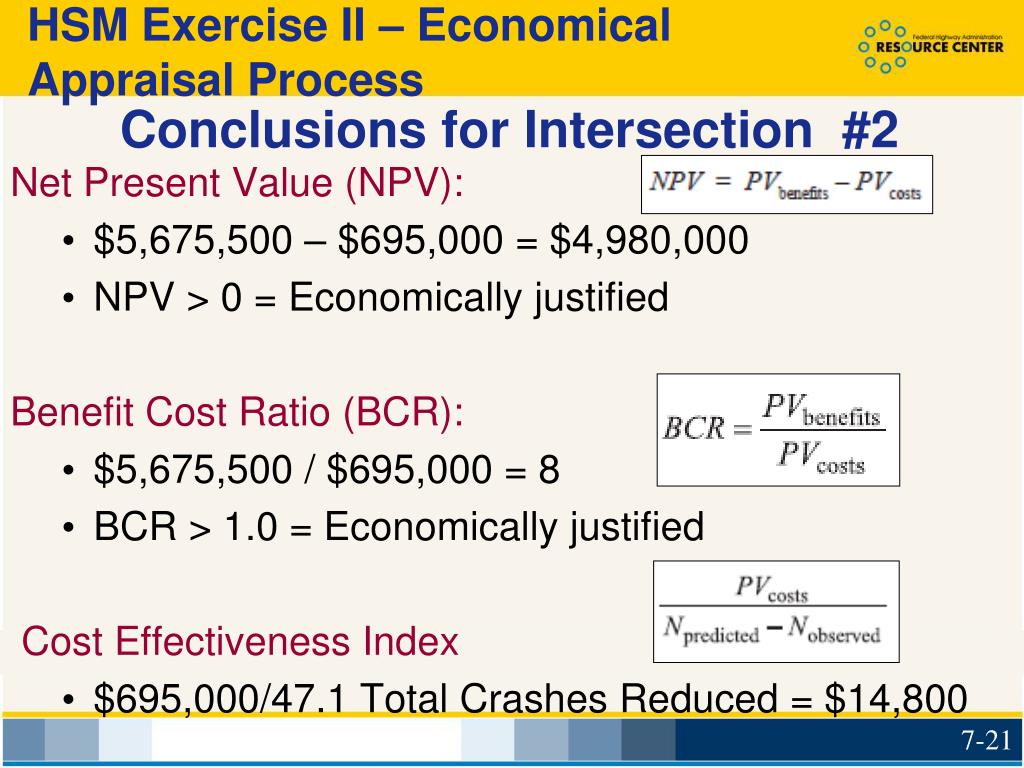

  21. HSM Exercise II – Economical Appraisal Process Conclusions for Intersection #2 • Net Present Value (NPV): • $5,675,500 – $695,000 = $4,980,000 • NPV > 0 = Economically justified • Benefit Cost Ratio (BCR): • $5,675,500 / $695,000 = 8 • BCR > 1.0 = Economically justified • Cost Effectiveness Index • $695,000/47.1 Total Crashes Reduced = $14,800

  22. HSM Exercise III – Prioritize Projects Which Project Countermeasure(s) to Fund? • Intersection 2 must now compete for funding with • Three other Intersections • Five Road Segments Table 8-3. Summary of Countermeasures

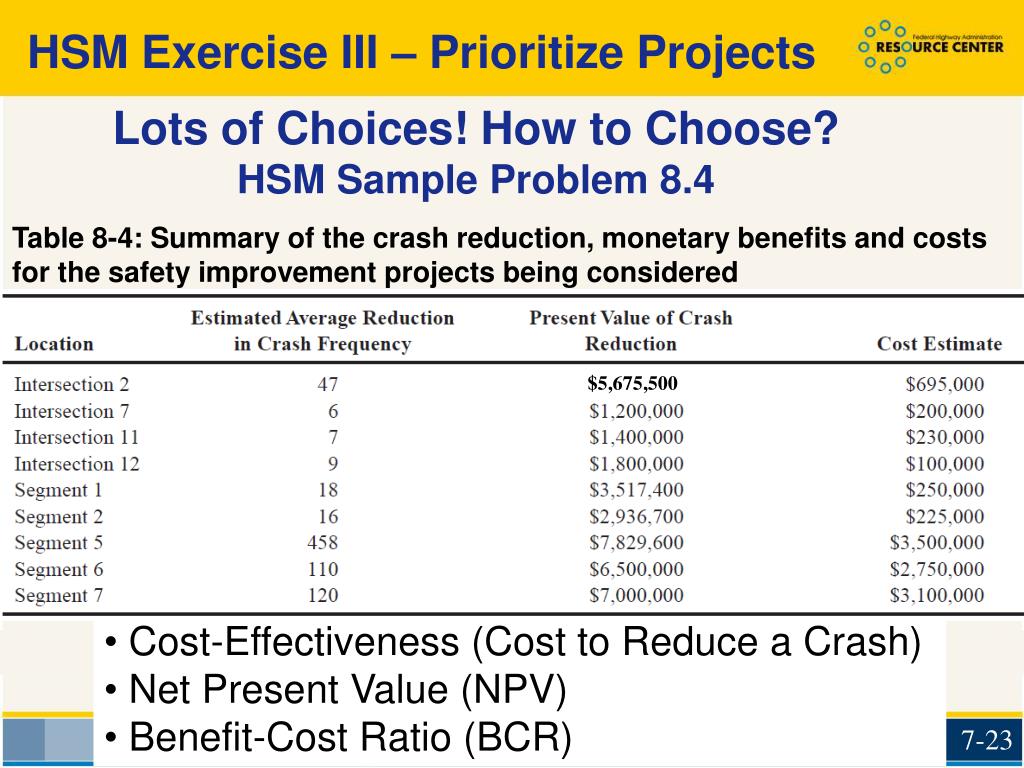

  23. HSM Exercise III – Prioritize Projects Lots of Choices! How to Choose?HSM Sample Problem 8.4 Table 8-4: Summary of the crash reduction, monetary benefits and costs for the safety improvement projects being considered $5,675,500 • Cost-Effectiveness (Cost to Reduce a Crash) • Net Present Value (NPV) • Benefit-Cost Ratio (BCR)

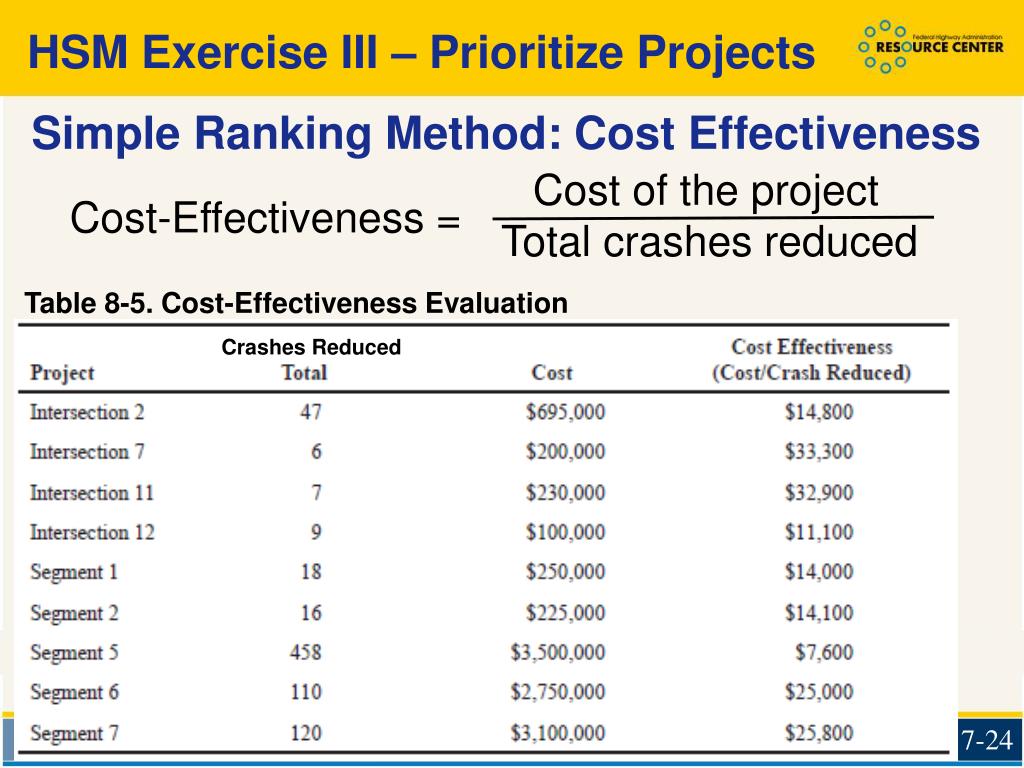

  24. HSM Exercise III – Prioritize Projects Simple Ranking Method: Cost Effectiveness Cost of the project Total crashes reduced Cost-Effectiveness = Table 8-5. Cost-Effectiveness Evaluation Crashes Reduced

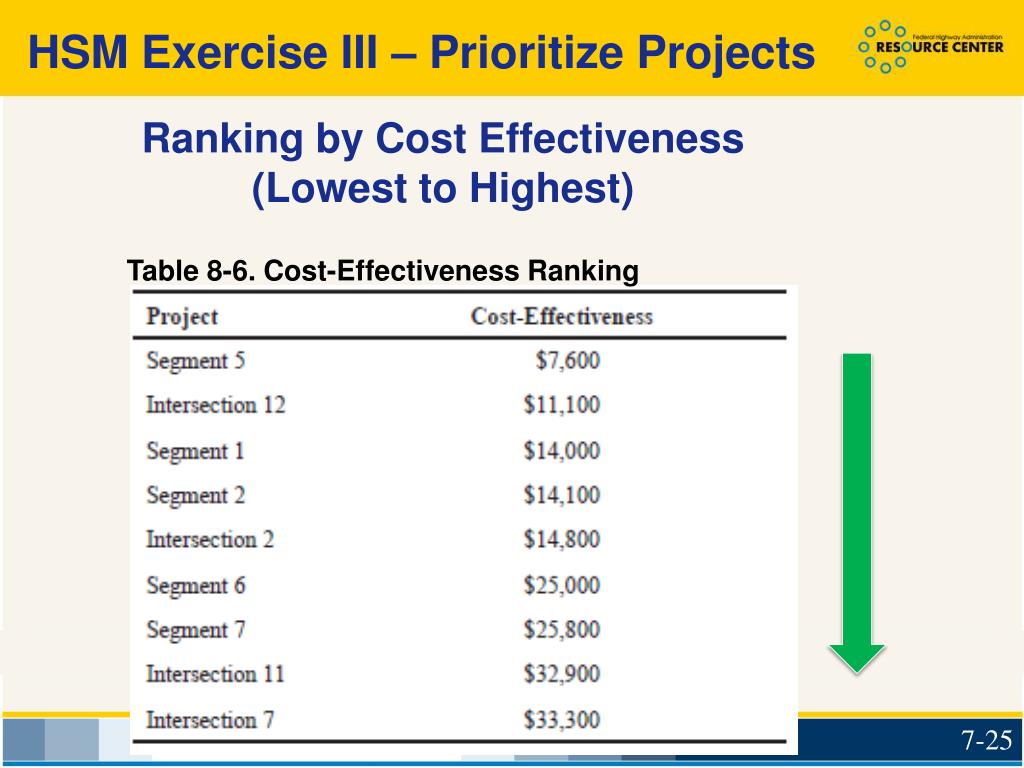

  25. HSM Exercise III – Prioritize Projects Ranking by Cost Effectiveness(Lowest to Highest) Table 8-6. Cost-Effectiveness Ranking

  26. HSM Exercise III – Prioritize Projects Simple Ranking Method: Net Present Value(Ranked Highest to Lowest) NPV = Present Monetary Value of the Benefits – Project Cost Table 8-8. Net Present Value Results $5,675,500 $4,980,500

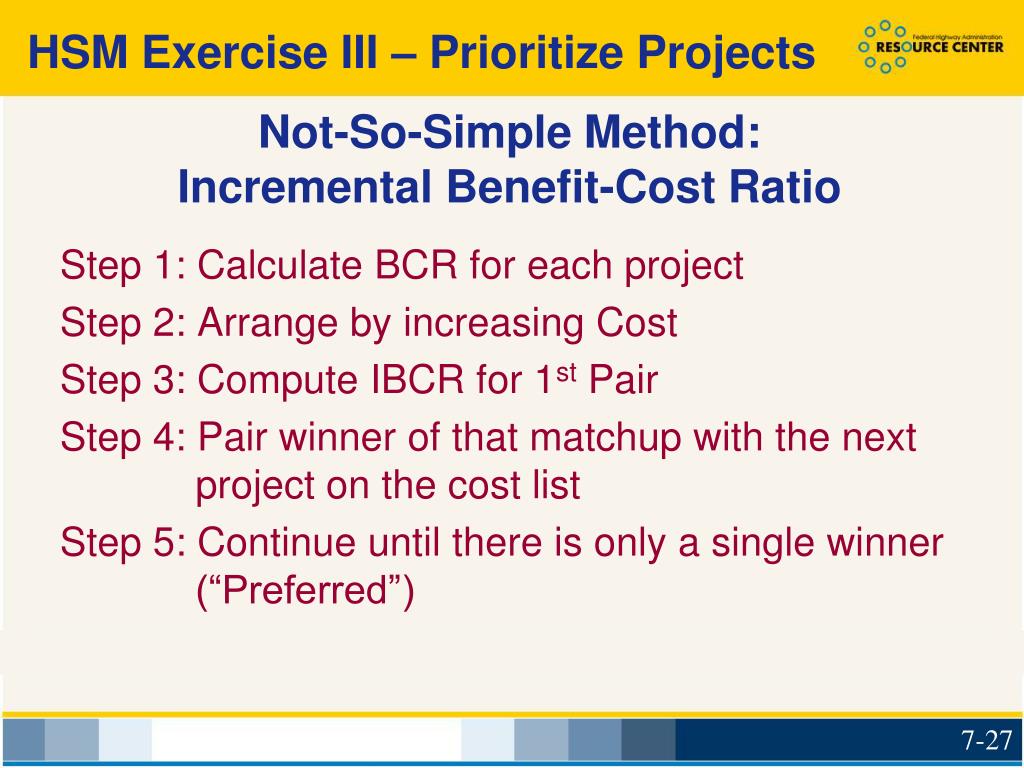

  27. HSM Exercise III – Prioritize Projects Not-So-Simple Method:Incremental Benefit-Cost Ratio • Step 1: Calculate BCR for each project • Step 2: Arrange by increasing Cost • Step 3: Compute IBCR for 1st Pair • Step 4: Pair winner of that matchup with the next project on the cost list • Step 5: Continue until there is only a single winner (“Preferred”)

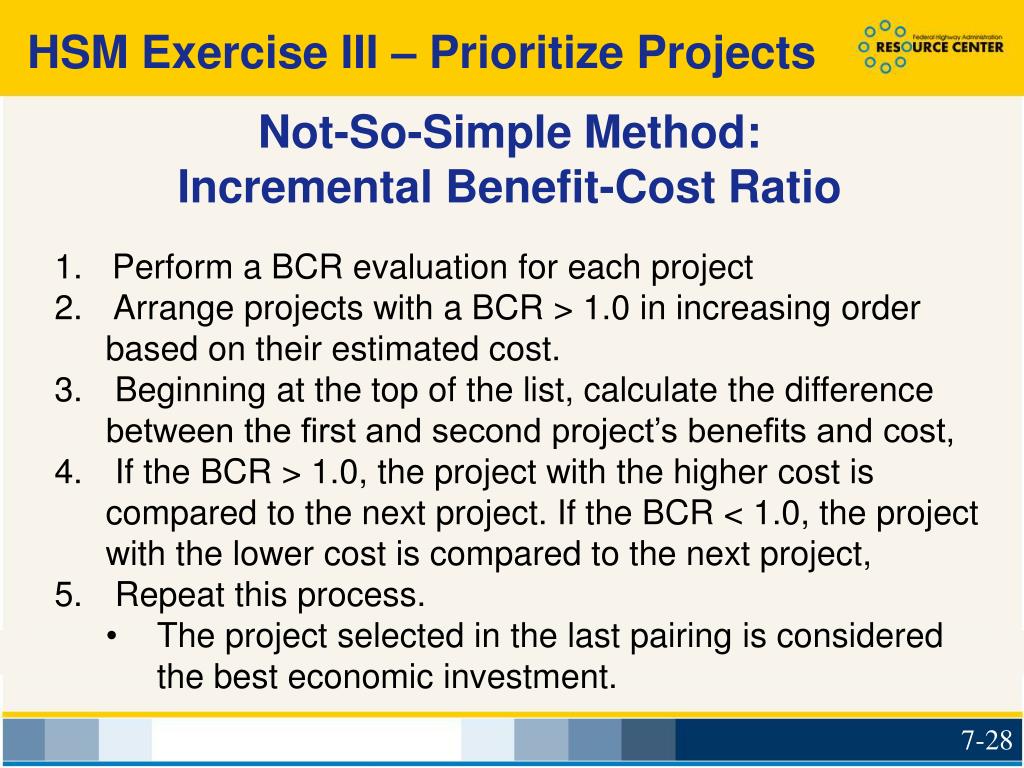

  28. HSM Exercise III – Prioritize Projects Not-So-Simple Method:Incremental Benefit-Cost Ratio • Perform a BCR evaluation for each project • Arrange projects with a BCR > 1.0 in increasing order based on their estimated cost. • Beginning at the top of the list, calculate the difference between the first and second project’s benefits and cost, • If the BCR > 1.0, the project with the higher cost is compared to the next project. If the BCR < 1.0, the project with the lower cost is compared to the next project, • Repeat this process. • The project selected in the last pairing is considered the best economic investment.

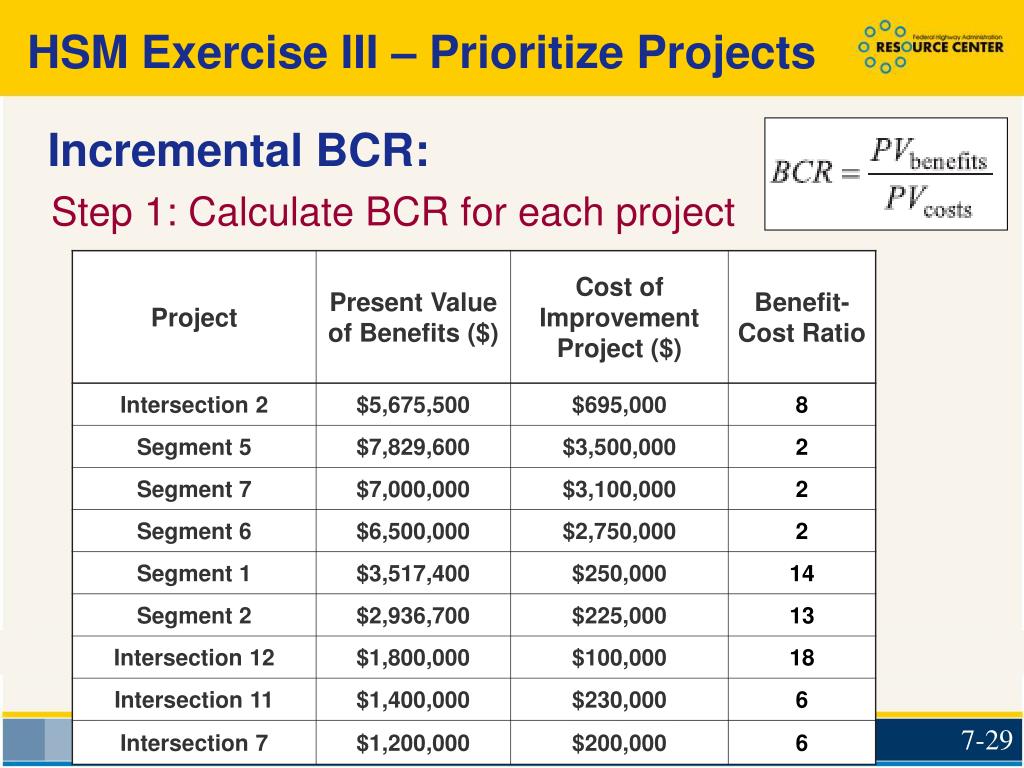

  29. HSM Exercise III – Prioritize Projects Incremental BCR: • Step 1: Calculate BCR for each project

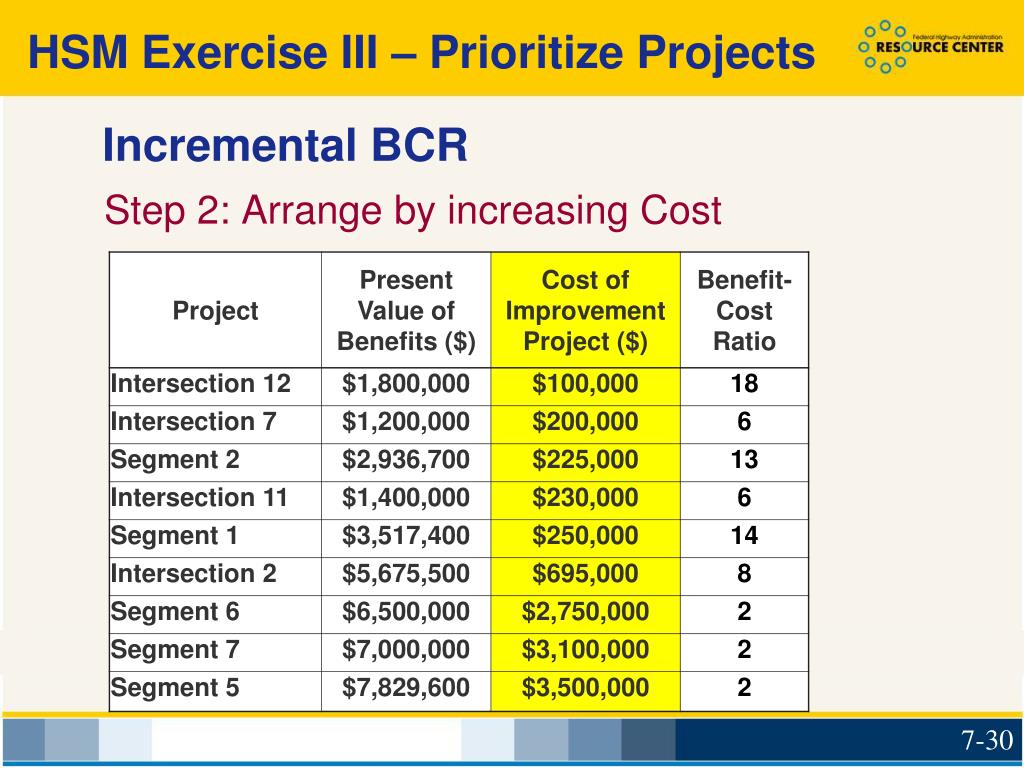

  30. HSM Exercise III – Prioritize Projects Incremental BCR • Step 2: Arrange by increasing Cost

  31. HSM Exercise III – Prioritize Projects Incremental BCR • Step 3: Compute IBCR for 1st Pair of Projects PVbenefits 2 – PVbenefits 1 PVcosts 2 – PVcosts 1 Incremental BCR = Where: PVbenefits 1 = Present value of benefits for lower-cost project PVbenefits 2 = Present value of benefits for higher-cost project PVcosts 1 = Present value of cost for lower-cost project PVcosts 2 = Present value of cost for higher-cost project

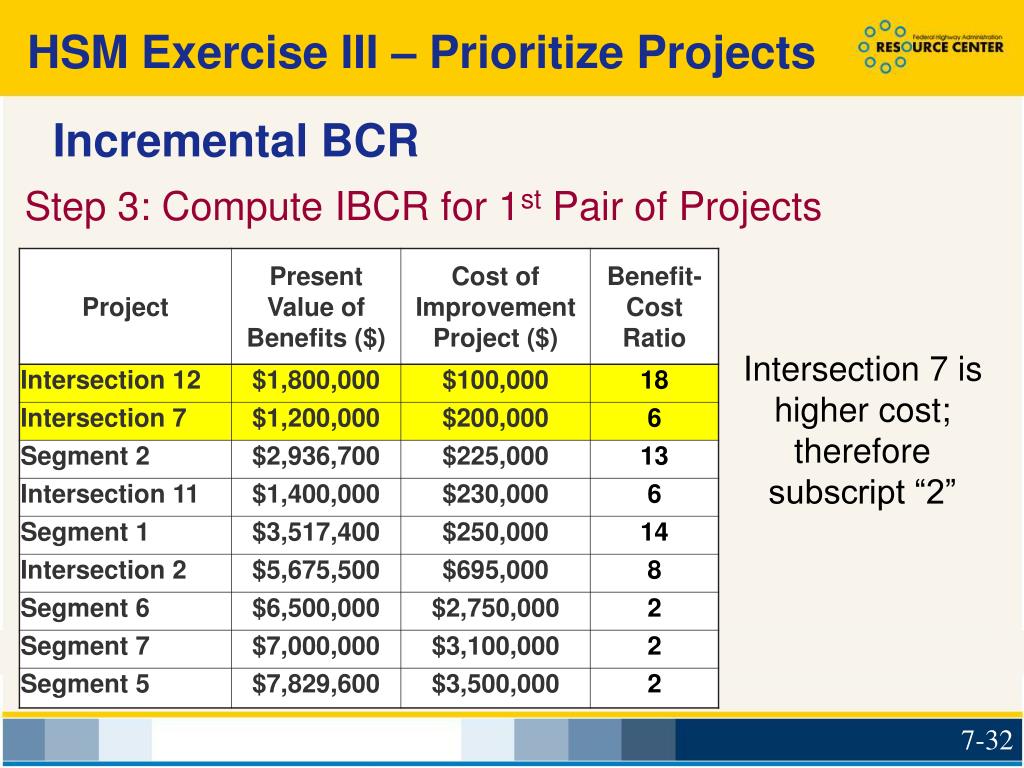

  32. HSM Exercise III – Prioritize Projects Incremental BCR • Step 3: Compute IBCR for 1st Pair of Projects Intersection 7 is higher cost; therefore subscript “2”

  33. HSM Exercise III – Prioritize Projects Incremental BCR Incremental BCR = (PVbenefits 7 – PVbenefits 12) / (PVcosts 7 – PVcosts 12) - $600,000 $100,000 $1,200,000 - $1,800,000 $200,000 - $100,000 -6 IBCR = = = RULE: If ICBR > 1, Higher Cost project is “preferred” ICBR < 1, Therefore, Intersection 7 is NOT “preferred” and Intersection 12 is retained and compared to the next alternative

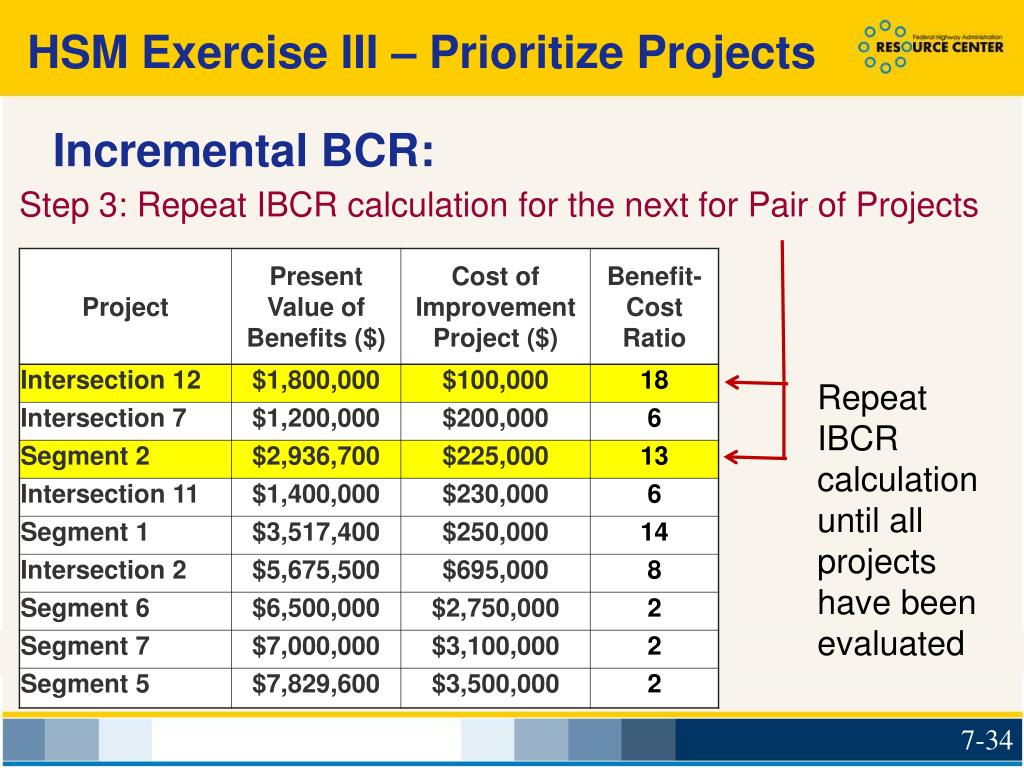

  34. HSM Exercise III – Prioritize Projects Incremental BCR: • Step 3: Repeat IBCR calculation for the next for Pair of Projects Repeat IBCR calculation until all projects have been evaluated

  35. HSM Exercise III – Prioritize Projects Incremental BCR: Results Winner?

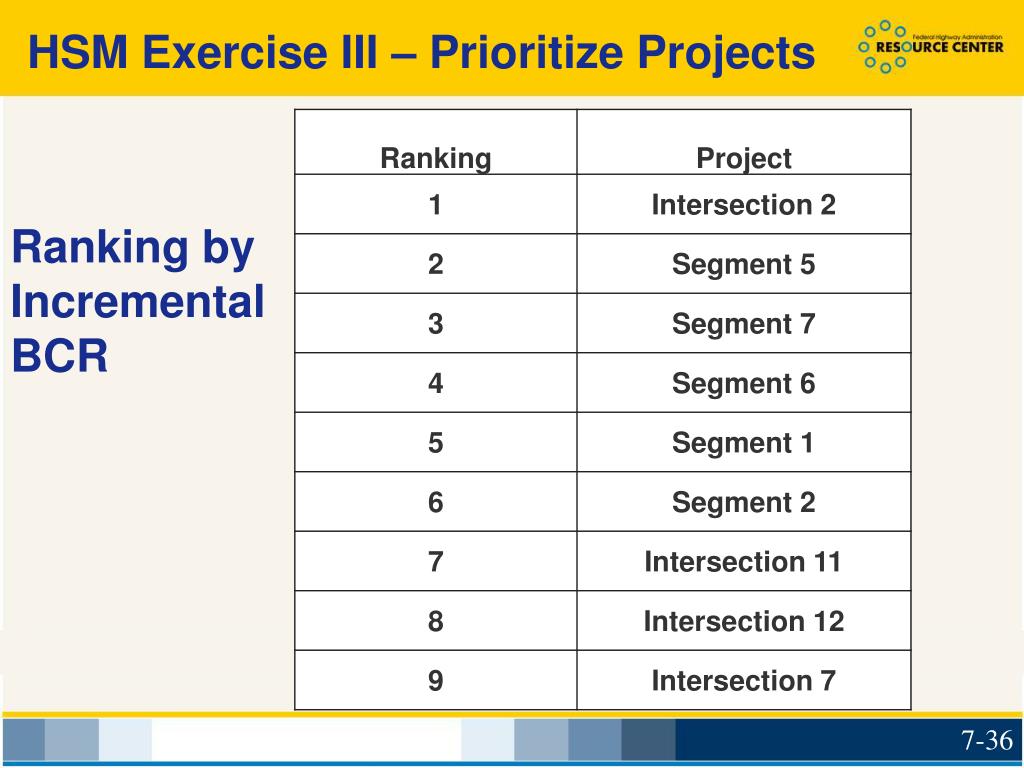

  36. HSM Exercise III – Prioritize Projects Ranking by Incremental BCR

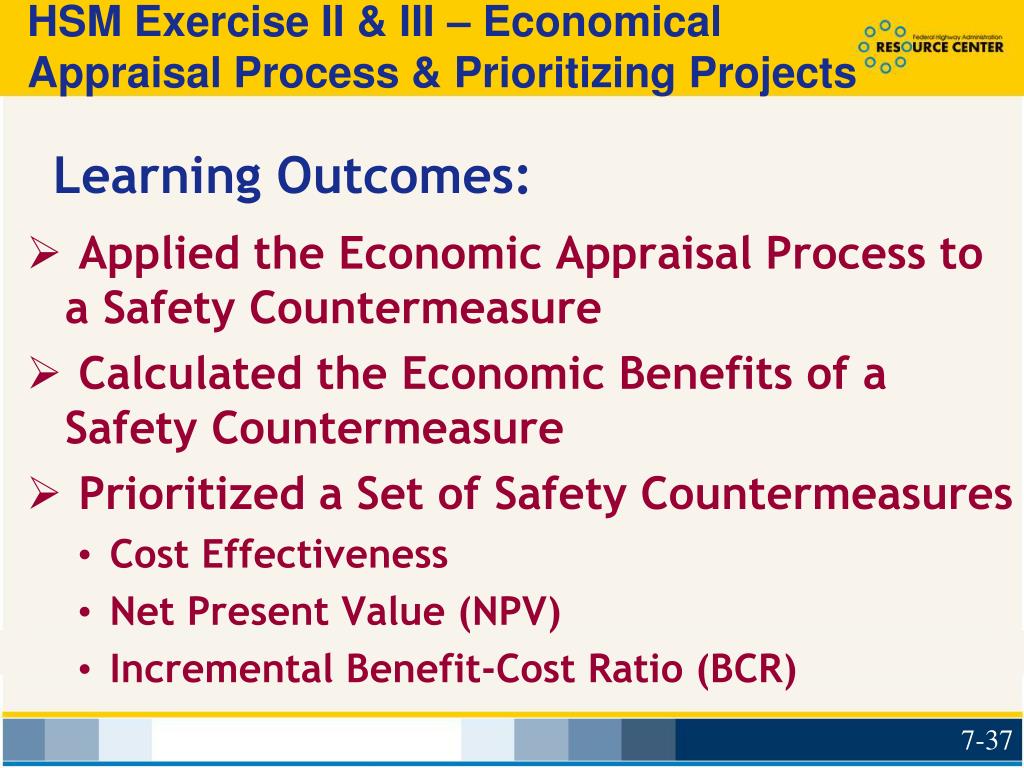

  37. HSM Exercise II & III – Economical Appraisal Process & Prioritizing Projects Learning Outcomes: • Applied the Economic Appraisal Process to a Safety Countermeasure • Calculated the Economic Benefits of a Safety Countermeasure • Prioritized a Set of Safety Countermeasures • Cost Effectiveness • Net Present Value (NPV) • Incremental Benefit-Cost Ratio (BCR)

  38. HSM Exercise II & III – Economical Appraisal Process & Prioritizing Projects Questions and Discussion?
