Prioritization of Cabling Needs

Prioritization of Cabling Needs. P. Bonnal with inputs from J.-C. Guillaume, P. Lelong and D. Ricci. P.Bonnal LIU-PSB meeting 2012-01-12. Prioritization of Cabling Needs. IEFC Meeting held on Friday 16 th December : Critical cable areas in SPS and PS complex (D. Ricci)

csilla
Télécharger la présentation

Prioritization of Cabling Needs

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Prioritization of Cabling Needs P. Bonnalwith inputs from J.-C. Guillaume, P. Lelong and D. Ricci P.BonnalLIU-PSB meeting 2012-01-12

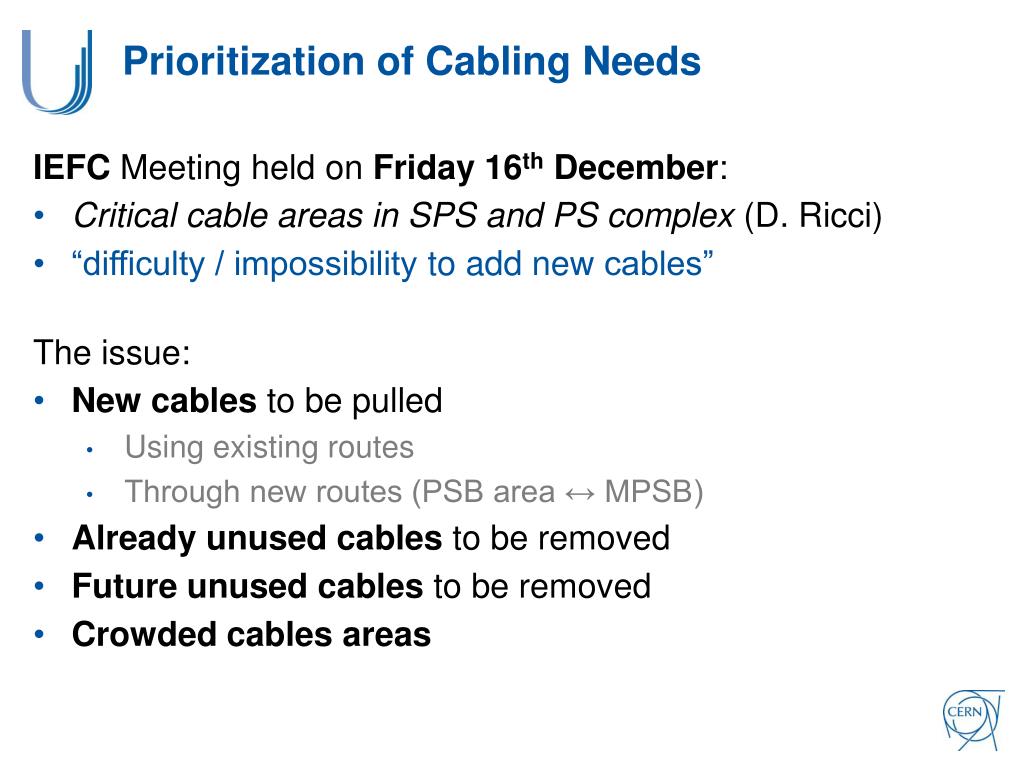

  2. Prioritization of Cabling Needs • IEFCMeeting held on Friday 16th December: • Critical cable areas in SPS and PS complex (D. Ricci) • “difficulty / impossibility to add new cables” • The issue: • New cables to be pulled • Using existing routes • Through new routes (PSB area ↔ MPSB) • Already unused cables to be removed • Future unused cables to be removed • Crowded cables areas

  3. A few pictures (Wed. 21st December)

  4. Prioritization of Cabling Needs → ideas • Prelim. discussion with J.-C. Guillaume, P. Lelongand D. Ricci : • Possible strategies: • Removing all cables then (re)pulling all cables → LHC • Removing some cables, pulling new cables… repeating • Removing all unused cables in one campaign LS1then pulling all new and reused cables in LS1 • Removing all unused cables in one campaignthen pulling all cables in LS1 and SD 14-15 • Removing all unused cables in one campaignthen pulling all cables in LS1, SD 14-15 and SD 15-16 • …

  5. Prioritization of Cabling Needs → ideas • Prelim. discussion with J.-C. Guillaume, P. Lelongand D. Ricci : • Issue #1 → Existing databases: • Before 1989 : paper listings ; routing unknown • After 1989 : in EL Cablothèque • Issue #2 → Cable marking • Issue #3 → Cables to remove • Issue #4 → Cables to pull • Issue #5 → Work optimization (remove then re-pull) • Issue #6 → Possible civil works required • Issue #7 → EN-EL workload (already 8 projects on-going)

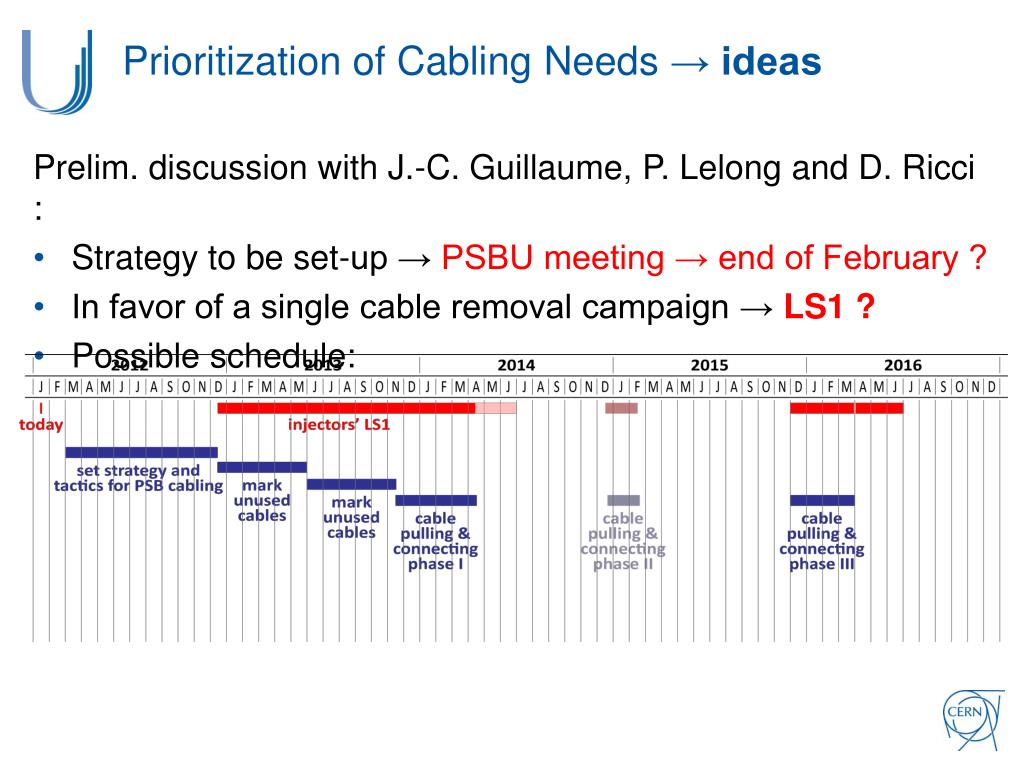

  6. Prioritization of Cabling Needs → ideas • Prelim. discussion with J.-C. Guillaume, P. Lelongand D. Ricci : • Strategy to be set-up → PSBU meeting → end of February ? • In favor of a single cable removal campaign → LS1 ? • Possible schedule:

  7. Preparatory works • Identifying all new vs. old equipment ☞ on-going and associated cabling requirement ☞ schematic layout required ☞ to initiate soon • Identifying cables that are/will be useless • Identifying new cables that need to be pulled • Identifying rather crowded cables areas • Optimizing cable routes • Marking then removing these useless cables • Re-pulling useful removed cables + pulling of new cables
